I plan data center crews by the IT megawatts under construction - not the campus’s future capacity. Workers per MW equals concurrent on-site headcount divided by IT MW. For example, 500 workers on a 50 MW build equals 10 workers per MW - a calculation, not a staffing benchmark.
I build separate crew plans for:
I keep average staffing, peak headcount, and shift rosters separate. Then I check trade quantities, equipment deliveries, and work-area readiness before setting weekly coverage targets. <u>Hiring follows the schedule, not a single ratio.</u> Leadership hiring may need 60–90 days, and I update the workforce plan weekly as dates and scope change.

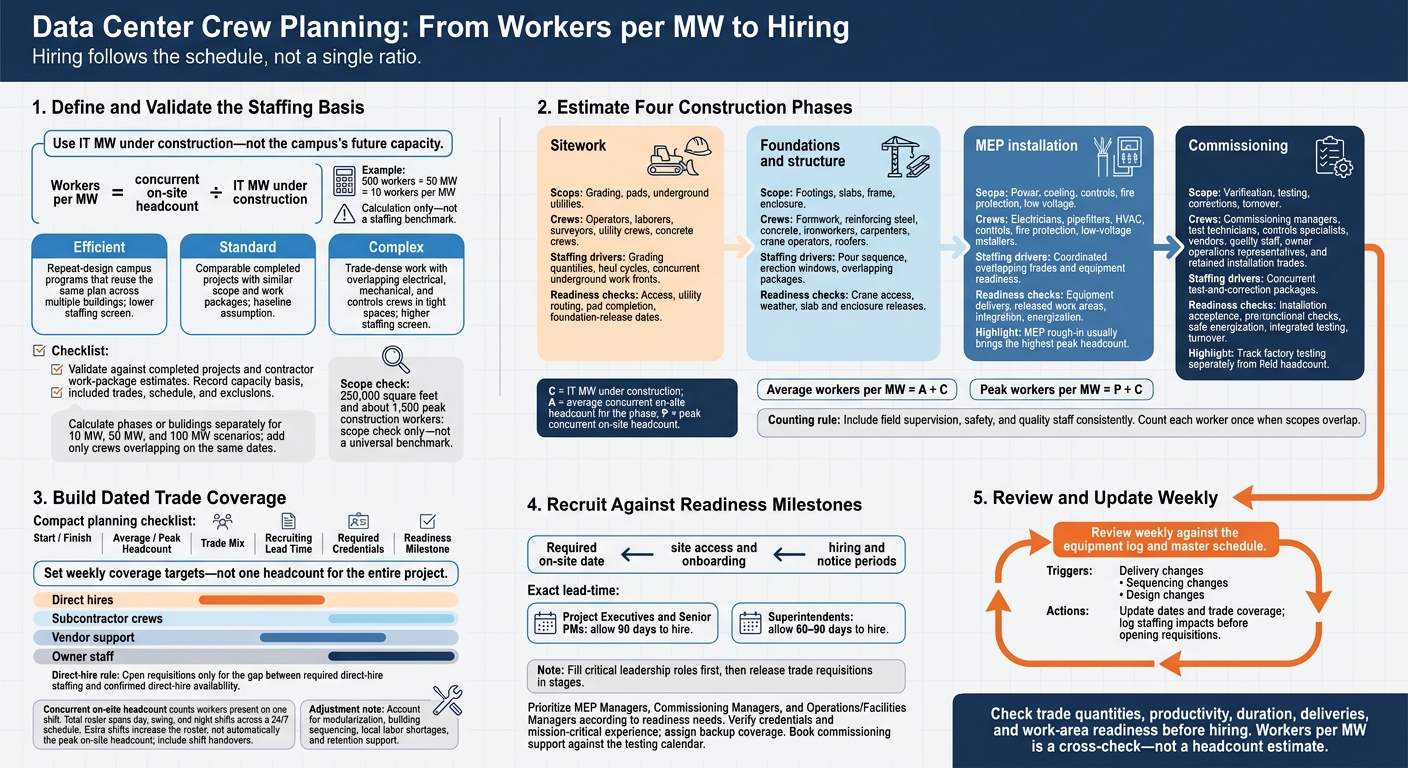

Data Center Crew Planning: From Workers per MW to Hiring
Use ratios as screening assumptions - not hiring targets. Before setting hiring targets, check them against completed projects with matching scope and contractor work-package estimates. Record the capacity basis, included trades, schedule, and exclusions alongside each assumption. These checks provide the baseline for the phase staffing ranges in Step 2.
Use this table to screen staffing assumptions, not to set crew targets.
Calculate each phase or building separately for 10 MW, 50 MW, and 100 MW scenarios, then add only crews that overlap on the same dates. Use those totals as a reality check before moving to phase-level staffing. Use 250,000 square feet and about 1,500 peak construction workers as a scope check. [2]
Concurrent on-site headcount counts workers on one shift. Total workers employed includes day, swing, and night shifts across a 24/7 schedule. [2] Track these measures separately to avoid double-counting labor coverage.
MEP rough-in usually brings the highest peak headcount, with electricians, pipefitters, and HVAC mechanics making up most of the crew on-site. [1] Use that peak window to size the phase-by-phase crews in Step 2.
Hiring for a mission-critical build? Get a pre-qualified shortlist.
iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.
Get Started
Success-based pricing · 90-day replacement credit · No upfront fee on single roles
Apply the Step 1 screening ratio to each phase, then use the trade packages to estimate average and peak headcount. Check each phase’s busiest concurrent workfront against the Step 1 screening assumptions.
Let C equal the IT MW under construction, A the average concurrent on-site headcount for the phase, and P its peak. Calculate staffing ratios as follows: average workers per MW = A ÷ C and peak workers per MW = P ÷ C. Include field supervision, safety, and quality staff on the same basis across phases. Count each worker only once when scopes overlap.
The table outlines crew drivers, trade mix, and schedule dependencies. Use the phase notes below to size crews around the dominant trade package and its schedule trigger.
Size crews around grading quantities, haul cycles, underground work fronts, and pad-release dates. Access and utility routing determine which fronts can run at the same time.
Base staffing on the pour sequence, erection windows, and enclosure releases. Before approving overlapping work, check crane access, weather exposure, and work on multiple buildings at once.
Plan overlapping trade crews around switchgear, generators, busway, and cooling-system readiness. Tie staffing requisitions to released work areas and equipment delivery. Reduce crew sizes as installation, integration, or energization milestones are completed.
Peak staffing shifts from installation labor to specialist testing support. Plan coverage for verification, pre-functional checks, energization, functional and integrated systems testing, corrections, and turnover.
Include installation trades retained for testing support, along with turnover personnel. Track factory testing separately from field headcount. [5] Overlapping test packages can require dense specialist coverage, so align vendor, controls, quality, and owner support with the test calendar.
Turn the phase peaks from Step 2 into a hiring and coverage plan with dates for each trade.
Set weekly coverage targets - not one headcount for the entire project. Track direct hires, subcontractor crews, vendor support, and owner staff separately. Open direct-hire requisitions only for the gap between required staffing and confirmed direct-hire availability. Keep subcontractor commitments in their own records.
Use the phase peaks to fill out the dated trade rows below. Treat recruiting lead times as buffers.
Work backward from the required on-site date, allowing time for site access, onboarding, hiring, and notice periods. Fill critical leadership roles first, then release trade requisitions in stages.
With dates in place, adjust the roster for shifts, modularization, and site conditions.
Keep roster size separate from peak on-site headcount. Extra shifts increase the total roster, not the peak number of people on-site. Include shift handovers when checking how many people will be on-site at once.
Modular construction moves staffing toward factory work, logistics, integration, and testing. Sequence buildings so one hall’s electrical peak overlaps with another hall’s underground and slab work. This keeps core crews working and avoids gaps.
Local labor shortages and staffing challenges increase turnover and wage pressure. Use housing, transport, and retention support to keep coverage steady. [4]
Once the schedule is set, secure critical roles first to prevent mobilization delays.
Tie hiring dates to readiness milestones. Prioritize Project Executives and Senior PMs, MEP Managers, Superintendents, Commissioning Managers, and Operations/Facilities Managers based on when each role needs to be ready.
Allow 90 days to hire Project Executives and Senior PMs, and 60 to 90 days to hire Superintendents. [1] Verify role-specific credentials and mission-critical experience. Build in time for onboarding and site access, and assign backup coverage for critical roles.
Book commissioning support against the testing calendar. Keep subcontractor, vendor, and owner commitments in separate coverage records so each group’s responsibilities and availability are clear through mobilization, testing, and turnover.
After sizing sitework, structure, MEP, and commissioning, use workers per MW as a cross-check - not a headcount estimate. Check each phase against IT MW under construction and the counted on-site headcount. Keep average and peak staffing separate when comparing data center construction benchmarks.
Check each trade package against its work quantities, productivity, and duration before setting hiring targets. Even a strong project-wide ratio can hide trade shortages or overlapping staffing peaks.
Review the forecast weekly against the equipment log and master schedule to mitigate schedule risks. When deliveries, sequencing, or design change, update the affected dates and trade coverage. Log the staffing impact before opening requisitions. This proactive approach is essential for solving talent shortages during peak construction phases.
Apply each phase’s workers-per-MW range to your project’s defined IT capacity in MW. Then check how many workers will be on-site at the same time, accounting for overlapping trades. Headcount should be low during sitework, peak during MEP rough-in, and taper during commissioning [1].
Use historical peaks as a reference: about 1,500 workers per building or 3,000–3,500 on hyperscale campuses. Adjust those figures for schedule compression, modularity, and complexity [1][2]. Plan enough commissioning staff to cover its 3–6-month window [1].
Skip a fixed workers-per-MW ratio. Adjust staffing by phase to match the critical path, and plan engineering and commissioning coverage toward the high end of the staffing range, with commissioning compressed into 3–6 months.
Bring commissioning and controls leads into construction earlier, and secure MEP leadership during design - these roles can take about 4.2 months to fill. Overlap phases to keep core crews productive and avoid staffing gaps. [1][2][3]
Use phase-specific ratios - not a single blended multiplier to convert IT capacity (MW) into peak concurrent on-site staffing. Plan hiring waves before each phase starts: sitework, foundations/structure, MEP rough-in, and commissioning [1][2].
Build a labor histogram for electrical, mechanical, controls, and commissioning trades. Account for shifts, then convert required labor hours into worker counts for each scheduled window. Expect the highest staffing peaks during electrical-heavy rough-in and commissioning. Schedule compression can create 1.5–2x staffing pressure [3][1].
