September 1, 2026

Entitlement to Delivery: How Long Commercial Development Really Takes

By:
Dallas Bond

If you plan a commercial project from permit issue to construction finish, you’re probably missing months - or years. In most U.S. markets, the full path from land-use approval to ready-for-use handoff runs about 2.5 to 5+ years, and power-heavy or process-heavy projects can take even longer.

Here’s the short version:

  • I’d plan from entitlement to turnover, not from groundbreaking to construction finish.
  • The main schedule drivers are usually approvals, utility power, long-lead equipment, commissioning, and staffing.
  • Common review cycles can add 6 to 12 weeks.
  • Major electrical gear can take 8 to 24 months, and some transformers are now reported at 128 weeks.
  • Utility power can become the longest item on the job, with some interconnection queues averaging five years.

Delivery also means different things by project type. A data center needs power and integrated systems testing. A healthcare site needs inspections, life-safety signoff, and licensing. A manufacturing plant may still need equipment qualification and process checks after the building work is done.

Here’s the core point: a building can look finished and still not be ready to use. If I were building the plan, I’d tie schedule, hiring, and cash flow to the date the site can actually start service, production, or tenant use.

A few timing ranges from the article:

  • Data centers: about 24–60+ months
  • Healthcare outpatient: about 18–42 months
  • Industrial/logistics: about 15–37 months
  • Advanced manufacturing: about 36–72+ months
Project type Typical total timeline What often holds it up
Data centers 24–60+ months Utility power, switchgear, transformers, IST
Healthcare outpatient 18–42 months Reviews, inspections, commissioning, licensing
Industrial/logistics 15–37 months Site work, permits, utility extensions
Advanced manufacturing 36–72+ months Process equipment, validation, utility capacity

The bottom line is simple: the field schedule is only part of the job. If you want a date you can trust, build the plan around approvals, gear releases, utility milestones, commissioning, and the people needed to hold those dates.

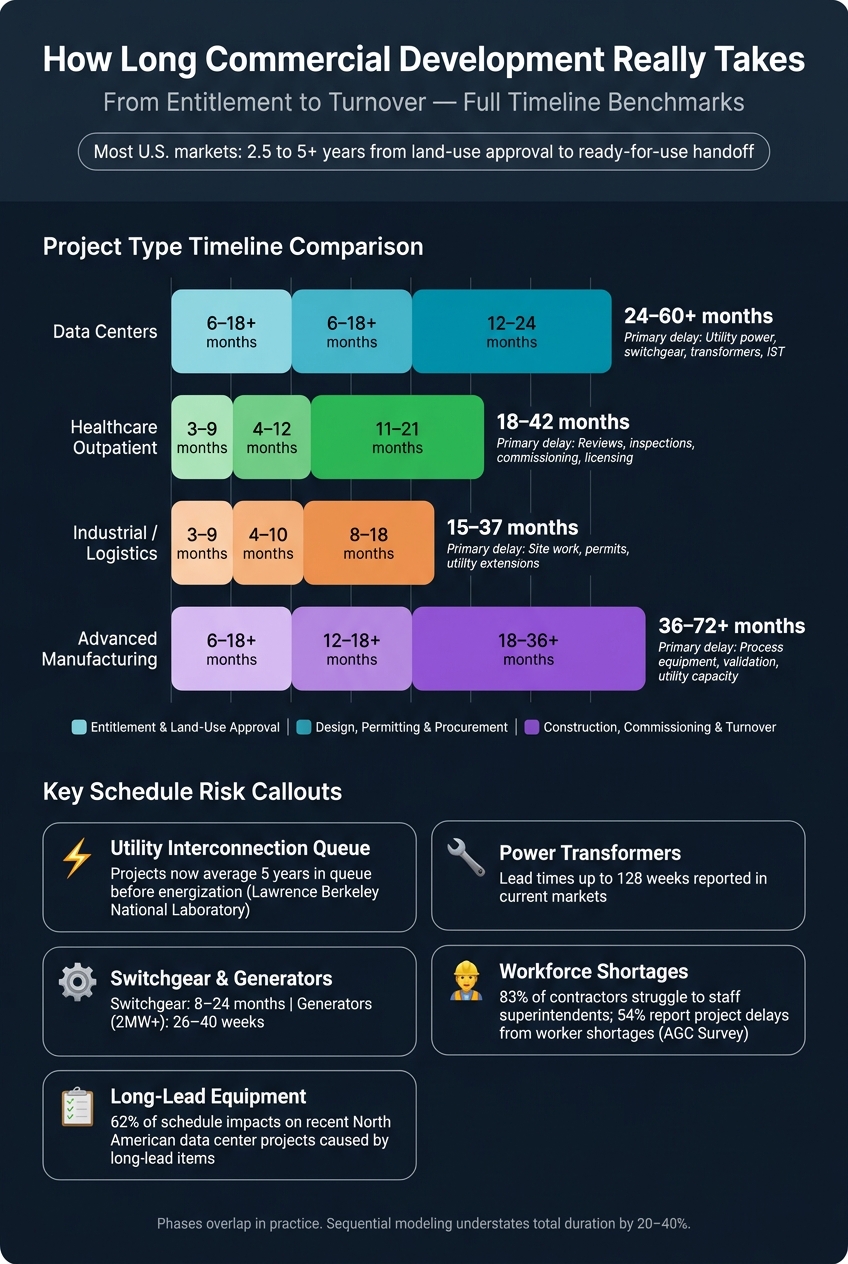

Commercial Development Timelines: Entitlement to Turnover by Project Type

Commercial Development Timelines: Entitlement to Turnover by Project Type

Phase-by-Phase Timeline Benchmarks From Entitlement to Turnover

Realistic delivery plans start with phase timing and phase overlap. That matters because every extra month hits staffing plans, capital deployment, and launch timing. The weak spot may differ by sector, but the delivery risk looks the same. The ranges below make one thing clear: build the plan around overlap, not a neat step-by-step sequence.

Phase Data Centers Healthcare Outpatient Industrial / Logistics Advanced Manufacturing
Entitlement & Land-Use Approval 6–18+ months 3–9 months 3–9 months 6–18+ months
Design, Permitting & Procurement 6–18+ months 4–12 months 4–10 months 12–18+ months
Construction, Commissioning & Turnover 12–24 months 11–21 months 8–18 months 18–36+ months
Typical Total (Greenfield) 24–60+ months 18–42 months 15–37 months 36–72+ months

These phases do not move in a clean line. Schematic design often starts before entitlement is finished. Long-lead equipment buying begins during design development. Commissioning overlaps with the last stretch of construction. Owners who model these phases as strictly sequential often understate total duration by 20% to 40%[10][12][13][15].

The first place schedules get squeezed is entitlement.

Entitlement and Land-Use Approval: 3 to 18+ Months

Entitlement includes zoning confirmation, site plan approval, variances, environmental review, and utility capacity agreements. The time range depends on zoning status, hearing requirements, and review complexity.

By-right projects, where the proposed use already fits current zoning, can secure entitlement in 3 to 6 months if the jurisdiction has a clean administrative path and there is little or no community opposition. Projects that need rezoning, conditional use permits (CUPs), or full environmental review often stretch to 12 to 18+ months[3][5].

Conditional use permits often take 2 to 6 months, but large-city reviews or matters that need several hearings can stretch to 3 to 6+ months[6][8][9]. In California, complex rezonings or tract maps can take 1.5 to 2+ years even when applicants move fast[4].

Utility approvals are a separate risk, and teams often miss how big that risk is. Data centers and advanced manufacturing facilities may need medium-voltage feeds, new substations, or line upgrades. Utility studies, design, and regulatory approvals for those improvements can take 6 to 18 months by themselves. In tight power markets, that becomes the actual critical path for the whole project[1]. Owners should treat utility capacity and environmental constraints as early critical-path risks, not back-office items to sort out after design begins.

Design, Permitting, and Procurement: 6 to 18+ Months

This phase combines several workstreams that run at the same time. Schematic design usually takes 1 to 3 months, design development 2 to 4 months, and construction documents 3 to 6 months. Permit review often adds another 2 to 6 months after a complete application is submitted. For standard commercial projects, the median review time is 12 to 20 weeks[7]. On more complex jobs with multiple authorities having jurisdiction (AHJs), that window gets longer.

In practice, long-lead procurement often drives the schedule. Switchgear can carry lead times of 8 to 24 months, depending on size and market conditions[2]. Generators run 26 to 40 weeks. Chillers and cooling systems for data centers often fall in the 24 to 36+ week range. In advanced manufacturing, custom process equipment such as tools, reactors, and precision HVAC can run 30 to 60+ weeks, including factory acceptance testing. Those items usually need to be released during design development, often before construction documents are finished, using performance specs and approved vendors.

The practical move is simple: issue early procurement packages for critical equipment while permitting is still underway. Waiting for a full CD set sounds tidy, but it can backfire. Plenty of teams get to the point where field crews are ready to go and the equipment is still weeks from delivery.

Construction, Commissioning, and Turnover: 8 to 24+ Months

Field execution timelines vary a lot by sector. Mid-size industrial and logistics facilities can reach shell-and-core completion in 8 to 16 months. Larger data centers and advanced manufacturing buildings with dense MEP infrastructure often need 12 to 24 months just for the core construction scope[16][17].

Substantial completion almost never means the building is ready for use. Integrated systems testing, commissioning, training, closeout, and inspections can add 3 to 9+ months after substantial completion. In healthcare and manufacturing, that tail also includes validation, calibration, and performance qualification against regulatory or process standards. Turnover is not the same thing as usable operation. A hospital shell can be substantially complete months before it gets an occupancy permit and licensing clearance. A data center can look finished while the transformer needed to energize it is still sitting in a backlog queue.

For mission-critical projects, commissioning follows a structured verification process, often five levels (L1–L5) that end with integrated systems testing (IST)[2].

Plan capital and staffing around operational readiness, not substantial completion. Those milestones are rarely the same. That gap is often what turns a "finished" project into a delayed launch.

The next section shows the specific factors that push projects toward the high end of these ranges.

Hiring for a mission-critical build? Get a pre-qualified shortlist.

iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.

Get Started

Success-based pricing · 90-day replacement credit · No upfront fee on single roles

What Actually Drives Duration on Commercial Development Projects

Most schedule overruns come from the same handful of issues. Phase benchmarks tell you how long a project may take. These drivers explain why some jobs drift to the far end of that range.

Risk Driver Affected Phases
Zoning disputes, variances, and CUPs Entitlement
Environmental review and stormwater approvals Entitlement, early design
Off-site improvements (roads, utility extensions) Entitlement, pre-construction
Grid interconnection and substation construction Entitlement through commissioning
Power transformer procurement Design through commissioning
Medium-voltage switchgear procurement Design through construction
Generator procurement (2 MW+ scale) Design through commissioning
Design scope changes after design development Design, permitting, procurement
Staffing gaps in MEP, project controls, and commissioning Design through turnover

Approvals, Utilities, and Site Conditions

Projects usually end up at the high end of the entitlement range when hearings pile up, comment rounds keep coming back, and environmental or off-site requirements trigger extra agency reviews. The problem isn't limited to preconstruction. These issues can also delay energization and occupancy.

Each new round of comments from a zoning board or planning commission can add weeks. Environmental constraints and off-site work, like turn lanes or utility extensions, often bring in several agencies at once. That shrinks the time available before vertical construction can start [18][19].

For power-heavy facilities, utility service is often the hardest part of the schedule to shorten. Grid interconnection and substation construction usually take 18 to 24 months, and those timelines are mostly outside the owner's control [19]. In tight markets like Northern Virginia, utilities may need 3 to 5 years to energize new large campuses because of needed transmission upgrades [11]. Research from Lawrence Berkeley National Laboratory found that interconnection wait times have more than doubled over the past 15 years, with projects now averaging five years in queue before reaching energization [22]. On these projects, utility capacity often becomes the main schedule gate.

Design Changes, Long-Lead Equipment, and Supply Chain Delays

Changes after design development can hit the schedule harder than teams expect. Once scope shifts, updated plan sets may be treated by building departments as new submissions. That can restart permit review or stretch it out. At the same time, equipment that was already released may need to be redesigned, which pushes delivery dates even farther than the design change itself [14][18].

On many mission-critical projects, long-lead equipment drives the schedule more than civil or structural work [2]. Industry surveys found that long-lead items caused 62% of schedule impacts on recent North American data center projects [21]. If a team waits too long to release key equipment, the project can lose months at the back end. Not because the field work moved slowly, but because the gear simply wasn't on site. Late scope changes are even tougher when the MEP and controls team is already short-staffed.

Staffing Gaps in Project Controls, MEP, and Commissioning

One of the most missed schedule risks in commercial development is hiring the wrong construction management roles at the wrong time. If MEP leadership is not in place during design development, equipment specs often stay open too long. That slows the release of switchgear, cooling systems, and controls packages.

An AGC survey found that 83% of U.S. contractors struggle to staff superintendents, 81% struggle to staff project managers and supervisors, and 54% reported project delays tied directly to worker shortages [20].

On mission-critical projects, the hardest roles to fill are MEP Managers and Commissioning Managers [2]. Without a commissioning lead involved during construction, integrated systems testing often gets squeezed or starts late. In plain terms, missing commissioning leadership can delay turnover even after substantial completion. The hiring plan needs to sit on the critical path from day one. The next step is turning these risks into a schedule and hiring plan.

How to Build a More Reliable Delivery Plan

Use phase benchmarks to set up the control tools that keep the schedule honest. In plain English: don't leave the timeline as a static chart. Turn it into a working control plan with a CPM schedule, milestone map, permitting tracker, early procurement log, and workforce plan.

Tool Purpose Phase Impacted Key Benefit
CPM Scheduling Maps logic, dependencies, and the true critical path All phases Exposes float, prevents cascading delays
Milestone Map Translates the full schedule into key decision dates All phases Keeps executives, finance, and field teams aligned
Permitting Tracker Tracks submissions, reviewers, comments, and resubmittals Entitlement, design Surfaces permit delays weeks earlier
Early Procurement Log Monitors long-lead submittal, approval, buyout, fabrication, ship, and installation dates tied to the schedule Design, construction Prevents late equipment from stalling commissioning
Workforce Plan Aligns staffing levels to project milestones Design through turnover Prevents approval delays and leadership gaps
Specialized Recruiting Support Fills hard-to-source roles before they delay the critical path Design through turnover Keeps critical positions from becoming schedule risks

Map the Critical Path From Approval Milestones to Turnover

Build one master CPM schedule that links entitlement approval, design releases, permit submittals, utility commitments, equipment release dates, dry-in, energization, IST, temporary occupancy, and turnover. Each step should connect through dependency links, not just calendar dates. That's how the team sees what actually controls turnover instead of what merely looks important on paper.

Update the schedule weekly as design matures. The controlling issue can shift. On a data center, the bottleneck may be utility energization and generator switchgear delivery. On a healthcare project, it may be AHJ inspections and commissioning signoff. That's why a live CPM schedule matters.

Pair that schedule with a milestone map for executive reviews. The milestone map should show only the dates that matter most to finance, leasing, and operations teams, while still matching the field schedule. Think of it as the short version for decision-makers, without losing the logic behind the job.

Use Permitting Trackers and Early Procurement Logs

A permitting tracker should capture the permit package name, discipline, submission date, reviewer, current status, resubmittal date, comments received, next action, and the responsible owner. Each permit needs one owner, one due date, and one next action. No gray area, no handoff confusion.

Early procurement logs should follow the same idea. Track every long-lead package - switchgear, transformers, generators, chillers, controls hardware, specialty process equipment - with expected submittal, approval, buyout, fabrication, ship, and installation dates. Those dates should tie straight to the schedule's critical path.

The working rule is simple: start procurement planning before construction mobilization for any item that could affect energization, commissioning, or turnover. If a late piece of equipment can stall startup, it belongs in the log early.

Once permits and long-lead items are tracked this way, the next pressure point is staffing the work to match the schedule.

Build Hiring Plans Around Project Milestones

Because staffing gaps affect design, procurement, and commissioning, recruiting has to follow the milestone map. Hiring belongs on the critical path from day one.

Bring in key roles early:

  • Hire the project manager, scheduler, and preconstruction lead before entitlement.
  • Add the superintendent, MEP lead, controls specialist, and commissioning manager before submittals and startup planning.

If those roles are filled late, the right people show up after the key design and procurement calls have already been made. And when that happens, the delay doesn't disappear. It shows up at turnover.

Conclusion: Plan for Actual Duration, Not Best-Case Duration

From entitlement through turnover, project duration is set by constraints, not optimism. In commercial development, timelines are shaped less by how fast work moves in the field and more by approvals, design maturity, procurement, commissioning, and staffing. That’s why so many owners still finish late: best-case schedules often miss the real critical path.

The fix is pretty simple, even if the work isn’t. Manage the full timeline, not just the construction window. Treat the schedule like a live control plan. Map milestones, track permits, log long-lead procurement, and connect hiring plans to project dates.

Sector benchmarks matter too. Data centers often rise or fall on utility energization. Healthcare projects depend heavily on code and occupancy approvals. Advanced manufacturing schedules are often controlled by equipment installation and validation.

It also helps to connect financing draws, vendor deposits, and launch costs to dates that reflect how the project is actually moving. When an aggressive schedule starts to slip, cash-flow pressure follows. Funding lines up with operational readiness only when the schedule matches actual duration.

One question should stay on the table for the full project: What controls the next critical date, and does the team have the people and materials to protect it? That kind of discipline is what protects delivery.

FAQs

What does turnover mean?

Turnover is the formal handoff of a facility from the construction team to the owner. It includes the project documents and the know-how needed to run the place.

This step happens after commissioning and system testing, once subsystems reach Mechanical Completion. It’s a major milestone, but it doesn’t always mean the facility is ready for immediate operation, occupancy, or production.

When should utility coordination start?

Utility coordination needs to begin during site selection and feasibility, long before construction starts. Owners and project leaders should check infrastructure capacity, interconnection timelines, and grid availability early. If they wait, utility issues can turn into major schedule delays.

That work should carry through pre-construction, or Phase 0, with written capacity commitments and service agreements in place before major design decisions are locked in. Utility work and approvals can take more than 12 months, so the project schedule needs to account for that from day one.

Which roles should be hired first?

Hire against the project’s critical path, not a fixed hiring calendar.

Start with the Owner’s Representative, Senior Project Manager, and the project controls team, including cost managers and schedulers. They put governance in place, shape the plan, and set baseline schedules early.

Then bring in MEP leadership, healthcare architects, and civil engineers during design. After that, add construction leadership, such as Superintendents and QA/QC leads, well ahead of mobilization.

Related Blog Posts

Keywords:
commercial development, entitlement timeline, construction schedule, long-lead equipment, utility interconnection, commissioning, project planning, data center timelines
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Intel Ohio One: Construction Status and the Workforce Behind the New Albany Campus
September 1, 2026

Intel Ohio One: Construction Status and the Workforce Behind the New Albany Campus

New Albany site moves from underground to vertical construction; hiring shifts from earthwork to MEP, commissioning and tool-install specialists.
TSMC Arizona Fab Expansion: What the Third Fab Means for Construction Hiring
September 1, 2026

TSMC Arizona Fab Expansion: What the Third Fab Means for Construction Hiring

Third Arizona fab tightens construction labor, raises pay, and ups schedule risk; hire MEP, commissioning, and project leaders early.
EPCM vs EPC on Mine Builds: What Owners Choose and Why
September 1, 2026

EPCM vs EPC on Mine Builds: What Owners Choose and Why

EPC gives price and schedule certainty; EPCM gives owners control and flexibility but needs larger owner teams and assumes more risk.
UFC for Contractors: Unified Facilities Criteria Explained
September 1, 2026

UFC for Contractors: Unified Facilities Criteria Explained

Treat UFC as contract scope: identify governing UFCs early to avoid antiterrorism, QC, and commissioning surprises on DoD projects.
