If I had to sum it up in one line: EPC gives me more price and schedule certainty, while EPCM gives me more control and more work on my side.
That’s the choice most mine owners are making. I’d pick EPC when scope is fixed, lenders want one contract, and I want one party tied to cost and completion. I’d pick EPCM when the mine will be built in phases, scope may shift, and I want direct control over vendors, packages, and changes.
Here’s the article in plain English:

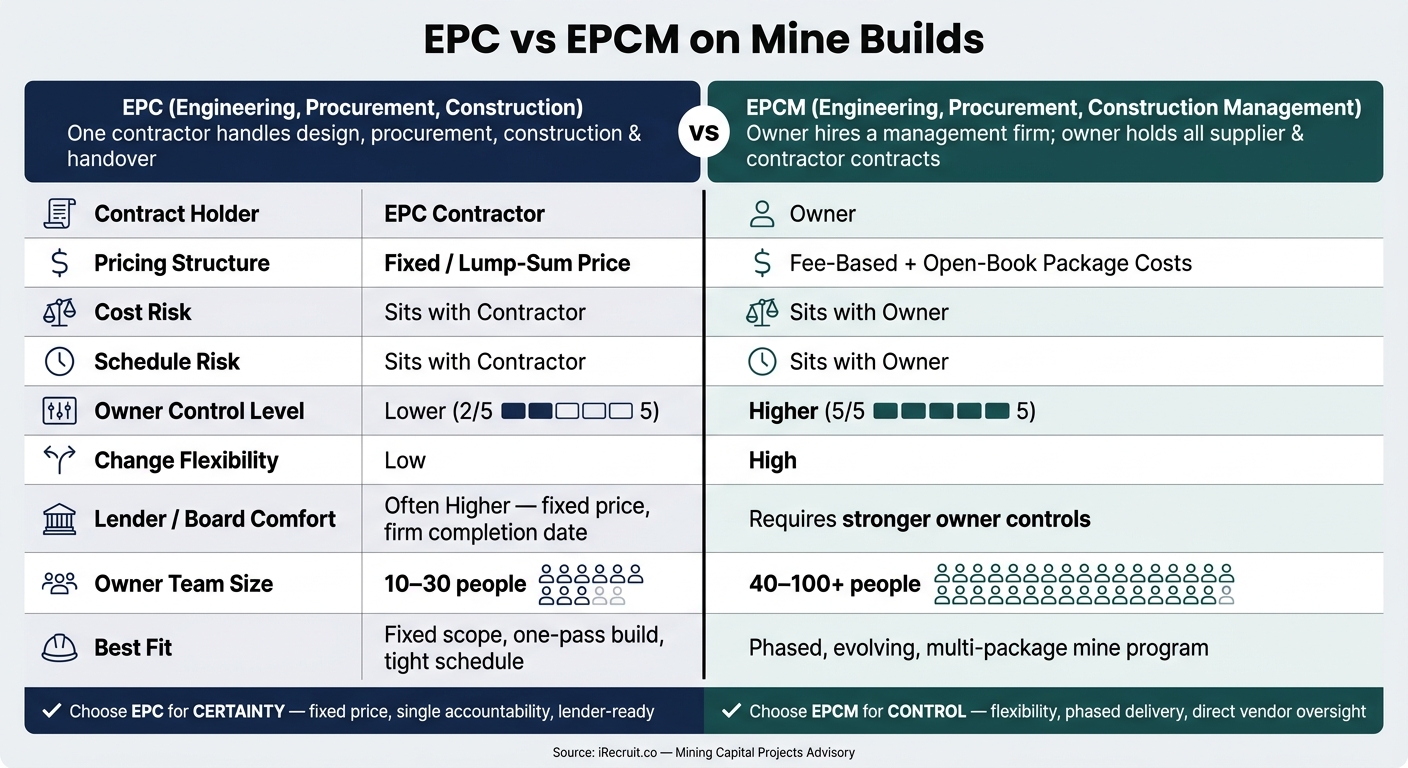

EPC vs EPCM on Mine Builds: Key Differences at a Glance
Bottom line: if I want certainty, I lean EPC. If I want control, I lean EPCM. And if I choose the wrong one, I usually feel it in staffing, claims, delays, and handoffs later.
Mine owners usually make this call by looking at four things: scope certainty, control, risk transfer, and financing tolerance. That’s what tends to shape the choice on a mine build.
The biggest swing factors are control, risk, and how much the scope is still moving.
Under EPC, the contractor runs execution. That helps the owner stay lean, but it also means less day-to-day influence.
EPCM flips that setup. The owner keeps control, including key calls on design, vendors, and changes. But there’s a catch: that only works if the owner can make decisions fast and has solid governance in place.
On mine builds, this gap matters most when key pieces are still in motion. Think process plant selections, tailings designs, and site interfaces. If geotechnical or metallurgical data is still improving, those decisions can shift late, and the contract model starts to matter a lot more.
EPC’s main draw is simple: it pushes cost and schedule risk to the contractor. For many owners, that’s the headline benefit.
With EPCM, the owner gets open-book pricing and direct control over vendors. That can help with visibility, but it also means overruns and productivity misses fall back on the owner’s side. If packages slip or field output drops, the owner feels it.
The fee setup can also be harder to pin down than a fixed-price contract value. That’s one reason lenders often want tighter controls before they get comfortable with EPCM.
EPC makes interfaces simpler. One contractor owns design, procurement, and construction coordination. Fewer handoffs, fewer moving parts for the owner to chase.
EPCM is often a better fit when the mine will be built in stages. It lets owners sequence packages as the mine plan changes, keep supplier competition in play, and adjust scope between phases without setting off a major change order process.
That’s why EPCM often works better for expansions, while EPC tends to fit first-pass builds with a frozen, well-defined scope.
Owners usually pick EPC when they want to hand off execution risk instead of running it themselves. If the scope is set, the package is standard, and there aren’t many moving parts, EPC is often the cleanest option.
That’s especially common on a brownfield expansion with proven equipment and a frozen flowsheet. In that setup, a lump-sum EPC contract can cover everything from design through commissioning. The appeal is pretty simple: one contract, one party in charge, and a clearer path when the project needs board or lender approval on a tight schedule.
EPC works best when the scope is stable and the owner wants a fixed price and one contractor accountable for delivery. A concentrator upgrade or process plant package with a frozen flowsheet and standard equipment is a clear fit.
The owner tenders one lump-sum contract that covers design through commissioning, gets one price and one completion date, and pushes day-to-day execution responsibility away from the owner’s team. That can make capital approval move faster because the owner doesn’t have to manage a web of separate packages and interfaces.
Lenders often like EPC structures because they get one contract, a firm completion date, and fewer package-level interfaces to assess. Fixed-price terms help limit capital cost escalation, which matters when debt service depends on predictable cash flow.
Firm completion dates, backed by delay liquidated damages, also help line up first production with repayment schedules. And performance guarantees on throughput and metallurgical recovery give financiers a stronger basis for revenue assumptions. For boards, the setup is usually easier to review too, with cleaner governance and fewer moving parts to sign off on.
Where scope is still shifting, or where the mine is expected to expand in phases, owners usually move toward EPCM.
EPCM tends to fit projects where scope, sequence, or approvals are still moving around. In those cases, owners often need flexibility more than the certainty of one fixed-price contract. The main reason is pretty simple: if you lock into EPC before the design is mature, costs can climb fast. Permits, land access, power approvals, and community agreements don't always move on the project team's schedule. EPCM gives owners room to resequence work as those outside factors shift.
A staged greenfield copper project is a good example of where EPCM makes sense. Early works, utilities, the plant, tailings, and camp can all move as separate packages while design and permits continue to develop.
Large phased mines, including Minera Escondida, have used EPCM to scale expansion in stages.[4]
This setup matters most when the work can be split cleanly into separate contracts. Under EPCM, the owner and the EPCM team break the job into bid packages such as:
That keeps competition in place and gives the owner more control over timing for each award.
The trade-off is interface risk. When several contracts run in parallel, the owner carries the gap between packages. If the civil contractor finishes late and the mechanical contractor shows up on schedule, that issue falls to the owner to sort out, not to one EPC contractor. More packages also mean more owner oversight, and that changes the kind of owner-side team needed to run the work.
The delivery model shapes the owner-side team in a big way. It affects team size, seniority, and who covers what. On large mine builds, the wrong setup can leave holes in execution. It also decides how much hiring the owner needs to do.
Under EPC, the contractor handles most day-to-day coordination. So the owner’s team can stay fairly lean. On a large greenfield mine, that may mean only 10–30 owner-side project staff, not counting operations. In this model, hiring is usually centered on governance and assurance, not direct delivery on site. [5][7][8]
Typical roles include a Project Director, who carries overall owner risk, manages key stakeholders, and keeps the project tied to the mine’s business case. There’s also an Owner’s Representative, who acts as the main day-to-day contact with the EPC contractor.
A Contract/Commercial Manager is also a core hire. This person manages the EPC contract, tracks variations, and deals with claims and liquidated damages. Owners also tend to bring in Technical Oversight Leads for major disciplines such as mine planning, process plant, tailings, and infrastructure. Add a small project controls team and a Commissioning Oversight Lead, and you have the basic owner-side structure under EPC. That last role matters because handover to operations is often where things can go sideways. [1][5][11]
Under EPC, owners usually need fewer people, but those people need to be senior. They have to read dense reports, make big calls, and protect the owner’s commercial position without stepping in to run the site themselves.
EPCM is a different animal. When the owner holds more contracts, the team has to grow with that load. Since the owner is managing several direct contracts, the team must cover procurement, controls, and site coordination in much more depth. A large mine program delivered through EPCM can need 40–100+ owner-side people across governance, engineering oversight, procurement, construction management, controls, and commissioning. [3][6][9]
Key roles usually include a Capital Projects Director to lead the full program across phases, plus several Senior Project Managers who each own a major scope area. On site, Construction Managers and field superintendents handle execution. The owner also needs a full Procurement and Contracts team to run bids across work packages like civil works, structural steel, mechanical installation, and electrical and instrumentation.
EPCM programs also need deeper bench strength in controls. That means Project Controls Managers, Schedulers, and Cost Engineers who can build and maintain one integrated master schedule across all contractors. Without that, the program can drift fast. [10][12][2]
This is why EPCM calls for more seasoned owner-side staff. Scope can shift fast, and packages are often awarded in quick succession. The owner isn’t just reviewing progress. The owner is running a multi-contract program.
The table below shows the team-level split between the two models:
Hiring needs shift by phase, so timing matters just as much as headcount. A smart sequence helps. Bring in the Project Director and technical leads before FID. Add project controls and procurement during detailed engineering. Then bring in site construction and commissioning leaders before mobilization.
That order can help cut delay risk and limit change-order growth.
The choice between EPC and EPCM comes down to one thing: how much control the owner wants to keep. That tradeoff shows up most clearly in two places - owner control and contractor risk.
EPC works best when the scope is fixed, the schedule is tight, and price certainty matters. In that setup, owners give up some control in exchange for more predictability and single-point accountability.
EPCM is a better fit for complex or phased programs that need more flexibility. The owner stays closer to the work and keeps more control, but also takes on more risk and needs a larger in-house team.
That contract choice also shapes who the owner needs to hire to manage the job. Delivery strategy and hiring strategy should be planned together from feasibility and early capital planning. Pick the model early, staff for it, and the project starts on firmer ground.
Owners usually lock in the delivery model before Final Investment Decision so the schedule, procurement timing, and contract risk split match the project phasing.
Choose EPC if you want one firm in charge, more cost and schedule certainty, and a faster path to execution.
Choose EPCM if you need more flexibility for complex, multi-phase developments, want more owner control over interfaces and major procurement, and can staff project controls, procurement approvals, and construction oversight.
Before choosing EPCM, the owner needs a strong in-house project team. Under this setup, the owner keeps a big share of the work: managing interfaces, forecasting costs, handling risk, coordinating contractors, and keeping the master schedule on track. That means the team can’t just “check in” now and then. It has to stay involved day to day.
The owner also needs enough know-how to define the design basis, approve major procurement awards, and set execution strategies. If there isn’t a dedicated technical team in place - or an Owner’s Representative to fill that gap - project controls can slip, and performance risk goes up fast.
Yes. Mine projects can use a hybrid delivery model that combines EPC and EPCM.
Owners often choose this setup to balance control and risk. For example, they might use EPC for specific processing packages when speed matters, while keeping EPCM services for more complex, phased infrastructure or site-wide integration.
