August 24, 2026

GMP Facility Construction Timeline: Shell to IOQ

By:
Dallas Bond

If shell turnover slips or turnover documents are thin, IOQ usually slips too. From what I see in this article, the path from shell complete to IQ/OQ depends on three things: build in the right order, lock documents early, and staff CQV and MEP roles before the work starts.

Here’s the short version:

  • Shell complete is only the starting line. It means the building is weather-tight and ready for interior GMP work, not close to finished.
  • Fit-out must follow GMP flow. Room zoning, PALs/MALs, finishes, and utility drops need to match the URS before rough-in starts.
  • MEP work drives the schedule. HVAC, controls, clean utilities, power, and fire protection all affect commissioning and IQ/OQ.
  • Above-ceiling clashes can cost weeks. 3D coordination, early procurement, and firm change control help avoid field rework.
  • Pre-commissioning finds problems before CQV does. The article says this step can clear 60%–80% of wiring and mechanical issues before formal testing.
  • Pressure control and cleanroom sealing matter early. Even small leaks at doors, pass-throughs, or penetrations can disrupt target room differentials like 10–15 Pa.
  • IOQ is often delayed by paperwork, not hardware. Missing weld logs, calibration records, as-builts, tag mismatches, and late software changes can stall IQ fast.
  • Hiring is part of schedule control. Senior commissioning and CQV hires may take 90+ days, while niche recruiting may cut that to 45–75 days.

A simple way to read this timeline is:

Stage What needs to happen
Shell turnover Confirm layout, utility stub-outs, URS, and room data sheets match
Fit-out and rough-in Build partitions, route MEP, freeze zoning, control changes
Cleanroom and equipment Close the envelope, install HEPA, set equipment, finish utility hookups
Pre-commissioning Walk down P&IDs, run loop checks, clear punch items
Commissioning Test HVAC, utilities, power, and automation against design intent
IQ/OQ Prove installation matches specs, then test ranges, alarms, and failure response

So if you want the main takeaway in one line, it’s this: shell-to-IOQ success comes down to sequence, turnover records, and early staffing. The rest of the article explains how those pieces connect on a U.S. GMP project.

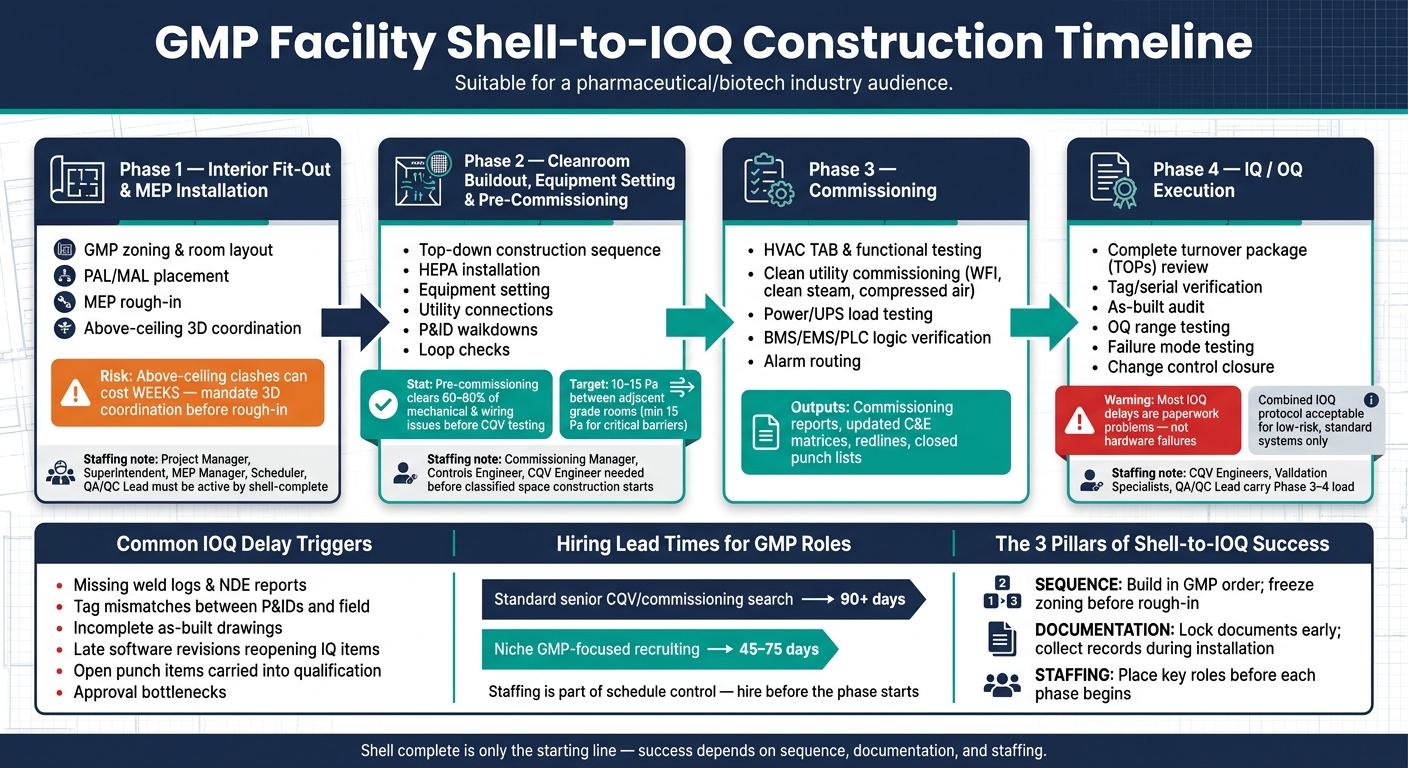

GMP Facility Shell-to-IOQ Construction Timeline: Key Phases & Milestones

GMP Facility Shell-to-IOQ Construction Timeline: Key Phases & Milestones

CQV: What is Commissioning Qualification Validation (IQ OQ PQ) in pharmaceutical industry 2026 Guide

Phase 1: Interior Fit-Out and MEP Installation

With shell turnover done, Phase 1 turns the bare shell into a GMP-ready interior through fit-out, utility rough-in, and MEP installation. What happens here sets up commissioning and IOQ readiness. That’s why space planning comes next.

Build the Interior Around GMP Flows and Zoning

Start with process flow diagrams and the URS to place partitions, grade transitions, and support spaces. Map every operation, assign an ISO or GMP grade to each step, and draw personnel and material routes before you place a single partition. [5] That order shows where grade transitions occur and where airlocks are needed, instead of finding those gaps during late walkthroughs.

PALs and MALs should stay separate, interlocked, and sized for the spaces they serve. Gowning rooms should sit next to PALs and follow a clean-to-dirty flow, with distinct corridors kept in place throughout. [4][5][6][7]

Wall, ceiling, floor, and built-in finish selections need to be locked early based on the cleaning regime and product type. In classified and controlled non-classified areas, the standard is smooth, non-porous, chemically resistant surfaces with sealed joints and as few horizontal ledges as possible. [3][5][10][12] Late changes to coatings or joint treatments can wipe out cleaning validation studies and force repeat IQ/OQ work. For that reason, QA sign-off on the finish schedule before installation starts is time well spent.

Once the layout is fixed, the team can lock rough-in paths and move into MEP coordination.

Install Critical MEP Systems With Qualification in Mind

Install each MEP system as if it is already a future qualified system target. Tag AHUs, HEPA housings, sensors, valves, and panels the same way across P&IDs, panel schedules, and I/O lists. Missing or mismatched tags are one of the most common reasons IQ gets delayed, because protocols must be rewritten or repeated when the documents don’t match field conditions. Those tags also form the backbone of IQ/OQ turnover packages. [8][9][10][13]

The table below shows the main MEP systems, the commissioning tests tied to them, their qualification effect, and where Phase 1 schedule risk usually piles up:

MEP System Key Commissioning Tests Qualification Impact Common Phase 1 Timeline Risks
HVAC & HEPA Distribution Airflow balancing, pressure differential verification, filter integrity tests (PAO/DFT), alarm and interlock checks Base requirement for ISO classification, environmental control, and cleanroom IOQ Late AHU delivery, ceiling-space clashes, design changes to pressure cascades, incomplete controls integration
Electrical & Standby Power Load tests, critical circuit functional tests, ATS transfer tests, protective device coordination Supports reliability of critical GMP loads, data integrity for BMS/EMS, and continuity for validated processes Long-lead switchgear or UPS, late changes to the critical load list, conduit routing congestion
Plumbing & Clean Utilities (WFI, clean steam, process gases) Pressure and leak tests, flow tests, flushing and cleaning verification, slope and drain point inspections Direct effect on process quality and contamination control; needed for cleaning validation Late URS decisions on user points, weld/NDE bottlenecks, hygienic fitting shortages, inadequate maintenance access
BMS/EMS & Controls I/O point-to-point checks, sequence functional tests, alarm and trend verification, 21 CFR Part 11 compliance checks Governs environmental monitoring, alarms, and data integrity; critical for maintaining validated state Late control narratives, incomplete I/O definition, software version changes, vendor integration issues
Fire Protection Flow and pressure tests, alarm and notification tests, coverage verification, BMS interface tests Indirect GMP effect; interfaces with cleanroom envelopes and critical equipment protection Coordination conflicts with ductwork and cleanroom ceilings, late AHJ comments, ceiling congestion

Clean utilities need extra attention during routing. WFI and clean steam lines must avoid dead legs, hold the right slopes, and include drain points that meet hygienic design principles. [8][9] Weld logs, NDE reports, and flushing records tied to tag numbers are required IQ artifacts. They’re much easier to collect during installation than to rebuild later from memory and missing paperwork.

With the main systems mapped, the next problem is trade congestion above the ceiling.

How to Control Schedule Risk During Rough-In and Above-Ceiling Coordination

Above-ceiling space gets crowded fast. Ductwork, pipe racks, cable trays, HEPA housings, and fire protection all fight for the same overhead space. If trades don’t coordinate in 3D before rough-in starts, field clashes can turn into weeks of rework. [3][8][9][10]

The best way to cut that risk is to make 3D coordination sessions mandatory before major rough-in begins, with all trades and CQV involved. [3][8][9][10] Prefabricated MEP racks can cut field congestion in a big way. A clean build protocol also helps: seal the envelope and finish nonclean work before HEPA filters arrive on-site, so contamination issues don’t creep in before commissioning starts. Long-lead items like AHUs, switchgear, clean utility skids, and control panels should be procured during schematic design, not after trade awards. Keep those items on a live risk register with clear owners and escalation paths. That’s how you stop a late delivery from turning into a late IOQ.

Freeze the URS and zoning before rough-in starts, then push changes through formal change control. When process teams add clean utility drops or change zoning after rough-in is in motion, the downstream effects stack up fast: pipe rerouting in crowded ceiling zones, gaps in weld logs and as-builts, and instrument recalibration before IQ can move ahead. [3][8][9][10]

Once rough-in is coordinated and utility routes are frozen, the project can move into cleanroom buildout and equipment setting.

Phase 2: Cleanroom Buildout, Equipment Setting, and Pre-Commissioning

Once the MEP rough-in is coordinated and utility routes are fixed, Phase 2 turns that installed backbone into a GMP-ready space. This is the point where walls go up, HEPA units get installed, and process equipment moves into place. Put simply, Phase 2 sits between rough-in and formal commissioning.

Complete Cleanroom Construction and Cleanroom Interfaces

Use a strict top-down sequence. First, sign off on above-ceiling MEP work. Then install wall tracks, walls, ceilings, doors, glazing, pass-throughs, HEPA housings, and coved flooring. Every penetration needs GMP-grade sealant.

Resinous or sheet flooring with coved bases creates a continuous cleanable surface. It runs up the wall with no gap and no ledge, which matters more than people think when cleaning starts day after day.

Keep the pressure boundary sealed. Every door seal, pass-through frame, and utility penetration should go through visual inspection and smoke testing before HVAC balancing begins. The target is 10–15 Pa between adjacent rooms of different grades, with 15 Pa at minimum for critical cases, such as between a graded production room and a barrier airlock. [11][15]

If those pressure differentials are tough to maintain after balancing, the cause is often simple: a bad seal or a breach in the room boundary. That kind of issue is far easier to fix before IQ than after.

Set hard completion dates for each room envelope by working backward from the air-balancing date. Miss one envelope milestone, and the delay can spread fast into the IOQ schedule as dependencies pile up.

Set Process Equipment and Complete Utility Connections

Equipment setting starts after the cleanroom envelope is closed, but before final finishes and detailed cleaning. Confirm subfloor load ratings and egress clearances first. Then match equipment footprints against the approved coordinated model.

For vibration-sensitive units like centrifuges or lyophilizers, install isolation mounts and grout pads based on structural engineer approvals before the equipment is placed. [2]

Every utility connection has to match the P&IDs and isometric drawings before the system can move into commissioning. That includes:

  • WFI
  • clean steam
  • compressed air
  • process gases
  • CIP/SIP lines
  • electrical feeders
  • I/O terminations

Check drain-line slopes, orbital welds on sanitary piping, and insulation against redlined as-builts. At the same time, collect weld logs, material certificates, and calibration records for every tagged instrument during installation, not weeks later when someone is chasing paperwork.

Bad or incomplete as-built data is one of the most common reasons IQ/OQ gets delayed. That's why many U.S. projects now build as-built verification milestones straight into the construction schedule. [2]

Use Pre-Commissioning to Catch Installation Issues Early

Pre-commissioning is the handoff point between mechanical completion and commissioning. This is where teams find the issues that would otherwise blow up during CQV testing.

P&ID walkdowns check each line, valve, and instrument against the drawing. Loop checks confirm that every field instrument signal reaches the control system with the right wiring, range, and signal direction. Pressure tests, flushing records, and functional checks - like motor rotation and valve stroke testing - fill out the package. Each issue should be logged on a punch list with a named owner and a close-out date.

A disciplined pre-commissioning program can clear 60–80% of mechanical and wiring issues before CQV testing starts, which lowers the chance of failed IQ/OQ steps. [14][16]

Before any system goes live under power, a pre-startup review acts as the formal gate. It confirms that safety punch items are closed, as-builts are up to date, lockout/tagout plans are ready, and operating procedures, emergency shutdown procedures, and operator training plans exist for the first run.

Use the table below to track the handoff from construction to qualification.

Major System Construction (Phase 2) Commissioning (Pre-IQ/OQ) Qualification (IQ/OQ)
Cleanroom Architecture Wall/ceiling systems, doors, pass-throughs, penetration seals, flooring and coves Room integrity, door operation, pressure control, environmental monitoring probes IQ: Materials and installation vs. specs; OQ: Classification, pressure cascades, and recovery
HVAC & Terminal HEPA Air handlers, ductwork, terminal HEPA housings, sensors, and dampers Fan start-up, airflow balancing, alarm and interlock tests, HEPA leak and visualization tests IQ: Components, tags, installation; OQ: Temperature, humidity, airflow, and pressure stability under load
Process Equipment Set and anchor equipment; connect piping, drains, WFI, clean steam; install controls interfaces Dry runs, power-on tests, motor rotation, functional checks, SAT with OEM IQ: Installation, utilities, and tagging; OQ: Functional tests under simulated conditions
Clean Utilities (WFI, clean steam, gases) Install and weld piping, hydro/pressure tests, insulation, line labels, drain connections Flush and sanitize lines, verify flows and pressures, quality sampling IQ: Line routing, slopes, materials; OQ: Utility quality and capacity across design ranges
Controls/Automation (BMS/EMS/DCS/PLC) Panels, cable trays, field wiring, I/O terminations, cable and device labels Loop checks, logic and interlock testing, HMI graphics, alarm and trend checks IQ: Panel layouts, I/O assignments, tag consistency; OQ: Control responses and alarm behavior

Once the envelope, utilities, and controls clear pre-commissioning, the project can move into formal commissioning.

Phase 3: Commissioning Through IOQ Execution

Once pre-commissioning punch lists are closed and systems are handed over, the project moves into its most document-heavy phase. This is where pre-commissioned systems become IQ-ready assets. That handoff only works when the turnover package is complete, the punch list is closed, and controls and utilities are sitting on stable baselines.

Commission Building, Utility, and Automation Systems

Commissioning shows that installed systems run the way the design says they should before IQ/OQ begins. Put simply, it turns installed equipment into traceable proof for CQV, which is the next step in the shell-to-IOQ chain.

For HVAC, that starts with TAB to confirm design airflows and room pressure cascades. After that, each air handling unit goes through functional testing: start/stop sequences, damper operation, setpoint stability under load, and emergency shutdown behavior.

For clean utilities like WFI, clean steam, and compressed air, commissioning checks flow, pressure, temperature, and basic alarm response at points of use. Power systems go through load testing, emergency generator transfer testing, and UPS verification so the team can confirm that critical systems stay live during simulated power loss.

Automation commissioning focuses on control logic and sequences in the BMS, EMS, process control system (PCS), or PLC. That includes normal startup, interlocks, emergency shutdown, and alarm routing. Each critical alarm should be triggered and verified for correct annunciation.

The output from this phase matters because IQ depends on it. That includes:

  • Commissioning reports
  • Updated cause-and-effect matrices
  • Redlines
  • Closed punch lists

Those records become the starting point for IQ.

Execute IQ and OQ With Complete Turnover Packages

Before IQ starts, the turnover package (TOP) has to be complete. That means approved P&IDs, as-builts, tag lists, MOC certificates, weld logs, calibration certs, FAT/SAT reports, and commissioning results. If the TOP has gaps, IQ can stall fast.

During IQ, the team checks that every tagged component matches its design specification. That covers model number, serial number, materials, orientation, utility connections, and installation against manufacturer recommendations. For automation systems, IQ also checks software version control, I/O wiring against loop diagrams, and whether audit trails and access controls are active.

Most IQ work is document review. That's why a complete TOP isn't just nice to have - it's what keeps the work moving. From there, OQ tests those same systems across operating ranges.

OQ shifts the focus from installation to performance. Systems are tested across their full operating ranges, not just at nominal setpoints. For HVAC, that means showing temperature, humidity, and pressure control, including room recovery after door openings. For process equipment, OQ pushes control loops at upper and lower limits, runs sterilization or CIP/SIP cycles to confirm repeatability, and intentionally triggers failure modes such as sensor failures, emergency stops, and power interruptions to confirm safe, predictable response.

FDA expects OQ to be risk-based and traceable to the URS, with tested ranges and failure modes clearly justified in the protocol. [1][17] Any failed test or deviation has to go back through change control before qualification can close.

Keep IOQ on Schedule With Disciplined Documentation and Change Control

The most common IOQ delays usually aren't technical. They're paperwork problems. Incomplete turnover binders, late software revisions that reopen IQ items, open punch items carried into qualification, and approval bottlenecks can each add weeks to the schedule.

A combined IOQ protocol can save time for low-risk, standard systems like utility sub-systems and simple equipment. It does that by folding installation checks and operational testing into one structured document. But the line between IQ and OQ still has to stay clear. Acceptance criteria should remain separate, and each phase needs its own sign-off so traceability doesn't get muddy.

High-risk systems like aseptic filling lines or sterilizers should keep IQ and OQ as separate staged protocols, with QA approval between phases.

Change control is the other big pressure point. Any field change made after final TAB or after the software baseline is set - a rebalanced damper, a revised setpoint, a wiring correction - has to move through formal change control and then be re-verified before the affected IQ or OQ step can close.

That's what keeps IOQ from drifting off schedule. Skip that step, and the result is often inspection findings that cost far more to fix than the original change.

Qualification Stage Primary Purpose Key Tasks Typical Outputs When Combined IOQ Applies
IQ (Installation) Verify build matches design Tag/serial verification, MOC review, calibration checks, as-built audit IQ report, calibration certs, weld logs Low-risk utilities and standard equipment
OQ (Operational) Verify functional limits Alarm/interlock testing, failure response, range testing OQ report, functional test data Low-risk, standard systems only
Combined IOQ Compress schedule Simultaneous verification of installation and function with separated acceptance criteria Integrated IOQ report with distinct IQ/OQ sign-offs Standardized, low-complexity systems only

Workforce Planning and Conclusion: The Roles That Keep Shell-to-IOQ Delivery on Track

Match Key Roles to Each Phase of the Timeline

As a project moves from construction into CQV, staffing becomes part of schedule control. It can't be treated as a late admin task. From shell completion through IOQ, each role needs to be in place before its phase starts.

By shell-complete, project managers, construction superintendents, and MEP managers should already be active. Schedulers and QA/QC leads need to be in place no later than the start of interior fit-out. If leadership shows up late, RFIs and change orders start stacking up without a clear owner. Then above-ceiling coordination slips, BIM clashes turn into field conflicts, overtime climbs, and turnover dates move to the right.

Phase 2 needs a different team. Commissioning managers, controls engineers, and CQV engineers should be brought in alongside cleanroom contractors and equipment installation supervisors before classified space construction starts. If commissioning and CQV support don't come in until the cleanroom envelope is closed, handoff gets muddy. Testability isn't clear, and documentation often doesn't line up.

Phase 3 is where the CQV execution team carries the load: CQV engineers, validation specialists, and QA/QC leads. CQV can take up a big share of the back half of the schedule. When this phase is short on people, the impact goes beyond a slower IOQ. It can create data integrity risk and deviation backlogs that push regulatory-readiness dates by weeks or even months.

The table below maps the key roles to the phase they need to support.

Phase Must-Have Roles Primary Risk if Understaffed
Fit-Out & MEP Project manager, superintendent, MEP manager, scheduler, QA/QC lead RFI backlogs, field clashes, non-compliant installations
Cleanroom & Equipment Commissioning manager, controls engineer, CQV engineer Untestable systems, documentation gaps at turnover
Commissioning & IOQ CQV engineers, validation specialists, QA/QC lead Protocol delays, deviation backlogs, missed readiness dates

Labor shortages make early hiring a must. Senior CQV and commissioning searches often take 90 or more days, while niche recruiting can cut that to 45–75 days. [18]

How iRecruit.co Supports Hiring for Hard-to-Fill GMP Construction Roles

iRecruit.co

The roles most likely to create schedule risk are often the hardest to fill: senior MEP managers with GMP experience, commissioning managers who know FDA-regulated environments, controls engineers with BMS/EMS/PCS backgrounds, and CQV/validation specialists. These jobs call for technical depth, delivery experience, and regulatory fluency. Most generalist candidates just don't bring that mix.

iRecruit.co focuses on GMP construction and CQV hiring, helping owners, contractors, and CQV firms fill senior MEP, commissioning, controls, and validation roles faster. Because iRecruit.co screens for GMP experience, regulatory awareness, and the ability to work under schedule pressure, time-to-fill for niche roles can drop from 90+ days to 45–75 days. [18] On a schedule-driven project, that gap can decide whether commissioning and IOQ start on time or slip.

Conclusion: Sequence, Documentation, and Staffing Drive Shell-to-IOQ Success

Shell-to-IOQ delivery stays on track when three things are managed together: sequence, documentation, and staffing. Those three elements are what keep the work predictable and inspection-ready.

That means defining shell-complete clearly, aligning fit-out with GMP flows from day one, installing and documenting MEP systems with qualification in mind, coordinating cleanroom and equipment readiness with commissioning and CQV plans, and staffing each phase early enough to avoid resource cliffs. When sequence, documentation, and staffing are managed as one connected system, shell-to-IOQ delivery becomes far more predictable - and regulatory readiness is less likely to turn into a last-minute scramble.

FAQs

How long does shell to IOQ usually take?

It varies a lot based on how complex the project is. But one thing is common: validation by itself often adds 6 to 12 months after mechanical completion.

Inside that window, IOQ execution usually takes 8 to 12 weeks. That’s a lot longer than the 2 to 4 weeks some teams expect at the start.

And that’s where schedules can slip. If hiring specialized CQV staff takes longer than planned, or if design issues show up late, startup can get pushed back by another 3 to 12 months.

What documents are needed before IQ can start?

Before Installation Qualification (IQ) starts, the facility needs to show that the system was built the way it was designed. That proof usually comes from approved commissioning test scripts, FAT and SAT records, and a basic Turnover Package (TOP).

The TOP should include the core handover documents teams need to check the installation. This usually means:

  • as-built drawings
  • equipment data sheets
  • calibration records
  • material certificates
  • weld logs
  • verified equipment serial numbers

If there are any punch list items or deviations, those need to be formally closed through change control before qualification can begin.

When should CQV and MEP hiring begin?

CQV professionals and MEP leadership should come in as early as possible, ideally during pre-design and early planning.

Getting CQV leads involved by design freeze, or during the User Requirements Specification phase, helps teams deal with validation needs before construction starts. MEP leadership should be in place before major system procurement. Automation and controls staff should also join early so testing can be finished before turnover.
