Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If ITAR controls are not built into the facility plan early, owners often pay for it later in change orders, delays, and extra security work.
I’d boil this article down to one point: define the ITAR zones first, then design every door, route, storage area, camera, server room, and recordkeeping process around those boundaries. The piece is about what owners need to put into the building before design wraps up, so the site can control access, protect technical data and parts, log activity, and support audits. It also points to a hard recordkeeping rule: under 22 CFR §122.5, some records must be kept for at least five years.
Here’s the short version of what needs to be built in:
What matters most: if a space handles ITAR data, parts, systems, or even routine transfer traffic, I’d treat it as a controlled zone and show that on the drawings.
This article is a build-focused checklist, not a legal reading of export rules. It helps owners line up the physical layout, security hardware, and records process before the first wall goes up.

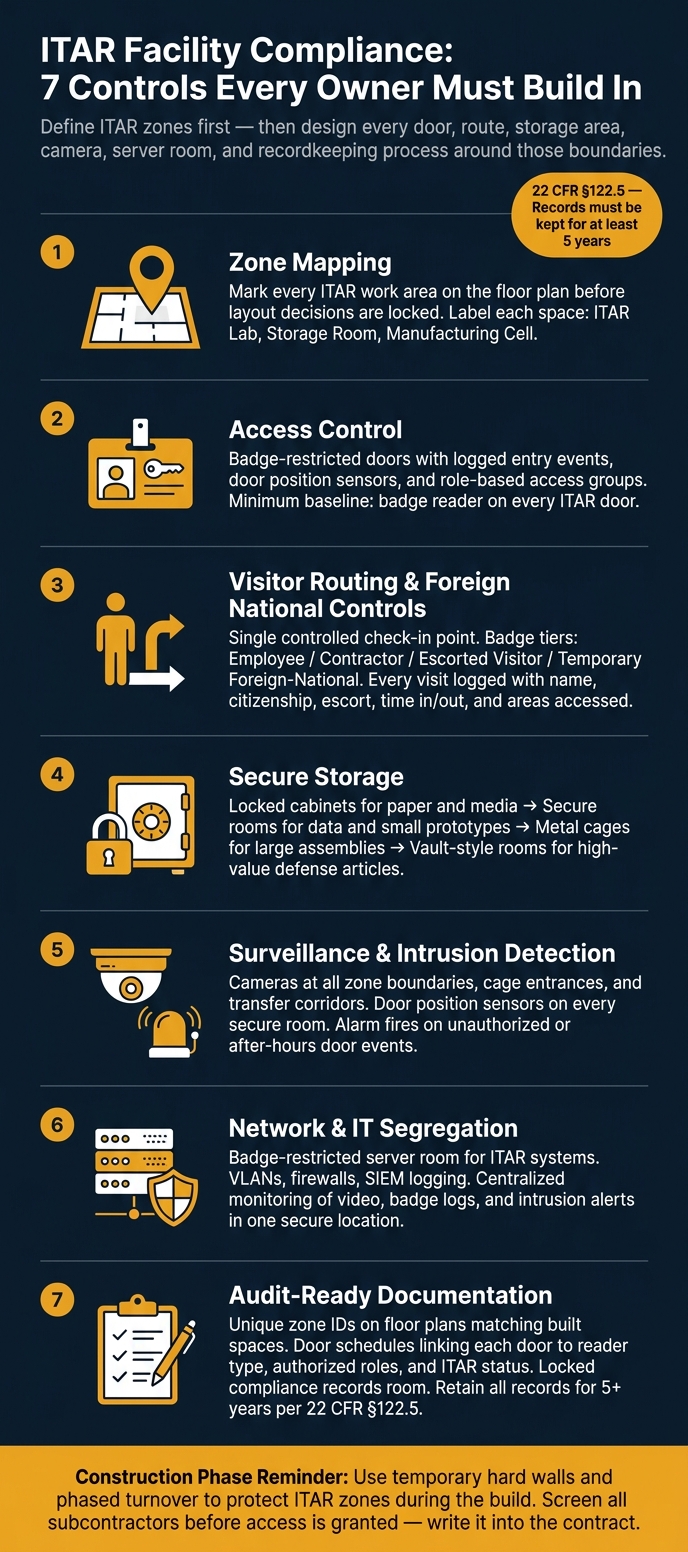

ITAR Facility Compliance: 7 Controls Every Owner Must Build In
Map every ITAR-controlled activity before the design is locked in: engineering, prototyping, testing, assembly, storage, and shipping. Then mark each one on the floor plan and document it in a facility zoning plan used for design reviews and audits. That includes server rooms, secure meeting rooms, manufacturing cells, and records storage. This map sets the path for where walls, doors, and restricted routes need to go.[1][3][13]
After you identify the controlled activities, draw them on the architectural and security plans as clear, enclosed boundaries. Each controlled zone - whether it's a badge-restricted engineering lab, a separated manufacturing cell, or a secure work area - should have walls, controlled doors, and as few entry points as possible.[1][7][10]
On the drawings, label each controlled space in plain terms: "ITAR Controlled Lab", "ITAR Storage Room", "ITAR Manufacturing Cell." Add the access rule at every door, such as badge-only, escort-required, or foreign-national restrictions. Any opening into the space - service doors, utility hatches, or loading docks - needs the same level of access control and intrusion detection.[1][10]
A space should be treated as a controlled zone if it regularly meets any of these conditions:
If one of those conditions applies on a regular basis, formally designate the space and note it on the drawings with the needed hardware and access rules.[7][14]
Keep general circulation out of controlled zones. Use dedicated ITAR rooms, separated staging areas, and corridors that don't cut through controlled work areas.[1][6][13]
Wherever practical, separate tooling, test rigs, and staging areas used for ITAR work. A dedicated ITAR-only staging area at receiving - instead of a shared loading dock - can close a common compliance gap. If the site is under renovation, set clear exclusion zones and require vetted, escorted access for any worker who has to enter a controlled area. Those requirements should be written into the bid package from the start.[5][8][12]
These zone lines shape the badge readers, visitor paths, and door controls that come next.
Once the zone map is in place, the next step is to build the controls that enforce it. Put the hardware, badge rules, and visitor process into the construction documents from the start. If you wait until after move-in, you're patching holes instead of setting the rules up front. These entry points set the ground rules for who can reach storage, equipment, and network spaces inside the zone.
Every door leading into an ITAR-controlled space should have a badge reader tied to a central log that records who entered, which door they used, and the time of entry.[1] Call out electrified hardware, such as electric strikes or maglocks, and make sure those devices tie into the fire alarm and egress plan. Add door position switches so security staff can spot propped doors or forced entry.[1]
Post clear signage on the exterior of each controlled door, such as ITAR Restricted Area - U.S. Persons Only.[15] Access should move through a documented approval process, not an informal request or one-off badge change. Role-based access groups help keep this clean. If someone leaves a team or no longer needs entry, removing that person from the group blocks badge access at every door in that zone right away, and the system keeps an audit trail showing who made the change and when.[1][17]
Set up the reception area so every visitor goes through one controlled check-in point.[1][16] Keep waiting areas and meeting rooms outside the controlled zone. Use full-height walls or controlled doors so visitors don't have a direct line of sight into labs or production areas.[6][9][16] Turn workstations away from corridors, and add privacy screens where needed.[6][9]
Badge tiers should make status obvious at a glance:
That distinction matters in day-to-day use. Staff policies should require employees to challenge any unescorted person who has escort-required access status.[9][4] Every visit also needs to be logged with the visitor's name, organization, citizenship, escort, badge number, time in, time out, and areas accessed, in a format that can produce export-control-ready reports on demand.[4][1][17] At departure, collect the badge and close out the log.[4][16]
If a foreign national needs access to a controlled area under a license or Technical Assistance Agreement, the access-control system should allow temporary, room-specific permissions tied to the exact approved time window. Escort should be required, and the related export authorization should appear in the visitor record.[2][1]
Those routes should lead straight into secure storage and monitored work areas, not through general circulation.
Choose the least complex control that still fits the zone's risk.
Hiring for a mission-critical build? Get a pre-qualified shortlist.
iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.
Get Started
Success-based pricing · 90-day replacement credit · No upfront fee on single roles
Once access routes are set, the next job is to build the spaces that protect whatever sits behind those routes. That means storage areas, camera coverage, alarm systems, and network rooms need to be part of the construction documents from day one, not patched in later.
Store paper records and small media in fire-rated, lockable cabinets that are anchored to the building structure inside a secure room. Use secure rooms for routine ITAR data and lower-risk hardware. For larger prototypes, assemblies, and in-process parts, use metal cages. Each cage should have mesh walls and one controlled entry point inside a secure room or warehouse bay. That setup keeps controlled hardware apart from general inventory and pushes all movement through a single logged point.
For high-value or more sensitive defense articles, plan for vault-style rooms with reinforced construction, high-security locks, tamper-resistant construction, intrusion detection, minimal shelving, and no windows. Every entry should be deliberate and logged.
Place lockable cabinets and cages close to desks, inspection benches, and machine tools so technicians can secure drawings and media without walking across the facility. In office and engineering areas, set up clean-desk zones with nearby lockable storage. On the production floor, define ITAR work cells with marked boundaries, dedicated racks or cabinets, and controlled return points for parts and media at the end of each shift.
After storage is contained, you need to monitor every entry, exit, and alarm event.
Place cameras at every boundary and transfer point shown on the zoning plan. Install them at all primary and secondary entries to controlled zones, aimed at doors, badge readers, and the corridor beyond. Cover cage and vault entrances with a view of the immediate interior near the entry point. Put cameras in corridors that connect general workspace to ITAR zones. For ITAR-only manufacturing cells, cameras should cover the cell perimeter and the main operator stations.
Every door into a secure room, cage, or vault should have a door position sensor tied to the access control system. If a door opens without a valid badge, or opens after hours, an alarm should fire. In higher-risk spaces, add interior motion sensors that arm when no one is supposed to be there. Send camera feeds and alarm events to a central monitoring system in the secure server room so video, badge logs, and intrusion alerts can be checked in one place.
That same controlled-zone approach should extend to the facility’s IT and communications room. Set aside a badge-restricted server room for systems that handle ITAR technical data. Limit access to vetted IT staff. Escort and log all non-routine maintenance. Plan rack space, patch panels, and cabling early so VLANs, firewalls, logging, and SIEM tools fit into the design without later rebuilds.
Match the control tier to the asset. Use simpler measures when cabinets and room-level access do the job, and keep vault-style storage for the highest-risk items. The aim is a layered system, so one weak point doesn’t expose controlled data or hardware.
Once the physical controls are in place, the next step is making the facility auditable. An ITAR site should be audit-ready from day one. That means the documentation system needs to be part of the design itself, not something patched together after move-in.
Every controlled zone needs a unique identifier on the floor plan that matches the built space. Zone maps should clearly separate ITAR-restricted areas, general production space, and office zones. Each controlled room or door should use the same label across drawings, signs, and access-control software. Those maps should sit alongside a door and hardware schedule that links each door ID to its reader type, lock type, authorized roles, and ITAR restriction status. If an auditor looks at a door, they should be able to trace that control back to the schedule without any guesswork.
Keep one retrievable set of zone maps, door schedules, access logs, and inventories. Under 22 CFR §122.5, covered records - including visitor logs and access records - must be kept for at least five years.[18][11] Set aside a locked compliance records room for zone maps, visitor logs, incident reports, and badge and access-control records so staff can pull them fast during an audit. The floor plan, door schedule, and records set should all line up and tell the same story.
During construction, those same zone boundaries still matter. In many cases, construction is the highest-risk period for ITAR exposure. You've got multiple trades and vendors moving through the site before the final controls are even live.
Use temporary hard walls, lockable doors, or secure fencing to separate future ITAR-controlled areas from the rest of the jobsite. Show those barriers on construction-phase drawings. Plan phased turnover so completed rooms or manufacturing cells move under ITAR access-control rules as soon as they're ready, well before the full facility is done. Keep contractor staging areas, tool storage, and break spaces outside ITAR zones. That's the cleanest way to cut down avoidable exposure.
Subcontractor screening rules should be written into the contract, not saved for a late conversation after award. Spell out U.S. person status for unescorted access, background check standards, export control training before badging, and signed acknowledgment of ITAR restrictions. Owners should also put experienced project leadership in place - people who understand phased turnover, controlled routing for cabling and utilities, and how to verify access-control, camera, and logging systems as each part of the build is finished. On more complicated projects, bring in physical security engineers, export-compliance coordinators, and secure IT/network designers.
Most ITAR risk is set long before the first wall goes up. Owners need to bake these controls into the project from the start:
Base it on your workflow and the defense articles or technical data you handle. Start by pinpointing the rooms where controlled technical data is viewed, defense articles are kept, or restricted technology is used during manufacturing.
From there, map those needs across receiving, inspection, storage, assembly, and testing. The goal is simple: support one-way movement where possible and keep access tight instead of broad.
That can mean setting up:
Done well, this shrinks the ITAR-controlled footprint and keeps sensitive work from spilling into areas that don’t need it.
Before construction starts, owners should plan for the security features needed for ITAR compliance. That usually includes:
The layout matters too. A good plan should support one-way workflows, segregated manufacturing cells for quarantine, and built-in controls such as ESD-safe flooring and cleanroom airlocks.
Keep a searchable digital archive that shows how systems were built, installed, and checked against project requirements.
The core file set usually includes as-built drawings, operation and maintenance manuals, equipment data sheets, change reconciliation logs, inspection reports, and certificates of occupancy.
You’ll also want records that support traceability and commissioning. That means keeping purchase orders, certificates of conformance, mill test reports, serial, lot, and heat numbers, calibration records, weld logs, material certificates, and version-controlled RFIs, change orders, and revision logs.
The goal is simple: if someone needs to confirm what was installed, when it changed, or whether it met the job requirements, they should be able to find the answer fast in one place.
