September 1, 2026

USP 797 and 800 for Owners: What Compounding-Space Construction Requires

By:
Dallas Bond

If you get the scope wrong on day one, your pharmacy build can miss certification, miss budget, and miss go-live.

If I were an owner, I’d treat USP <797> and USP <800> as project-defining rules, not late-stage checklists. The big calls come early: sterile vs. nonsterile, hazardous vs. nonhazardous, and Category 1 vs. Category 2 CSPs. Those choices drive the room plan, airflow, pressure, exhaust, finishes, staffing, paperwork, and cost.

Here’s the article in plain English:

  • Category 2 sterile compounding needs an ISO Class 5 PEC inside an ISO Class 7 buffer room with a classified ante room.
  • Category 1 can use a segregated compounding area, but BUDs are tighter.
  • Hazardous sterile compounding usually needs negative pressure of -0.01 to -0.03 in. w.c., 30 ACPH, and external exhaust.
  • Non-hazardous sterile rooms are usually positive pressure with 30+ ACPH.
  • HD storage must stay separate and, for antineoplastics, in a negative-pressure, externally vented room.
  • Finishes must be smooth, non-porous, cleanable, and chemical-resistant.
  • The space is not ready at construction finish. It still needs commissioning, certification, reports, SOP inputs, and staff training records.
  • Cleanroom HVAC can use up to 15x more energy than normal commercial systems.
  • Long-lead items like BSCs, CACIs, air handlers, and pressure monitors can take 8 to 20 weeks.

A few owner takeaways stand out:

  • Lock the basis of design and user requirements early.
  • Map people flow and material flow before layout is final.
  • Pick a contractor and MEP team with USP cleanroom project history.
  • Tie payment milestones to fixing test failures before turnover.
  • Do not treat “construction complete” as “ready for compounding.”

Clean Room Design: Pharmacy Flow with USP 797 and USP 800 Standards

Quick comparison

Topic Non-hazardous sterile Hazardous sterile
Pressure Positive Negative
Air changes ≥30 ACPH ≥30 ACPH
Exhaust Not the same HD exhaust rules Ducted to exterior; no recirculation
Main room type ISO 7 buffer + ante for Category 2 ISO 7 HD buffer + ISO 7 ante
Main owner risk Poor layout or underbuilt HVAC Exhaust routing, containment, pressure control

In short: this article explains how owners should plan, fund, build, test, document, and staff a compounding suite so it can pass certification and open without last-minute rework.

Planning the suite: room types, adjacencies, and workflow

Use the BOD and URD from the previous section to turn scope into room-by-room requirements. Once the scope is set, map every room, door, and travel path.

Ante rooms, buffer rooms, HD storage, and receiving areas

At a minimum, the program should include an ante room, sterile buffer room(s), hazardous-drug buffer room, dedicated HD storage, receiving/unpacking, waste handling, and support storage. Owners set the program. The design team turns that program into walls, doors, and equipment.

Each room has a clear role. The ante room handles hand hygiene, garbing, staging, and decontamination. For sterile compounding, it is typically ISO Class 7 when it opens into a hazardous-drug buffer room (C-SEC), and it must keep the right pressure relationship with nearby spaces [16][10]. The buffer room is where the primary engineering control (PEC) sits and where sterile compounding happens. Sinks and floor drains do not belong in the buffer room. Water sources belong in the ante room, at least 1 meter from the buffer room entrance [16][17][10].

Leave these rooms out, and problems show up fast. Cross-traffic increases. Segregation gets weaker. Redesign becomes more likely. If there is no dedicated HD storage room and hazardous drugs are mixed with general stock, that can violate the rule that antineoplastic HDs must be stored in a negative-pressure, externally vented space separate from non-HD areas [9][12]. If waste handling has no defined space, HD waste often ends up moving back through ante or buffer rooms, which creates exposure risk and segregation failures [11][1].

Personnel and material flow that prevents cross-contamination

Room placement only works if personnel and material move in one direction. Before design moves too far, owners should map personnel flow diagrams. Show where staff enter, where they wash hands, where they gown, and how they move into buffer and HD rooms. Then check that door locations and sink positions support that sequence during actual workload, not just on paper [6][7][10][3].

The goal is simple: move from clean to dirty in one direction. Staff go from the general pharmacy into the ante room, complete hand hygiene and the full gowning sequence, and then enter the buffer or HD room. On the way out, paths should return through the ante room for de-gowning, so contaminated garb does not travel through public corridors. Material flow should follow the same logic. HDs should move one way only: from receiving and unpacking into HD storage, then into the HD compounding room, and out through dedicated waste routes. They should never backtrack through clean ante areas or general pharmacy space [11][1][12][3]. Pass-throughs can help move finished preparations out of buffer rooms while keeping pressure relationships in place, but they need to sit where they do not trigger frequent door openings that weaken the pressure cascade [15].

Bad flow does more than create survey findings. It also slows down daily work. Model door swings, cart paths, and pass-through use at peak volume before locking the layout. That flow map then becomes the starting point for engineering and containment design.

Full cleanroom suites vs. containment segregated compounding areas

The room model you choose sets the limits for space, HVAC, and compounding. Pick the model that fits current volume and expected growth.

A full cleanroom suite usually pairs an ISO Class 7 ante room with an ISO Class 7 buffer room running at least 30 air changes per hour (ACPH). This setup is required for Category 2 CSPs under USP <797> and supports longer beyond-use dates (BUDs) and a broader mix of sterile preparations [8][10][16][2]. A C-SCA, on the other hand, is an unclassified room with fixed walls, dedicated exhaust, negative pressure, and at least 12 air changes per hour [6][8][11][12][15]. It takes less space and can lower upfront cost, but every CSP prepared there is limited to a BUD of 12 hours or less [6][13][3]. That limit affects batch sizes, scheduling, and labor in ways that can wipe out the early savings if the program has meaningful volume.

Feature Full Cleanroom Suite (ISO 7 Ante + ISO 7 Buffer) C-SCA
CSP categories supported Category 2 CSPs; extended BUDs [2] Limited hazardous-drug compounding; BUD ≤12 hours [6][13][3]
ISO classification ISO 7 ante and buffer; ≥30 ACPH in buffer [8][10][16] Unclassified; minimum 12 ACPH [6][8][11][12][15]
Space and construction impact Larger footprint; higher HVAC capacity; stricter finishes Smaller footprint; lower space and HVAC demand
Best fit High-volume, complex, or growing programs Low-volume or transitional programs with short BUD tolerance

Choose the smallest room model that still fits volume and BUD needs. That choice sets the direction for the mechanical and building-envelope requirements next.

Hiring for a mission-critical build? Get a pre-qualified shortlist.

iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.

Get Started

Success-based pricing · 90-day replacement credit · No upfront fee on single roles

Engineering and construction requirements that drive cost and schedule

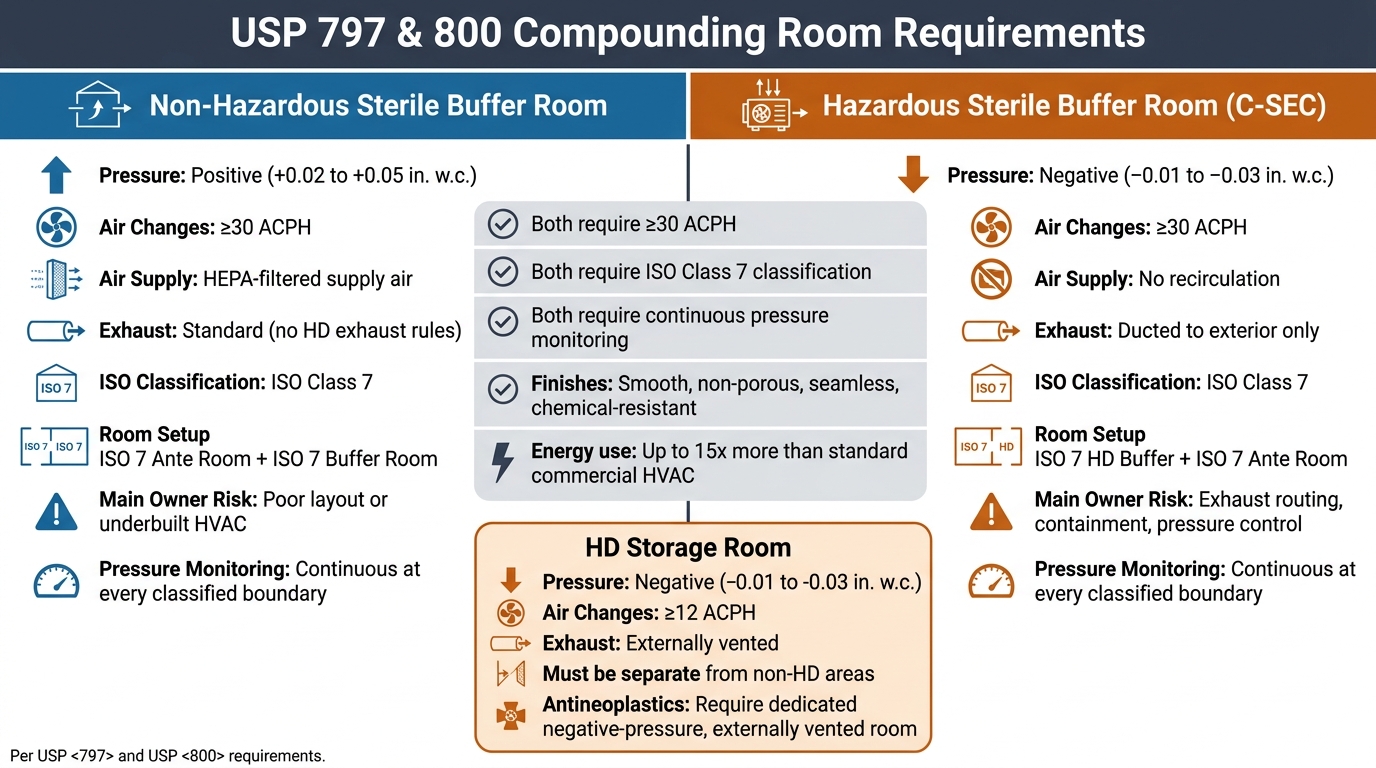

USP 797 & 800 Compounding Room Requirements: Non-Hazardous vs. Hazardous Sterile Spaces

USP 797 & 800 Compounding Room Requirements: Non-Hazardous vs. Hazardous Sterile Spaces

Once the room model is set, the next job is building the systems that make the space certifiable. That usually comes down to HVAC, exhaust, and the cleanroom envelope. And this is where budget and timeline can swing fast.

If those systems are underdesigned, the suite may miss certification. If they’re overbuilt, owners can end up paying for more capacity, more ductwork, and more energy use than they need.

Pressurization, airflow, exhaust, and HVAC capacity

Pressure mode is one of the first big design choices because it affects almost everything downstream.

Non-hazardous sterile rooms are designed for positive pressure, while HD rooms are designed for negative pressure. Those targets drive HVAC sizing, exhaust layout, and utility demand. Non-hazardous sterile buffer rooms are typically designed for +0.02 to +0.05 in. w.c. with ≥30 ACPH of HEPA-filtered supply air.[19][20][22] Hazardous drug sterile buffer rooms require −0.01 to −0.03 in. w.c., ISO Class 7 conditions, ducted exhaust to the exterior, and 30 ACPH with no recirculation.[21][18][14]

Continuous pressure monitoring is required at every classified boundary.[1][20] On top of that, temperature and humidity targets add more load to the system. Common design guidance for sterile and hazardous compounding spaces is about 68°F and 30% to 60% RH. Holding those conditions while also delivering high ACPH can push cooling and heating demand up in a big way. Pharmacy cleanrooms can consume up to 15 times more energy than typical commercial building systems, so owners should ask the mechanical engineer for peak and annual energy use tied to the USP-driven airflow and exhaust plan.[5][22][26]

Room Type Pressure Relationship Airflow & Exhaust Coordination Risks
Non-Hazardous Sterile Buffer Positive: +0.02 to +0.05 in. w.c. ≥30 ACPH; HEPA-filtered supply Ceiling congestion with terminal HEPA diffusers; low-wall return placement
Hazardous Sterile Buffer (C-SEC) Negative: −0.01 to −0.03 in. w.c. ≥30 ACPH; ducted exhaust to the exterior; no recirculation; ISO Class 7 Dedicated exhaust riser; roof penetration; no recirculation
Hazardous Nonsterile Compounding Negative: −0.01 to −0.03 in. w.c. ≥12 ACPH; dedicated exhaust to the exterior Containment at pass-throughs
HD Storage Room Negative: −0.01 to −0.03 in. w.c. ≥12 ACPH; externally vented Sealed penetrations for shelving; exhaust routing to exterior

One item owners often underrate is exhaust discharge location. It’s not just “run the duct to the roof” and move on. The discharge point must be placed and aimed so exhaust does not re-enter building air intakes or drift into occupied outdoor areas.[14][24]

That means shaft space, roof space, and zoning limits need to be checked early. If that coordination slips until late design or construction, duct rerouting can get expensive fast and can push the schedule off track.[5][22][24]

Cleanroom envelope, finishes, and containment details

Even a well-sized HVAC system won’t save a room with a leaky envelope. If the shell can’t hold pressure or can’t stand up to cleaning, certification can still fail.

Classified surfaces must be smooth, non-shedding, non-porous, and resistant to disinfectants.[19][1][18] During certification walks and state board inspections, reviewers often look for the same problem spots: cracks, peeling coatings, exposed gypsum edges, and ledges that trap particulates. If those issues show up at that stage, the space usually needs rework before go-live.

Flooring should be seamless or heat-welded with integral coved bases at wall transitions. Ceilings should be seamless or gasketed cleanroom panels. Standard lay-in ceiling tiles are not acceptable unless they are specifically made and gasketed for cleanroom use.[1][18] All penetrations - conduit, piping, and data cabling - must be fully sealed with smooth, cleanable materials. Fixtures like lights, diffusers, and grilles should sit flush, not recessed.[19][1]

HD spaces need even tighter containment details. Walls must be fixed and full-height to structure. Temporary barriers and plastic curtains are not appropriate where the room must hold negative pressure and use ducted exhaust to the exterior.[7][23] Doors also matter more than people expect. Frames should be gasketed, and hardware needs to be adjusted so doors close fully without gaps that weaken containment.

Finish System Cleanability Durability Chemical Resistance Repair Complexity Lifecycle Cost
Epoxy-Coated Gypsum Board High when intact Moderate; susceptible to impact High Moderate; requires sanding and recoating Moderate; budget for periodic recoating
FRP / PVC Panel Systems High; non-porous surface High; impact-resistant High Low for panels; joints must be resealed Higher upfront; favorable in heavy-use areas
Sheet Vinyl (heat-welded) High; smooth surface Moderate; seam failure risk if improperly installed Moderate Moderate; section patching or replacement Moderate; installation quality is critical
Resinous Flooring (epoxy/urethane) Highest; seamless Highest; handles rolling loads and frequent disinfection High High; requires skilled contractors and cure time Higher initial cost; favorable long term. Requires early install and cure time before nearby occupancy.

These systems also need commissioning and documentation before turnover. In practice, that means the room has to do more than look finished. It has to hold pressure, support cleaning, and match the design record the certifier will review.

Turnover, certification, and the documentation owners need before go-live

Substantial completion is a construction milestone. Go-live is a compliance milestone. Those two dates are not the same, and treating them as interchangeable can create costly schedule problems on compounding projects.[4][35]

Once the room shell and HVAC are done, the owner’s role changes. The focus shifts from building the space to proving that it works and gathering the records regulators will want to see. A suite can look finished at substantial completion and still be unfit for pharmacy use. Until commissioning, certification, and turnover records are done, it is not ready.

Commissioning and certification steps that cannot be left to the end

A lot of lost time starts here. Teams finish construction, then push commissioning to the back of the line. That’s where trouble begins.

Commissioning and certification should start as soon as systems are installed and powered, not after the job is “done.” The process usually starts with startup checks. That means confirming that air handling units, exhaust fans, pressure sensors, and control valves are wired the right way and respond to building automation commands. From there, the team moves into operating-condition testing, where pressure differentials, minimum airflows, and alarms are checked while doors open and close and equipment is running.

Once functional testing passes, third-party certification confirms that the room performs under compounding conditions. That work includes particle counts, HEPA integrity, airflow, and pressure verification. Pressure setpoints should match the design record. Smoke studies matter here too. Airflow visualization under peak staffing and equipment loads shows whether air moves from clean to dirty zones and whether hazardous drug vapors travel toward exhaust instead of toward door openings or staff breathing zones.[30] USP <797> requires certification before initial use and at least every 6 months after that, or whenever changes could affect air quality or airflow.[27][32]

Corrective-action time needs to be part of the schedule. If a HEPA filter leaks, or a hazardous room cannot hold negative pressure when doors are open, the fix may involve mechanical rebalancing or ceiling work. That is not the kind of issue you solve with a quick tweak. Owners are in a much better spot when substantial completion recognition and contractor payment milestones are tied to fixing major commissioning deficiencies. If they accept the space first and chase repairs later, they usually lose leverage.[28][29]

Turnover package: drawings, reports, SOP inputs, and training records

Paperwork can hold up activation just as fast as a failed test. FDA inspection guidance points to common gaps such as missing environmental monitoring SOPs, missing training records, and missing environmental monitoring logs. Any of those can delay approval or activation, even when construction is physically complete.[34][36] The Washington State Department of Health's USP <797> addendum spells out the required record set: facilities must maintain personnel qualification and training records, certification reports, environmental monitoring procedures and results, equipment records, SOPs, release testing records, complaints and adverse event logs, and investigation documentation.[4][33]

Owners should require and verify these items before calling the space ready for inspection scheduling:

Document Category What It Supports
Basis of Design Aligns SOPs and risk assessments with actual system capabilities
Submittals and O&M manuals Filter change schedules, calibration intervals, parts sourcing
Testing, adjusting, and balancing (TAB) reports Documents achieved ACH, supply/exhaust flows, and final system settings
Commissioning report with corrective action closeout Demonstrates that deficiencies were found and resolved before go-live
Controls sequences, alarm matrix, and pressure trend setup Supports environmental monitoring strategy and staff training
Cleanroom and containment certification records Required by Boards of Pharmacy and accreditors; must include corrective actions
Staff training curricula, attendance logs, and competency assessments Demonstrates readiness for regulatory surveys and internal audits

The controls sequences and pressure trend setup need extra attention. They show what pressure readings the team should expect, where alarm thresholds are set, and how the system reacts when a fan trips or a door stays open. They also guide environmental monitoring plans and staff training. Put simply, these records tell the team what “normal” looks like and what to do when the room drifts out of range.

Competency files should cover pharmacists, technicians, and facilities staff. They should also include mock drills, such as a simulated loss of negative pressure in a hazardous room, along with documented staff responses and debrief notes. Boards of Pharmacy and Joint Commission surveyors often ask for those records.[4][34][36] Do not schedule inspections or finalize SOPs until the turnover package is complete and filed before go-live. That file is what inspectors, operators, and pharmacy leaders will rely on during handoff and readiness review.

Owner execution plan: budget, contractor selection, and hiring the right team

How compliance requirements change budget, phasing, and contractor selection

Once the room design and turnover targets are set, the owner's job shifts fast. Now it's about funding the work, choosing the right partners, and buying the right equipment at the right time.

USP <797>/<800> projects cost more than a standard pharmacy remodel. The biggest reason is compliance-driven infrastructure, especially HVAC, exhaust, and cleanroom construction. HVAC and exhaust usually make up 14%–22% of total project cost, and the cleanroom envelope and finishes add about $200–$400 per square foot[25]. Hazardous drug areas also need dedicated exhaust to the exterior, including roof-mounted exhaust fans and discharge ducting above the roofline[31][38][39].

That means these items shouldn't get buried inside general MEP costs or a loose contingency bucket. They need their own compliance line items. If you don't price them that way from the start, the budget can look fine on paper and then fall apart when the real scope shows up.

Another big pressure point is long-lead equipment. Biological safety cabinets, compounding aseptic containment isolators, dedicated air handlers, and pressure monitors can come with lead times of 8–20 weeks[37][25]. That's a major schedule risk. Owners sometimes finish the room and then realize the space can't certify because a key piece of equipment still hasn't arrived. The fix is simple in theory, but easy to miss in practice: start procurement for critical-path equipment as soon as the basis of design is stable, even if construction documents are still being finished. It also helps to budget time after construction for HVAC controls tuning and workflow adjustments.

A lot of projects go sideways because the owner treats the work like a standard tenant improvement. It isn't. The contractor team needs direct experience with regulated healthcare or cleanroom work. That matters even more for trades touching pressure relationships, hazardous drug exhaust, and system backup plans. Prior USP <797>/<800> or ISO-classified cleanroom experience should be a weighted selection factor, not a box to check at the end. Ask for hospital or health system references, plus proof that past spaces actually passed certification. The same rule applies to MEP partners.

Staffing needs from project delivery through steady-state operations

The team structure matters just as much as the floor plan. A good setup helps owners avoid the usual failures: missed scope, weak turnover records, failed certification, and spaces that drift out of compliance after handoff.

These roles cover both project delivery and day-to-day operations. Each one should be filled by someone who has worked in regulated environments before the project begins. In RFPs, require prior USP <797>/<800> project experience.

Project Phase Critical Role Required Experience Risk if Missing
Planning & Concept Design Owner's Project Manager Healthcare/life sciences capital projects Scope creep, unrealistic budget, unclear compliance goals
Planning & Concept Design Pharmacy Operations Lead USP <797>/<800> workflow and SOP development Layouts that hinder safe workflow or fail operational inspections
Design Development MEP Lead Cleanroom HVAC, pressure cascade, HD exhaust Undersized systems, failed certification, costly rework
Design Development Commissioning Authority Early design review for cleanrooms/healthcare Performance issues found late; increased change orders
Construction Construction Superintendent Healthcare renovation, infection control, envelope sealing Pressure leaks, non-compliant finishes, buried defects
Construction QA/QC Lead USP compliance documentation, ICRA protocols Failed inspections, thin turnover records
Commissioning Certifier Coordination Lead Cleanroom certification, TAB oversight Protocol delays, failed HEPA or pressure tests
Go-Live & Steady-State Facilities/O&M Staff Maintenance of classified environments Post-turnover pressure drift, loss of compliant state

Conclusion: the shortest path to a compliant, operational compounding space

For owners, the fastest path to go-live is simple: line up scope, budget, project delivery, and operations around compliance from day one.

The projects that go well tend to follow the same pattern. They define compliance scope early, lock room adjacencies and airflow strategy before procurement, build an envelope that can be cleaned and can hold pressure, and plan commissioning well before substantial completion. When those decisions get pushed off, the risk doesn't disappear. It just moves downstream, where the fix usually costs more and takes longer.

FAQs

How do I choose between Category 1 and Category 2 compounding?

Choose based on your day-to-day needs and the risk level of the sterile preparations you plan to make.

Category 1 works best for shorter timeframes and beyond-use dates. It often needs less complex space and infrastructure.

Category 2 is built for longer beyond-use dates and more involved processes. But it also calls for tighter environmental controls, specialized layouts, and stricter documentation.

What usually causes a compounding suite to fail certification?

Most certification failures come down to two late-stage problems: bad paperwork and mechanical issues.

On the documentation side, teams often run into missing or inconsistent records. That can include weld logs, calibration certifications, tag lists, and as-builts that don’t match what was actually installed. It sounds minor on paper, but it can derail sign-off fast.

Mechanical problems are just as common. HVAC systems may have pressure cascades that don’t work as intended, weak air quality, or setups that fall short of ASHRAE standards. When those issues show up late, fixes tend to be expensive and time-consuming.

When should owners start commissioning and equipment procurement?

As early as possible. Owners should bring in commissioning, qualification, and validation (CQV) professionals and MEP leadership during initial planning, pre-design, or the User Requirements Specification phase.

Long-lead equipment, like air handling units and clean utility skids, should be bought during schematic design instead of waiting for trade awards. That move can cut delays and help teams deal with design, validation, regulatory, and supply chain risks before construction starts.

Related Blog Posts

Keywords:
USP 797, USP 800, compounding room design, cleanroom HVAC, hazardous drug containment, buffer room, commissioning
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Intel Ohio One: Construction Status and the Workforce Behind the New Albany Campus
September 1, 2026

Intel Ohio One: Construction Status and the Workforce Behind the New Albany Campus

New Albany site moves from underground to vertical construction; hiring shifts from earthwork to MEP, commissioning and tool-install specialists.
TSMC Arizona Fab Expansion: What the Third Fab Means for Construction Hiring
September 1, 2026

TSMC Arizona Fab Expansion: What the Third Fab Means for Construction Hiring

Third Arizona fab tightens construction labor, raises pay, and ups schedule risk; hire MEP, commissioning, and project leaders early.
EPCM vs EPC on Mine Builds: What Owners Choose and Why
September 1, 2026

EPCM vs EPC on Mine Builds: What Owners Choose and Why

EPC gives price and schedule certainty; EPCM gives owners control and flexibility but needs larger owner teams and assumes more risk.
UFC for Contractors: Unified Facilities Criteria Explained
September 1, 2026

UFC for Contractors: Unified Facilities Criteria Explained

Treat UFC as contract scope: identify governing UFCs early to avoid antiterrorism, QC, and commissioning surprises on DoD projects.
