September 2, 2026

Micron New York Megafab: What the Clay Campus Means for Fab Construction Talent

By:
Dallas Bond

Micron’s Clay campus is a long hiring cycle, not a single job push. With first concrete poured for Fab 1 on July 9, 2026, and a plan tied to 4 fabs and about $100 billion through 2045, I see one clear takeaway: employers need to line up hard-to-fill fab talent well ahead of each phase, and candidates who move early should have the best shot at top roles.

Here’s the article in plain English:

  • This project lasts for years, not months.
  • Hiring will come in waves as work shifts from preconstruction to civil, MEP, tool install, and startup.
  • The hardest roles to fill are leadership and niche fab jobs, not basic labor roles.
  • Local labor helps with volume, but many semiconductor-experienced hires will still come from a national search.
  • Timing matters. Some roles need to be filled 3 to 24 months before the work starts.

The article boils demand into 3 hiring groups:

  • Program leadership: project executives, construction managers, superintendents
  • Technical delivery: CSA, MEP, process piping, tool install
  • Startup controls: commissioning, scheduling, cost controls

Quick Comparison

Hiring group Main focus Sample roles When demand gets tight
Program leadership Keep the full job moving Project executives, senior construction managers, superintendents Early, before each phase starts
Technical delivery Build and coordinate fab systems CSA leads, MEP managers, process piping specialists, tool-install PMs During core build and equipment prep
Startup controls Turn systems over and track sequence/cost Commissioning managers, startup engineers, schedulers, cost controls As phases move toward startup

If I had to sum it up in one line: Clay will reward early workforce planning and early applications, because the project faces the same staffing challenges as other large-scale construction projects and needs a small pool of fab-specific talent.

Where talent demand will concentrate on the Clay campus

At Clay, the hiring push will center on three areas: leadership, technical delivery, and startup controls.

Program leadership: project executives, construction managers, and field leaders

Project executives, senior construction managers, and field leaders keep the whole job moving. They line up owner teams, trade contractors, and several work fronts at the same time. Senior superintendents keep daily production on track across civil, structural, and finishing scopes. When schedules slip, backward-pass scheduling is a must for recovery.

This group sets the tempo for the teams working below them.

Technical delivery roles: CSA, MEP, process systems, and tool install

CSA leaders oversee the structural and architectural work that supports the campus build. MEP and process systems leaders run the dense systems work that has to be installed and coordinated right the first time. In process systems roles, UHP piping expertise is required.

Tool install specialists handle hook-up coordination and confirm interfaces before tool start-up.

Startup controls: commissioning, scheduling, and cost controls

As the build-out moves forward, startup controls become the gating function. Commissioning professionals manage system turnover across overlapping construction and startup work. They own the testing, verification, and documentation needed to get each system accepted by the owner and cleared for tool qualification.

Commissioning, scheduling, and cost controls keep turnover, sequence, and budget in view as each phase opens.

Why Clay will be hard to staff without early workforce planning

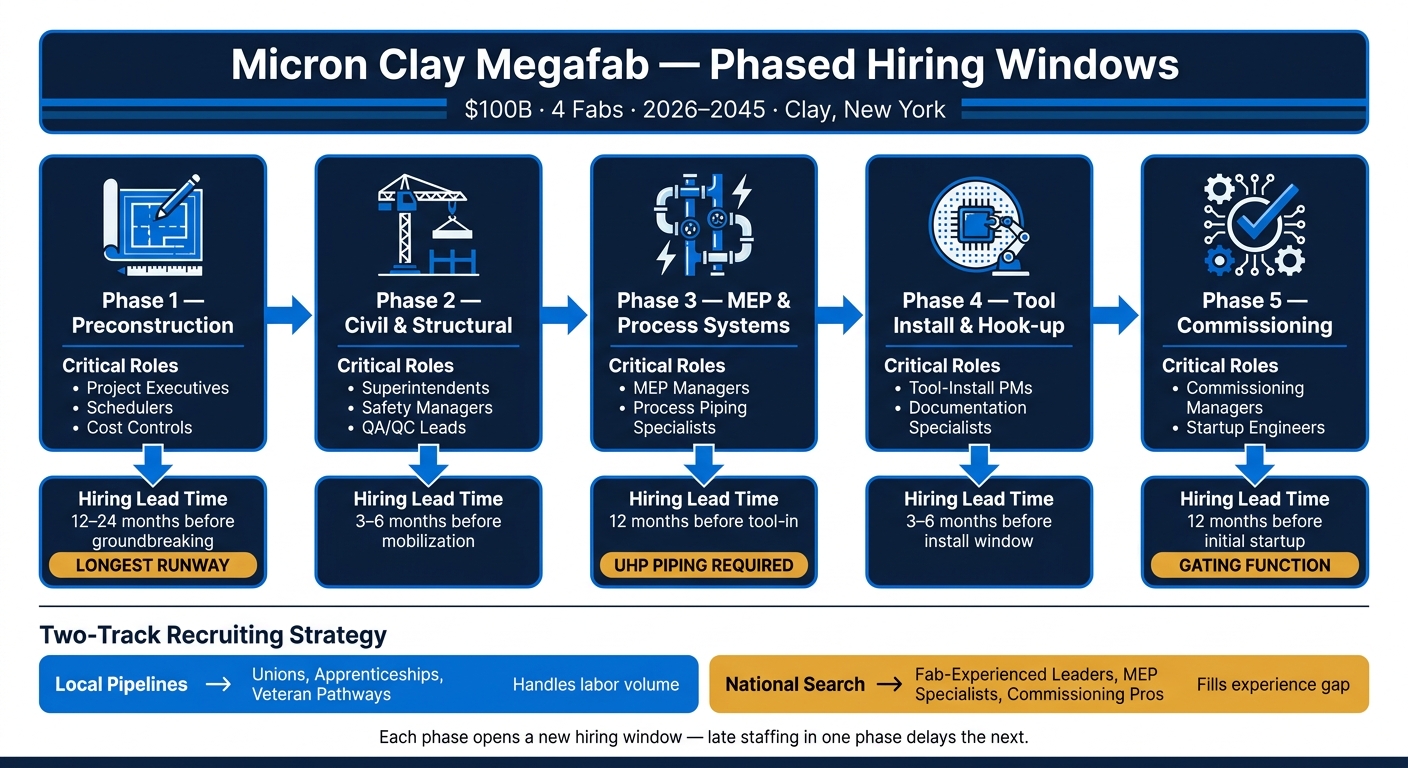

Micron Clay Megafab: Phased Hiring Timeline & Lead Times by Construction Stage

Micron Clay Megafab: Phased Hiring Timeline & Lead Times by Construction Stage

Those leadership, technical, and startup roles need to be lined up months before each phase begins. Micron's Clay megafab is a $100 billion, 20-year program built around four fabs [2], which means hiring won't happen once and move on. It will come in waves across each phase.

And the toughest jobs to fill won't be entry-level spots. They'll be roles like project executives, schedulers, cost controls staff, MEP and process systems leaders, tool-install PMs, and commissioning managers. These are the people you can't just post for and hope to fill next week. They need long runways.

Local labor availability versus specialized talent scarcity

Local craft labor can handle part of the build. That's the good news.

The hard part is the specialist side. Semiconductor-experienced leaders and niche experts will still need national searches, especially for roles tied to fab delivery, process systems, tool install, and startup. In plain English: Clay may have access to local labor, but that doesn't solve the shortage of semiconductor-experienced talent.

Phased delivery creates repeated hiring waves

Clay is not a one-time mobilization. It works more like a long relay race than a single sprint. Each major phase brings its own staffing spike, and each spike has different timing.

Preconstruction needs one group. Civil and structural work needs another. Then MEP and process systems work ramps up. After that come tool install and hook-up, followed by commissioning. Every one of those steps has its own hiring window, and if a team shows up late, the phase behind it can feel the hit.

Project Phase Critical Roles to Secure Hiring Lead Time
Preconstruction Project Executives, Schedulers, Cost Controls 12–24 months before groundbreaking
Civil & Structural Superintendents, Safety Managers, QA/QC Leads 3–6 months before mobilization
MEP & Process Systems MEP Managers, Process Piping Specialists 12 months before tool-in
Tool Install & Hook-up Tool-Install PMs, Documentation Specialists 3–6 months before install window
Commissioning Commissioning Managers, Startup Engineers 12 months before initial startup

That's why workforce planning has to roll forward phase by phase, well before each staffing peak hits.

Recruitment strategies that fit a semiconductor megaproject

Timing is only half the job. In Clay, the other half is building the right hiring system for the right roles.

That usually means running two tracks at the same time. One track builds local craft capacity. The other runs a national search for the hardest-to-fill fab roles. Put simply: local pipelines help with labor volume, while national hiring brings in the semiconductor experience the project can't do without.

Build local pipelines through unions, apprenticeships, and veteran pathways

Contractors should keep a local craft pipeline moving from day one. Unions, apprenticeships, and veteran pathways can help keep workers coming in across civil, MEP, tool install, and commissioning as the project moves from one phase to the next.

Apprenticeship programs can be shaped around fab-related work so new entrants show up ready for site demands. Veteran transition pathways also widen the talent pool with dependable candidates who are often used to structure, pace, and high-stakes work.

New York workforce and infrastructure funds [1] also strengthen the case for local hiring.

Use national search for fab-experienced leadership and specialists

Local pipelines help fill the numbers. National search fills the experience gap.

Project executives, construction managers, CSA and MEP leaders, tool install specialists, commissioning professionals, and scheduler/cost controls talent with semiconductor experience are the roles most likely to need a national search.

To reach those people, employers need to think beyond the local market and make the job worth moving for. That means compensation that lines up with niche experience and schedule pressure. A long project runway also helps. For many candidates, that kind of visibility matters a lot.

How iRecruit.co can help employers staff mission-critical fab roles

iRecruit.co is a construction recruiting firm that staffs mission-critical construction roles in semiconductor fabs and other complex industrial projects. The team focuses on roles such as project executives, project managers, schedulers, cost controls professionals, MEP leaders, commissioning managers, and field leadership - exactly the positions that carry the most delivery risk on a program like Clay.

Prequalified screening and outsourced recruiting support can help employers avoid starting over every time a new phase begins. That's a big deal when each phase opens another hiring window.

iRecruit.co's founders, Dallas Bond and Tanya Runholt, built the firm around construction and technical recruitment.

Conclusion: The employers and candidates who move early will be best positioned

Clay has moved from site prep into vertical construction on the first of four planned fabs. That change means hiring timing matters just as much as hiring volume.

For employers, the focus now is clear: bring in leadership, CSA/MEP, tool install, commissioning, and controls talent months before each phase begins.

That same phased build opens the door for candidates who are ready to move early. People with fab, cleanroom, MEP, commissioning, or tool-install experience are in the best spot for the first openings. And those who apply early will be first in line as each phase ramps up.

In Clay, planning ahead will pay off on both sides of the hiring equation. The people who act early will land the best roles and build the strongest teams.

FAQs

When should employers start hiring for Clay?

For the Clay megafab, employers should hire one phase ahead instead of waiting until the last minute. That means bringing in leadership roles, like project executives, during early planning, not after the work is already in motion.

For milestone-heavy roles, timing matters even more. In particular, MEP and commissioning leaders should be hired 12 to 24 months in advance. For other mission-critical leadership positions, a good rule is to start recruiting 6 to 12 months before the role is needed.

Which roles will be hardest to fill?

At Micron’s Clay, New York campus, the toughest roles to staff are the ones that demand deep skill and calm under pressure during a fast, high-stakes build.

That includes senior project managers, general superintendents, MEP managers, commissioning managers, QA/QC leads, Primavera P6 schedulers, and specialized trades such as high-purity pipefitters, electricians, and tool-install specialists.

Do candidates need fab experience to compete?

Not always. Direct semiconductor fab experience matters a lot, but it isn't a must-have for every role.

Many employers also look at people from nearby mission-critical fields like data centers, pharmaceutical manufacturing, and complex energy infrastructure. That’s especially true when those candidates bring skills that carry over well, such as cleanroom protocols, documentation, high-purity systems, MEP coordination, commissioning, and quality control.

Related Blog Posts

Keywords:
Clay megafab hiring, fab construction jobs, semiconductor workforce planning, MEP commissioning, tool install specialists, project leadership hiring, phased hiring timeline
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Eli Lilly Lebanon, Indiana: Inside the API Manufacturing Campus Buildout
September 2, 2026

Eli Lilly Lebanon, Indiana: Inside the API Manufacturing Campus Buildout

How a Lebanon API campus build ties schedule, shared utilities, CQV, equipment lead times and hiring to tirzepatide production.
Salute agrees to acquire T5 Operations
September 2, 2026

Salute agrees to acquire T5 Operations

Salute agrees to acquire T5 Operations, expanding FM&O services, global footprint and AI/HPC capabilities.
Italy grants strategic status to Energy Vault AI project
September 2, 2026

Italy grants strategic status to Energy Vault AI project

Italian government designates Energy Vault’s Digital Vault Sulcis as strategic AI infrastructure, launching a 30 MW data center expandable to 100 MW.
Data center construction spending surged in July
September 2, 2026

Data center construction spending surged in July

AI data center construction spending surged in July to an annualized pace above $75B.
