NERC Certification Explained: System Operator Credentials and the Construction Interface

By:
Dallas Bond

If your project touches the Bulk Electric System, your field team does not have final control at energization. The control room does.

I’d sum the article up like this: NERC certification is tied to a person, not a company, and that person may be the one who approves switching, outage timing, and first energization. On many U.S. power projects, that means schedule risk starts well before startup. A missed outage window can push milestones by days or weeks, and each NERC credential lines up with a different level of control over the grid.

If I were reading this to get the answer fast, here’s what matters most:

  • RC, BA, TO, and BT/BIT are not the same. Each one maps to a different grid role.
  • PER-003 links certification to control-room jobs. If a role must be staffed by a certified operator, a gap can stop work.
  • Construction teams usually do not need NERC-certified hires. But they do need people who know outage requests, switching steps, commissioning hold points, and turnover records.
  • The grid interface becomes tightest at commissioning and first energization.
  • Large loads matter too, not just generation and transmission. That includes data centers, fabs, EV battery plants, and storage sites.

A few fast facts from the article:

  • NERC system operator certifications are valid for 3 years
  • They require continuing education hours (CEHs) to stay active
  • Control-room authority often sits with the RC, BA, or TOP/TO, depending on the task
  • Large-load and interconnection work can trigger study, outage, and ramp-up steps well before site turnover

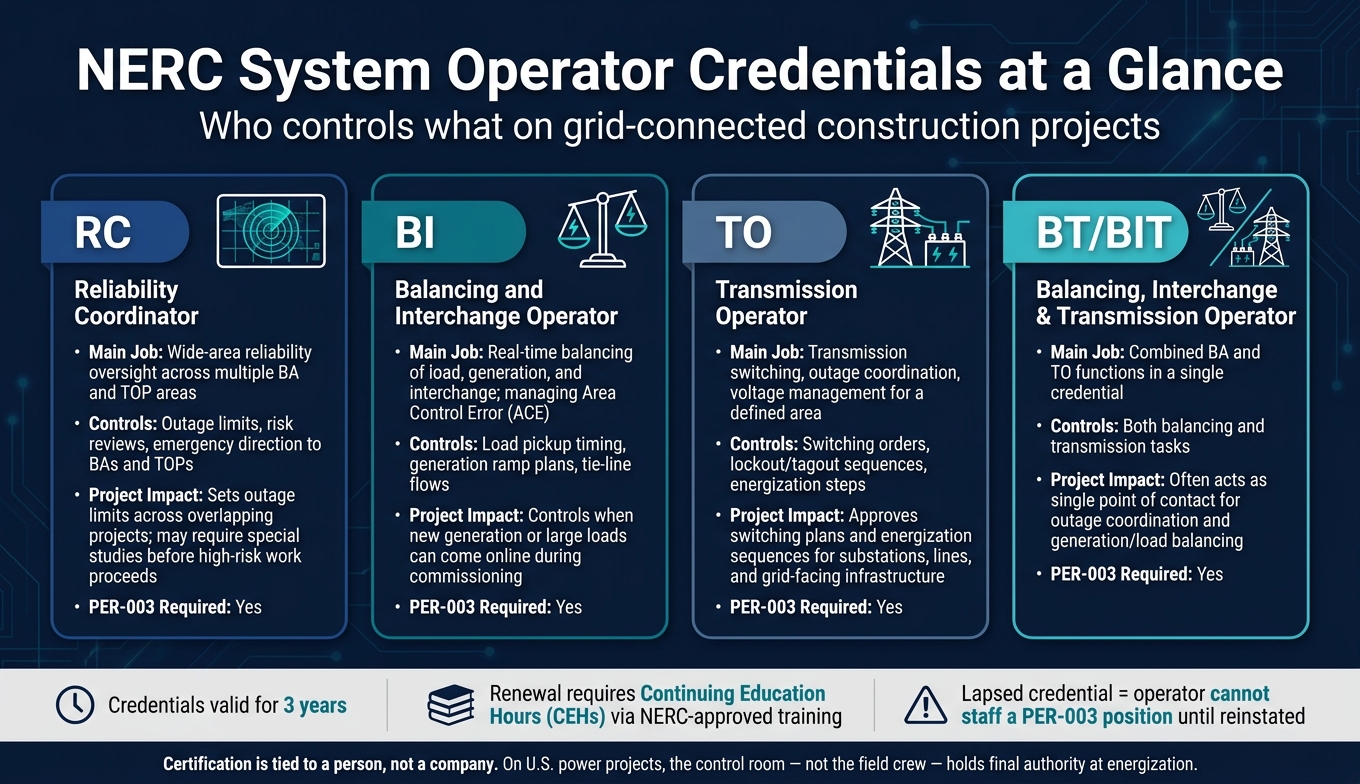

Here’s a quick comparison of the four credentials the article covers:

Credential Main job What it can affect on a project
RC Area-wide reliability oversight Outage limits, risk reviews, emergency direction
BA / BI Balance load, generation, and interchange Load pickup, generation timing, ramp plans
TO Transmission switching and outage control Switching orders, outage windows, energization steps
BT/BIT Combined BA and TO work Single point of contact for both balancing and transmission issues

Bottom line: if you build around your own turnover plan and ignore control-room authority, you can lose the schedule at the last step. I’d use this piece as a plain guide to who controls what, when that control shifts, and what kind of hiring fits the job.

NERC System Operator Credentials: RC, BI, TO & BT/BIT Compared

NERC System Operator Credentials: RC, BI, TO & BT/BIT Compared

Explaining NERC | The PER Standards | Certrec

NERC

NERC certification basics: credentials, rules, and functional roles

NERC system operator certification is a personal credential for operators who direct Bulk Electric System reliability tasks in real time under standards such as PER-003. [15][4] It is not a state electrical license or a utility authorization. It applies to control-room staff who approve switching, balance load and generation, and manage reliability. On power projects, that matters for a simple reason: these are the people who can approve switching, outages, and energization.

The main issue isn't just a job title. It's which grid function the credential allows that person to perform.

What RC, BI, TO, and BT/BIT each cover

Credential Operating scope Why it matters on site
RC (Reliability Coordinator) Wide-area reliability across multiple BA and TOP areas; real-time contingency analysis; authority to direct BAs and TOPs during emergencies. [9][14] Sets outage limits across overlapping projects and may require special studies or mitigation plans before higher-risk work moves ahead.
BI (Balancing and Interchange Operator) Real-time balancing of load, generation, and interchange; managing Area Control Error (ACE); dispatching generation and adjusting tie-line flows. [9][14] Controls when new generation or large loads can come online and how temporary generation is handled during construction outages.
TO (Transmission Operator) Transmission operations for a defined area: switching, outage coordination, loading, and voltage management. [9][11][14] Approves switching orders, lockout/tagout sequences, and energization steps for substations, lines, and grid-facing infrastructure.
BT/BIT (Balancing, Interchange, and Transmission Operator) Combined balancing authority and transmission operator functions in one credential. [3][8][13] Often acts as the single point of contact for outage coordination and generation/load balancing during project work.

These credentials stay valid for three years. To keep them active, operators must complete continuing education hours, or CEHs, through NERC-approved training, simulations, and drills. [3][2][4] If a credential lapses, that operator cannot staff a PER-003-covered position until it is reinstated.

How credentials map to RC, BA, TOP/TO, and GOP entities

NERC's functional model lays out the entities construction leaders will run into on bulk power projects.

The Reliability Coordinator (RC) sets outage limits across a broad area and can direct other entities to preserve system stability. [9][14] RC-credentialed operators fill these roles. In construction, RC involvement tends to matter most when a project touches major transmission corridors, where overlapping outages can put regional stability at risk.

The Balancing Authority (BA) keeps generation, load, and interchange in balance in real time. [9][14] BI and BT/BIT credentials line up with BA work. BAs decide how and when new generation, like a solar farm or battery storage project, or a large new load gets tied in. That includes staged energization plans during commissioning so frequency and ACE stay within limits.

The Transmission Operator (TOP/TO) manages real-time reliability for the transmission system in a defined area. [9][11][14] TO and BT/BIT credentials cover this work. This is usually the entity construction teams deal with most. TOPs approve switching plans, schedule outage windows, and authorize energization sequences for substations, overhead lines, underground transmission, and other grid-facing infrastructure.

The Generator Operator (GOP) runs the generation asset being built or commissioned and must coordinate with BA and TOP limits during startup. [9][14] GOPs are the owners and operators of assets such as combined-cycle plants, wind farms, and battery storage. Many also staff people with NERC credentials to help that coordination run smoothly.

How PER-003 affects staffing and supervision

PER-003

Once the credential types are sorted out, the staffing rule becomes the part that hits the schedule.

PER-003 is the NERC reliability standard that ties these credentials to specific control-room positions. [10][12] At its core, the rule says operators staffing a real-time BES operating position for RC, BA, and TOP functions must be certified through the NERC System Operator Certification Program. Under PER-003, non-certified staff may work only under direct supervision, so a staffing gap can delay a planned outage window or cut it short. [10][12][8]

That rule tends to show up fast during outage planning, commissioning, and first energization.

Where NERC-certified operators connect with construction and commissioning

NERC-certified operators make the grid-side calls that shape what happens in the field. You see that most clearly during interconnection, commissioning, outage planning, and first energization. The handoff starts in studies, moves into outage planning, and ends at the switch.

Interconnection studies, design reviews, and pre-energization planning

Interconnection studies under FAC-001 and FAC-002 need complete modeling data early enough for planners and operators to run power-flow, short-circuit, and dynamic studies.[19][20][21][23] That means project teams need to deliver equipment ratings, protection data, load profiles, and harmonic characteristics at the front end. For large loads, NERC guidance calls for staged commissioning with TO, TOP, RC, and BA coordination before commercial operation.[22] If the study package has gaps, everything that follows gets delayed.

During design review, TOP/TO, RC, BA, and GOP staff look at relay coordination, trip logic, reclosing, SCADA points, and operating limits to make sure the design can be monitored and switched safely.[3][6][1][18] Any design changes that come out of those reviews must be made. Operator acceptance is a condition for energization. It is not just a box-checking exercise.

Outage coordination, switching windows, and first energization

Planned outages for high-voltage lines, transformers, and large generators need TOP, BA, and RC coordination under IRO-017 and TOP-003.[7][1][24] That process decides when the construction team gets a switching window.

For transformer energization, TOP and BA operators review system voltage levels, available reactive support, and inrush effects before they approve the switch. In many cases, they want energization during light-load periods and in a set sequence: energize at nominal tap with no load, verify readings, then pick up load in controlled steps.[7][1] The final call comes from the certified operator in the control room, not the commissioning crew in the yard. That is the point where authority shifts from contractor execution to control-room control.

Reactive device outages - capacitor banks, reactors, and STATCOMs - can also get pushed if VAR demand makes the timing unsafe.[7][1] The same kind of control shows up in load ramp plans for large facilities. BA and GOP operators line up ramp rates, start times, and contingency protocols so frequency and voltage stay within limits. In some cases, that means staged load blocks and required communication checkpoints.[5][18]

Commissioning records, protection systems, and turnover documentation

After energization, owners rely on test reports, relay settings, event logs, fault records, and as-builts to update models and meet MOD-026-2 and MOD-033 requirements.[26][28][25][27] Those same requirements also shape what hiring teams need from the people supporting turnover and operations.

The table below shows how each project phase ties to the NERC entity involved, the credential usually staffing the control room, and the main action required from the construction team.

Project phase NERC entity involved Typical credential in control room Key construction action
Concept & interconnection request Transmission Planner, BA, RC RC or BT-certified system operator support Provide preliminary one-lines, load/generation data, and site parameters
Detailed design & protection review TOP/TO, BA, GOP TO, BT/BIT, or BA-certified operators Finalize protection schemes, SCADA points, and operating limits
Outage planning & scheduling TOP/TO, BA, RC RC, TO, and BA-certified operators Submit outage requests, negotiate windows, sequence cutovers
Pre-energization & commissioning TOP/TO, BA, GOP TO and BA-certified operators in real time Execute test plans, coordinate switching orders, verify protection readiness
First energization & ramp-up TOP/TO, BA, RC, GOP RC, BA, TO, and possibly RC-certified system operators Perform staged energization, follow ramp plans, report anomalies
Post-energization & turnover TOP/TO, BA, GOP TO and BA-certified operators Deliver as-builts, settings packages, event logs, and model update data

That split in responsibility is what tells you whether a project needs a certified operator, a commissioning lead, or both.

Hiring guidance: when NERC-certified talent is needed and how to scope the role

Once commissioning gets to the grid interface, hiring turns into a role-definition issue. You need to decide what the job actually calls for: certification, operating background, or a mix of both. On large power projects, plenty of people work near the grid interface. But only a small group need active NERC certification. If you sort that out before posting the role, you can avoid wasted interviews, extra cost, and schedule trouble.

True operator roles - real-time RC, BA, and TOP positions - require NERC certification under PER-003.[16][10] These people issue switching orders, manage system conditions, and respond to live grid events. Most construction and commissioning jobs do not fall into that bucket. A common hiring mistake is labeling every grid-adjacent role as certification-required when many of those jobs only need someone who can coordinate well and understands compliance.

Role NERC Certification Required? What Actually Matters for Hiring
RC / BA / TOP real-time operator Yes Active certification, CEH maintenance, real-time operating judgment
Construction manager on power project Usually no Outage sequencing, switching coordination, schedule integration tied to commissioning milestones
Commissioning manager Usually no Energization planning, hold-point management, turnover documentation
EPMS / protection / controls lead Usually no Relay commissioning, settings coordination, SCADA integration
Owner's rep or startup leader Usually no Operator interface fluency, compliance awareness, ramp-up governance

For roles like these, ask for grid-interface experience, not certification. That one distinction shapes both the job post and the screening process.

What to look for in resumes, interviews, and job scopes

On resumes, the clearest signals usually come from project-phase wording. Look for terms like first energization, outage coordination, commissioning hold points, operations turnover, grid interconnection, or switching documentation. Generic electrical construction experience, without that kind of language, often isn't enough for grid-interface work.

Other good signs include experience with:

  • Protection and relay testing
  • SCADA or EPMS integration
  • Outage request management
  • Turnover package preparation

Candidates who have worked on more complex utility interconnections - like data center substations, battery storage sites, semiconductor fab tie-ins, or renewable interconnections - often have the right kind of exposure even if they don't hold a credential.[29][30][31]

In interviews, ask candidates to walk you through a time when commissioning got held up by utility availability, or when construction wrapped before operating approval came through. Good answers show they know the grid interface is procedural and stakeholder-driven, not just an engineering task. Someone who has only managed internal construction dates, but has never worked through an outage window or a protection-settings review, will often hit a wall at handoff.

In the job scope, be specific about who the person will work with: utility, ISO/RTO, balancing authority, transmission operator, or owner-operator. Then spell out the work itself - submitting outage requests, joining operating readiness meetings, managing switching documentation, and preparing turnover packages. That level of detail helps candidates self-screen and lets hiring managers evaluate fit with far less guesswork.

How iRecruit.co supports hard-to-fill power and mission-critical roles

iRecruit.co

The tough part is finding people who can move between the jobsite and the control room without missing a beat. iRecruit.co focuses on that space, recruiting for mission-critical builders and developers across data centers, energy infrastructure, advanced manufacturing, and defense-tech. The team turns a project's technical needs into a clear hiring profile, then sources candidates who have handled energization planning, outage coordination, commissioning constraints, and owner/operator coordination on similar builds.

That work starts with role definition. Before sourcing starts, the team works with the employer to figure out whether the opening calls for a certified operator, a commissioning lead with operator-interface skill, or a project professional who can speak the language of both the grid and the jobsite. Getting that answer right up front keeps the search tight and improves hiring accuracy - especially on projects where first energization is a fixed schedule milestone.

Conclusion: the grid interface drives project risk, and credentials define who controls it

Once a project gets to outage planning or energization, credential gaps stop being an admin detail and start becoming schedule risk. On grid-connected builds, outage approval, switching, first energization, and protection approval sit with NERC-certified operators. For U.S. construction projects, contractors and owners need to plan around the decision rights of RCs, BAs, and TOP/TOs from day one.[17][34][8]

That split in authority is what makes credentialing a field issue, not just a staffing issue. RCs, BAs, and TOP/TOs each control a different layer of grid risk, from regional reliability oversight to balance control to step-by-step switching. If project teams miss those decision rights early, delayed energization and squeezed outage windows tend to show up at the worst time.[32][7][35][36]

Key takeaways for contractors, owners, and recruiters

Three priorities matter most when handling grid-interface risk through credentials and staffing.

First, map credentials to authority before the project schedule is set. Figure out which RC, BA, or TOP/TO controls the interconnection, then build that entity’s outage rules into the baseline schedule as fixed logic that shapes milestone sequencing.[32][7][35][36]

Second, engage certified operators early. Bring them in before commissioning starts. Protection settings, energization sequences, and switching plans all need operator input well ahead of field execution.[17][33]

Third, hire for the right experience. Look for people who understand grid-interface work, outage coordination, switching documentation, and commissioning under reliability limits.

When planning and staffing reflect those priorities, the grid interface is far less likely to become a schedule surprise.

FAQs

Who needs NERC certification on a power project?

On power projects, NERC certification is required for roles tied to NERC/FERC compliance and grid reliability. That’s especially true for system-operator-credentialed professionals working on utility-scale projects and grid interconnection work.

This usually applies to teams handling relay testing, SCADA integration, energization planning, outage coordination, and start-up activities. In these roles, operational actions must line up with reliability standards.

What can delay first energization?

First energization can get pushed back when the team hasn’t fully cleared the items needed for a safe startup.

That usually includes:

  • Missing or unfinished pre-energization safety steps, such as LOTO, energization permits, MOP approvals, and electrically safe work conditions
  • Controls and point-to-point checks that still haven’t been verified
  • Breaker protection, trip, and relay readiness problems
  • Documentation and reports that are still incomplete, which can block gated commissioning levels before higher-risk energization phases

When should outage coordination start?

Outage coordination needs to start in the initial project planning phase - ideally during site selection and permitting. Why so early? Because commissioning leadership can take 60 to 90 days or longer to hire, and that team needs to set testing requirements before installation starts.

Commissioning should also begin in the pre-design phase. That gives the Commissioning Authority time to review designs for commissionability before construction begins. It also lets the team plan outage-driven cutovers and readiness steps early, instead of trying to sort them out later when the schedule is already tight.

Related Blog Posts

Keywords:
NERC certification, system operator, PER-003, outage coordination, first energization, transmission operator, commissioning, grid interconnection
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Water Operator Certification Grades 1–4 Explained: Requirements, Exams, and Pay
August 21, 2026

Water Operator Certification Grades 1–4 Explained: Requirements, Exams, and Pay

Explains Grades 1–4 for water operator certification: eligibility, exam topics, responsibilities, and typical pay ranges.
Relay and P&C Technician Certifications: NETA Paths for Utility Work
August 21, 2026

Relay and P&C Technician Certifications: NETA Paths for Utility Work

NETA Level 2 opens entry roles; Level 3 is the career breakpoint for independent relay/P&C leads and pay; Level 4 runs projects.
AS9100 for Facility and Construction Teams: What Aerospace Builds Require
August 21, 2026

AS9100 for Facility and Construction Teams: What Aerospace Builds Require

Aerospace construction must deliver compliant facilities and audit-ready records: traceability, calibration and commissioning from day one.
Skanska wins $1.2 billion contract for four US data centers
August 20, 2026

Skanska wins $1.2 billion contract for four US data centers

Skanska signs SEK 11.2bn (~$1.2bn) contract to build four data centres in the southeastern US, with construction from 2026 to 2028.
