Owner's Project Requirements (OPR): Guide for Cx Careers

By:
Dallas Bond

If I can read an OPR, tie it to tests, and track gaps back to owner requirements, I become more useful on a Cx project. That’s the main point.

The OPR is the owner’s written target for how a facility must perform. In this guide, I’d focus on three things: what an OPR includes, how Cx teams use it from design through handoff, and why that skill can help me move from Cx engineer to manager or owner’s rep.

Here’s the short version:

  • The OPR starts the Cx process. It sets performance targets, reliability needs, budget and schedule limits, and owner expectations.
  • Good OPR language is measurable. For example, ±2°F works. “Reliable cooling” does not.
  • The BoD and test scripts should trace back to the OPR. If they don’t, gaps show up fast.
  • Facility type changes the OPR. Data centers focus on uptime and redundancy. Hospitals focus on pressure, ACH, and patient safety. Labs and manufacturing sites focus on tight room conditions and utility response.
  • The OPR drives testing. It shapes L1 through L5 integrated systems testing, including failure events.
  • Hiring managers look for OPR fluency. They want people who can review BoDs, write test steps, log issues, and explain risk in plain language.
  • Pay often climbs with more OPR ownership. The article notes about $113,000 to $150,000 for many Cx engineers and $200,000 to $260,000+ for many Cx managers, with senior total pay at $300,000+ in some cases.

A few examples make this simple:

  • In a data center, the OPR may call for 72–80°F, N+1 or 2N redundancy, and full-load IST sign-off.
  • In healthcare, an AIIR may need -0.01 in. w.g. and 12 ACH.
  • In any project, a failed generator transfer is not just a test miss. It is a miss against an owner requirement.

Bottom line: if I can connect owner intent to design review, field checks, test results, issue logs, and turnover, I show the kind of project judgment employers pay for.

That’s what the full article explains in more detail.

What Goes Inside an OPR for Mission-Critical Facilities

Common Requirements Found in Most OPRs

Once the OPR is set, the next step is simple: define what has to be in it. An OPR states the owner's performance requirements in measurable terms. Commissioning professionals use that document to build verification around it. It needs to cover facility objectives, user requirements, occupancy schedules, indoor environmental conditions, maintainability, training and documentation expectations, ongoing commissioning requirements, and project schedule and budget limits, because those directly affect what the project can deliver [3][4][5].

In mission-critical work, the OPR also needs clear sequence-of-operations requirements. That means spelling out how systems should perform during normal operation, during maintenance, and during failure events. It also needs to state what recovery actions are required when something goes wrong.

The key point is that every requirement has to be measurable. A requirement like a ±2°F temperature tolerance gives the Cx team something they can test. A phrase like "reliable cooling" sounds good, but it doesn't give anyone a pass/fail target [2].

OPR Examples by Facility Type: Data Centers, Healthcare, Life Sciences, and Manufacturing

OPR priorities change by facility type. If you know those differences, it's much easier to read design intent and spot missing items early. And in mission-critical projects, those differences matter.

Facility Type Main Focus Example Criteria
Data Centers Uptime, redundancy, efficiency 72–80°F operating range; N+1 or 2N power/cooling; PUE target; power quality criteria; full-load IST sign-off
Healthcare Patient safety, infection control OR temp 68–75°F, 20–60% RH, ≥20 ACH, +0.01 in. w.g. positive pressure; AIIR at −0.01 in. w.g., ≥12 ACH (per ASHRAE 170)
Life Sciences Environmental stability, cleanliness ISO cleanroom class; humidity tolerance; airflow velocity; USP utility performance
Manufacturing Process continuity, utility reliability Sequence of operations; equipment uptime targets; failure-mode recovery actions

For airborne infection isolation rooms, or AIIRs, the requirements need to be just as clear. Measurable targets include continuous negative pressure of at least −0.01 in. w.g. and a minimum of 12 air changes per hour [7][6]. Those numbers don't just sit on paper. They become acceptance criteria during functional performance testing.

How OPR Requirements Become Testable Criteria

For commissioning teams, this is where the OPR starts doing the heavy lifting. It turns owner intent into pass/fail criteria. A broad goal becomes a number, a limit, or a defined response.

For example:

  • "High reliability" turns into a stated redundancy topology, an alarm response requirement, and a documented recovery expectation.
  • "Stable environment" turns into a temperature or humidity range, plus a stated drift limit.

In mission-critical construction, that approach lines up with a five-level verification sequence, starting with factory acceptance at L1 and ending with integrated systems testing at L5. The L5 Integrated Systems Test is where the full facility is checked against OPR criteria under operating conditions, including failure events such as loss of utility power or a single-component failure. Each step in that sequence ties back to a specific OPR requirement [1].

The Basis of Design explains how the project is supposed to meet the OPR. Functional performance tests then verify more than normal operation. They also need to check unoccupied modes, alarm response, failure scenarios, generator transfer, and system-to-system interfaces, all tied back to the OPR [9][10][8]. That traceability is what Cx teams use to write tests, log issues, and confirm closure. It's also why the OPR sits at the center of functional testing, issue tracking, and turnover.

OPR Document: How Commissioning Can Clarify Owner Vision and Drive Project Quality

Hiring for a mission-critical build? Get a pre-qualified shortlist.

iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.

Get Started

Success-based pricing · 90-day replacement credit · No upfront fee on single roles

How Cx Professionals Use OPRs Throughout a Project

The OPR is the day-to-day reference Cx teams rely on from pre-design all the way through occupancy. It ties the owner's goals to what gets designed, installed, tested, and handed over.

Pre-Design and Design: Documenting Owner Intent and Reviewing the BoD

Cx managers and engineers run OPR workshops with the owner, stakeholders, and design team to turn business goals into clear, testable requirements. For example, a data center OPR might define a 2 MW initial IT load, a path to 4 MW, a 2N UPS setup, plus required temperature, humidity, and pressurization limits [1].

From there, Cx teams review the BoD to see whether it can meet the OPR in practice. This is where problems often show up: no room for growth, the wrong redundancy target, or sequences that don't deal with failure modes. Each issue goes into a design review comment log, and each one points back to the exact OPR clause.

That same traceability carries into submittal review, field checks, and issue tracking.

Construction and Testing: Using the OPR to Verify Work and Track Issues

During construction, the OPR guides submittal review and field verification. Capacity, operating range, redundancy, interlocks, alarm points, and restart logic all need to line up with the owner's requirements.

In the field, Cx teams check whether installed systems match the OPR's redundancy, controls, and maintenance needs. If something is off, they issue a deficiency ticket and tie it to the matching OPR clause. That direct link matters. A generator that fails to pick up the full emergency load within the required time isn't just a piece of bad test data - it's a documented risk to the OPR's uptime and continuity requirements [1].

Turnover and Occupancy: Confirming Performance Against Owner Requirements

Functional performance tests and integrated systems tests are built from OPR criteria. Each test procedure points to the specific OPR section it verifies, and pass/fail thresholds come straight from the values the owner approved. On mission-critical projects, Ready-for-Service depends on L5 sign-off after L1 through L4 have met the OPR [1].

Training and O&M documentation also need to prove that site staff can keep the owner's performance targets in place without causing uptime or environmental limit problems. If open issues affect OPR-defined critical functions, they must be fixed before handover or formally accepted with a written mitigation plan.

The way teams use the OPR shifts by project phase:

Project Phase Key OPR-Related Tasks Primary Cx Role
Pre-Design / Design Facilitate OPR workshops; review BoD and sequences; log design gaps Cx Manager / CxA
Construction (L1–L2) Review submittals; verify factory acceptance; confirm installation Cx Engineer / Cx Technician
Startup (L3) Complete pre-functional checklists; verify controls logic Cx Engineer
Testing (L4) Execute functional performance tests; track deficiencies to OPR Cx Engineer / Cx Lead
Turnover (L5) Close integrated systems testing; review O&M; sign off RFS CxA / Cx Manager
Occupancy Verify ongoing performance and energy efficiency Cx Manager / DCEP

Career Skills and Roles That Depend on OPR Knowledge

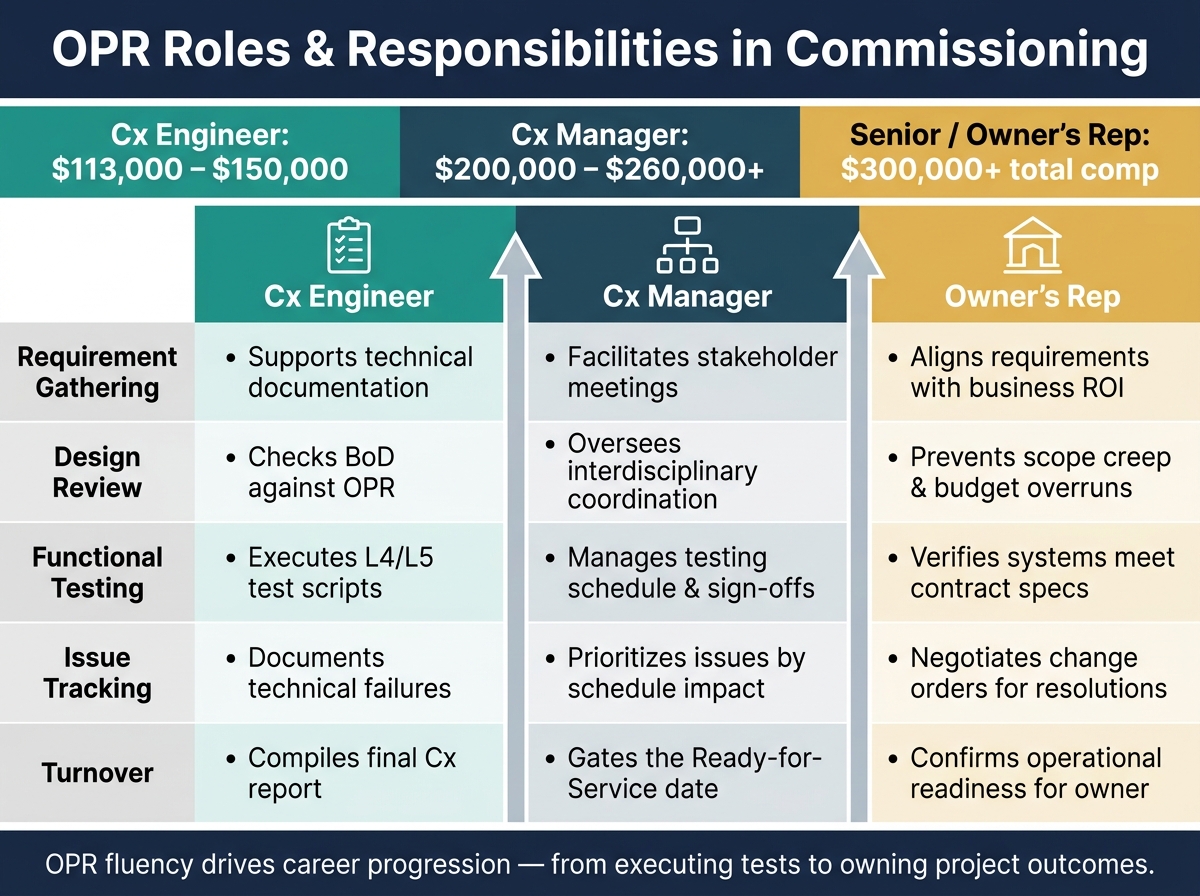

OPR Roles & Responsibilities: Cx Engineer vs. Manager vs. Owner's Rep

OPR Roles & Responsibilities: Cx Engineer vs. Manager vs. Owner's Rep

The same OPR traceability used in design, testing, and turnover is also something employers look for when hiring Cx talent. OPR fluency is a hiring signal because it shows you can connect owner intent to what happens in the field.

What Employers Expect from Cx Engineers, Managers, and Owner's Reps

Each commissioning role handles the OPR in a different way, and employers hire with those differences in mind.

Commissioning engineers work directly from the OPR. They read it, build test procedures that tie back to owner requirements, and use the OPR and BoD as the baseline for design reviews and functional performance testing. On a hyperscale data center project, every L4 and L5 test script should include a "Requirement Traceability" column that points to the exact OPR requirement being checked. That includes controls validation against stated temperature and humidity ranges, plus response times.

Commissioning managers run the OPR process. That means leading development workshops, keeping the Basis of Design aligned with the OPR, managing the master issue log, and coordinating fixes across design and construction teams so the L1–L5 sequence stays on track for Ready-for-Service (RFS).

Owner's reps use the OPR to review submittals, approve changes, and explain tradeoffs when a requirement can't be met within budget or schedule. If a proposed design cuts redundancy, the owner needs a clear picture of how that changes uptime risk and what mitigation plan has to follow.

OPR Skills That Strengthen a Cx Resume

The best resumes don't just mention OPR. They show hands-on OPR work.

Employers pay attention when candidates can point to work such as:

  • Leading requirement-gathering sessions
  • Reviewing BoD documents for gaps
  • Writing test scripts that map each step to a performance criterion
  • Maintaining issue logs with direct OPR references

Another strong signal is documenting acceptance gaps at turnover. If you can show which requirements were fully met and which ones needed a formal mitigation plan, that sets you apart in a very practical way.

Facility-specific OPR experience also matters. Data center work with tier levels, PUE goals, and IT load scalability shows one type of depth. Hospital projects bring patient safety conditions and infection control into the picture. GMP manufacturing adds cleanroom classifications and validation protocols. These project types show that you can apply OPR thinking in high-stakes settings. Familiarity with ASHRAE Guideline 0 and 1.1 also signals working knowledge of standard Cx practice.

How OPR Experience Opens Doors to Higher-Value Roles

As your role moves from execution to ownership, pay tends to move with it. Commissioning engineers in mission-critical sectors usually earn $113,000 to $150,000. Commissioning managers often range from $200,000 to $260,000+, and total compensation can go past $300,000 at the senior level [1]. That difference comes from owning OPR alignment across the full project lifecycle, not just running system-level tests.

A commissioning engineer who can lead OPR workshops, sort through conflicting requirements, and explain risk tradeoffs to senior stakeholders is already showing the core skills of a commissioning manager. And someone who understands how OPR requirements connect to business results, like uptime costs, regulatory compliance, and product quality, is in a strong position to move into an owner's rep role and speak for the owner's interests across a full portfolio.

The map below shows how OPR work changes by role, moving from support tasks to full ownership.

OPR Task Cx Engineer Cx Manager Owner's Rep
Requirement Gathering Supports technical documentation Facilitates stakeholder meetings Aligns requirements with business ROI
Design Review Checks BoD against OPR Oversees interdisciplinary coordination Prevents scope creep and budget overruns
Functional Testing Executes L4/L5 test scripts Manages testing schedule and sign-offs Verifies systems meet contract specs
Issue Tracking Documents technical failures Prioritizes issues by schedule impact Negotiates change orders for resolutions
Turnover Compiles final Cx report Gates the Ready-for-Service date Confirms operational readiness for owner

Candidates who can show full OPR traceability on L5 handoffs stand out on fast-moving projects.

Conclusion: Using OPR Knowledge to Advance a Cx Career

Those same OPR skills can give you an edge as you move up. If you're fluent in the OPR, you show that you can connect owner intent to design, testing, and turnover. That makes your work more accurate and more useful to the owner.

That's the exact skill employers want on fast-moving projects because it cuts risk. For Cx engineers, commissioning managers, and owner's reps, the ability to turn uptime and redundancy goals into test procedures - and explain non-compliances in business-risk terms - is tough to build in the middle of active construction. And it's often what helps make the case for commissioning manager and owner's rep roles.

Senior commissioning roles can reach $250,000 to $300,000+ in total compensation [1]. Treat every OPR as the benchmark for showing you can deliver mission-critical performance. Then make it clear that your design reviews, testing, issue logs, and turnover documents tie straight back to OPR requirements.

FAQs

Who usually writes the OPR?

The owner is ultimately responsible for the Owner’s Project Requirements (OPR) because it defines the facility’s goals and sets the baseline for commissioning.

In practice, the owner often hands development of the OPR to the project team. The CxA usually leads workshops with the owner, stakeholders, and facilities teams to refine and document those needs, ideally early in pre-design.

How detailed should an OPR be?

An Owner’s Project Requirements (OPR) document needs to be clear and exact. If the language is vague, commissioning can turn subjective fast, and that often leads to performance gaps.

The document should spell out measurable, testable technical requirements. That includes critical load, redundancy levels such as N+1 or 2N, rack density, cooling strategies, utility assumptions, generator runtimes, and clear acceptance criteria.

Why does that matter? Because testing should lead to objective pass-fail results, not back-and-forth debates about what the project was supposed to meet.

What happens if the OPR changes mid-project?

The OPR is a living document, so it may change as the project scope shifts or tenant needs change. When that happens, those updates should be managed in a clear, consistent way so commissioning stays in step with the project’s revised goals.

Use a formal decision log to record each change, the approver, the date, and the contract basis. That paper trail helps prevent duplicate logs, conflicting test scripts, and costly late-stage redesigns that can hurt the schedule and the facility’s performance.

Related Blog Posts

Heading 1

Heading 2

Heading 3

Heading 4

Heading 5
Heading 6

Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed do eiusmod tempor incididunt ut labore et dolore magna aliqua. Ut enim ad minim veniam, quis nostrud exercitation ullamco laboris nisi ut aliquip ex ea commodo consequat. Duis aute irure dolor in reprehenderit in voluptate velit esse cillum dolore eu fugiat nulla pariatur.

Block quote

Ordered list

  1. Item 1
  2. Item 2
  3. Item 3

Unordered list

  • Item A
  • Item B
  • Item C

Text link

Bold text

Emphasis

Superscript

Subscript

Keywords:
OPR, Owner's Project Requirements, commissioning, commissioning careers, Cx, functional testing, integrated systems testing, Basis of Design
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

CxA Certification Guide 2026: Cost, Exam & Salary Impact
August 8, 2026

CxA Certification Guide 2026: Cost, Exam & Salary Impact

CxA is for experienced commissioning pros: eligibility, exam format, 3‑year costs, prep time, and salary impact explained.
What Is Commissioning in Construction? Meaning & Careers
August 8, 2026

What Is Commissioning in Construction? Meaning & Careers

Explains how commissioning verifies building MEP, power, controls, and life-safety systems from design through turnover, plus career paths and certs.
CMIT Certification: Cost, Requirements & Salary Boost 2026
August 8, 2026

CMIT Certification: Cost, Requirements & Salary Boost 2026

CMIT is a low-cost, entry-level construction credential that boosts hiring odds more than instant pay—ideal for early-career project staff.
Construction Management Resume Keywords That Get Interviews
August 8, 2026

Construction Management Resume Keywords That Get Interviews

Use exact construction resume keywords tied to measurable project results to pass ATS and attract recruiters.
