August 29, 2026

Passive Fire Protection Roles in Data Center Delivery

By:
Dallas Bond

If one person does not own passive fire protection in each project phase, the job usually pays for it in rework, failed inspections, and turnover gaps. In data center delivery, PFP is not just a code item. It affects schedule, area release, energization, and future maintenance.

I’d boil the article down to this:

  • Set one owner per phase: design review, procurement, field install, inspection, and handover
  • Match each penetration and joint to an approved system before rough-in
  • Do not allow close-in before inspection, photos, and signoff
  • Keep a usable record set: IDs, drawings, photos, system references, EJs, and closeout logs
  • Tie PFP to hiring so PMs, supers, MEP leads, QA/QC, and turnover staff have done this type of work before

A few numbers make the point. Uptime Institute logged 11 fire incidents out of 8,000+ abnormal incidents since 1994, or less than 0.5 per year. That sounds low. But one barrier failure can still turn a small event into a multi-room outage, with downtime costs that can run fast in a live facility.

What I take from this article is simple: PFP needs clear ownership, hold points in the schedule, and records that the owner can use after turnover. Everything else supports those three controls.

Who Owns Passive Fire Protection by Role

This section maps passive fire protection ownership by role. Once the project phases are set, the next job is simple: assign one accountable owner to each role.

Project Executive and Project Manager: Scope, Budget, and Schedule Control

The project executive sets the rules for compliance, approved installer standards, and budget and schedule protection for rated assemblies and inspections. If fire-rated assemblies, specialty sealants, or added inspections increase costs, the executive settles that budget conflict and keeps PFP from getting cut during value engineering.

The project manager owns scope capture, RFI closure, submittal approval, lead times, change control, deficiency tracking, and turnover documentation. That sounds administrative on paper, but it has a direct field effect. If passive fire protection inspections aren't built into the schedule, the project can slide into rework and delayed energization.

Superintendent and MEP Lead: Field Coordination and Penetration Control

The superintendent owns sequencing, stop-work authority, pre-close access, and verification before concealment. On a data center project, where dense MEP layouts create constant penetrations through fire-rated assemblies, that day-to-day enforcement is what keeps rework off the schedule.

The MEP lead handles pre-install coordination. This role lines up ductwork, conduit, cable tray, busway, and piping routes with approved fire-rated systems before rough-in starts. If a routing change creates an unplanned opening through a rated wall, the MEP lead checks that an approved firestop system exists for that condition. In practice, this role ties together routing, approved firestop systems, and inspection access before rough-in.

QA/QC Manager and Commissioning Interface: Verification, Documentation, and Readiness

The QA/QC manager applies project inspection thresholds, documents each system by area, and closes deficiencies before concealment. Those thresholds come from ASTM E2174 and ASTM E2393: a minimum of 10% of each firestop type witnessed during installation, or destructive verification at 2% per 10,000 square feet; and at least 5% of total linear feet for fire-resistive joint systems, or one destructive sample per 500 linear feet. [3][4]

The commissioning interface confirms that fire and life safety prerequisites are closed out before energization, integrated systems testing, or turnover moves ahead. Commissioning flags readiness. QA/QC owns firestop verification. That handoff needs to be clear before turnover starts.

The summary below shows who owns, supports, and escalates each PFP task.

Role Primary PFP Accountability Key Control Point
Project Executive Compliance, budget, installer standards Scope inclusion, AHJ inspection requirements, cost resolution
Project Manager Scope, schedule, submittals, closeout Schedule integration, submittal approval, closeout package
Superintendent Sequencing, hold points, concealment control Pre-close inspection access, photo capture, stop-work authority
MEP Lead Routing, penetrations, system matching Coordination drawings, approved system match, sleeve requirements
QA/QC Manager Inspection, documentation, deficiency closure Inspection witness rates, traceable records, re-inspection signoff
Commissioning Interface Readiness gate, turnover hold Barrier and penetration closeout confirmation, deficiency flagging

Passive Fire Protection Responsibilities by Project Phase

Phase ownership matters just as much as role ownership. Each project phase brings its own fire-risk controls. If you set the owner early, before procurement locks in the design, you avoid a lot of pain later.

Design Review: Rated Assemblies, Details, and Scope Gaps

At this stage, the biggest risk is simple: missed rated-assembly gaps and unlisted conditions. The PM leads the review. QA/QC and the MEP lead check rated assemblies, details, and barrier locations. The superintendent looks for constructability issues early, and the Project Executive lines up risk decisions with owner standards.

Before fabrication or rough-in starts, the PM and QA/QC manager should pull together a fire barrier review session with the design engineers, the MEP lead, and the superintendent. The goal is straightforward. Every rated wall, floor, shaft, room separation, and each penetration and joint detail needs to be checked, tagged with the correct rating, and matched to a listed system reference.

The MEP lead then cross-checks penetration conditions in the mechanical and electrical models - cable bundles, conduit runs, chilled water piping, and ductwork - against rated barrier locations in the architectural drawings. If those don’t line up, that should trigger an RFI early, before sleeves, embeds, or rough-in begin.

The superintendent also reviews access to above-ceiling spaces and shaft interiors for later inspection. That matters more than people think. If a team can’t get back to a location, inspection and rework get messy fast.

This phase should end with a documented PFP design review report and updated drawings that drive procurement and field controls. Any gap found here should become a submittal or RFI issue, not a field workaround.

Procurement and Submittals: Approved Systems, Qualified Installers, and Material Lead Times

At this phase, the main risk is approved systems showing up late - or showing up without qualified installers. The PM runs submittals, while the Project Executive steps in when scope or budget conflicts get in the way.

Each PFP product category needs its own submittal. That includes mechanical and electrical penetration firestopping, head-of-wall and slab-edge joints, and structural fireproofing. Each package should include:

  • A listed system data sheet
  • Installation instructions
  • A clear field-use map showing where that system applies

The QA/QC manager reviews each submittal against project specs and AHJ requirements. Generic or non-listed products should be rejected before they ever reach the field. Engineering judgments should be used only when no listed system exists, and they need project-specific justification tied back to a tested system. [5][6][7][8]

Installer qualifications matter just as much as product approval. Firestop installers should have documented manufacturer training, along with project histories from similar mission-critical work. PFP materials - high-performance sealants, pre-formed devices, fireproofing coatings, and labels - also need to sit on the critical path procurement list. If those items slip, the delay doesn’t stay isolated. It rolls into wall close-in, ceiling installation, and commissioning milestones.

Field Installation: Hold Points, Sequencing, and Penetration Control

Here, the biggest risk is open penetrations getting concealed before inspection. The superintendent owns this phase.

No rated barrier should be closed until firestopping is installed and inspected. That rule needs to show up in the schedule as a clear hold point. Daily look-ahead plans should follow a tight sequence:

  • Framing complete
  • Firestopping installed
  • QA/QC inspection and photo capture
  • Close-in approved

The MEP lead enforces penetration ownership. Each trade - mechanical, electrical, plumbing, and low-voltage - either seals its own penetrations or works under a dedicated firestop contractor with clear scope boundaries. Every penetration needs a named owner. No gray area, no finger-pointing later.

If someone makes an unplanned opening through a rated barrier, QA/QC should be notified at once, and work should follow a defined approval path before continuing. Nothing gets closed until the inspection record is complete.

Inspection and Documentation: Access, Photos, Labels, and Deficiency Closure

The QA/QC manager owns the penetration and joint log, the inspection record, and the photo archive. That log tracks every PFP location in rated barriers, including the unique ID, room and coordinate, barrier rating, penetrant types, system used, installer, inspection date, and photo links.

Photos should show both the big picture and the close-up. In plain English, that means one shot of the overall barrier context and another of the product labels and system setup. Labels placed at the barrier itself - showing rating, system ID, date, and installer - help later during AHJ audits and maintenance work.

Any deficiency should trigger a Nonconformance Report. That includes the wrong product, an incomplete seal, missing backing material, or an incorrect annular gap. The superintendent should push rework access to the front of the line so open NCRs don’t pile up before commissioning. At the same time, the PM tracks open PFP NCRs as part of overall project risk.

Handover and Operations Interface: Turnover Records for Future Maintenance

At handover, the main risk is a turnover package that people can’t actually use for future maintenance. Area turnover depends on a complete technical record set, and PFP documentation is part of that requirement.

The turnover package needs to include as-built fire barrier drawings with final ratings and UL/ASTM references, a full firestop and joint system register, the complete penetration and joint log with photos, and copies of any engineering judgments used, along with their specific conditions and limits. [1][9][2][10]

The commissioning interface also works with operations to build PFP requirements into facility procedures. That means written guidance for future changes: any new penetration through a rated barrier needs a listed or engineered system, a photo, a label, and an updated log entry.

In live data center settings, teams often need PFP records in structured formats like spreadsheets or databases with room IDs and coordinates. That makes the records easier to use inside asset management and change-control systems. That record set then becomes the basis for the role-to-phase matrix that follows.

Role-to-Phase Matrix for Data Center Teams

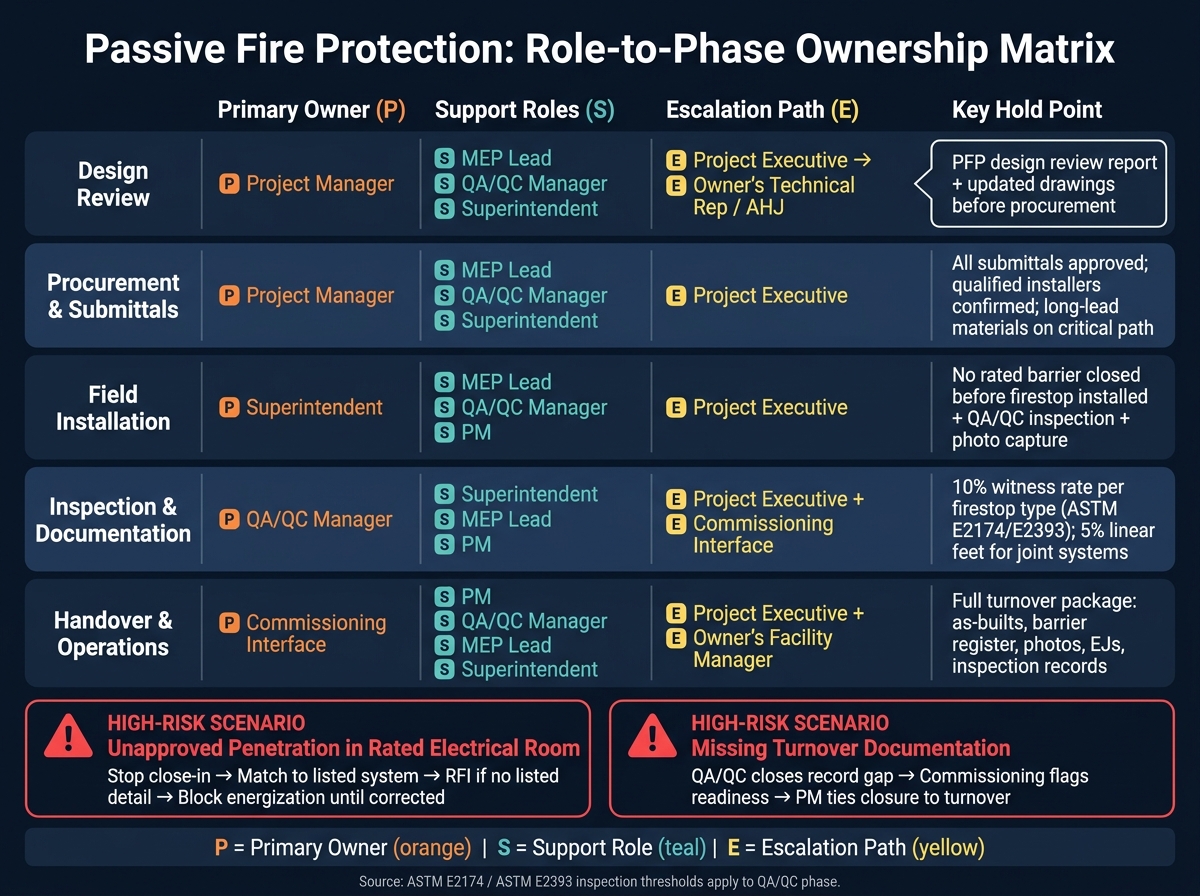

Passive Fire Protection Role-to-Phase Ownership Matrix for Data Centers

Passive Fire Protection Role-to-Phase Ownership Matrix for Data Centers

Use the turnover record set above as the basis for this matrix. It turns phase ownership into a quick control sheet for PMs, supers, QA/QC, commissioning, and staffing teams. Mission-critical hiring teams can use the same matrix to spell out what kind of role experience they need when they hire data center construction project managers.

Primary Owner, Support Role, and Escalation Path by Phase

The table below assigns a primary owner (P), a support role (S), and an escalation path (E) for passive fire protection in each project phase. The escalation path shows who steps in when close-in, energization, or budget goals run into firestopping requirements.

Project Phase Primary Owner (P) Support Role (S) Escalation Path (E)
Design Review Project Manager MEP Lead, QA/QC Manager, Superintendent Project Executive → Owner's Technical Rep / AHJ
Procurement & Submittals Project Manager MEP Lead, QA/QC Manager, Superintendent Project Executive
Field Installation Superintendent MEP Lead, QA/QC Manager, PM Project Executive
Inspection & Documentation QA/QC Manager Superintendent, MEP Lead, PM Project Executive + Commissioning Interface
Handover & Operations Commissioning Interface PM, QA/QC Manager, MEP Lead, Superintendent Project Executive + Owner's Facility Manager

Any project matrix should call out two high-risk scenarios in plain language:

  • Unapproved penetration in a rated electrical room: Stop close-in, match the opening to a listed system, issue an RFI if no listed detail exists, and block energization until corrected and documented.
  • Missing turnover documentation: QA/QC closes the record gap, commissioning flags readiness, and the PM ties closure to turnover.

Minimum Documentation and Qualification Checks

Once ownership is assigned, phase-gate records show whether the team is ready to move ahead. The table below lists the records and checks needed to close each phase.

Role Design Review Procurement Field Installation Inspection Handover
Project Manager Final drawings/specs showing rated walls, floors, and required fire-resistance levels; design review meeting minutes Approved submittals; RFI log; long-lead tracking report - - Turnover index listing all passive fire protection deliverables
MEP Lead Penetration schedule; clash detection report MEP penetration details tied to UL system numbers Redlined drawings showing field changes to penetration locations or sizes - Future penetration protocol for operations
Superintendent Constructability review notes Material logistics plan Daily logs; signed hold-point checklists; area-based close-in tracking; QA/QC sign-off required before any rated barrier is closed in Access plan; area turnover checklist Field verification of last-minute changes
QA/QC Manager Code compliance review notes Submittal review against specs and AHJ requirements - Inspection log by room/zone; deficiency reports with photos; UL/FM system references per location Final QA/QC conformity report; engineering judgment records
Commissioning Interface - - - PFP status flag in commissioning readiness checklist; rated barriers must be fully closed out before room is declared ready Rated barrier data integrated into O&M manuals; owner training records

On the qualification side, firestop installers should have documented manufacturer training certificates and verifiable project histories from comparable mission-critical work. QA/QC managers should hold ICC fire inspector or NICET fire protection credentials, or an equivalent, plus inspection templates from prior projects. Superintendents and MEP leads should have documented penetration-control experience on large, MEP-heavy builds.

Common Failure Points in U.S. Data Center Builds

Even when ownership looks clear on paper, passive fire protection can still fall apart in the field. Why? Late changes happen, schedules tighten, and handoff control gets loose. That’s usually where things start to go sideways.

Late Design Decisions That Create Unlisted Penetration Conditions

This issue starts when the MEP lead or PM allows routing to change after submittals have already been approved. One reroute can be enough to create a problem.

Say a conduit bank gets added to and now goes past the maximum fill ratio allowed under the approved UL system. At that point, the penetration condition is no longer listed at the rated barrier. That changes everything. Each condition needs its own listed system or an EJ before work can move ahead.

The field rule here should be simple: stop work at the barrier until a listed system or EJ is approved.

Close-In Before Inspection or Photo Capture

This failure starts when the superintendent releases close-in before QA/QC clears the hold point. Drywall or ceiling crews move in before QA/QC signs off, and rated penetrations end up concealed without a photo record or AHJ verification.

The impact is immediate:

  • Areas have to be reopened
  • Energization sequences slip
  • Field surveys often find nonrated foam and missing firestopping among the most common defects in existing construction [11][12][13]

A lot of those issues stay hidden because no one checked before the area was closed up.

Incomplete Turnover Packages for Rated Barriers

This problem starts when turnover records are treated like end-of-job paperwork instead of a controlled deliverable. That usually leads to missing penetration registers, linked system data, labels, and formal engineering judgments.

When that happens, teams end up doing rework, and later changes get slower and harder to track.

A proper turnover package should include:

  • A penetration register with unique IDs
  • UL system or EJ data tied to each ID
  • Photo documentation indexed to the register
  • As-built plans that show rated barriers

Use these failure modes to tighten the PM, superintendent, and QA/QC controls already assigned above.

Failure Category Typical Trigger Direct Project Impact
Unlisted penetration conditions Late routing after submittal approval Rework, EJ cost, delay
Early close-in Close-in before QA/QC sign-off Concealed noncompliance, failed inspection
Incomplete turnover package Records assembled at closeout Handover gaps, future inspection risk

How to Build Passive Fire Protection Into Project Controls

Build PFP into the master schedule, procurement log, and QA/QC plan from day one. That’s how ownership turns into clear schedule, cost, and quality gates.

Schedule Activities and Hold Points

Add PFP work to the master schedule and the two-week look-ahead. In pull planning, map each rated wall, floor, and shaft area by zone - white space, electrical rooms, shafts, and commissioning release areas. Then assign the trade in charge and list the work plainly: firestop installation, inspection, photo capture, and deficiency closeout.

Common hold points usually land at key moments:

  • before ceiling closure
  • before inaccessible spaces are sealed
  • before permanent power area release
  • before integrated systems testing

Each hold point should sit as a predecessor to the next task. That way, downstream work can’t move ahead by accident. The superintendent and QA/QC manager should sign off before the next trade starts. One pull-plan rule works well in the field: no ceiling in a data hall closes until every overhead penetration in that zone is inspected and photo-documented.

If the hold point isn’t in the schedule, the field will skip it.

Procurement, Cost, and Change Tracking

The PM and project executive should give passive fire protection its own budget code. If not, firestopping costs get buried inside general MEP or drywall line items, and then no one can see what’s going on.

Track each change by affected zone, system, and cost code. Do the same for every change order, RFI, and EJ tied to the affected opening, so rework charges stay visible and traceable.

Long-lead materials - specialty collars, sealants, sleeves, devices, and joint spray systems - should be listed in the materials log and tied to the schedule zones where they’ll be installed. Before award, check installer qualifications against the firestop qualification required by the project.

Cost visibility only works when every change is tied to a zone and system.

Quality Plans, Checklists, and Area Turnover Gates

The QA/QC manager should own a project-specific QA/QC plan. That plan should spell out the inspection checklist, labeling standards, deficiency aging rules, and acceptance criteria for each barrier type.

The checklist should verify:

  • system match
  • installer qualification
  • annular space
  • backing
  • sealant depth
  • label

Document pre-install, in-place, and closed conditions with location references. That record matters later, especially when someone asks, “Was this opening done before the ceiling went up?” You want the answer in writing and in photos, not in someone’s memory.

Area turnover gates are where all of this meets the field. Don’t release a zone until all rated barriers are complete, inspected, photographed, and closed. Unresolved firestopping deficiencies should block the hard gate, not linger on an old punch list. The QA/QC manager and commissioning interface should sign off at each gate.

Once those gates are set, the next step is putting the right people in place to enforce them.

Staffing and Hiring for Mission-Critical Teams

An ownership matrix only works if your hiring process checks for the same controls. On paper, responsibilities can look clear. On the jobsite, those controls fall apart fast if the person assigned to them hasn’t handled this kind of work before.

That matters even more now. U.S. data center construction is growing fast, while experienced people in life-safety and fire-protection roles are still hard to find. So passive fire protection isn’t just a field issue. It needs to be part of your hiring screen from the start.

What Experience Matters for Each Role

Hire for people who have personally owned design review, procurement, field installation, inspection, and turnover controls. That’s the bar. The table below shows the screening criteria that matter most for each role.

Role Screening Criteria
Project Executive Led passive fire protection across multiple data center or mission-critical projects; defined responsibility matrices for rated walls, floors, and penetrations; tied firestopping to separate budget codes and schedule gates
Project Manager Managed firestop RFIs and submittals; tracked passive fire protection change orders by zone; coordinated AHJ and third-party inspection readiness
Superintendent Sequenced work to protect inspection access; ran penetration coordination meetings; enforced hold points in congested MEP spaces
MEP Lead Coordinated penetration details for chilled water, cable bus, and busway through rated assemblies; used 3D models linked to rated barriers
QA/QC Manager Wrote and enforced project-specific passive fire protection quality plans; managed photo documentation and deficiency logs with systematic naming conventions
Commissioning Interface Coordinated phased turnover records; ensured operations teams received inspection reports, as-built penetration logs, and product data for installed systems

Use these criteria to bring in people who can own the phase gates already defined in this guide.

In interviews, the best signal is specificity. Ask the candidate to walk you through a UL-listed firestop system they’ve used. They should be able to explain the assembly type, the penetrating item, the annular space, and the firestop material.

If someone says, “we just used fire caulk,” that usually points to surface-level familiarity. A stronger answer sounds different. The candidate can explain a case where a design change created an unlisted penetration condition, then spell out how they handled it through a manufacturer engineering judgment or a documented RFI and submittal update.

Experience from data centers, hospitals, pharma plants, semiconductor fabs, and similar mission-critical facilities tends to transfer well. These projects share the same pain points: dense MEP routing, strict compartmentalization, and phased energization. That mix makes passive fire protection hard to control.

High-rise commercial or multifamily work is less likely to carry over cleanly unless the candidate can point to specific experience with rated shaft control, stair pressurization, or complex smoke control systems.

The labor picture makes this even less forgiving. With a projected annual shortfall of about 81,000 electricians from 2024 to 2034, plus a backlog nearing $40 billion in gigawatt-scale projects [14][15][16], builders can’t afford to hire on hope alone. iRecruit.co focuses on mission-critical construction hiring and screens candidates for the passive fire protection experience needed on U.S. data center projects.

Conclusion: Clear Ownership Prevents Rework, Delays, and Turnover Gaps

Passive fire protection works when each phase has one clear owner. Day to day, that means using the matrix above as the rulebook: assign a single accountable owner for every phase, enforce hold points, and fix deficiencies before the next phase begins.

That same discipline needs to continue through turnover. Handover records matter just as much as the installation itself. A complete turnover package should include:

  • as-builts
  • barrier registers
  • photos
  • approved submittals
  • inspection records
  • deficiency closeout
  • maintenance procedures

Without those records, later IT refreshes and MEP changes can damage rated barriers without anyone knowing. Then small gaps turn into a trail of undocumented openings.

The same bar should apply when hiring. Mission-critical teams need people who already know data center fire protection, and iRecruit.co can help source that talent.

The best projects usually have the clearest ownership. The formula is simple: one owner per phase, enforced from design through turnover.

FAQs

Why does PFP need one owner per phase?

Passive fire protection needs one owner in each phase. That’s how you avoid accountability gaps that can slow the project down.

When responsibility is split or left vague, teams often assume someone else is handling readiness. The result is familiar: incomplete documentation, weak handoffs, and areas that look done but still aren’t ready for turnover.

A RACI matrix helps fix that by assigning one accountable owner for each decision and phase. With that kind of clarity, teams can cut disputes, support verified closeout, and protect both schedule and quality.

What should happen if a new penetration has no listed system?

Stop the installation right away and get formal approval before you move forward.

For mission-critical projects, any non-standard penetration needs a formal fire protection review first. That review confirms the work meets code and the Basis of Design.

If the penetration is already in place, log it as a deficiency or nonconformance. Then put compensatory measures in place, such as a fire watch or extra portable extinguishers, until an approved, code-compliant system is back in place and documented.

What records should owners receive at handover?

Owners should receive complete turnover packages for electrical, mechanical, controls, fire alarm, and security systems. And those packages shouldn't be thrown together at the end of the job. They should be built during commissioning, while the work is being checked and documented.

That package should include as-built drawings, O&M manuals, and equipment warranties.

Owners should also get the records that prove the team is ready to run the building day to day. That includes:

  • Verified training and attendance records
  • Staff competency documentation
  • SOPs, EOPs, and MOPs
  • CMMS asset data
  • Spare parts lists
  • Final regulatory or inspection reports

Put simply, turnover documents need to cover both the systems themselves and the people who will operate them.

Related Blog Posts

Keywords:
passive fire protection, firestopping, data center construction, penetration control, fire barrier documentation, QA/QC, commissioning, firestop installers
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Mission-Critical Commissioning Specialist Roles
August 29, 2026

Mission-Critical Commissioning Specialist Roles

Construction completion ≠ site readiness: commissioning roles prove systems work, integrate, and remain reliable across sectors.
Mine Construction Timeline: Permit to Production - Why It Takes 7–10 Years
August 29, 2026

Mine Construction Timeline: Permit to Production - Why It Takes 7–10 Years

Why U.S. mine builds take 7–10 years from late‑stage study to first production: permits, financing, long‑lead equipment, construction, and commissioning.
How to Build a Hyperscale Data Center Team
August 29, 2026

How to Build a Hyperscale Data Center Team

Learn 5 ways project leaders build hyperscale data center teams through trust, delegation, partner alignment, and field leadership growth.
The MILCON Timeline: Appropriation to Award to Beneficial Occupancy
August 28, 2026

The MILCON Timeline: Appropriation to Award to Beneficial Occupancy

Explains the MILCON flow from authorization and appropriation through award, construction, commissioning, and beneficial occupancy.
