Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If one role owns the test, another owns the install check, and a third owns the paperwork, you avoid the gap that delays turnover. In data center builds, most late-stage failures happen at handoffs between QA, QC, commissioning, and MEP teams - not because the equipment is bad, but because ownership is unclear.
Here’s the short version:
If you’re staffing a U.S. data center project, I’d keep four things clear before mobilization:
That matters because a single missed record, failed pre-functional check, or bad handoff can delay energization by days or weeks and add $10,000s to $100,000s in rework, retesting, and schedule slip on large projects.
Quick comparison
I’d sum up the article this way: set one clear owner for each gate, keep commissioning independent when reliability is high, and split program-level oversight from site-level execution on campus builds. That simple structure cuts rework, failed tests, and handoff confusion.
Hiring for a mission-critical build? Get a pre-qualified shortlist.
iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.
Get Started
Success-based pricing · 90-day replacement credit · No upfront fee on single roles

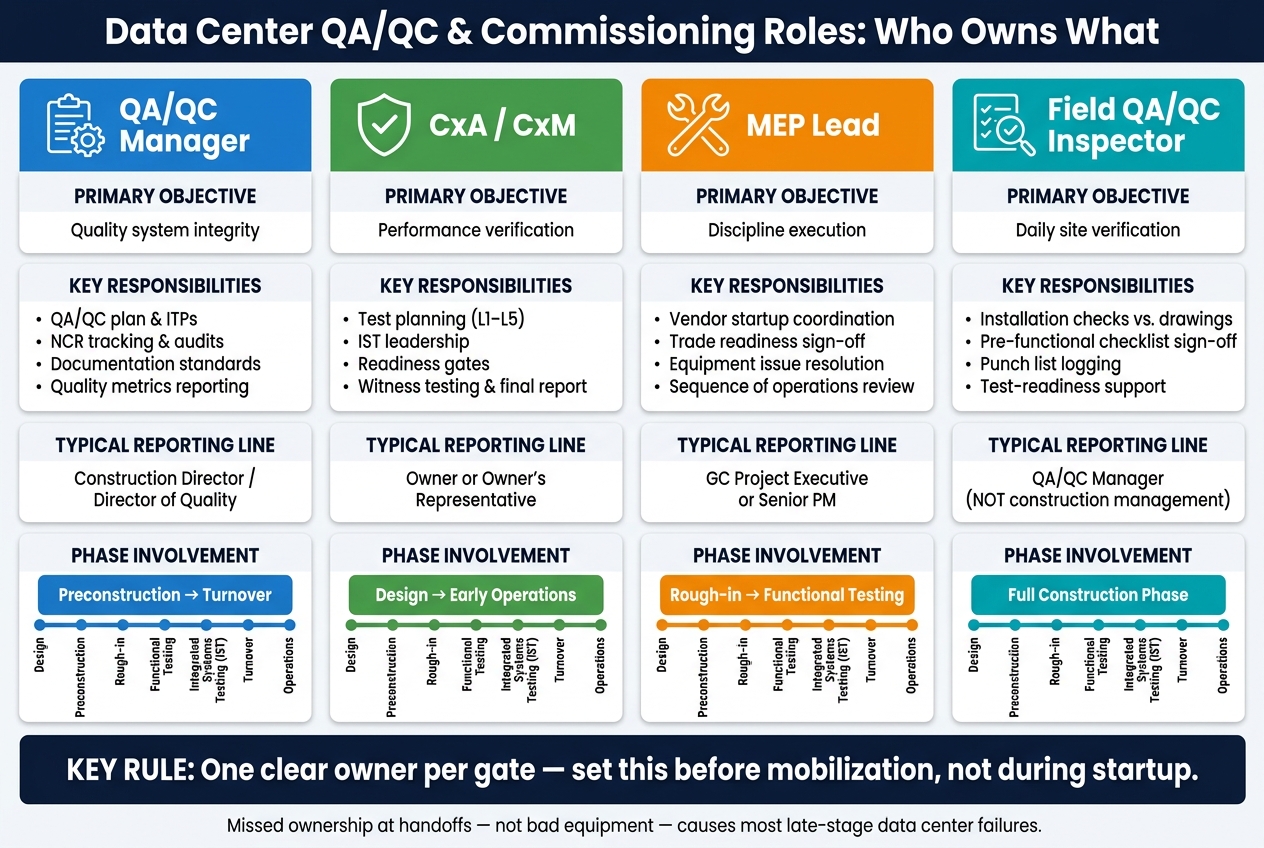

Data Center QA/QC & Commissioning Roles: Who Owns What
These roles each own a different part of project delivery. When those lines get fuzzy, handoffs tend to break down between installation, startup, and testing.
The QA/QC Manager owns the quality management system across the full project. In practice, that means responsibility for the project QA/QC plan, ITPs, and documentation standards. This role also tracks NCRs, runs audits, and reports quality metrics to project leadership.
The reporting line matters. If schedule pressure gets too close to the quality function, enforcement can slip. On large data center campuses, a common best-practice setup is a solid-line to the Construction Director with a dotted-line to a corporate Director of Quality. That gives the role enough independence to enforce standards, while still keeping it close to day-to-day site decisions.
The table below shows the difference between these two roles. The CxM usually sits on the GC or EPC side and drives execution, scheduling, and turnover coordination. The CxA reports to the owner or owner's representative and owns final technical acceptance.
This role owns the commissioning plan, readiness gates, pre-functional checklists, functional performance tests, Integrated Systems Testing (IST), and the final commissioning report. It helps to keep commissioning separate from construction management. That way, test results stay defensible to the owner, insurers, and end customer.
The MEP Lead is the technical lead for mechanical, electrical, plumbing, and controls systems. The job is to make sure those systems move safely from static installation to energized operation. That includes vendor startup, field issue resolution, and trade coordination through readiness gates. The MEP Lead usually reports to the Project Executive or Construction Director. On large U.S. data center portfolios, the role sometimes reports to a central MEP or Technical Director.
Field QA/QC Inspectors are the day-to-day enforcement layer. They verify installations against drawings and specs, log defects, and confirm pre-functional checklists before functional testing begins. They report to the QA/QC Manager, not to construction management, so findings can't be quietly pushed aside by schedule pressure. If this role is understaffed, intermittent failures can show up during IST or after turnover.
The table below sums up how all four roles compare across the areas hiring managers tend to care about most.
Next, map these roles to preconstruction, construction, startup, and turnover so ownership stays clear at each gate.
Ownership changes as the project moves forward. And most quality problems don’t show up in the middle of a phase - they show up at the handoff. That’s where things get missed, test steps drift, and one team assumes another team handled it. This phase map turns the role matrix above into day-to-day execution.
At this stage, QA/QC locks down the quality plan, ITPs, and document control. The CxA checks that the design can actually be tested and that acceptance criteria are in place before procurement starts. That matters more than it may seem. If nobody defines pass/fail criteria early, startup scripts later won’t line up with the system that gets installed in the field.
The MEP Lead reviews constructability in plain terms: Is there room to maintain the equipment? Can teams reach test points? Do the sequences of operation for critical power and cooling systems reflect failure conditions that could happen on a live site? Field QA/QC staff prepare inspection templates, material receiving checklists, and mock-up criteria so the site team has something usable from day one.
That early alignment cuts down on rework once equipment and controls arrive and installation starts.
During construction, Field QA/QC staff verify installations against drawings and specs. That includes cable terminations, pipe supports, equipment mounting, penetration seals, and other field details that often decide whether a clean startup is possible. They also log deficiencies as they find them.
The QA/QC Manager tracks NCRs, root causes, and repeat defects. The MEP Lead owns technical review and signs off on startup readiness. For hydronic systems, flushing, pressure tests, and chemical treatment need to be finished and documented. For electrical systems, teams need megger tests, insulation resistance tests, and torque verification completed before energization.
Field QC marks each pre-functional checklist item complete. The MEP Lead reviews and approves that work. Then the CxA gives final readiness confirmation before any system goes live. Those checks roll straight into functional testing.
During functional performance testing, the CxA leads test execution, keeps the issues log current, and controls the test schedule. The MEP Lead explains system sequences, reviews failed results, and directs trade contractors on corrective action. Field QA/QC staff record field conditions such as valve positions, damper status, breaker positions, and test readings. The QA/QC Manager oversees document control and tracks retest rates across systems.
IST - black-building, utility-loss, generator, UPS, and cooling scenarios - is where all four roles come together under the most pressure. The CxA owns the integrated test script and final acceptance. The MEP Lead and site operations representatives check system response against the stated performance criteria.
Use the matrix below to assign one owner per gate.
After IST passes, turnover shifts into a document-control task. The closeout package needs to include:
If even one of those items is missing at handover, occupancy and transfer to operations can be delayed.
Use the role matrix to size the team based on project scale, reliability target, and how many buildings fall under one program.
On a single-building project - say, a 20–30 MW facility in Phoenix or Columbus - one Site QA/QC Manager plus one or two discipline inspectors is usually enough. That person owns the quality plan, handles daily inspections, tracks NCRs, and works directly with the commissioning team. It’s a lean setup on purpose.
Once you move to a campus-scale project, that model starts to crack. One site QA/QC manager can’t keep standards lined up across several buildings at once. That’s where a Program QA/QC Director comes in. This role owns standards, checklists, approved vendor lists, and cross-site defect metrics, while Site QA/QC Leads handle execution at the building level.
The table below shows how the structure changes:
The next call is reporting structure: independent commissioning or construction-led commissioning.
On Tier III, Tier IV, and other high-reliability programs, commissioning should report outside construction management. The reason is simple: test acceptance has to stay independent. Redundancy setups like N+1, 2N, and 2N+1 only mean something if they’re tested under simulated failure conditions. If the same team pushing schedule also controls acceptance, things can get blurry fast.
On smaller or lower-complexity builds, some owners let commissioning sit under construction management. But for higher-reliability or multi-building programs, independent commissioning is usually the better fit.
When the schedule gets tight, specialized recruiting can help fill these roles faster.
iRecruit.co fills data center QA/QC, commissioning, MEP, and field roles with pre-qualified data center construction candidates, helping owners and GCs staff faster and reduce hiring friction.
Start with the role matrix. Before anyone mobilizes, lock down who owns what: QA sets the standards, QC checks the work, commissioning proves the system performs as planned, MEP leads handle cross-discipline issues, and field teams keep the site ready for each next step.
Put that role matrix in place before commissioning begins, then turn it into a one-page responsibility list people can actually use in the field. At a minimum, spell out who owns:
Those roles should be clear across preconstruction, startup readiness, functional testing, IST, and turnover.
Publish the org chart and responsibility matrix at kickoff, not during startup. If you wait until the schedule gets tight, confusion tends to pile up fast. And when hiring gets squeezed, specialized recruiting can cut time-to-fill for QA/QC, commissioning, MEP, and field roles. If you need QA/QC, commissioning, or MEP hires before that happens, iRecruit.co places pre-qualified candidates for mission-critical construction teams.
Final acceptance sits with the owner or the owner’s representative.
The Commissioning Manager handles turnover. The Commissioning Authority (CxA) works as an independent checker, confirms the system lines up with the design intent, and recommends acceptance. Operations staff and the owner’s commissioning representative also help verify that the system meets day-to-day operating needs before final sign-off.
Commissioning should be independent when impartial verification and objective decision-making matter most. That’s especially true when you need to keep contractor-led schedule pressure from steering the process.
On most U.S. mission-critical projects, owners bring in a third-party CxP or CxA that reports directly to the owner. Their job is to verify compliance with the Owner’s Project Requirements. For high-risk testing, owners often require independent witnessing.
On-campus builds need QA/QC staffing that changes as the job moves forward. Early on, the focus should move from broad oversight to phased, trade-specific support. Put QA/QC staff in place during foundation work and structural framing so they can catch hidden work before it gets covered up.
As startup gets closer, bring in electrical, mechanical, and controls inspectors to handle hold points plus inspection and test plans. Staffing should grow with site headcount, then shift toward integrated systems testing and final turnover during commissioning.
