October 18, 2026

Time to Hire for Data Center PMs & Supers: 2026 Benchmarks

By:
Dallas Bond

For a U.S. data center project, I’d budget 30–45 calendar days to hire a midlevel project manager and 8–12 weeks for a superintendent. Then add two to four weeks for notice, plus relocation and site onboarding, before counting on someone to start.

These are planning ranges through October 18, 2026, not national averages. Here’s how I’d use them:

  • Match the role: Senior PM searches can take 45–75 days; senior or specialized superintendent searches may need 12–20 weeks or longer.
  • Set terms early: Confirm pay, authority, travel, housing, and rotation before interviews. Location and mission-critical experience can stretch the search.
  • Work backward from mobilization: Add hiring time, notice, onboarding, and contingency to set your requisition approval deadline.
  • Track delays weekly: Assign deadlines for candidate review, interviews, offers, and start readiness.

My main rule: <u>an accepted offer is not a staffed job site</u>. Keep hiring time and time to start separate so your staffing plan supports the construction schedule.

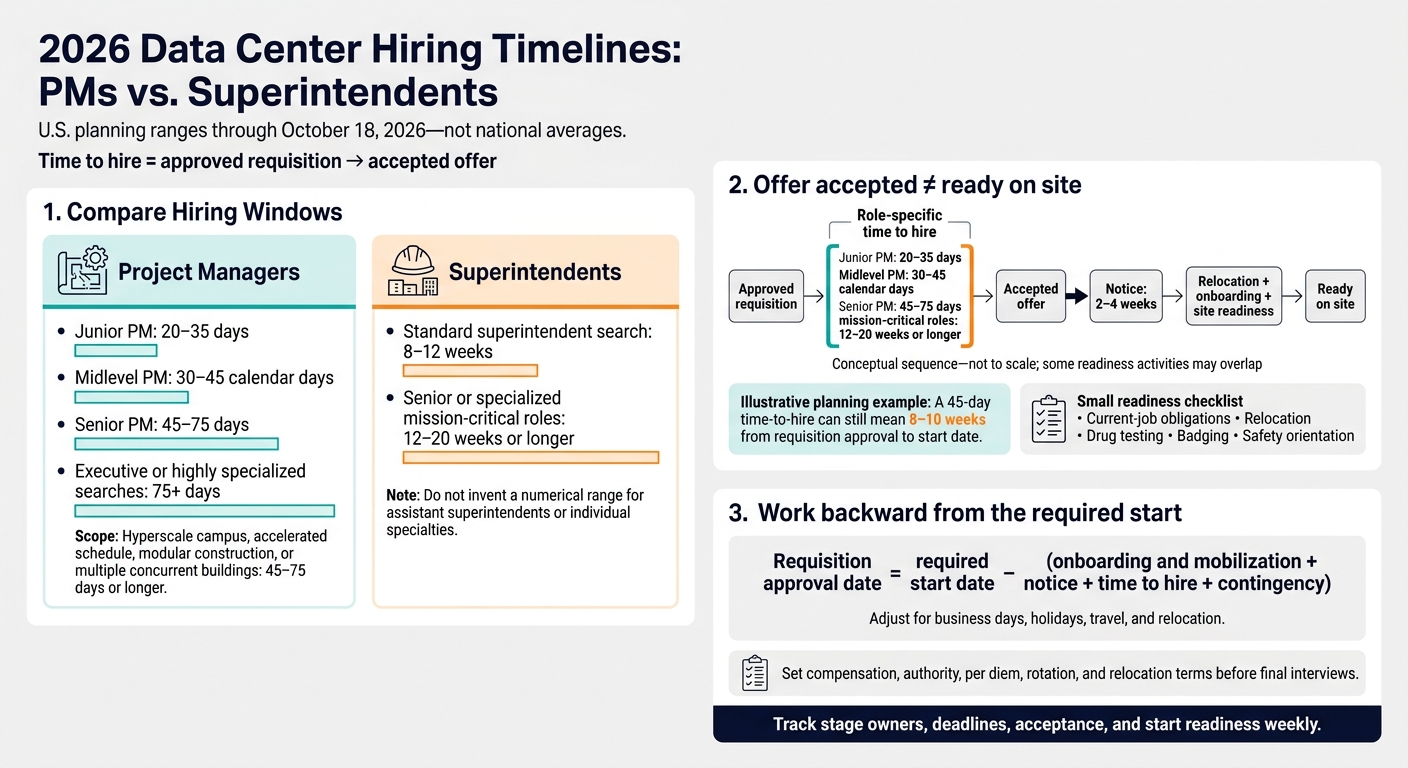

2026 Data Center Hiring Timelines: PMs vs. Superintendents

2026 Data Center Hiring Timelines: PMs vs. Superintendents

1. Data Center Project Managers

Hiring Duration

PM searches usually move faster than superintendent searches when the scope, authority, and market are clear.

Plan for 30–45 calendar days from approved requisition to accepted offer for a midlevel data center PM with a defined scope. A separate 2026 dataset of 122 completed placements across more than 20 metro markets reports a 10.1-day PM average[5]. However, it does not clearly establish whether the clock starts at requisition approval.

The hiring window grows when the role goes beyond managing a single building.

Seniority and Technical Experience

Allow 20–35 days for junior PMs, 30–45 days for midlevel PMs, 45–75 days for senior PMs, and 75+ days for executive or highly specialized searches. Requirements for hyperscale delivery, high-voltage coordination, commissioning, or live facility experience can extend these timelines.

A PM search for a single-building, moderate-size facility may stay within the standard range if requirements are flexible. For a hyperscale campus, accelerated schedule, modular construction, or multiple concurrent buildings, budget 45–75 days or longer.

Define the delivery model and decision authority before outreach. For design-build, EPC, and owner’s representative searches, spell out the contract type, reporting structure, peak workforce, handoff plan, and project phase.

Market and Candidate Availability

Northern Virginia, Dallas-Fort Worth, Phoenix, Atlanta, Austin, and parts of the Midwest often have deeper talent pools. But active projects compete for those same candidates. Set salary, per diem, rotation, and relocation terms before outreach begins.

Hiring Stages and Start Readiness

For a standard search, budget:

  • 5–10 business days for sourcing
  • 3–7 business days for screening
  • 5–10 business days for interviews
  • 2–5 business days for references and approval
  • 2–5 business days for offer development and acceptance

Overlap stages where practical.

Use a preapproved scorecard to assess mission-critical experience, MEP literacy, schedule and cost control, subcontractor management, commissioning, safety, and owner communication. If the owner needs to interview candidates, schedule that step before the offer stage. Make clear who has final decision authority.

Set turnaround targets of two business days for resume review, one week for first interviews, and 2–3 business days for final decisions.

Budget separately for the candidate’s commonly required two- to four-week notice period, plus relocation or onboarding time. A 45-day time-to-hire can still mean 8–10 weeks from requisition approval to start date. When mobilization is fixed, that gap matters as much as the offer date.

PM hiring sets the pace, but superintendent hiring usually puts more pressure on the timeline because field coverage is less flexible.

2. Data Center Superintendents

Superintendent searches usually take longer than PM searches because field teams can’t absorb a vacancy. An unfilled role puts site control and turnover milestones at risk.

Hiring Duration

Plan for 8–12 weeks from approved requisition to accepted offer for standard superintendent searches. Senior or specialized mission-critical roles may take 12–20 weeks or longer. These are planning ranges, not a national average.

AGC’s 2026 Workforce Survey reports that 75% of firms with superintendent openings struggled to find qualified candidates.[7] Short sourcing or source-to-acceptance windows don’t measure the full hiring cycle.

Seniority and Technical Experience

Assistant superintendents with strong industrial experience may fit the shorter window when an experienced lead supervises them. For data center assignments, verify completed turnover experience, MEP coordination, commissioning, subcontractor control, and safety leadership.

Be clear about which requirements call for data center experience and which can transfer from hospital, semiconductor, or pharmaceutical work.

Market and Candidate Availability

Northern Virginia, Phoenix, Dallas-Fort Worth, Atlanta, and Central Ohio compete for the same field leaders. A national search can expand the candidate pool. For travel-heavy assignments, settle housing, per diem, rotation, flights, and assignment length before outreach begins.

Hiring Stages and Start Readiness

Allow 2–4 weeks for sourcing, 2–4 weeks for interviews and technical validation, and 1–3 weeks for references, approvals, and offer negotiation. Overlap stages where practical, but don’t treat these allowances as a guaranteed total. Track client interview delays and compensation approvals separately from candidate response time.

Before acceptance, clarify site access, temporary facilities, subcontractor commitments, and field authority. After acceptance, track time to site readiness separately, including current-job obligations, relocation, drug testing, badging, and safety orientation.

Set the arrival date around field-control needs, not offer timing. Work backward from mobilization to account for the gap between offer acceptance and site readiness.

How Seniority, Experience, and Location Affect Hiring Time

Use the preceding PM and superintendent hiring windows as baselines. Then adjust for seniority, specialty, and market tightness. These factors explain why the same role can fill in weeks in one market but take months in another. The tables below show where searches tend to slow down. They’re planning comparisons, not validated role-level averages.

More authority and narrower technical requirements generally mean a longer search.

Role Distinguishing requirement Candidate pool depth Interview complexity Counteroffer risk
PM Broader construction backgrounds can shorten the search Regional and national Hiring-manager interview and project assessment Moderate
Senior PM Ownership of projects at a comparable scale narrows eligibility Usually national Operations and client review High
Project executive Portfolio authority calls for targeted outreach Limited executive pool Executive and client-fit review Very high; a tailored authority package may be needed
Superintendent Local-only requirements limit availability Depends on travel flexibility Field and project-history review High
Senior superintendent Large-scale turnover responsibility limits the pool Often national Operations and reference checks Very high
MEP superintendent Controls and energized-site expertise call for specialist sourcing Limited specialist pool Technical sequence review Very high
Commissioning-focused field leader Proven integrated systems testing experience narrows eligibility National or cross-industry Commissioning scenario assessment Very high; contractors and owners compete for these candidates

Location affects the candidate pool, compensation package, and likelihood of counteroffers. Use the pressures below to adjust hiring deadlines before mobilization - not as local averages for days to hire.[8][9][10]

Market Planning category and specific hiring pressure
Texas High-volume market with multiple hubs; semiconductor and industrial projects draw from overlapping talent pools
Arizona Growing specialist market; semiconductor demand competes for MEP and commissioning leaders
Northern Virginia Highly competitive mission-critical market; wage premiums and counteroffers can make closing harder
Georgia Growing regional hub; contractor concentration affects access to experienced field leaders
Ohio Growing cluster market; reliance on traveling crews changes the available candidate pool
Pacific Northwest High-cost, dispersed market; distance between projects limits commuting options

Even a fast offer can stall when travel, housing, or clearance requirements remain unresolved. Set compensation, authority, per diem, rotation, and relocation terms before final interviews. Identify security or client-approval gates early, too, so the hiring deadline supports mobilization - not just offer acceptance.

Hiring Delays and Planning Backward From Mobilization

Plan backward from mobilization. Time to hire ends at offer acceptance - not the first day on site. Use the overlapping workflow below to plan PM and superintendent searches alongside your data center construction schedule. These are planning ranges; senior or specialist hires can take longer.[11][15] Use the shorter PM window for preconstruction leadership and the longer superintendent window for field control.

The goal is to secure an accepted offer before a leadership gap starts costing the project time or money. Here’s how to shorten the search while keeping each step under control.

Stage Accelerated process Conventional process Implementation guidance
Requisition approval and intake 1–2 business days 3–7 business days Confirm scope, reporting line, pay range, travel, project phase, and start date before sourcing
Sourcing and initial screening 3–7 days 1–3 weeks Use a targeted mission-critical network to reach scarce PM and superintendent talent
Hiring-manager review 1–2 days 3–7 days Set a 24–48-hour review standard
Interviews 5–10 days, overlapping 2–4 weeks Keep the process to two or three structured rounds
References and approvals 1–3 days 3–10 days Start references once the preferred candidate is identified
Offer preparation and acceptance 1–3 days 3–7 days Pre-approve compensation and authority to negotiate
Total to accepted offer About 3–5 weeks About 5–8 weeks or longer Add notice, relocation, and contingency outside the hiring window

Fast-track examples exist, but they aren’t benchmarks for every search.[12][13]

Keep handoffs moving. Give the hiring manager 24–48 hours to review candidates and require a decision within 24 hours of the final interview.[13] Track delays caused by unclear scope, missing project details, extra interview rounds, compensation approval, and travel or start-date conflicts.

Make ownership clear: recruiting handles scheduling, the hiring manager provides feedback, and finance or compensation approves the package. Review stalled items weekly against the required start date.

PM hiring usually needs to finish before execution plans become fixed. Superintendent hiring needs to finish before field work peaks. Plan backward from these project gates:

Project milestone Staffing implication Recommended backward-planning action
Preconstruction PM leadership supports estimating, constructability, procurement planning, and early trade coordination Start identifying the lead PM before design and contracting decisions are finalized
Notice to proceed Core project leadership should be selected and aligned with the execution plan Have the PM hired or at the finalist stage before notice to proceed
Mobilization The superintendent coordinates site logistics, safety, temporary facilities, and early subcontractor activity Secure acceptance early enough for notice, travel, onboarding, and site preparation
Structural turnover Field leadership coordinates envelope, structure, access, and trade sequencing Confirm superintendent coverage before the turnover date - not when structural work is complete
MEP installation PM and superintendent capacity must support major electrical, mechanical, controls, and subcontractor interfaces Staff before peak MEP coordination begins; add specialty leadership where required
Energization Experienced mission-critical leadership supports electrical safety, turnover planning, and utility coordination Avoid first-day staffing changes immediately before energization
Commissioning PM, superintendent, commissioning, and trade teams coordinate documentation, deficiency correction, and turnover Have leaders established before commissioning planning starts
Integrated systems testing Stable leadership supports test scripts, issue resolution, client coordination, and final acceptance Treat leadership continuity as a prerequisite; add contingency for failed tests or rework

These relationships aren’t fixed calendar offsets. The project’s delivery method, size, phasing, utility constraints, and commissioning strategy may require leaders to start earlier.

Use this formula to work backward from mobilization and set the hiring timeline:

Requisition approval date = required start date − (onboarding and mobilization + notice + time to hire + contingency).

Allow two to four weeks for notice after acceptance, outside the search window.[14] Adjust for business days, holidays, travel, and relocation.

Don’t apply a blanket six-to-nine-month lead time. If leadership is needed that early, tie the date to specific procurement, MEP coordination, or commissioning-planning duties.

Conclusion: Set Hiring Deadlines and Track Delays

Use the role-specific ranges above as planning baselines. There’s no fixed national data center benchmark. PM screening focuses on commercial, financial, contract, client, and schedule control. Superintendent screening focuses on field leadership, trade coordination, safety, commissioning, and site execution. This scarcity extends to commissioning talent, which is also increasingly difficult to source. National survey data still ranks both among the hardest salaried construction roles to fill: 75% of firms struggle to hire superintendents, and 74% struggle to hire project managers or supervisors.[6]

Choose a baseline that measures approved requisition to accepted offer.[3][4] Document whether it counts weekends, approvals, declined offers, and paused searches. Don’t compare it with submission-to-acceptance figures.[16]

Adjust that baseline for seniority, market, mission-critical experience, compensation, relocation, and site or security access. Then work backward from the required start date, keeping post-acceptance steps outside time to hire.

Use a weekly dashboard to turn benchmarks into deadlines. Track qualified slate delivery, manager response, interviews, offer issuance, acceptance, and start readiness. Give each stage an owner, deadline, and forecast. Report PMs and superintendents separately by market and seniority.

A search is behind schedule when any stage misses its deadline or the forecast start or readiness date moves past mobilization. Flag the bottleneck immediately and address that specific delay rather than extending the overall deadline.

FAQs

How much hiring contingency should I budget?

Treat senior data center roles like long-lead equipment: start searches 3 to 6 months before those roles become mission-critical. That gives you room for typical hiring timelines of 60 to 90 days.

Budget $15,000 to $25,000 for every 30 days a role stays vacant, plus schedule risks, rework, and liquidated damages. Plan leadership, controls, and commissioning hires one full project phase before their required on-site start dates.

Which data center experience requirements can I relax?

Separate must-haves from preferred experience. Direct data center experience is standard for critical roles, but consider candidates with backgrounds in pharmaceutical manufacturing, semiconductor fabrication, or hospital construction [1][2].

Before moving candidates forward, verify their experience in complex MEP coordination, phased delivery, integrated master scheduling, and rigorous commissioning. Also require proof of hands-on work with redundancy models, FAT/SAT/IST protocols, and zero-downtime environments [1][2].

What should I do if hiring threatens mobilization?

Treat the vacancy as a schedule risk, not a routine HR task. Give it priority in your risk register, assign an owner, and check whether your team has the capacity and specialized market access to fill it on time.

If the role has been open for 60 to 90 days, or candidates reaching interviews lack mission-critical experience, bring in a specialized recruiting partner to protect the critical path.

Related Blog Posts

Keywords:
data center hiring, project manager hiring, superintendent hiring, time to hire, hiring benchmarks, mobilization planning, construction recruitment, PM timelines, superintendent timelines
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

QA/QC Engineer vs Commissioning Engineer: Data Center Roles & Pay
October 18, 2026

QA/QC Engineer vs Commissioning Engineer: Data Center Roles & Pay

Compare QA/QC and commissioning in data centers: daily duties, L1–L5 testing, handoffs, staffing, credentials, and pay considerations.
Data Center Recruiters: How Hyperscale Owners & GCs Vet a Firm
October 18, 2026

Data Center Recruiters: How Hyperscale Owners & GCs Vet a Firm

Pick data center recruiters by verified placements, technical screening, client references, timelines, and clear fees — start with one pilot search.
Hiring a Data Center MEP Manager: Pay Bands, Vetting & Timeline
October 18, 2026

Hiring a Data Center MEP Manager: Pay Bands, Vetting & Timeline

Benchmarks, vetting checklist, and a 6–10 week hiring timeline for data-center MEP managers; plan $100k–$220k base pay.
Cost per Hire in Construction Management: Data Center Benchmarks
October 18, 2026

Cost per Hire in Construction Management: Data Center Benchmarks

Clear method to calculate cost-per-hire for data center construction roles and compare internal, agency, retained, engaged, and RPO models.
