August 21, 2026

AS9100 for Facility and Construction Teams: What Aerospace Builds Require

By:
Dallas Bond

If you’re building for aerospace, the building has to support an AS9100 quality system on day one. That means your job is not just to finish the space. You also need clean records, controlled changes, calibrated test data, and a turnover package the owner can use in an audit.

Here’s the short version:

  • AS9100 applies to the owner’s quality management system, not the building itself
  • Facility design still matters because HVAC, compressed air, power, layout, clean zones, and ESD controls affect production quality
  • Documentation is a big part of the job: item IDs, lot and heat numbers, certs, revision logs, calibration files, and test reports all need to line up
  • Commissioning has to prove performance with calibrated instruments and records tied to acceptance criteria
  • Different aerospace spaces need different control levels: manufacturing, MRO, and defense electronics do not need the same setup
  • Hiring matters because weak QA/QC, document control, or commissioning can turn into audit findings later

A few numbers show how tight these projects can get:

  • AS9100 Rev D adds about 80 aerospace-specific requirements on top of ISO 9001:2015
  • Critical compressed air may need a dew point near -40 °F (-40 °C)
  • Precision assembly spaces often target 68–72 °F and 40–55% RH
  • Clean assembly areas may need pressure gaps of 0.02–0.05 in. w.g. relative to nearby spaces
  • One open hiring gap in a key role can cost about $20,640 per month

If I had to boil the whole article down to one point, it’s this: aerospace construction is part building project, part quality-records project. You’re not just handing over walls, utilities, and equipment. You’re handing over proof that the site can support controlled aerospace work from the first day of use.

What are AS 9100 and ISO 9001, Why Are They Important, and How Are They Different?

ISO 9001

How AS9100 Changes Facility Design and Construction

AS9100 Facility Types Compared: Manufacturing vs. MRO vs. Defense Electronics

AS9100 Facility Types Compared: Manufacturing vs. MRO vs. Defense Electronics

AS9100 Rev D treats infrastructure and the work environment as part of quality control. So these aren’t just building issues. They turn into facility requirements for HVAC, space planning, flooring, and utilities. Choices around compressed air, power, and controlled rooms tie straight back to the owner’s quality management system, not just code minimums.

Infrastructure, Utilities, and Controlled Environments

Compressed air, specialty gases, vacuum systems, and power should be handled as controlled inputs. That means documented performance, commissioning records, and proof that each system does what production needs it to do.

Compressed air used on production equipment often needs drying and filtration to a dew point of −40 °F / −40 °C for critical pneumatic controls. Particulate and oil limits also need to be documented and tested during commissioning [6][9]. Specialty gases like nitrogen, argon, and oxygen need clearly marked piping, isolation valves, and logged pressure or vacuum performance tests as quality records. Vacuum systems used for composite bagging or leak testing need that same level of documentation and test history.

Power quality also matters, especially in avionics test areas and metrology labs. In practice, that can mean dedicated feeders, isolation transformers, and power conditioning. Voltage, frequency, and grounding specs should be written into the facility’s documented capability record [2][6].

Layout is another big driver. The goal is one-way flow: receiving → inspection → controlled storage → assembly → test → shipping. Corridors, doors, and access controls should support that path [1][5]. Nonconforming material needs a dedicated quarantine area that is physically separate and access-controlled. Inspection rooms should sit near production, not off at the edge of the building. Floor markings, color-coded racking, and signage help back up those procedures.

HVAC targets should be written directly into mechanical schedules and air-balance diagrams. Precision assembly and electronics spaces typically stay at 68–72 °F with 40–55% RH. Composite layup rooms often cap humidity at 45–50% RH to protect prepregs. Clean assembly zones and ISO-classified cleanrooms need positive pressure of 0.02–0.05 in. w.g. - about 5–12 Pa - relative to nearby corridors, while paint booths and chemical processing areas run negative to keep vapors contained [9][11]. Commissioning should include calibrated sensor checks and trend logs that show those conditions stay in range.

Cleanliness, ESD, and Sensitive Production Areas

Some aerospace hardware doesn’t forgive dirty conditions. Optics, sensors, precision mechanisms, and avionics are good examples. In those spaces, owners set cleanroom or clean-assembly criteria tied to ISO 14644 classifications. ISO Class 7–8 is common for satellite assembly and some propulsion components [7][8][11].

The construction details matter here. Seamless epoxy or sheet vinyl flooring, coved base, sealed penetrations, smooth wall and ceiling finishes, and HEPA or ULPA filtration all help support the target classification. A small gap or rough surface might not look like much, but in a controlled room it can become a contamination source.

ESD control adds another layer in avionics and defense electronics areas. ESD-safe flooring - conductive or static-dissipative vinyl with a surface resistance of 10⁶–10⁹ Ω - connects to copper grounding grids or busbars tied to the building grounding system [3][10][13]. Workstations need grounded mats, wrist-strap stations, and bonding points. Before production begins, resistance and continuity tests should be documented with calibrated ESD meters [12][13]. Those reports belong in the turnover package.

Gowning flow and contamination-control details also need to be built into the space itself, not left to procedures alone. Gowning rooms should include benches, lockers, and garment racks arranged for one-way movement from the street-clothing side to the clean side. Airlocks or ante-rooms between corridors and cleanrooms help hold cleanliness gradients. Sticky mats at entries, smooth cleanable finishes, and controlled tool storage help keep the room aligned with documented procedures [4][9][11]. Turnover records for these areas should include room classifications, planned gowning protocols, and particle count validation reports.

Facility Type Comparison: Manufacturing vs. MRO vs. Defense Electronics

The same AS9100 framework applies across facility types, but the control level changes a lot depending on the work.

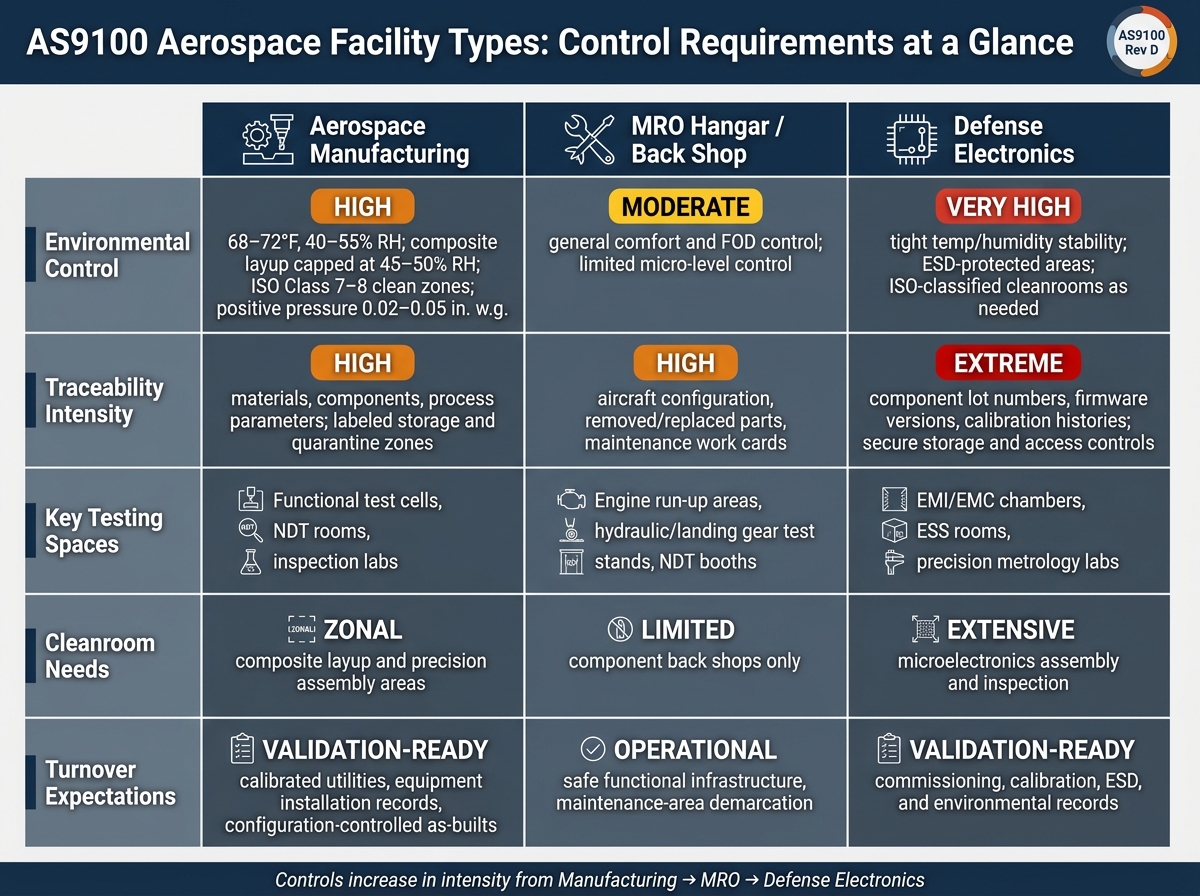

Feature Aerospace Manufacturing MRO Hangar / Back Shop Defense Electronics
Environmental Control High - stable temperature and humidity for machining, assembly, and composites; selected ISO 7–8 clean zones Moderate - overall comfort and FOD control; limited micro-level control Very high - tight temperature/humidity stability, ESD-protected areas, ISO-classified cleanrooms as needed
Traceability Intensity High - materials, components, process parameters; labeled storage and quarantine zones High - aircraft configuration, removed/replaced parts, maintenance work cards Extreme - component lot numbers, firmware versions, calibration histories; secure storage and access controls
Testing Spaces Functional test cells, NDT rooms, and inspection labs near production Engine run-up areas, hydraulic and landing gear test stands, and NDT booths EMI/EMC chambers, environmental stress screening (ESS) rooms, and precision metrology labs
Cleanroom Needs Zonal - composite layup and precision assembly areas Limited - component back shops only Extensive - microelectronics assembly and inspection
Turnover Expectations Validation-ready - calibrated utilities, equipment installation records, and configuration-controlled as-builts Operational - safe, functional infrastructure and clear maintenance-area demarcation Validation-ready - commissioning, calibration, ESD, and environmental records

In plain terms, the controls get tighter as you move from manufacturing to MRO to defense electronics.

Documentation, Traceability, and Quality Control During Construction

Once the environment is set, AS9100 moves the focus to proof. It sets a higher standard for construction records: the owner needs a turnover package that shows what was installed, where it went, when it was installed, who installed it, and which revision controlled the work.

Material Traceability and Configuration Control

Every critical installed item - an air handling unit, a section of process piping, a cleanroom panel, or an ESD floor tile - should have its own ID. That ID should stay with the item from submittal review to receiving inspection, installation, and as-built closeout.

That single ID should tie back to:

  • the purchase order
  • supplier data
  • lot or heat number
  • certificate of conformance
  • mill test report
  • installed location

At receiving, the team should log serial, lot, or heat numbers, collect supplier certifications, and connect those records to the item ID. Barcodes or QR codes can help when they make sense.

Every RFI, field change notice, and change order also needs to update the configuration baseline. If teams rely on unlogged redlines or casual field changes, traceability falls apart.

Calibrated Tools, Test Records, and Commissioning Evidence

Any instrument used to verify acceptance criteria should be calibrated, labeled, and traceable to NIST. That includes differential pressure gauges, flow hoods, particle counters, torque wrenches, temperature and humidity data loggers, and electrical testers.

Each instrument needs:

  • an asset ID
  • a calibration interval
  • an ISO/IEC 17025 certificate with as-found/as-left readings, standards used, and uncertainty

Commissioning records should be strong enough that an independent reviewer can rebuild the test story from the file alone: what was tested, how it was tested, which instrument was used, and which acceptance criteria applied.

A solid record set includes system and equipment IDs, the test procedure and applicable standards, the instrument asset ID and calibration certificate reference, as-found values, as-left values, pass/fail results, and any anomalies or nonconformances along with corrective action, retest results, and sign-off.

In defense electronics and cleanroom work, teams often line up these records with IQ/OQ/PQ methods so owners can roll commissioning evidence into product validation files.

AS9100 Clause-to-Deliverable Map

The map below turns AS9100 requirements into the records needed for a validation-ready turnover package.

AS9100 Concept What It Means on a Facility Project Construction Deliverables
Infrastructure Facility systems must support controlled production conditions As-built drawings, BIM model, utility single-line diagrams, cleanroom classification reports, capacity and redundancy analyses
Monitoring and Measuring Resources Test instruments must be suitable, controlled, and calibrated Calibration register, NIST-traceable calibration certificates, commissioning test plans and reports with instrument IDs
Identification and Traceability Critical materials and components must be uniquely identified and traceable to source Material traceability logs, weld maps, equipment tag lists, serial/lot/heat number logs, CoCs, mill certs, labeling drawings
Control of Documented Information Drawings, specs, RFIs, and change documents must be version-controlled and protected from unintended use Document control plan, revision logs, RFI and change logs, transmittal records, EDMS access and audit logs

Those records only matter if the project is sequenced and staffed in a way that lets the team produce them as the work happens.

Project Delivery and Hiring for AS9100-Ready Builds

With the record set defined, the next step is simple in theory and hard in practice: the job has to be sequenced so those records are created as the work happens.

Delivery Sequence: From Preconstruction to Validation-Ready Turnover

AS9100 turnover starts in preconstruction, not closeout.

That means traceability, calibration, cleanroom, and retention rules need to be written into the contract and the project quality plan from day one. It also means the team has to spell out who approves field work, system performance, and any dual-approval items. If that part is fuzzy, problems tend to snowball later.

Every purchase order should lock in the same traceability fields:

  • supplier approval status
  • part number
  • revision level
  • lot/batch/heat number
  • country of origin
  • certificate reference

Those same fields should carry through inspection, commissioning, and turnover records. And commissioning scripts should be written to the owner’s requirements, not pulled from a generic checklist that sort of fits but doesn’t quite land.

The table below shows how each delivery phase ties to its main activity and the role that owns it:

Phase Key Activity Accountability Lead
Preconstruction Owner quality requirements, document control workflows, dual-approval authority Owner's Rep / Commissioning Manager
Procurement Traceability fields, supplier approvals, long-lead equipment Project Manager / MEP Lead
Construction Clean build protocols, field inspections, continuous as-builts Superintendent / QA/QC Manager
Commissioning (IQ/OQ) Calibrated testing, scripted performance verification Commissioning Manager
Turnover Integrated systems testing, validated turnover package delivery Commissioning Manager / Document Control Lead

A validation-ready turnover package should pull together the records collected during design, procurement, construction, and commissioning into a searchable digital file, organized by system and space. Monthly mock turnover reviews help the team spot missing records early, when they’re still fixable without a fire drill.

Key Roles and Hiring Profiles for Aerospace Construction

That delivery sequence only works when the right people own each control point.

This is where AS9100 projects often go off track. Put the wrong person in one of these seats, and the paperwork may look fine for a while, right up until an audit or turnover review says otherwise.

  • Project managers must tie AS9100 requirements to contracts, schedule, and risk.
  • Superintendents must enforce approved-document-only work and log every field change. A superintendent must treat redlines as controlled changes, not informal notes.
  • MEP leads need direct experience with clean dry air, process gases, precision HVAC, and power quality.
  • Commissioning managers must produce test evidence that stands up to independent review and can be rolled into validation records.
  • QA/QC managers must understand AS9100 clauses, inspection planning, NCRs, and records control.
  • Document control leads need version control, access management, and audit-ready retention.
  • VDC/BIM leads must model cleanroom envelopes, utilities, and equipment for asset tagging and configuration control.
  • Owner's representatives must connect facility features to the owner's aerospace quality system.

Pay reflects how specialized these roles are. Senior project managers on aerospace builds typically earn between $165,000 and $245,000 in base salary. Commissioning managers usually fall between $135,000 and $190,000 in base, while MEP leads tend to range from $110,000 to $160,000.[14]

How iRecruit.co Supports Aerospace and Defense Construction Hiring

iRecruit.co

Specialized roles are tough to fill, so hiring strategy becomes part of project risk control.

The U.S. aerospace and defense workforce is short by roughly 40,000 skilled workers, and attrition across the industry sits at about 14.5% to 15% - more than double the average for other U.S. industries.[14][15][16][17][18] A 2025 AIAMcKinsey workforce study found that 76% of aerospace and defense companies report lasting difficulty hiring engineers, and 56% report shortages in skilled trades tied to production.[16][18] One vacant critical role can cost an estimated $20,640 per month.[14]

iRecruit.co focuses on construction staffing for complex, compliance-driven builds, including aerospace and defense, advanced manufacturing, and similar sectors. For owners, GCs, and EPC teams, iRecruit.co keeps pre-qualified pools of project managers, MEP leaders, commissioning professionals, schedulers, estimators, field superintendents, and QA/QC personnel with prior experience in high-compliance settings.

Screening centers on proven familiarity with AS9100 or equivalent standards, U.S. defense and export-control environments, and strict document-control and validation frameworks. Candidate profiles are matched to the facility type - manufacturing, MRO, or defense electronics - so the people presented already know the kind of site they’re stepping into. That kind of fit can cut ramp-up time and reduce audit risk tied to weak documentation.

Conclusion: What Aerospace Builds Require From Construction Teams

The earlier sections point to one clear idea: facility design, records, and staffing have to function as one AS9100 system. AS9100 touches design, execution, records, and turnover together. That broad reach is what sets aerospace builds apart from standard industrial work.

AS9100 calls for more discipline than standard industrial jobs. The biggest trouble spots are weak measurement traceability and uncontrolled configuration changes. When those slip, turnover turns into rework.

The answer is simple: put traceability, calibration, and turnover requirements into the contract before procurement starts. That’s why the turnover package needs to be built during the project, not thrown together at the end.

People are the part that makes the plan stick. So role fit becomes part of project risk control. At closeout:

  • QA/QC managers enforce inspection records and nonconformance resolution
  • Commissioning leads produce test evidence that can stand up to independent review
  • Superintendents treat redlines as controlled changes, not casual notes

Those three roles turn AS9100 requirements into field discipline and audit-ready records.

Teams that treat the facility as part of the aerospace quality system deliver compliant, operations-ready space.

FAQs

Does AS9100 certify the building itself?

No. AS9100 applies to organizations, not to the building itself.

At turnover, the facility and installed systems are checked through documented evidence like commissioning and test records, calibration and qualification documentation (IQ/OQ/PQ, where applicable), traceability, and a validation-ready turnover package.

What records should be included in the turnover package?

A complete turnover package is the formal record showing that systems were built, installed, and checked against requirements.

It should include:

  • as-built drawings, O&M manuals, and equipment data sheets
  • calibration records, weld logs, material certificates, and passivation records
  • commissioning reports, integrated testing results, IQ/OQ/PQ documentation, training records, warranties, attic stock lists, and final change reconciliation

Which project roles matter most for AS9100-ready builds?

The most important roles are commissioning leadership and the coordinators who manage turnover and evidence trails.

  • Commissioning manager/engineer: leads startup, functional testing, and sign-off
  • Scheduler, controls, and MEP leads: keep integration, test timing, and traceability on the critical path
  • QA/QC and closeout roles: protect the final validation-ready turnover package
