If I wanted to break into this job in 2026, I’d focus on three things first: learn the L1-L5 commissioning flow, build field time on power and cooling systems, and show clean test documentation on my resume.
This role is not just “engineering” and not just data center construction. It sits in the middle. I’d be expected to help test UPS systems, generators, switchgear, chillers, and BAS/BMS controls, then document every result before a data center goes live. In many cases, the work runs through five main test stages, from factory testing to integrated systems testing before handover.
Here’s the short version of the path:
A simple way to think about it: if I can explain how a data center gets tested from design review to IST sign-off, and back that up with field work, I’m on the right track.
Quick comparison of the path:
Bottom line: if I were starting today, I’d get onto an active data center or mission-critical project as fast as possible, take ownership of testing work, and describe that work in plain commissioning terms.

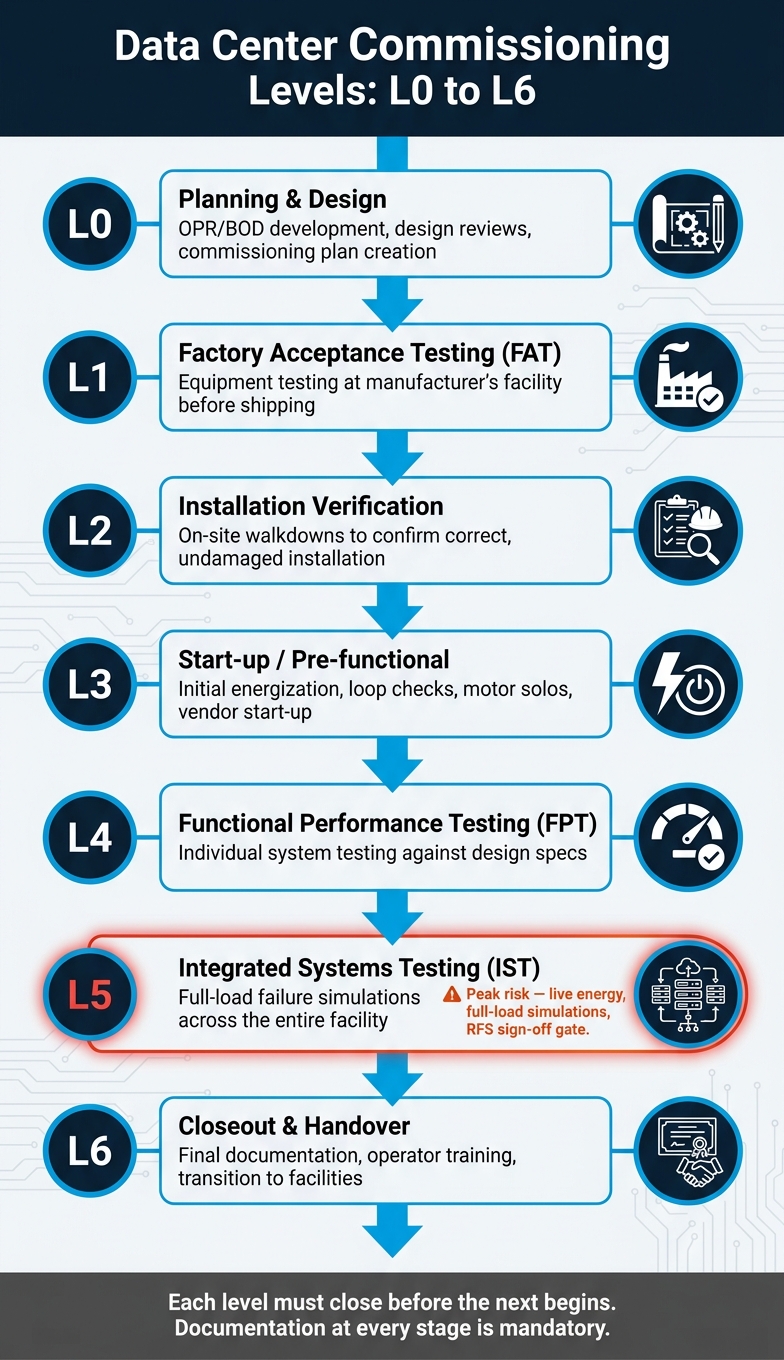

Data Center Commissioning Levels: L0 to L6 Explained
Commissioning follows a gated sequence. If you know that sequence, you know where you fit, which documents you own, and what kind of experience to build next. For people coming from construction, MEP, or controls, the big shift is simple: learn the commissioning flow, sign-off process, and documentation standards.
A commissioning engineer usually splits the day between the office and the field, and sometimes flips between both in the same hour. In the office, the work often starts with reviews of one-line diagrams, P&IDs, and sequences of operation. The goal is to catch design problems before they turn into field issues. You’re also writing pre-functional and functional test scripts, getting readiness checklists ready, and keeping issue logs current.
On site, the job gets more hands-on. You may be watching equipment start-up, leading readiness meetings with MEP contractors and vendors, and running functional tests. If something fails, you log the deficiency, assign the fix, and run the test again. Every test result, meter reading, photo, and sign-off needs to go into the commissioning record. That record supports final turnover.
Hiring managers look at these tasks to figure out whether you can handle both sides of the role: test execution and documentation. And those tasks make a lot more sense once you understand the gated sequence behind them.
Most mission-critical projects use a Level 0 to Level 6 sequence, though the names can change by owner. Each level has to close before the next one starts. Each one also produces the proof needed to pass the next gate.
This is the sequence employers expect you to understand before you touch live project work. If you can talk through it clearly, you’ll sound a lot more solid in interviews when test plans, turnover, and sign-off come up.
Level 0 is where design conflicts get caught on paper before field work begins. That can save a lot of pain later. On hyperscale projects, commissioning often drives the schedule instead of following it. Then there’s Level 5, where the pressure is highest. The facility is under full load, every system is live, and the team is simulating worst-case failure scenarios to prove that redundancy works before Ready-for-Service (RFS) is signed off.
The systems under test cover both the power and cooling sides of the facility. On the electrical side, that includes high- and medium-voltage switchgear, UPS systems, backup generators, and PDUs. On the mechanical side, it includes chillers, CRAH and CRAC units, and building automation system (BAS) / building management system (BMS) controls. You need to know these systems well enough to speak the language used in startup, testing, and turnover meetings.
Good commissioning records go far beyond simple pass/fail boxes. They include meter data, trend logs pulled from the BAS/BMS, screenshots of control interfaces at the exact time of the test, installation photos, and asset-tag traceability linked to the OPR, BOD, ASHRAE guidance, and contract documents. Every entry needs sign-off from the party responsible. The table below shows how the scope and documentation shift between component testing and IST.
Once you understand the commissioning sequence, the next move is to line up your background with the education, skills, and field experience employers want.
Now it’s time to look at your own background and figure out two things: does it line up with the role, and what do you still need to learn before you apply? The shortest path depends a lot on where you’re starting from today.
In the U.S., employers most often hire people with degrees in Electrical Engineering (EE), Mechanical Engineering (ME), or Construction Management. People from controls and automation can also move into the role. And if you’ve spent years doing hands-on work in MEP, controls, or facilities, you may be able to move in through a technician-to-engineer path instead.
A four-year degree is common, but it isn’t mandatory. What employers care about most is mission-critical competence. That matters even more when it’s backed by credentials like NETA Level 3 or NICET Level III. [1]
Because full L1-L5 experience is rare, employers put a lot of weight on proven field discipline and clean, accurate documentation, not just formal education.
If your degree isn’t in EE or ME, your past job title often becomes the biggest signal. A lot of roles transfer well into commissioning. The trick is to be honest about what you already know and where the holes are.
Controls and BAS/BMS specialists usually already understand protocols, logic, and how systems pass signals and execute control sequences. But they often need more time with physical equipment testing and the formal structure of the commissioning process.
Electrical test technicians tend to be strong at the component level and know NETA standards well. Their usual gaps are mechanical and cooling knowledge, along with whole-system integration work.
MEP coordinators often know how systems fit together across a project. What they may not have done is run functional test scripts or hold field testing authority themselves.
Facilities engineers know how equipment behaves during day-to-day operation. But many haven’t worked through construction-phase commissioning or the full L1-L5 sequence.
Construction PMs bring schedule control and vendor coordination. Their bigger gaps are mission-critical redundancy concepts and deeper MEP and controls integration.
Once you know your starting point, the next step is filling the gaps employers check for first. There’s a basic technical floor most hiring teams expect before they’ll put you on a live data center job. Think of this as a minimum screen:
Technical know-how matters. But on a live project, employers want proof that you can use that knowledge in the tools, records, and tests the job runs on every day.
CxAlloy is a common commissioning platform for issue tracking, test script management, and evidence storage. On data center projects, hiring managers expect you to log deficiencies and manage checklist status without hand-holding. If you say you’ve worked in commissioning, they’ll often assume you can step into CxAlloy and get moving.
You should also know Niagara, Desigo, or EcoStruxure well enough to pull trend logs, verify sequences, and troubleshoot sensors on your own. For senior roles, employers also look for working knowledge of ETAP or SKM PowerTools for electrical modeling and relay coordination studies.
Just as important: you need to be comfortable handling the documents that keep the project on track. That includes OPR, BOD, pre-functional checklists, functional test scripts, IST scripts, turnover packages, O&M manuals, and lessons-learned logs.
Why does this matter? Because these are the records and test materials hiring managers use to judge whether someone can do the work without slowing the team down.
The right certifications tell employers you meet the bar for a live data center project. They don’t get you hired by themselves, but they do help you clear the first screen.
At the entry level, employers usually want OSHA 30 and NICET I/II. At the mid level, they look for BCxP or CBCP plus CDCPM. At the senior level, the usual mix is BCxP plus CDCPM and NETA 3/4 or a PE. For manager-level roles, a PE license, Uptime Institute ATD/ATS, or DCEP points to portfolio-level oversight capability. [1]
Credentials get attention. Owning project work is what closes the deal.
On a mission-critical resume, your project history is the part hiring managers study hardest. They care most about whether you’ve already worked through the L1–L5 sequence and know what each stage looks like in the field.
The experience that carries the most weight includes:
At the senior level, one of the strongest proof points you can put on a resume is having personally led an L5 Integrated Systems Test on a previous hyperscale project. [1]
"The energization date moves only when L5 signs off, and L5 only signs off when L1 through L4 have been documented to spec." - iRecruit [1]
A strong project list does more than name the site. Show the systems, the test level, and the documents you owned. That’s the kind of detail hiring managers trust.
If you already know what the role involves and which skills it takes, the next move is simple: turn your current background into a clear hiring path. The fastest route depends on where you're starting, but the aim stays the same. Get onto mission-critical projects and build commissioning experience as fast as you can.
Once your route is clear, the next step is proving it on paper. That means a resume and project list that show clear scope, direct ownership, and hands-on testing work.
After you pick the path, you need proof. In commissioning, hiring managers want to see system scale, test depth, and what you personally owned.
Your project list does most of the heavy lifting. For each data center project, include the IT load in MW, generator count and size, UPS setup and topology, and cooling plant capacity in tons. Then spell out which commissioning levels you handled - L2 installation verification, L3 start-up, L4 functional performance testing, and L5 integrated systems testing. Be specific about your part in the work. "Wrote and executed functional test procedures for generator auto-start, load transfer, and retransfer on a 24 MW hyperscale project" tells a hiring manager a lot in one line. [2]
The strongest resumes tie scope, ownership, and results together. A tight project block should show the size of the issue log, the platform used, and how you helped drive defects to closure. It should also name the BAS/BMS platforms and your hands-on work inside them, like pulling trend logs, checking sequences, or building alarm matrices. Then add measurable results, such as "closed 95% of commissioning issues before substantial completion" or "raised IST pass rate from 70% to 95%." [2]
Once you have the right experience and a resume that shows it well, the next move is positioning yourself for mission-critical openings. Get onto an active data center project, take ownership of commissioning work at every level you can reach, and describe that work in commissioning terms: system scale, test levels, issue closure, and document ownership.
Hiring teams are actively recruiting people from nearby fields, and commissioning specialists are often tied up on projects 12–18 months in advance. [3] That creates an opening for people who can show clear, project-based proof. Focus on active builds, go after the credentials that fit your stage, and talk to mission-critical recruiters with the level of detail this role expects.
No. There isn't one set path into data center commissioning.
A degree can help. But plenty of people come in from mechanical, electrical, controls, or MEP facilities roles instead.
In many cases, employers care more about strong hands-on work with mission-critical equipment - like generators, switchgear, or chilled water plants - than about a four-year degree. And if you don't have a degree, you may still qualify for certifications if you have deep, verifiable field experience.
For data center commissioning roles, the field experience that carries the most weight is the kind that shows you can take a project from startup all the way through turnover. Hiring managers want proof that you’ve directly led or carried out the L1–L5 commissioning sequence. General commercial work or routine maintenance usually isn’t enough on its own.
Put the spotlight on experience such as:
Tie your hands-on experience directly to the L1–L5 commissioning lifecycle. On your resume, spell out the work you’ve done during startup, functional testing, and turnover. Also call out your ability to read one-lines, schematics, and control diagrams, and to write and run test scripts.
It also helps to list base credentials like BCxP or CBCP, then put mission-critical or similar experience near the top. Many employers want people who can handle turnover documentation and issue logs without hand-holding. They also look for working knowledge of tools and standards like CxAlloy and ASHRAE Guideline 1.6.
