August 28, 2026

Brownfield Automation Retrofit: How Long a Line Conversion Really Takes

By:
Dallas Bond

A brownfield line conversion usually takes 6 to 24 weeks+ end to end, but the line is often down for only 1 to 21 days. That’s the main point I’d want any plant team to get first.

If I were planning one, I’d separate the schedule into two clocks:

  • Total project time: about 6–8 weeks for a single-machine upgrade, 10–14 weeks for a cell retrofit, and 16–24 weeks for a full line conversion
  • Actual downtime: about 1–3 days, 3–7 days, or 7–21 days for those same scopes
  • Ramp-up after restart: often 2–8 weeks or more before output is stable
  • Validation and approvals: can add 2–6 weeks
  • Long-lead parts: often drive the date more than the shutdown itself

Here’s the short version: I’d work backward from the restart date, freeze scope early, order parts fast, finish as much design and testing off-line as possible, and protect commissioning time. In many jobs, the schedule slips not because installation took too long, but because of late hardware, missing drawings, added scope, weak staffing, or restart issues after SAT.

This article breaks that down into the parts that shape the timeline most: scope, assessment, shutdown planning, procurement, off-line controls work, cutover, commissioning, and ramp-up.

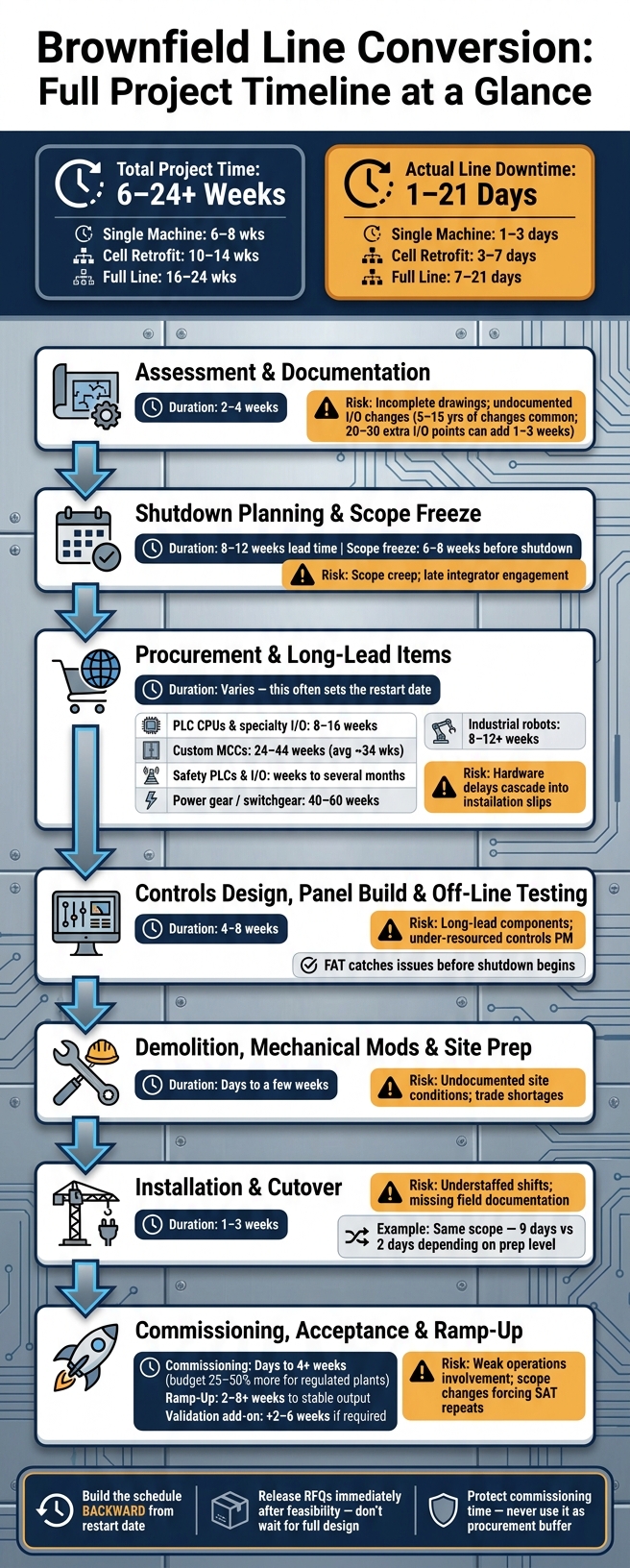

Brownfield Automation Retrofit Timeline: Phases, Durations & Schedule Risks

Brownfield Automation Retrofit Timeline: Phases, Durations & Schedule Risks

How Automation Transforms Existing Warehouses | DC Velocity Webcast

Build the Schedule Backward From the Restart Date

Start a brownfield retrofit with the committed restart date. Put that date on the calendar first. Then work backward through mobilization, procurement, engineering, and assessment.

That approach keeps design and purchasing moving before shutdown starts. The restart date becomes the anchor for every task that comes before it.

Assessment, Documentation, and Feasibility: 2 to 4 Weeks

The first job is a field-verified assessment, because every later deadline depends on what the line actually looks like. This phase includes field surveys, controls document checks, utility verification, and code reviews.

The target is simple:

  • a verified I/O list
  • confirmed mechanical constraints
  • an accurate picture of the line as it exists today

Brownfield panels and field wiring often come with 5–15 years of undocumented changes. Sensors get moved. Safety circuits get bypassed for a short-term fix and never put back. Spare I/O channels get used with no record left behind.

That creates trouble fast. If the team finds 20–30 extra I/O points after panel design is finished, it can force a redesign and add 1–3 weeks to the schedule before any hardware even ships. [6] A 2–4 week walkdown that checks I/O against physical devices and operator input helps avoid that kind of late surprise.

Shutdown Planning and Scope Freeze: 8 to 12 Weeks of Lead Time

After the assessment, set aside 8–12 weeks before shutdown to line up production, maintenance, utilities, and contractors. Scope should freeze 6–8 weeks before shutdown. Any change after that needs formal approval and a clear schedule impact.

This is where operations and sales look for lower-demand windows or work out temporary delivery changes. Planned maintenance gets bundled with retrofit work so the site gets more out of the downtime. Electrical tie-ins and utility changes also need coordination with site-wide safety rules.

By the time scope freezes, engineering, operations, maintenance, and safety should all sign off on equipment lists, I/O counts, panel layouts, functional specs, and acceptance criteria. If that signoff doesn't happen, small add-ons have a way of sneaking in. Then demolition or commissioning runs long, and the restart date starts to slide.

Procurement and Long-Lead Items Often Set the Date

In many cases, the restart date isn't driven by the shutdown window. It's driven by when critical hardware will arrive on site.

PLC CPUs and specialty I/O modules can take 8–16 weeks from order to delivery, depending on platform and supply conditions. [3] Custom motor control centers average about 34 weeks, and they can stretch to 44 weeks when VFDs are built in. [4] Robots and custom mechanical tooling often ship in 8–12 weeks or more. Power gear and switchgear can take 40–60 weeks under 2023 conditions. [5] In periods of high demand, safety PLCs and safety-rated I/O have also stretched into multi-month lead times. [3]

Here's the practical issue: if the main PLC or primary drive doesn't show up until a certain week, panel build and off-line testing can't finish before then. If testing can't finish, installation can't start on time. And if installation slips, the restart date slips with it.

A realistic U.S. schedule uses actual supplier quote lead times, adds 1–3 weeks for freight buffer, and does not put shutdown on the calendar before critical hardware is on site. Releasing RFQs right after the feasibility phase, even before full design is done, gives the team an early read on whether the restart date will hold.

Long-Lead Item Typical U.S. Lead Time
PLC CPUs and specialty I/O 8–16 weeks
Custom motor control centers 24–44 weeks (avg. ~34 weeks)
Industrial robots 8–12+ weeks
Safety PLCs and safety-rated I/O Weeks to several months
Power gear / switchgear 40–60 weeks (2023 conditions)

Once materials are on site, the schedule shifts into demolition, controls build, and installation.

How Long Each Execution Phase Takes

Once long-lead hardware is on site, the job moves out of planning mode and into field work. At that point, each phase tends to follow a pretty clear time range. The catch is that calendar time and production downtime are not the same thing. That gap is where a lot of schedule risk shows up.

Demolition, Mechanical Modifications, and Site Prep: Days to a Few Weeks

Demolition and site prep usually take a few days to a few weeks.[12] Small tasks, like swapping outdated sensors, clearing a short conveyor section, or removing a small panel, can often fit inside a short shutdown window. Bigger changes take longer. If the team needs to reroute utilities, move structural supports, or change conveyor geometry, this same phase can stretch to two or three weeks.

This is also the point where job-site surprises can throw the schedule off. Maybe floor anchors clash with the new layout. Maybe cable trays run right through the space needed for new equipment. Maybe shared utilities weren’t flagged during the assessment. Add rigging limits or a shortage of specialty trades, and the timeline can slip fast. Pre-shutdown surveys and 3D layout checks help catch those issues before crews are standing on the floor waiting.[10][12]

A common way to cut downtime is to split mechanical work into short shutdown windows tied to planned maintenance.[8][1]

Controls Design, Panel Build, and Off-Line Testing: 4 to 8 Weeks

Controls architecture, PLC and HMI programming, cabinet fabrication, and network planning can all happen off-line. That’s why this phase usually runs 4 to 8 weeks.[11]

The timeline gets longer when the retrofit brings in safety systems, motion control, recipes, or legacy integration. This is where a strong FAT can save days later. Validating I/O mapping, fault recovery paths, and sequence logic under simulated conditions is one of the best schedule moves a team can make.[11][13] Every issue found during FAT is one less problem eating up shutdown time on the plant floor.[13]

Installation and Cutover: 1 to 3 Weeks for Most Retrofits

Field installation includes mounting, cable pulls, terminations, device swaps, utility connections, software loading, loop checks, subsystem integration, energization, and site acceptance testing (SAT). For most retrofits, this phase lands in the 1 to 3 week range.[9][1][14][2]

The actual duration depends a lot on two things:

  • How much pre-work was finished off-line
  • Which cutover method the team picked

One useful example comes from an eFlex assembly line changeover. In that case, one method needed 9 days of shutdown, while a more optimized approach finished the full changeover in 2 days over a weekend. Same scope. Different level of prep.[1]

Single-window cutovers shorten calendar time. Phased and parallel approaches cut downtime, but they also add labor and coordination. The best fit depends on the finished-goods buffer, whether the line can handle staged outages, and how much extra coordination the plant will pay for to lower downtime risk.

After cutover, commissioning and ramp-up become the next schedule-critical phase. At that stage, staffing can make or break the restart date.

Commissioning, Ramp-Up, and the Main Sources of Delay

Commissioning and ramp-up are the final pieces of the conversion timeline. And in many cases, they decide whether the restart date is just a date on paper or an actual return to production. Mechanical completion does not mean the line is ready to restart.

Commissioning and Acceptance: Days to Several Weeks

After installation and cutover wrap up, the focus shifts from building the line to proving it can run safely and do the same job again and again. That usually means working through checks, loop verification, dry runs, safety validation, and SAT.

For a typical line, loop checks alone often take 2 to 5 days. Safety validation can add another 3 to 10 days. Put together, commissioning for a typical retrofit usually lands in the 1 to 3 week range, with complex or regulated lines stretching to 4 weeks or more.[19] In regulated plants, it makes sense to budget 25% to 50% more time for commissioning because validation and approval add extra steps.[17][18]

Ramp-Up to Stable Output: 2 to 8 Weeks or More

Passing SAT is a big milestone, but it isn't the finish line. The next test is getting the line to produce at speed, with the output and quality the plant expects.

After acceptance, ramp-up usually takes 2 to 8 weeks or more to reach stable output at target throughput and quality.[7] This is often where small startup issues start piling up. Early alarm cleanup and spare-parts checks help avoid delays that can drag out those first production weeks.

What Speeds Up or Slows Down Delivery

One of the biggest hidden schedule drivers is documentation quality. Good P&IDs, electrical schematics, and I/O lists make commissioning much smoother. When those records are missing, old, or incomplete, teams can lose days or even weeks tracing wires and reverse-engineering control logic.[16][15]

Scope changes during commissioning can also cause trouble fast. Even a small change can force part of SAT to be repeated, which pushes the acceptance date back. MES and SCADA integration add more risk too. Protocol mismatches and data mapping problems often don't show up until the line is live.

Staffing matters just as much as the paperwork and systems. Plants that have experienced controls engineers and maintenance technicians on-site during the first weeks of ramp-up usually get to stable output faster than plants leaning on occasional vendor support.

Build buffer into the schedule. But that buffer only helps if the startup team is there when needed, which is why staffing often decides whether the restart date holds.

Staff the Retrofit to Hit the Restart Date

Staffing affects the schedule. It’s not just a hiring task. In many retrofits, the team you lock in before scope freeze has a direct effect on whether the restart date sticks.

Core Roles Needed From Assessment Through Startup

Name the core team before shutdown starts.

You need a construction PM, controls lead, commissioning lead, safety specialist, and owner-side operations and maintenance reps in place early. Each one protects a different part of the schedule.

The construction PM owns the master schedule, lines up trades, and handles site access and permits. The controls lead owns design milestones, panel build timing, software work, and FAT/SAT windows. When those leadership roles are missing or weak, the damage usually shows up later as rework, live-line debugging, and a commissioning window that gets squeezed hard.

The commissioning lead should also be named early, with clear authority over acceptance criteria. That matters more than people think. If no one owns acceptance from the start, teams can burn time arguing about what “done” means when the line should already be moving.

Electricians and mechanical trades need shift coverage for the full shutdown window. A safety specialist is just as important. They keep LOTO, hot work, and temporary guarding from turning into stop-work events when the site is under turnover pressure.

Owner-side operations and maintenance reps need to be involved from the assessment stage onward. Their input on plant constraints, changeover times, and acceptance criteria helps stop redesigns that otherwise don’t surface until ramp-up.

Once the core team is in place, add specialist support where retrofit risk is highest.

When to Bring in Specialized Retrofit Talent

Bring brownfield controls engineers, commissioning specialists, and validation staff in before scope freeze.

Brownfield controls engineers know how to deal with legacy panels, obsolete PLCs, mixed-vintage hardware, and undocumented changes. If they come in late, they often find bad assumptions that force redesigns and add days to commissioning.

Commissioning specialists help shape test plans and acceptance criteria up front. If they’re pulled in too late, commissioning tends to drag because I/O checks and safety validation weren’t planned well enough.

In pharma, validation engineers and CSV specialists need to line retrofit design up with IQ/OQ/PQ needs before scope freeze. If that step slips, teams can get hit with extra testing, added documentation, and hardware changes that delay restart.

Across sectors, early specialist support trades a modest pre-shutdown cost for a major drop in surprise-driven delays during the most expensive phase: actual downtime. [20][21][22]

Conclusion: How to Forecast a Line Conversion Accurately

Accurate forecasting comes down to a few simple habits. Define scope before estimating duration. Build the schedule backward from the restart date. Treat total calendar time and actual downtime as two separate numbers.

Push as much work off-line as possible, including panel builds, PLC simulation, and FAT. That way, the shutdown window is driven more by installation and cutover than by design churn and debugging. Protect commissioning and ramp-up time instead of using them as the first buffer when procurement slips. Staff the job with retrofit leaders who know how to work inside constrained, live facilities, and keep the schedule under active control from assessment through ramp-up.

Use the summary below to connect each phase to its main schedule risk.

Phase Typical Duration Main Schedule Risk
Assessment & Documentation 2–4 weeks Incomplete drawings; weak owner-side representation
Shutdown Planning & Scope Freeze 8–12 weeks of lead time Scope creep; late controls or integrator engagement
Controls Design & Panel Build 4–8 weeks Long-lead components; under-resourced controls PM
Demolition & Mechanical Modifications Days to a few weeks Undocumented site conditions; insufficient trades coverage
Installation & Cutover 1–3 weeks Understaffed shifts; missing field documentation
Commissioning & Acceptance Days to several weeks Late commissioning lead; scope changes forcing SAT repeats
Ramp-Up to Stable Output 2–8 weeks or more Weak operations involvement; unresolved usability or tuning issues

These ranges are a practical planning baseline for a mid-sized brownfield line conversion. [20][21][22]

FAQs

What can I do to shorten line downtime?

Prioritize early planning and close coordination between construction and operations. Pull in construction experts, commissioning managers, and specialized MEP leads during design, and use BIM to spot utility clashes before work starts in the field so you can avoid rework.

It also helps to use takt-based scheduling and daily big-room coordination. Lock in long-lead equipment 18 to 36 months in advance, look at modularization or prefabrication where it makes sense, and use interim power or cooling so lines can start up sooner.

Which retrofit phase causes the most delays?

Controls integration and commissioning often create the biggest delays. In fact, mismatches between equipment vendor protocols and automation systems account for 38% of integration delays.

The problem usually starts well before startup. Poor planning, late discovery of design complexity, limited skilled labor, long-lead equipment, and talent gaps in mission-critical roles can all make things worse. The result? Costly field fixes and a chain reaction of startup delays.

When should I lock scope and order parts?

Lock scope and order long-lead equipment as early as the conceptual design or site screening phase, before detailed designs are finished. Waiting for complete drawings is one of the most common reasons projects slip behind schedule.

For critical items like switchgear, transformers, and chillers, identify them and start procurement right away to secure manufacturing slots. Then, as work starts in each area, enforce a design freeze so scope creep doesn’t chip away at the timeline.
