A defense plant is not ready when the building is done. It is ready when it can make parts safely, meet spec, pass checks, and hold output over time.
From what I see in this piece, the main timeline is simple: sitework and utilities first, secure fit-out and tool install next, then commissioning, qualification, pilot runs, owner handoff, and ramp to rate production. For many U.S. projects, that means about 12–24 months to get the facility up and running, then another 6–12 months to reach steady output. More complex sites can take 24–48 months or longer.
Before I read any plant schedule, I’d look at these six items first:
A few numbers stand out right away:
If I had to sum up the article in one line, it would be this: the shortest path to output comes from lining up construction, utilities, equipment, staffing, validation, and handoff from day one.
That’s the core story of the article, and it sets up the full timeline that follows.

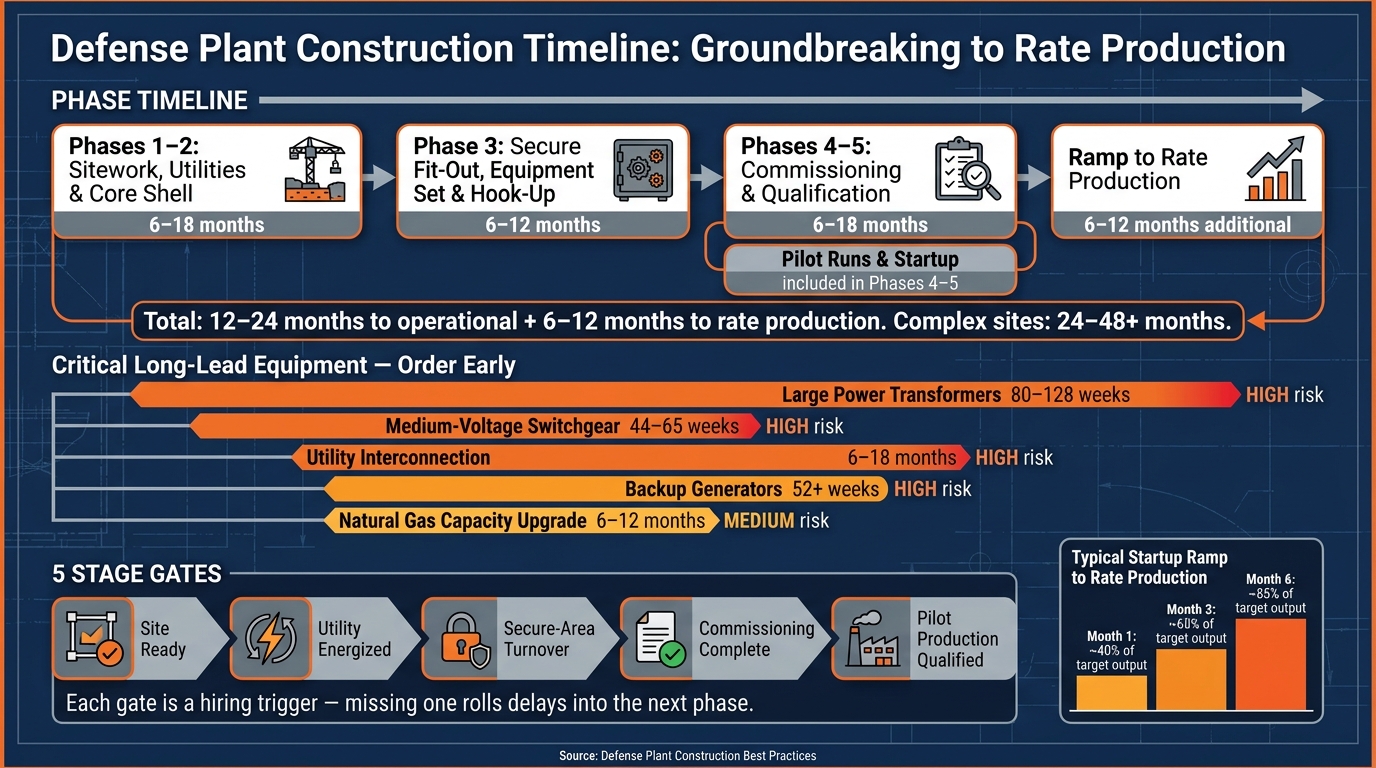

Defense Plant Construction Timeline: Groundbreaking to Rate Production
If production readiness is the target, the schedule has to start with the physical work that makes startup possible. Phases 1–2 set up the site, utilities, and core shell needed for commissioning and startup. On fast-track jobs, this work usually runs 9–18 months, from site prep through dry-in and early MEP rough-in. [1][3][4]
Civil work needs to be sequenced so vertical construction can start fast, without creating rework later.
Stormwater and erosion controls come first, before major grading, because permits usually require them ahead of mass grading. [6] From there, mass grading creates rough pads across the site. Fine grading follows on the main building pad and other high-priority pads, such as the substation and cooling tower areas. If the geotechnical report calls for it, this is also where soil improvement happens - lime treatment, over-excavation, or stone columns.
Once grading is stable, below-grade utilities and foundations can move at the same time. That usually includes underground power duct banks, water and fire lines, sewer, gas, storm systems, and telecom conduits. All of that needs to be in place before major slab pours begin. Structural steel can then start as soon as foundation zones and utility corridors are cleared, often moving across the building in grid-line tiers.
Two early choices can make or break the schedule.
The first is geotechnical conditions. Soft clays, organics, and weak bearing soils are some of the biggest drivers of schedule slips and cost growth on building projects. Defense plants with heavy machining bays or test cells often need deep foundations such as auger-cast piles, driven H-piles, or drilled shafts because process equipment creates high point loads. Industrial manufacturing slabs are often designed for 500–1,000 psf live loads, while a typical office building may be closer to 50–100 psf. [2] That's not a small gap. It means early soil data matters, and guesswork can get expensive fast.
The second is permitting. Depending on the jurisdiction, building and site permits alone can add 6–18 weeks before any field work starts. In Austin, Texas, site permits have taken 12–18 weeks. [5] That puts permitting squarely on the critical path, not in some side lane.
For defense programs, one practical move is to release early civil and structural steel packages before the full design is finished. Progressive design-build or CM-at-risk setups can help line up buying activity with a fast-track schedule. Structural steel, precast concrete, and blast-resistant specialty materials - hardened doors, blast panels, and high-security glazing - often have long lead times, and Phase 1 doesn't leave much room for delay.
Once pads and foundations are underway, the next big gate is utility energization.
Without live utilities, commissioning and startup grind to a halt. A building can look close to finished from the outside - roof on, walls up, maybe even some interior finishes in place - and still be nowhere near ready if permanent power isn't available.
Without energized utilities, HVAC can't be started, balanced, or commissioned. Controls and building automation can't be tested. Process equipment can't finish site acceptance testing. Life safety systems - fire alarms, smoke control, and emergency power - can't be formally commissioned, which means the Authority Having Jurisdiction (AHJ) can't issue a Certificate of Occupancy. Operator training on actual equipment stops too. Each of those items sits in front of commissioning, qualification, and early production.
This is why early action isn't optional. Lead times are long:
Each utility should be managed as its own workstream, with one owner, dated milestones, and direct links to the master schedule. Coordination with the local utility on grid power should start during site selection. Interconnection applications, load confirmations, substation design, and transformer procurement all need to be moving in Phase 1, not pushed off until the building starts to look finished.
Those dates only hold if the field team is in place early enough to manage them.
Phases 1–2 need strong field leadership from the start. These roles should be staffed before groundbreaking:
Scheduling, QA/QC, and safety shouldn't be folded into the Project Manager role. Each one needs a clear owner. That's what protects the handoff to turnover and startup.
The MEP Lead and QA/QC Manager matter most early. MEP coordination - clash detection, routing priorities, and rough-in sequencing - handled during preconstruction helps avoid expensive rework once steel and envelope work are underway. QA/QC oversight on foundations, underground utilities, and concrete pours catches issues while they're still fixable, not after slabs are down and steel is standing. Early staffing gives the project a much better shot at staying on schedule and ready for startup.
Once the shell is dry and utilities are live, the schedule shifts toward secure production areas, specialty fit-out, and equipment installation.
Once power and base systems are live, the work shifts to the spaces and tools that decide whether the plant is ready to produce. Phase 3 is where the shell starts becoming a defense production space. It’s also where trades, security, and compliance all collide, and where schedule risk can spike fast. If this phase slips, commissioning and first output slip with it.
Fit-out isn’t cosmetic work. It creates verified production spaces before equipment shows up.
For cleanrooms and precision assembly areas, the main standard is usually ISO 14644, and many defense assembly operations aim for ISO Class 7 or 8. Getting there takes tight air balancing across supply, return, and exhaust flows, plus pressure cascade design between zones and particle count testing under both static and dynamic conditions. Temperature is often kept between 68–72°F, with humidity in the 40–60% range. HVAC balancing and pressurization tests should happen before ceiling closure whenever possible, because making changes after finishes are in place is slow and expensive.
Secure areas such as SCIFs must meet ICD 705, DoD security rules, and project-specific classified-handling requirements. Hardened walls, controlled penetrations, access control, intrusion detection, CCTV, and formal accreditation all sit on the critical path. It helps to treat each secure area as its own work package, with a fixed design freeze date, a defined submittal sequence, and scheduled sign-off milestones. Late security change orders at this stage are some of the most disruptive and costly issues a defense project can run into.
Process utilities also need to reach every tool hookup point and pass pressure, leak, flow, grounding, and quality checks at that exact location. A simple red-tag/green-tag system for every drop before equipment moves in can save a lot of confusion.
This phase needs clear ownership. Assign a controls lead, a security lead, and a commissioning manager to own these gates. Coordination between controls, security, QA/QC, and commissioning leads has to stay tight.
Equipment installation covers more than setting a tool in place. It runs from rigging and placement to alignment, hookup, controls integration, safety checks, and pre-start verification. If site readiness is missing even one piece - power, concrete cure time, or utility testing - the next step stalls.
Use one shared startup plan for vendors, facility trades, controls, and owner operations. Tie each tool or line to:
That tradeoff stands out even more when you compare fit-out by delivery model.
A lot of defense owners end up using a hybrid model. Modular utility racks and pre-assembled process skids work well for repeatable production bays. Stick-built construction is then kept for SCIFs and other secure spaces, where in-place inspections and accreditation rules make offsite assembly hard to use.
Once fit-out is complete, the schedule moves to commissioning, qualification, and startup.
Mechanical completion is not the finish line. It’s the point where turnover, validation, startup, and the push to rate production begin. From here, schedule confidence comes down to three things: solid validation, trained people, and clean turnover packages.
Commissioning starts with pre-functional checks, then moves into single-system testing and subsystem integration. Pre-functional checks confirm installation quality, labeling, safety devices, and lockout/tagout points before anything is energized.
Single-system testing covers systems like:
Each one needs its own test scripts and acceptance criteria before integration starts. Control logic, interlocks, and alarms also need to be tested under normal and worst-case conditions. If this part gets rushed, startup rework tends to show up fast.
Qualification comes next through IQ, OQ, and PQ:
For controlled environments, qualification also includes extended environmental monitoring under occupied conditions. That means checking temperature, humidity, pressure differentials, air change rates, and particulate levels during actual production activity, not just when the space is at rest.
Each gate needs test reports, as-builts, and AHJ acceptance of life-safety systems before operational readiness sign-off.
The milestone path usually looks like this:
Hiring needs to line up with commissioning milestones. Bring people in too early, and labor cost climbs before they can do much. Bring them in too late, and startup slows down. Validation work and hiring have to move together because startup staffing is part of the schedule, not something you tack on later.
The first cohort should come in 6–9 months before mechanical completion. That group usually includes the commissioning manager, validation lead, controls engineers, and maintenance planners. Their job is to build test scripts, SOP drafts, CMMS setup, and the logic behind IQ/OQ/PQ.
This timing matters even more for hard-to-fill commissioning, MEP, controls, and construction leadership roles. If defense-specific experience is needed and the local labor pool is thin, an early search protects the schedule.
Operators, technicians, and quality inspectors should come in 8–12 weeks before pilot runs. That window gives enough time for safety training, SOP training, and hands-on dry runs. EHS and security should already be involved by then for risk assessments, permit-to-work controls, and secure-area procedures.
As output climbs, staffing should climb with it. Add operators and shift supervisors at 50%, 75%, and 100% of nameplate output.
Once the line is staffed, the next question is simple: how fast does actual output move toward design capacity?
Nameplate capacity is the designed maximum. Demonstrated rate production is the sustained output the line proves over time, often across a 90-day window. That gap between the two is normal. The job is to close it as fast as the operation can support.
Track throughput per shift, OEE, first-pass yield, downtime root causes, and staffing variance. Those measures help show whether the next fix should be maintenance, automation tuning, cross-training, or process changes.
The phases above roll up into five gates that set the pace to output. Put simply: these gates decide how fast the plant moves from groundbreaking to rate production.
The table below lays out the main schedule drivers in each phase. Durations are typical ranges for complex greenfield manufacturing projects, and some phases can overlap [17][18][19][20].
Five gates drive speed to output:
Each gate is also a hiring trigger. Miss one hiring window, and the delay doesn’t stay put; it rolls downhill into the next phase. That’s why clearance-driven recruiting needs to start 6–12 months early. Clearance timelines rarely match the project schedule [7][8][9][10].
Once qualification passes, the focus changes. The job is no longer project execution. It becomes operations control.
Turnover is a readiness gate, not a stack of paperwork. It plays a big part in how fast the plant settles down after go-live.
A full turnover package should include as-built drawings, equipment data sheets and OEM manuals, commissioning and functional test reports, validated setpoints and configuration baselines, cybersecurity documentation, spare parts lists and initial inventory, preventive maintenance plans, warranties and service contracts, SOPs, safety procedures, and training records [11][12][13][14][15][16].
When pieces are missing, the trouble shows up fast. Missing as-builts slow troubleshooting and make system changes harder without losing qualification status. Incomplete SOPs and training records increase the odds of quality escapes and failed audits. Weak spare parts planning and thin maintenance plans can force the plant into reactive mode during ramp, right when uptime matters most. Incomplete handoff packages also slow commissioning, operator training, and ramp-up in direct ways.
The move from project team to plant operations is one of the riskiest points in the whole timeline. Project teams often exit fast, while the operations team is still getting its footing. Good transitions usually rely on a joint steering committee with leaders from both sides, overlapping roles during a set transition window, and handover workshops where teams walk systems together, review commissioning records, and agree on open items.
Ownership also needs to be clear before the project team leaves. That includes warranties, punch-list closure, and change control. In defense settings, the handoff must also cover security accreditation, configuration management, and program compliance requirements as part of the formal transition plan.
That handoff can mean the difference between a ramp that settles in fast and one that gets stuck.
Align project controls, commissioning, MEP, and startup hiring to the master schedule to shorten the path from groundbreaking to output.
Usually, the biggest schedule risks come down to power availability, utility interconnections, and long-lead equipment. In many projects, the main critical-path issue is getting primary transformers, medium-voltage switchgear, and large chillers on time.
If a team misses key buying windows, commissioning can slip and production start dates can move out. Weak workforce planning can make things worse. The same goes for hiring delays in specialized MEP and commissioning roles, which often add more drift to the schedule.
Hiring for startup and mission-critical roles needs to begin well before site mobilization if you want to protect the schedule and avoid expensive slowdowns.
Start with project leadership during planning. Bring in MEP and commissioning leaders during design. Then add superintendents, QA/QC, and safety staff before mobilization.
For specialized roles that are hard to fill, begin the search 6 to 12 months before that phase starts.
A plant is production-ready when it goes through a structured commissioning and validation process that shows every system works as intended.
That means having documented proof in place, such as test reports, calibration records, and, when needed, IQ, OQ, and PQ results. It also means closing out punch list items, checking and confirming safety systems, and making sure the operations team is fully trained and has the documents they need to do the job well.
