Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
Commissioning is how I check that a building’s systems work as the owner expects before handover. It is not just startup, TAB, or punch list work. It starts in design, moves through installation checks and system testing, and ends with training, records, and support after turnover.
Here’s the short version:
One stat stands out: studies cited in the article report median energy savings of 16% in existing buildings and 13% in new construction. That helps explain why demand for commissioning work keeps growing.
If I had to sum it up in one line: commissioning proves a building is ready to run before people depend on it.
On mission-critical projects, the commissioning scope gets much broader. The goal isn't just to check boxes. It's to verify the systems that protect uptime, safety, and compliance.
If one of these systems fails, the result can be downtime, safety issues, failed inspections, or product scrap. Put simply: these systems decide whether a facility is actually ready to operate.
Each system group comes with its own failure points, test requirements, and pass criteria.
Mechanical and HVAC systems usually make up the biggest share of commissioning on complex projects. Testing confirms airflow, site-specific temperature targets, humidity levels, pressurization, control sequences, and failover behavior. It also checks that lead-lag rotation, economizer operation, and reset schedules line up with the approved sequence of operations.
For CRAH/CRAC units, commissioning looks at airflow patterns, supply and return temperatures, and how redundancy responds when a unit drops out. In cleanrooms and hospitals, systems are tested together under live conditions to confirm that pressurization, air-change rates, and filtration performance are ready for turnover. [2][3][7][11]
On the electrical side, commissioning checks failover and system integration across switchgear, UPS units, generators, transfer switches, and battery systems. Sequence verification confirms the right start, stop, and transfer order.
Power-loss testing goes a step further. It proves that the generator comes online within the required transfer and ride-through windows, and that loads transfer cleanly without nuisance trips. That work is verified under actual load conditions, not just in a submittal or sequence narrative. [2][3][6][10][11]
Controls commissioning checks that field devices, control logic, graphics, trends, and alarms match design intent. EPMS commissioning confirms metering accuracy, breaker status, and alarm thresholds so operators can spot overloads before they turn into outages.
For life safety systems, integrated testing simulates fire events to confirm that HVAC, smoke control, access control, and suppression systems respond the right way as a group. The results also need to satisfy code requirements and local authority documentation needs.
In healthcare facilities, medical gas systems are commissioned to verify purity, pressure, leak tightness, alarm operation, and source redundancy. Those checks tie directly to patient safety and accreditation compliance. [4][5][8][9]
In GMP pharmaceutical and semiconductor manufacturing, clean utilities and process systems are verified to confirm that flow, pressure, temperature, and quality parameters meet spec. Testing also checks that sanitization records and safety documentation are in place for regulatory inspections. [4][5][8][9]
Across all of these settings, interlocks, safety shutoffs, and utility-loss sequences are validated under real operating conditions. That's the whole point: prove the system works before turnover, not after people move in or production starts.
Once these systems are verified, commissioning moves into functional testing, deficiency tracking, and turnover.

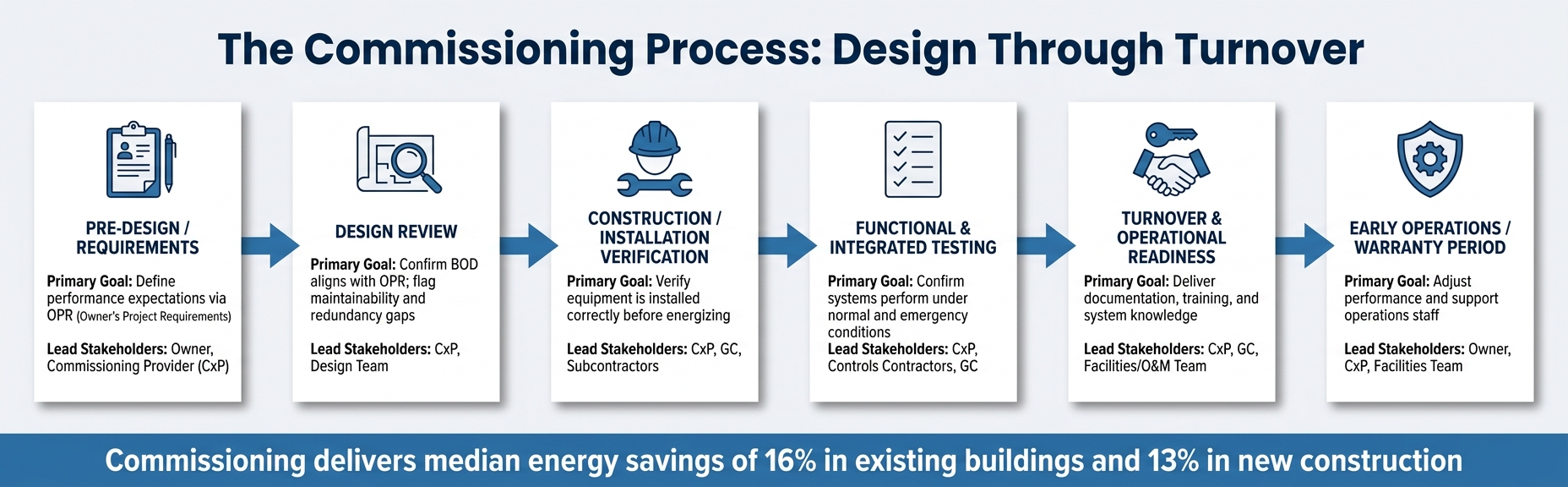

How the Commissioning Process Works: Design to Turnover
Once the systems are set, commissioning moves through a set path: from requirements to design review, then field checks, testing, turnover, and warranty support. At each step, the process spells out what needs to happen and who owns it.
The process begins by turning the OPR into design criteria. The BOD explains how the design will meet those requirements. That includes uptime targets, redundancy levels like N+1 or 2N for power and cooling, energy goals, and maintainability expectations.
At this stage, the CxP reviews the BOD for gaps tied to performance, maintainability, and redundancy. That early review matters. It can catch things like clearance conflicts, bad intake or exhaust placement, or control sequences that fail to handle redundancy switchover. Fixing those issues on paper is a lot easier than finding them after turnover, when uptime and service access problems become much more painful.
Once construction starts, the CxP shifts into pre-functional checklists and site observations. These checks confirm that equipment is installed the way the drawings show and the design intends. For example, the team may verify that:
This work happens before any energized testing begins. It helps stop a pileup of test failures later, when systems are live and the cost of delay goes up. In short, the team first checks the design, then checks that the field installation matches it.
Functional testing starts with individual pieces of equipment, then moves to full system behavior under normal and failure conditions. The idea is simple: first make sure each part works on its own, then make sure the whole setup works when things go right and when things go wrong.
A generator, for example, is tested for automatic start, load acceptance, and alarm verification for low oil pressure and high coolant temperature. A UPS is tested for input and output voltages, battery charging, and clean transfer from normal power to battery and back.
IST checks how systems respond together across power, cooling, fire alarm, egress, and life-safety systems. This is where coordination gets tested for real. If one system changes state, do the others react the way they should? These tests are usually run during off-peak hours and documented with precise timings and system interaction logs. After testing passes, the work shifts to closing deficiencies and getting the facility ready for operations.
Every issue found during testing goes into a deficiency log. Each one is logged, assigned, prioritized, corrected, and retested. The CxP works with the GC and subcontractors to coordinate fixes, then sets up retesting to confirm the correction holds under the same conditions.
Turnover includes the final commissioning report, as-builts, O&M manuals, and operator training. That handoff is not just paperwork. It gives the facilities and O&M team the information they need to run the building without guessing.
The CxP often stays involved during the warranty period as well, helping with seasonal testing and troubleshooting issues that show up under actual operating loads.
Once systems are defined and tested, the work shifts from planning to turnover. At that point, a small group of specialist roles takes over. Each one has a different job, a different angle, and a different set of deliverables.
The commissioning authority (CxA), often called the commissioning agent, represents the owner and leads the process apart from the installing contractor. The CxA owns the commissioning plan, sets acceptance criteria, reviews design documents, witnesses testing, and recommends system acceptance or non-acceptance to the owner.
A commissioning engineer is closer to the field work. This person develops detailed test scripts, carries out or witnesses functional tests, reviews trend data, and troubleshoots issues in MEP and controls systems. Commissioning engineers usually report to the CxA or a commissioning manager within a third-party Cx firm or a specialist division of a GC or EPC contractor.
A commissioning manager is focused on coordination across a large program. On large data center or pharma jobs, this role ties testing, turnover, and documentation into one integrated schedule. The commissioning manager usually reports to a project executive or program director and is accountable for risk management and operational readiness.
In practice, these roles can blur together, especially on large projects where testing and documentation are happening at the same time.
QA/QC managers make sure systems are ready before commissioning begins. They run inspection checklists, verify materials and workmanship, and track non-conformance reports (NCRs) that need to be closed before functional testing starts. On some mission-critical programs, one Manager of QA/QC & Commissioning may lead both areas. The split is simple: QA/QC checks installation quality, while commissioning checks performance and operational readiness.
Controls specialists handle the BAS/BMS side. They program and debug systems, run point-to-point checks, validate sequences, and confirm alarms and interlocks. EPMS specialists make sure power monitoring devices are set up correctly and tied into BMS and DCIM tools. That matters a lot for fault analysis and uptime reporting. Owner's representatives also stay involved by joining design reviews, reviewing commissioning protocols, and confirming that the process meets contract, regulatory, and operating requirements.
For hiring teams, the title matters less than whether the person can test hard systems under pressure.
Most employers want a working knowledge of MEP and controls systems. That usually means HVAC, chilled-water plants, electrical distribution such as medium voltage, UPS, generators, and switchgear, plus BAS/BMS/EPMS integration. They also want people who can read drawings and specs without getting lost, including single-line diagrams, P&IDs, control sequences, and panel schedules, then compare them against field conditions.
Issue tracking is another big separator. Employers like candidates who know platforms such as Procore or BIM 360 and can log, rank, and push deficiencies to closure across several stakeholders. On mission-critical work, hands-on experience with load tests, failover drills, and emergency simulations often makes the difference between a good candidate and a top one.
Project background also carries real weight. Data center, hospital, and semiconductor experience tends to matter most because those jobs are tied closely to reliability, safety, and downtime risk.
Certifications help, but they usually work best when paired with solid field experience. A PE license in mechanical or electrical engineering points to technical depth and is often valued on healthcare, energy, and infrastructure work. The ASHRAE BCxP is widely recognized for commissioning knowledge across design, construction, and operations phases. The PMP is especially useful for commissioning managers who need to fold Cx scope into overall project delivery. For power-heavy roles, NETA certifications, especially Level III/IV, are often required by spec on data center and utility jobs. NICET credentials and NFPA-related training such as NFPA 70E, NFPA 72, and NFPA 110 matter where life-safety and emergency power systems are a major part of the job.
Experience bands are fairly consistent across the market:
Commissioning starts in design and carries through testing, turnover, and training until systems are checked and ready for operations and project delivery. That end-to-end role matters most when a facility can't afford mistakes.
In mission-critical projects, weak commissioning can lead to downtime, poor coordination, and delayed operations. That's why commissioning stays at the center of data centers, hospitals, labs, and advanced manufacturing facilities. In these buildings, HVAC, electrical, backup power, controls, and life safety systems all need to work together.
Commissioning also brings measurable value. Studies have found median whole-building energy savings of 16% in existing buildings and 13% in new construction, with new-construction commissioning often paying back within a few years.[12][16][1][18][17] That's a big reason hiring demand keeps growing.
These projects create steady demand for commissioning professionals who can connect design, fieldwork, testing, and turnover. Employers pay for commissioning skill because it cuts risk through reliable documentation, rigorous testing, and turnover readiness. For employers, commissioning talent lowers risk. For candidates, it opens doors to some of the most demanding projects in construction.
That full-project responsibility is what makes commissioning a high-value career path.
It depends on how the project is set up and what the team is trying to achieve.
The Commissioning Authority (CxA) usually represents the owner. Their job is to oversee commissioning from pre-design through operations and confirm that the facility meets the Owner's Project Requirements and the design intent.
The Commissioning Manager (CxM) usually works for the contractor or project delivery team. They focus more on field execution, trade coordination, startup schedules, and making sure the project is ready for turnover.
On large, mission-critical projects, it's common for both roles to work side by side.
Commissioning should start in the pre-design phase. Bringing in the Commissioning Authority (CxA) early helps shape the Owner’s Project Requirements (OPR) and review the design for commissionability before construction starts.
That matters because it helps spot design gaps or scope issues early, when fixes usually cost less. It also helps keep technical targets lined up with business goals.
Not always. Plenty of employers like to see a four-year degree in mechanical, electrical, or building services engineering. But in practice, strong hands-on field work is often treated as equal to that degree - and sometimes worth even more.
A lot of people move into commissioning from MEP systems, controls, automation, or facility operations. That makes sense. If you've spent time working directly with building systems, you already know how things behave outside of a textbook.
What do hiring managers tend to care about most? Proven experience with mission-critical equipment. And if you want extra proof of your skills, certifications such as BCxP, CxA, or CCP can help back that up.
Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed do eiusmod tempor incididunt ut labore et dolore magna aliqua. Ut enim ad minim veniam, quis nostrud exercitation ullamco laboris nisi ut aliquip ex ea commodo consequat. Duis aute irure dolor in reprehenderit in voluptate velit esse cillum dolore eu fugiat nulla pariatur.
Block quote
Ordered list
Unordered list
Text link
Bold text
Emphasis
Superscript
Subscript
