If I had to sum up the whole article in one line, it would be this: owner-side control is what keeps a data center build from slipping.
U.S. data center demand may double or triple by 2028, while power access and equipment lead times keep getting tighter. That means I can’t treat staffing, procurement, scheduling, and commissioning as back-office work. They directly affect COD, turnover, and revenue. On a 60 MW project, a commissioning delay can cost about $14 million per month.
Here’s the playbook in plain English:
A simple split also matters: hyperscale projects usually favor standardization and fast campus delivery, while colocation programs often phase builds around tenant demand and capital timing. That changes how I plan staffing, procurement, and turnover.
| Focus area | What I need to do |
|---|---|
| Team setup | Put project executive, owner’s rep, MEP lead, commissioning manager, scheduler, and facilities lead in place early |
| Procurement | Release long-lead packages fast and assign one owner for OFCI tracking, testing, storage, and delivery |
| Schedule | Tie utility and land items directly into the master schedule with logic links |
| Risk control | Set triggers for utility delays, labor gaps, scope change, and rework |
| Commissioning | Start during design and carry factory testing through IST and handoff |
| Performance | Watch role fill rate, schedule adherence, cost per MW, pass rates, defects, and safety |
Bottom line: if I want more schedule certainty, fewer late changes, and a cleaner handoff, I need to build the owner-side system first and let every other part of the project follow it.
Most schedule slips start with governance, not with what happens on-site. When decision rights are fuzzy and no clear escalation path exists, approvals drag, procurement slows down, and the finish date starts to slip even if the site looks busy. That’s why the owner-side team needs to be hired and assigned before design freezes and contracts are signed. In plain terms: set staffing and decision rights early, not after the schedule is already in motion.
The table below shows the first owner-side hires that matter most, what they can decide, and where handoffs often break down.
| Role | Primary Decision Rights | Common Failure Point |
|---|---|---|
| Project Executive | Business case, total budget, capacity goals, and delivery model selection [1] | Slow procurement decisions [1] |
| Owner's Representative | Day-to-day oversight, reporting, issue escalation, and contractor accountability [1] | Field issues miss escalation [1] |
| MEP Construction Manager | Technical coordination of electrical/mechanical systems and energization readiness [1] | Trade coordination gaps [1] |
| Commissioning Manager | System validation, testing documentation, and final turnover acceptance [1] | Commissioning starts too late [1] |
| Scheduler / Project Controls | Master schedule logic, tracking decision latency, and risk register maintenance [6][4] | Unreliable third-party dates [6] |
| Operations / Facilities Lead | Maintenance readiness, training requirements, and final handoff acceptance [1] | Poor closeout handoff [1] |
One role is easy to bring in too late: the Commissioning Manager. That person should join during design and preconstruction. When verification needs are set before equipment is ordered, teams avoid late-stage rework that squeezes turnover timelines and chips away at schedule confidence.
One site may only need a construction team. A multi-site program needs a PMO.
The reason is simple: standardization. Without one central set of rules and tools, each new site turns into a one-off build. And once that happens, owners give up the cost and schedule gains that come from doing things the same way across locations.
A solid PMO standardizes:
It also gives the program one source of truth for cost, schedule, MEP coordination, and commissioning data. Across the enterprise, this kind of standardization can improve cost predictability by 1% to 2%. On a $1 billion-plus campus, that means $10 million to $20 million in budget certainty per phase [7].
Even well-staffed programs lose time on internal handoffs. The trouble usually shows up where utility coordination, IT fit-out sequencing, and financial approvals for long-lead equipment meet.
Operations, energy, security, and finance leaders need to be involved during site selection, not brought in at turnover. Financial approvals for long-lead items such as switchgear and transformers need to line up with capacity planning. If those tracks move out of sync, delays show up fast.
Owner review cycles, utility response windows, and permit timelines should be built into the schedule as actual activities with predecessors and successors. They should not sit in the background as admin work [6].
With the team in place, the next step is to standardize delivery and partner selection before procurement begins.

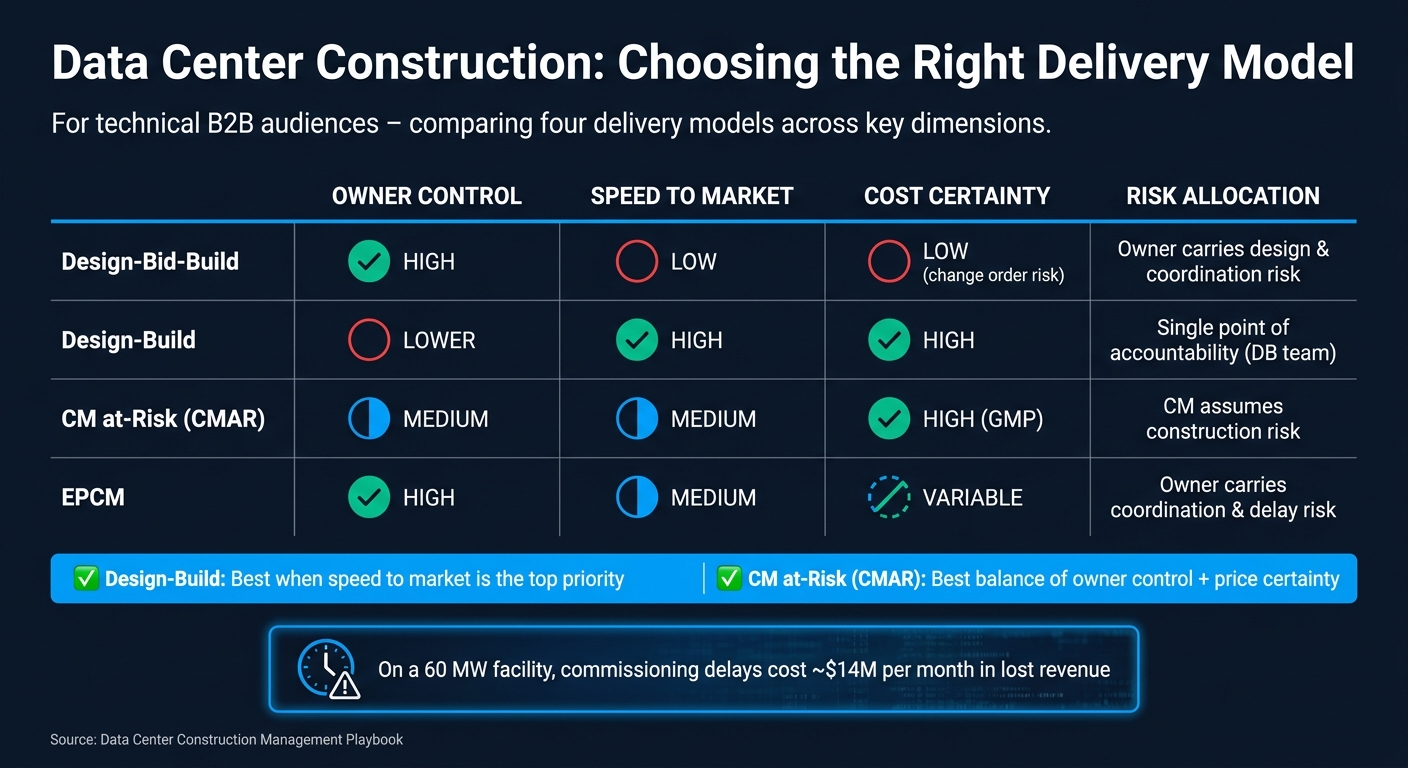

Data Center Delivery Models Compared: Control, Speed & Risk
Once governance is in place, the next move is picking a delivery model that fits the program’s risk profile. That choice shapes how fast the team can move, how much schedule control the owner keeps, and how much room there is in procurement.
There’s no one-size-fits-all delivery model for a data center program. The best fit comes down to three things: how much design control the owner wants, how fixed the budget needs to be, and how fast the project has to reach market.
| Delivery Model | Owner Control | Speed to Market | Cost Certainty | Risk Allocation |
|---|---|---|---|---|
| Design-Bid-Build | High | Low | Low (change order risk) | Owner carries design and coordination risk |
| Design-Build | Lower | High | High | Single point of accountability for the DB team |
| CM at-Risk (CMAR) | Medium | Medium | High (GMP) | CM assumes construction risk |
| EPCM | High | Medium | Variable | Owner carries coordination and delay risk |
In plain terms, Design-Build works well when speed matters most. CM at-Risk gives a middle ground between owner control and price certainty. EPCM can work, but only if the owner is ready to carry coordination risk and actively manage it.
Multi-prime delivery also shows up often on large hyperscale programs. On the Crusoe Abilene campus, early trade involvement compressed mobilization - the team broke ground 10 weeks after the first design meeting and reached initial turnover in 11 months [5].
Once the delivery model is set, partner review should focus on the risks that come with that model.
Partner selection should center on mission-critical experience, procurement command, path to power, prefabrication capacity, and project controls.
| Partner Selection Criteria | Key Evaluation Metric |
|---|---|
| Mission-Critical Experience | Total MW delivered; rack densities supported; % of projects hitting COD |
| Procurement Command | Established OEM relationships; strategy for 12-month+ switchgear lead times |
| Path to Power | Relationships with local utilities; experience with substation delivery |
| Prefabrication Capacity | Ability to move >30% of MEP work off-site to reduce site congestion |
| Project Controls | Use of integrated schedule, cost, and risk reporting with logic-driven milestones |
Don’t stop at the company logo. Review the actual project team. Ask how many total megawatts they’ve delivered, what rack densities they’ve worked with, and what share of their past projects hit the original commercial operation date (COD). If a team looks good on paper but can’t show a clear path to power, that gap matters. Utility interconnection, substation sequencing, and speed to power should sit near the top of the review.
Commissioning providers should come in during design, not near the finish line. That gives them time to define sequence of operations and test durations before procurement begins. On a typical 60 MW facility, commissioning delays can result in approximately $14 million per month in lost revenue and related impacts [4].
Long-lead equipment can wreck a schedule if the team waits too long. Medium-voltage switchgear lead times have reached 12 months or more in many U.S. markets [4]. Generators, transformers, UPS systems, and cooling equipment can create the same kind of squeeze.
A common move is to release limited-scope purchase orders for long-lead equipment before the full design is finished, then convert those orders into full-service agreements as details get locked in [8]. That approach helps teams move before every drawing is final.
It also helps to standardize design standards and technical criteria across sites for major equipment categories. Keeping generator, switchgear, and cooling system selections consistent cuts the odds of late design changes and the procurement or installation rework that tends to follow.
One detail that often gets messy: ownership. Assign one owner for OFCI lead times, submittals, factory testing, storage, and delivery logistics. If handoffs are fuzzy, installation slows down.
Add price-adjustment clauses tied to material indices or tariffs [2][8].
With delivery and procurement set, the next control point is the integrated schedule and commissioning plan.
Once procurement is locked, execution discipline becomes the main lever for schedule control. In practice, three tools carry most of that load: an integrated master schedule, formal risk controls, and a commissioning workstream that runs alongside construction instead of waiting until the end.
Schedule certainty is a business requirement, not a nice-to-have. Build the Integrated Master Schedule around system readiness, not around which trade happens to be free.
An Integrated Master Schedule (IMS) ties utility milestones, permitting, long-lead equipment procurement, civil work, MEP rough-in, and commissioning into one critical path [1][3]. Land rights, easements, and utility interconnection agreements need to sit inside that same schedule, with logic ties to mobilization and equipment delivery, not off in a separate admin tracker. If the utility interconnection slips, the IMS should show the downstream hit to energization and commissioning right away.
Float analysis matters here. Owners should use CPM scheduling to separate delays that can still be recovered from delays that put COD at risk [3]. On fast-track programs, parallel work is normal: structure, envelope, procurement, and infrastructure all move at the same time [5]. The owner still has to control milestone logic, escalation triggers, and recovery calls from start to finish.
That schedule should also feed the live risk register and trigger recovery action the moment a critical milestone slips.
Each risk below can hit COD, shift revenue timing, or weaken turnover quality. Mitigating schedule risks is a core owner duty, not something to patch in later.
| Risk | Likely Impact | Owner Control | Accountable Role |
|---|---|---|---|
| Utility Interconnection Delay | Prevents energization and IST; delays turnover | Early engagement; phased energization plans; treat agreements as critical path activities | Owner / Utility Liaison |
| Long-Lead Equipment Volatility | Stops MEP rough-in; creates schedule gaps | Early-release packages; OFCI tracking; direct OEM relationships | Procurement Manager |
| Labor Gaps / Congestion | Reduced productivity; safety risks | Prefabrication strategies; coordinated sequencing to reduce peak headcount | GC / MEP Leader |
| Scope Creep | Increased costs; procurement resets | Formal change control; defined decision rights; lock design standards before procurement | Owner's Rep |
| Quality / Commissioning | Operational failure and turnover delay | Parallel commissioning; early factory witness testing; IST discipline | Commissioning Manager |
Grid interconnection timelines in the U.S. have more than doubled over the past two decades and now often run past four years [4]. That puts early utility engagement in the must-do category. Owners should set clear escalation triggers in the schedule - specific points where a utility or procurement delay automatically activates a recovery schedule or starts a force majeure review [2].
Those controls only hold up if commissioning runs with construction instead of trailing behind it.
"Commissioning is no longer a final technical sign off, it sits at the center of delivery risk and revenue protection." - Erin Stanton, Consultant, LVI Associates [10]
During execution, the commissioning manager should run testing, documentation, and turnover in parallel with field work. A staged process works best: factory witness testing, pre-functional checks, functional performance testing, and integrated systems testing. At each stage, the commissioning manager has to line up the construction manager, trades, controls teams, and operations staff.
On a typical 60 MW facility, commissioning delays can lead to about $14 million per month in lost revenue and related impacts [4]. That number changes the tone fast. Operations staff should be part of staged cutover planning well before integrated systems testing starts, so the final system test confirms turnover readiness and sets up a clean operational handoff [9].
Once commissioning is planned, staffing becomes the next pressure point on the schedule.
Treat staffing like a schedule control, not an admin task. Labor availability, site access, and field productivity all need to show up in the plan.
Start by turning the multi-year build plan into a phase-based staffing plan. Preconstruction, MEP installation, and commissioning each call for different leaders at different times. Tie hiring dates to phase start dates so owner-side leadership is in place before the Notice to Proceed (NTP). Commissioning hires should be part of the design-phase staffing plan, not something pushed to the end. Regional labor conditions matter too. A staffing plan that works in one market can fall apart in another if specialized electrical or commissioning talent is hard to find [11].
At this scale, owners need a live recruiting pipeline for mission-critical roles before NTP. Waiting until a gap appears is how schedules slip. Owners need an active talent pipeline, with specialized recruiting and recruitment process outsourcing, so leadership gaps don't turn into schedule gaps [1].
Once the labor plan is in place, the next step is simple: track whether roles are being filled early enough to protect the schedule.
Execution gets better when owners measure the right things. The table below shows the gap between how many programs begin and where a well-run playbook can take them:
| Metric | Baseline Performance | Improved Performance (Playbook-Driven) |
|---|---|---|
| Critical-Role Fill Rate | Roles filled reactively after delays occur | Leadership in place before NTP; no critical-role gaps at phase start [1] |
| Schedule Adherence | Frequent slips due to trade stacking and labor gaps | High; logic tied to resource availability [11] |
| Cost per MW | High variance; late change orders and rework | Predictable; standardized procurement and early long-lead lock-down [12] |
| Commissioning Pass Rate | Low first-pass rate; treated as a final punch list | High; parallel workstream with high first-pass rate [12] |
| Rework / Defects at Turnover | High due to weak MEP coordination | Low; early commissioning and prefab alignment [12] |
| Safety Performance (TRIR/EMR) | Average TRIR/EMR; risk in congested zones | Lower TRIR/EMR through planned crew density and active field oversight [1] |
Track these metrics at the program level, not only at the project level. Looking across sites makes patterns easier to spot. That tells you whether the delivery model, partner selection, and staffing approach are scaling well - or whether a few projects just happened to go right.
Then use those signals to adjust hiring, sequencing, and partner selection before the next phase begins.
Owner-side staffing discipline drives schedule certainty. Hire the right Project Executive and technical leaders early. Standardize delivery models and partner selection criteria so each new site starts from a proven baseline instead of a blank page.
Manage risk with an integrated master schedule and clear escalation paths. Treat commissioning as a day-one engineering workstream, not a last-step sign-off. Build a talent pipeline that puts the right people in place before the schedule calls for them. A delayed data center means delayed customer capacity, delayed cloud or AI workloads, delayed revenue, and missed market timing [1]. The right owner-side team, hired early, improves turnover speed and cuts rework. That is where better construction management starts.
Hire the owner-side team 4 to 6 months before mobilization. That gives you time to put key people in place early, including project managers, MEP coordinators, and commissioning specialists.
Bringing the team on before mobilization helps cut down on delays and keeps the project moving with fewer hiccups.
It comes down to what matters most to you: control, speed, risk, or flexibility.
For hyperscale projects, multi-prime risk-sharing is a common pick when speed is the main goal. Bringing trade partners in early can move the job along faster, while also giving owners more say in coordination.
If you prefer single-point accountability, design-build may be a better fit. If you want more direct control over design and procurement, EPC or EPCM can give you that flexibility, but they also ask more from you on coordination.
Commissioning should begin before construction wraps up. That gives the team time to spot system issues early and fix them before they turn into expensive rework.
It also helps the facility get ready for day-to-day use, not just handoff on paper. And when turnover time comes, the process is usually much smoother and far less chaotic.
