A data center Cx engineer does not do the same job from start to finish. I see the role shift across 7 phases: design, preconstruction, installation, prefunctional testing, functional testing, integrated testing, and turnover.
Here’s the short version:
That shift matters because the cost of fixing problems climbs as the project moves forward. The article points to 27% fewer system-related change orders and a 90% drop in contractor callbacks when issues are found early. Put simply: the earlier I find a testing or controls gap, the less pain the team deals with later.
The article compares each phase using the same four checks:

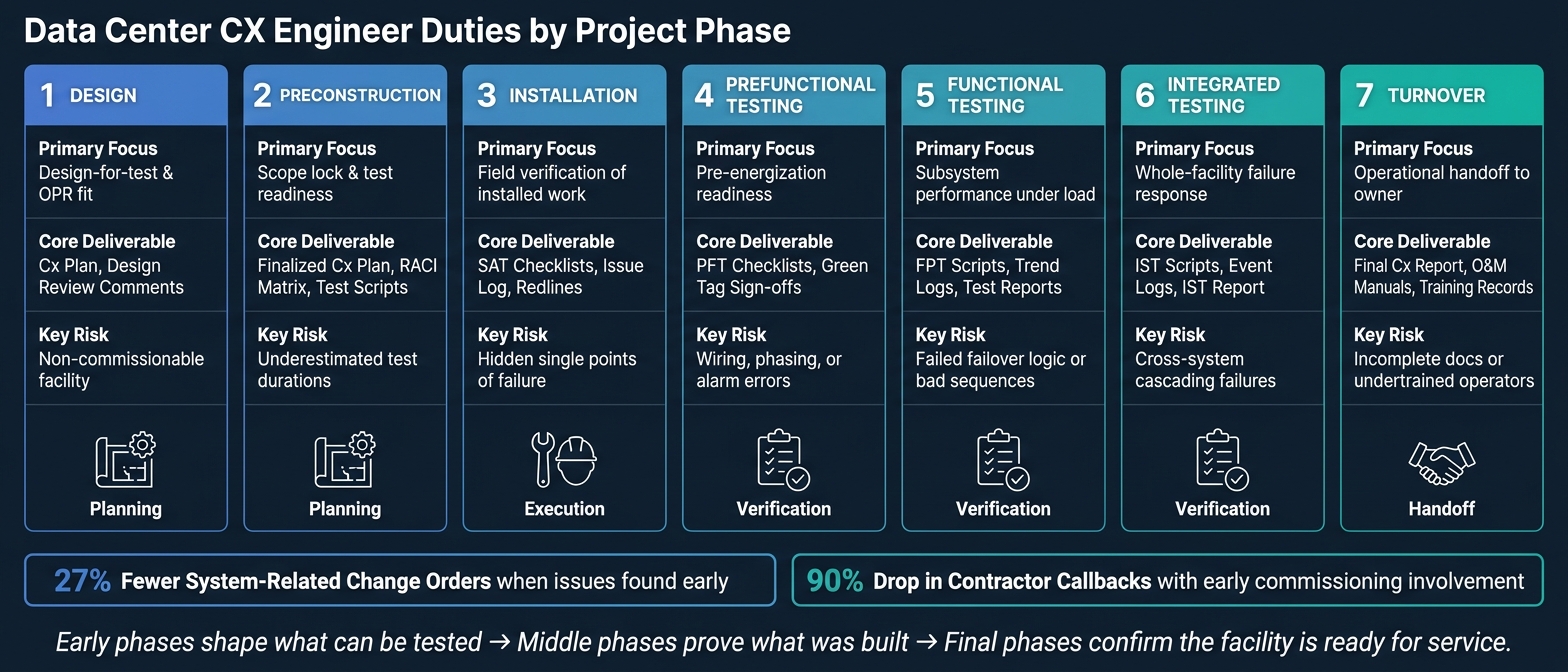

Data Center CX Engineer Duties by Project Phase
If you want the simplest takeaway, it’s this: early phases shape what can be tested, middle phases prove what was built, and final phases show whether the full data center is ready for service.
The design phase is the least expensive time to fix commissionability issues. That’s why the Cx engineer should get involved by schematic design, or no later than 30% design.
At this stage, the Cx engineer’s main job is simple: make sure the facility can actually be tested once it’s built.
That sounds obvious, but it’s easy to miss. Commissionability means the design includes the access, isolation, metering, trending, and controls needed for safe testing. If those pieces aren’t built into the design, the team may end up with systems that look fine on paper but can’t be checked properly in the field.
The engineer also reviews the design against the Owner's Project Requirements (OPR) and the Basis of Design (BOD). The goal is to make sure the finished facility lines up with how the owner expects it to run day to day.
What gets defined here shapes what the team can verify later during installation and testing.
During design, the Cx engineer produces the documents that guide both construction and testing:
The engineer also reviews sequences of operation and BMS/EPMS point lists. Why does that matter? Because if a point isn’t included in the design, it can’t be checked later. No point, no proof.
This is also the stage where training, documentation, and turnover expectations start getting defined. Those items often seem far off during design, but they shape handoff quality at the end of the project.
These documents become the baseline for preconstruction submittals, installation checks, and test scripts.
During design, the Cx engineer works closely with the architect, design engineers, owner/operator, operations staff, and project manager.
Operations staff matter a lot here. They often spot maintainability problems and failure modes that the design team may not catch. A layout can work on paper and still be a pain to operate in real life.
On projects pursuing Uptime Institute Tier certification, a third-party Tier certifier may also review the design documents. When that happens, the Cx engineer needs to work that feedback into the commissioning scope.
The biggest risk in design is ending up with a non-commissionable facility.
That can show up in a few ways:
The key decision point is approval of the commissioning plan, scope, and IST approach. Once that gets approved, it sets the path for preconstruction.
After design approval, the focus moves to scope lock, submittals, and procurement in preconstruction.
After design approval, the Cx engineer shifts from design review to execution control. The focus moves to constructability, sequencing, and test readiness. Put simply, this is where design intent gets translated into requirements the field team can actually use.
The main job here is to define "done" before installation begins. That means reviewing submittals and shop drawings for commissioning items like isolation valves, test ports, metering, and alarm points before procurement. If something is missing at this stage, the team can fix it before installation instead of dealing with rework later.
The Cx engineer uses preconstruction to finish documentation and test prep early:
At this point, coordination becomes schedule-driven. The Cx engineer’s role expands across the owner, design team, GC, and vendors.
The owner or owner’s rep confirms reliability and redundancy targets in the OPR. The design team needs to close out commissioning-related comments so testing needs show up in the issued-for-construction documents.
The general contractor or construction manager becomes a core partner. Commissioning milestones need to be built into the master schedule, not tacked on at the end. In phased data center deliveries, the Cx engineer works with the GC to sequence testing by data hall, electrical room, or mechanical plant module. That helps labor, tools, and vendor support move from phase to phase without unnecessary delays.
Equipment vendors matter here too. For UPS systems, generators, switchgear, and chillers, the Cx engineer brings in OEM representatives early to review factory test data, standard startup scopes, and recommended commissioning steps. That input shapes the site testing approach and helps the team plan around vendor availability windows.
The biggest risk in preconstruction is underestimating commissioning durations. If the schedule doesn’t allow enough time for prefunctional, functional, and integrated testing, the team ends up under pressure later. And when the clock starts ticking, steps get rushed or skipped. That squeeze usually shows up during startup and later testing.
Part of the Cx engineer’s job is to push back on compressed commissioning windows while the schedule can still be adjusted. That’s the moment when a schedule fix is still possible, not after crews and vendors are already locked in.
The key decision point is finalization of acceptance criteria. Preconstruction is the right stage to define what passing looks like for generator step-load performance, UPS ride-through times, temperature stability, and alarm response times. Lock those targets now, and turnover disputes become a lot less likely.
Once acceptance criteria are set, the next phase shifts to field verification of installed work.
Installation is where commissioning moves off the page and into the field. At this point, the Cx engineer stops looking only at documents and starts checking the installed work in person. Once equipment arrives on site, the job is to confirm that installation matches the BOD, commissioning requirements, manufacturer instructions, and code. This is the stage where problems stop being theoretical and become visible.
The Cx engineer performs regular site inspections as equipment is delivered and set in place. That includes checking nameplate data against approved submittals, confirming placement and anchorage, and reviewing access, clearances, and serviceability before walls go up and installation is closed out. If installation quality slips here, later testing usually slips too.
During installation, the Cx engineer produces field records that decide whether the project can move forward. Site Acceptance Testing (SAT) checklists are completed for each major system, including UPS, switchgear, PDUs, chillers, and CRAH units. A live commissioning issue log tracks each field deficiency with the description, photos, responsible party, and target closure date.
Redlined drawings show as-built deviations that affect commissioning scope. Yellow-tags keep deficient equipment out of the next phase until reinspection closes the item. Put simply, these records show whether installation is ready for prefunctional testing.
This phase takes close coordination. The Cx engineer works with trade foremen, QA/QC staff, startup technicians, the GC, and subcontractors. Controls contractors and integrators matter a lot here because the Cx engineer must verify that BMS and EPMS points are installed and wired the right way.
Design engineers also stay involved to answer RFIs and deal with field changes that affect commissioning scope. Their sign-off is the gate into prefunctional testing.
The biggest risk in installation is a single-point failure hidden in plain sight, like a common upstream breaker sitting behind A/B feeds. Issues like that are much easier and cheaper to fix during installation than after systems are energized and carrying load.
The key decision point comes at phase closeout: either clear open items or document them before prefunctional testing starts. That handoff keeps the project on schedule and stops known defects from drifting into the next phase.
After installation closeout, the Cx engineer checks that each system is safe to energize and ready for startup. Prefunctional testing is where that gets proved on paper and in the field. The goal is simple: make sure the system is installed the right way, safe to power up, and ready for functional testing.
At this stage, the team checks the items that can make or break startup: torque, terminations, rotation, fluid levels, sensor calibration, and BMS/EPMS communication. Each check needs to be documented before the system is released to functional testing.
The Cx engineer controls the release to functional testing. This phase is the last readiness gate before systems are tested under live operating conditions. That means no UPS module, generator, switchgear assembly, PDU, chiller, CRAH unit, or BMS controller moves ahead until its checklist is complete and accepted.
There’s no sampling here. Every checklist must be completed.
It also helps to inspect the first unit of each equipment type in detail. Why? Because repeat issues tend to show up early. Catch one wiring error or setup mistake on the first unit, and you may save the team from fixing the same problem ten more times later.
That release gate depends on three things: complete checklists, verified startup data, and point-to-point proof.
This phase takes tight coordination across several teams.
Startup technicians handle the physical energization of switchgear, UPS, chillers, and fans. OEM representatives bring manufacturer startup checklists and sign off before the Cx engineer issues a green tag. Controls and BAS specialists verify I/O mapping, alarm routing, and logic between field devices and the building automation system. TAB technicians run early airflow and hydronic checks, producing baseline readings in CFM and PSI that become reference points later.
This is the point where small misses can turn into expensive failures under load. Incomplete points, bad phasing, missing alarm mappings, or a failed generator startup can all create serious problems once the system is live.
That’s why the Cx engineer enforces strict Method of Procedure (MOP) and Lockout/Tagout (LOTO) rules during energization. If critical deficiencies are still open, the green tag does not get issued.
Functional testing starts only after every checklist is complete and signed. Once those checks pass, the project moves into functional testing, where systems are tested under operating conditions.
Functional testing checks whether each system can run under load, not just power on. In common North American commissioning practice, this is Level 4 (L4) functional performance testing. At this stage, each system has to show it can operate in conditions that look like actual use before integrated systems testing starts. Once each subsystem passes L4, the project can move into integrated testing.
The Cx engineer owns the FPT scripts for power, cooling, controls, and fire systems. These scripts are detailed, step-by-step procedures tied straight to the OPR, BOD, and control sequences. Each one spells out what the system should do, the conditions for the test, and what counts as a pass.
Take a power test as an example. The team simulates a utility loss to prove failover works under live operating stress. The UPS must carry the load, the generator must start, and the ATS must transfer after stabilization. If anything fails, the test stops. The issue gets logged, and the system must be retested.
That only works if the scripts, data, and retest process stay under tight control. Otherwise, things get messy fast.
This phase is very much a team effort.
Controls leads play a central role. PID loop tuning, alarm routing, transfer modes, alarms, and fault conditions are checked in real time during L4 tests. TAB specialists verify airflow and hydronic performance against design targets. OEM representatives for UPS systems, generators, and chillers attend their equipment tests and help sort out technical issues on the spot.
The operations team matters just as much. Operations staff should watch these tests happen and learn how the systems respond. That hands-on exposure can save a lot of confusion later.
L4 is a release gate. No system goes to integrated testing (L5/IST) until all Level 4 deficiencies are closed and retested. The Cx engineer makes that call and controls the release to L5.
Why does that matter so much? Because issues found here, like bad failover logic, unstable staging sequences, or mis-mapped alarms, are still fairly contained and can be fixed without dragging down the next phase. Let those same issues slip into integrated testing or live operation, and the trouble tends to spread.
Insufficient testing, especially poor failure logic and generator transfer sequencing, remains a recurring cause of serious outages [8][6].
Once all L4 deficiencies are closed, the team moves into integrated testing, where subsystems have to work together.
After individual systems pass Level 4 functional testing, the project moves into Level 5 Integrated Systems Testing (IST), the facility-level commissioning phase. L4 shows that each subsystem works on its own. IST shows that the whole facility works as one. It comes after L4 and confirms the systems work together before turnover.
IST checks system interactions and failure response across electrical, mechanical, controls, life-safety, and monitoring systems. The main point is cross-system behavior: what happens when one system fails, recovers, or transfers under load, and how the others respond.
A black-building test simulates total utility loss. That test proves UPS ride-through, generator start, transfer, and cooling recovery without manual intervention. IST follows L4 testing and proves the systems work together before turnover.
This phase is automatic, not manually driven. The scripts are built so the facility’s automatic sequences do the work, while the Cx engineer directs the test, watches performance, and records the results. If someone has to step in and fix something by hand, that’s usually the kind of issue IST is supposed to expose.
For Tier Certification projects, Level 5 completion is a prerequisite.
The Cx engineer coordinates test timing, prerequisites, witness attendance, and issue resolution. This is the stage where timing gets tricky. Multiple parties often need to watch the same event at the same time, and one system’s behavior can affect another in ways that create conflicts fast.
The owner’s operations team also needs to witness failure and recovery sequences firsthand. That way, they know what to expect and how to respond before handoff.
IST is where cascading failures finally show up in plain view. A generator start event might interrupt a critical load transfer sequence. A chilled-water plant reset might destabilize multiple CRAHs. Problems like these may stay hidden during standalone functional tests because each system looked fine on its own.
At this point, the Cx engineer makes the go/no-go decision for turnover. Any deficiency that creates unacceptable risk for live operations must be retested before that gate opens. Successful IST sign-off is the gate to Ready-for-Service (RFS). Once IST passes, the project moves to turnover and operational acceptance.
Once testing is done, turnover moves the job from technical proof to operational handoff. After IST sign-off and RFS, the Cx engineer shifts from running tests to coordinating handoff: making sure the operations team has the records, procedures, and training needed to run the facility. This is the moment responsibility moves from the construction team to the operations team. [13][10][4]
Turnover answers a different question: can operations take over without gaps? At this stage, the Cx engineer's recommendations are tied closely to live-load dates and early go-live milestones. [10][4]
The turnover package closes out the commissioning record and gets the owner ready for day-one operation. Each item helps avoid confusion once the building goes live. The Cx engineer reviews and checks that the package is accurate, complete, organized, and aligned with the commissioning plan and owner requirements. [3][12]
ASHRAE Guideline 0 requires defined training objectives, methods, duration, and documented results. [7][1] The Cx engineer treats this as a core deliverable, not an optional service.
During turnover, the Cx engineer works closely with the GC, trade partners, and operations staff to close out work and transfer ownership. The GC and trade partners - mechanical, electrical, controls, fire - stay involved to finish punch-list items and complete warranty registrations. [2][9]
The commissioning agent (CxA) leads formal acceptance, while the Cx engineer supports the process with system-level knowledge and issue tracking. IT and tenant teams also join closeout planning so go-live timing lines up with facility readiness. [10][11]
The biggest risk in turnover is incomplete or incorrect documentation. If there are gaps in as-builts, commissioning records, or SOPs/EOPs, the facility can inherit hidden failure points or operator mistakes once it is live. [12][4]
For large internet or financial services tenants in the U.S., downtime can cost thousands of dollars per minute. That puts the Cx engineer's closeout work in plain business terms: it lowers the chance of early-life incidents. [10]
The last decision point is readiness for owner acceptance. That means all critical systems have been tested and documented, no safety-critical defects remain open, and operators have been trained and can show competency. Any deferred items need to be logged with owners and assigned due dates. A formal closeout meeting and lessons-learned review finishes the phase, recording unresolved risks and helping the next project handle turnover better. [4][9][5]
A Cx engineer’s job doesn’t stay fixed from start to finish. In the early stages, the work leans toward design review and paperwork. Later, it moves into field checks, testing, and handoff. Put simply, the project moves from planning, to proof, to turnover.
The table below shows how that focus shifts by phase, along with the main deliverables, key people involved, and the big decision or risk at each step.
What changes over time isn’t just the task list. It’s also the kind of pressure the role carries.
Early on, the main concern is whether the design can actually be tested and whether it lines up with the OPR. A weak choice here can cause trouble months later. Once the project reaches installation and testing, the stakes shift. Now the question becomes: Does the system work the way it’s supposed to, under real conditions, with real loads?
The circle of people involved gets bigger in the later phases too. Controls teams, fire protection teams, and operations staff all play a larger part. That makes the work more hands-on and, in many cases, more intense. One missed label, one bad sequence, or one incomplete scenario can slow down energization or push risk into go-live.
So the focus changes in a pretty clear way: early risk sits in design fit, while later risk sits in proving performance and getting operations ready to take over. That shift also changes where the role feels the heaviest day to day.
Those shifts set up the next question: where does the role carry the most pressure, and where does it add the most value?
After the phase-by-phase duties above, this table shows the tradeoffs behind each stage.
Each phase gives the Cx engineer a different mix of influence and risk.
This is why the Cx engineer tends to have the most control early on and the most pressure near the end.
The early phases offer more room to shape the job. If something is off in design or preconstruction, it’s usually cheaper and easier to fix. Once the project moves into testing and turnover, the stakes go up. At that point, the work shifts from influence to proof.
Prefunctional testing and integrated testing show this tradeoff most clearly. They give some of the clearest evidence that systems are ready, but they also tend to expose the biggest problems. And when those problems show up late, schedule risk jumps fast.
Turnover usually gets squeezed the hardest. When go-live is close, training, documentation, and punch-list closeout often lose time first. That can leave operators with less time to get comfortable before they have to run the building.
Taken together, the seven phases follow one clear pattern. Across design, execution, testing, and handoff, the Cx engineer moves from design control to field verification to turnover.
In plain terms, the flow is straightforward: early phases protect the design, middle phases verify the build, and final phases prove the facility under real operating stress.
Early commissioning also cuts rework. One study found a 27% reduction in system-related change orders [14] and a 90% drop in contractor callbacks [15]. If an isolation-valve or controls-sequence issue is caught in design, the fix is cheap. If the same issue shows up during integrated testing, costs climb fast.
Bring the Cx engineer in during design. Keep the same team involved through turnover. And treat commissioning as a project-control function, not just a closeout task. Put Cx milestones in the master schedule, and tie completion to successful critical integrated testing, not only punch-list closeout.
The result is a data center with reliability that is documented, tested, and handed over.
Ideally, a commissioning engineer should come on board during the design phase or early construction.
In many projects, the CxA or commissioning manager gets involved during design and preconstruction. That gives them time to help shape the OPR and review the design before too many decisions are locked in.
Why does that matter? Because early involvement can cut down late-stage rework and help avoid delays at handover.
Functional testing checks whether each system - like chillers, generators, or UPS units - meets the design specs and does the job it’s supposed to do.
Integrated testing looks at how those systems perform together across the facility. That includes real failure scenarios, so teams can confirm resilience, redundancy, and coordination between systems.
Integrated Systems Testing (IST) in Level 5 carries the most risk. At this point, the facility is running at full load with every system live, while the team simulates worst-case failures to check redundancy and failover.
This is very different from more localized component testing. Level 5 looks at cross-system logic and the full facility infrastructure as one connected setup, which makes it the highest-risk gate before Ready-for-Service sign-off.
