If you want a data center project manager job, think construction first, not IT. I’d sum up the path like this: get deep MEP experience, learn commissioning, show you’ve run big jobs, and speak in hyperscale terms like MW capacity, RFS dates, N+1/2N, and Level 1–5 testing.
Here’s the short version:
One market fact stands out: U.S. data center construction was about $48.18 billion in 2024 and is projected to reach $112.33 billion by 2030. That means more jobs - but also tighter screening.
Understanding this model is essential for mitigating schedule risks during complex builds.
If I were moving into this field, I’d focus my resume on project size, MEP scope, commissioning role, and turnover results. That’s what gets you closer to hyperscale interviews and better offers.
A data center PM owns delivery from design coordination all the way through turnover. On a live project, that means keeping design aligned, staying on top of procurement, and pushing commissioning forward without letting delays stack up. The job starts in preconstruction and stays active through turnover.
During preconstruction, the PM reviews electrical and mechanical designs for constructability, checks that redundancy targets like N+1 or 2N can be built and maintained the way they were intended, and sets a baseline schedule that the team can actually hit.[8][11] That schedule usually lives in Primavera P6 or Microsoft Project. It tracks the critical path, float, and major milestones such as equipment release dates, factory acceptance testing, energization, and integrated systems testing.[5][11]
Once construction starts, the center of gravity moves to procurement control, RFI and submittal management, and change order discipline. This is where things get very real. Long-lead equipment often decides whether a data center project stays on track or slips. Generators, switchgear, UPS systems, transformers, chillers, and CRAH/CRAC units can have lead times from 8 to 24 months, which is much longer than standard commercial equipment.[5][9][11]
A good PM tracks fabrication, shipping, and delivery for every critical item and pushes issues up early, before they hit the critical path. On hyperscale programs, that kind of control matters more than routine admin work. Long-lead equipment and test milestones are often the difference between on-time turnover and expensive delay.
After procurement and sequencing are in hand, the PM turns hard toward safety, quality, and commissioning discipline.
Safety on a data center site goes beyond basic jobsite compliance. The PM enforces safety programs tied to OSHA standards and owner-specific rules, holds subcontractors to those rules, and moves fast when work does not conform.[5][10][11] A lot of the risk sits around energized systems, high-voltage installations, and work happening near live or soon-to-be-live equipment.
Quality control matters just as much. On hyperscale and mission-critical projects, owner standards often go past minimum code rules. Teams may be working to NFPA, ASHRAE, and TIA-942 on top of local building codes.[5][10][11] The PM checks that the installation matches the specs, that test records are complete, and that the workmanship supports the facility’s reliability targets.
Commissioning follows a staged sequence from Level 0 through Level 5, ending with Integrated Systems Testing (IST). At Level 5, the IST phase includes a full blackout test that simulates a utility outage. The point is to confirm that UPS systems and generators pick up the load and that failover sequences work the way they should.[12][13][14][15] The PM clears blockers, confirms prefunctional checklists are done, closes deficiencies, and keeps the commissioning agent, the owner’s operations team, and trade contractors lined up through the full test sequence.
How much of that lands on your desk changes based on the type of data center.
The PM role shifts with the delivery model. Hyperscale programs lean on standardized design templates, repeatable building programs, and phased turnover across multi-building campuses.[4][2][1][5][11] In practice, a PM on a hyperscale campus may be turning over one building while another is still being built. That takes tight sequencing, close stakeholder coordination, and the ability to manage work around live systems.
Colocation projects bring a different kind of pressure. There are multiple tenants, different fit-out needs, and SLA-driven capacity commitments that put both schedule and quality under a microscope.[4][2][6][7] Enterprise data centers are usually smaller, but they often involve closer coordination with one owner’s internal IT and facilities teams. They also tend to include custom design needs and tighter alignment with internal standards.[2][1][3][7]
Across all three models, the PM still owns schedule, budget, procurement, and commissioning. But hyperscale work puts the most pressure on repeatability, speed, and coordination. Those gaps affect the level of experience, systems knowledge, and commissioning fluency employers look for next.
Hyperscale hiring tends to reward PMs who can show three things without much hand-waving: MEP fluency, tight project controls, and commissioning experience. In practice, that bar comes down to experience, technical depth, and certifications.
Most hyperscale employers look for 7–15 years of construction management experience, plus leadership on $100M+ projects and direct ownership of schedule, budget, and turnover.[17][18]
The smoothest transitions usually come from PMs who have already run MEP-heavy or tightly regulated jobs, such as:
Why do those backgrounds matter so much? Because they already show you can handle dense MEP scope, strict sequencing, and close-out pressure without blinking.
Employers also want proof that you've handled the full project lifecycle, not just field coordination. That includes preconstruction support, procurement, RFIs, submittals, change orders, and closeout. Once you have that base, the next test is simple: can you talk comfortably about power, cooling, and commissioning?
Hyperscale PMs are expected to have working fluency in core data center systems. On the electrical side, that means knowing medium-voltage distribution, switchgear, PDUs, UPS systems, generators, and how redundancy setups like N+1 and 2N change scope, sequencing, and failure response. On the mechanical side, PMs need to understand chilled-water systems, CRAH/CRAC units, economizers, and how cooling design ties back to IT load and PUE targets.
This isn't just theory. It shows up in daily decisions. A PM with solid systems knowledge can sequence work, evaluate substitutions, and protect commissioning milestones without kicking every call to a consultant.
Schedule and cost control matter just as much. Hyperscale owners expect detailed CPM schedules in Primavera P6, updated weekly, with scenario modeling when milestones slip. Cost forecasting, earned-value tracking, and change-order control are standard parts of the job. Common tools include Primavera P6, Procore, Bluebeam, and Microsoft Project.
Certifications help support experience. They don't stand in for it. These are the credentials employers most often use to screen hyperscale PM candidates, along with when they usually make sense to pursue.
The strongest candidates usually combine a delivery credential, a mission-critical credential, and OSHA 30. That way, the profile reads as focused instead of generic.
Getting into data center work is mostly about translation. You need to show how your MEP, controls, and commissioning background fits hyperscale delivery. In most cases, the fastest route is through jobs that already involve MEP systems, sequencing, or commissioning.
The best entry points tend to be roles with strong MEP depth, schedule control, or hands-on commissioning work.
Once that background is in place, the next move is proving it in terms hyperscale teams actually screen for.
A lot of commercial PMs trip up here. They describe projects the way a general contractor would: by trade count, square footage, or delivery method. That’s not enough.
Hyperscale hiring teams usually want four details for each major project: the industry, the phase, your delivery role, and the project scale in dollars, square feet, or MW capacity [19].
Use Ready-for-Service (RFS) language when it fits. Hyperscale owners track RFS dates, not punch list closeout, so using that framing shows you get what matters on the operations side. It also helps to call out commissioning, turnover, and owner-side coordination work and tie it straight to hyperscale delivery. For senior-level candidates, PMP, CDCPM, and PE make a strong credential stack [16].
The top U.S. markets for hyperscale data center PM roles are Northern Virginia, Phoenix, Dallas-Fort Worth, Columbus, Atlanta, Reno, and West Texas.
Hiring comes from a mix of groups:
Across the board, employers tend to look for MEP fluency and commissioning exposure. Pay usually depends on the same core factors: market, employer type, project size, and how much commissioning responsibility sits with the role.

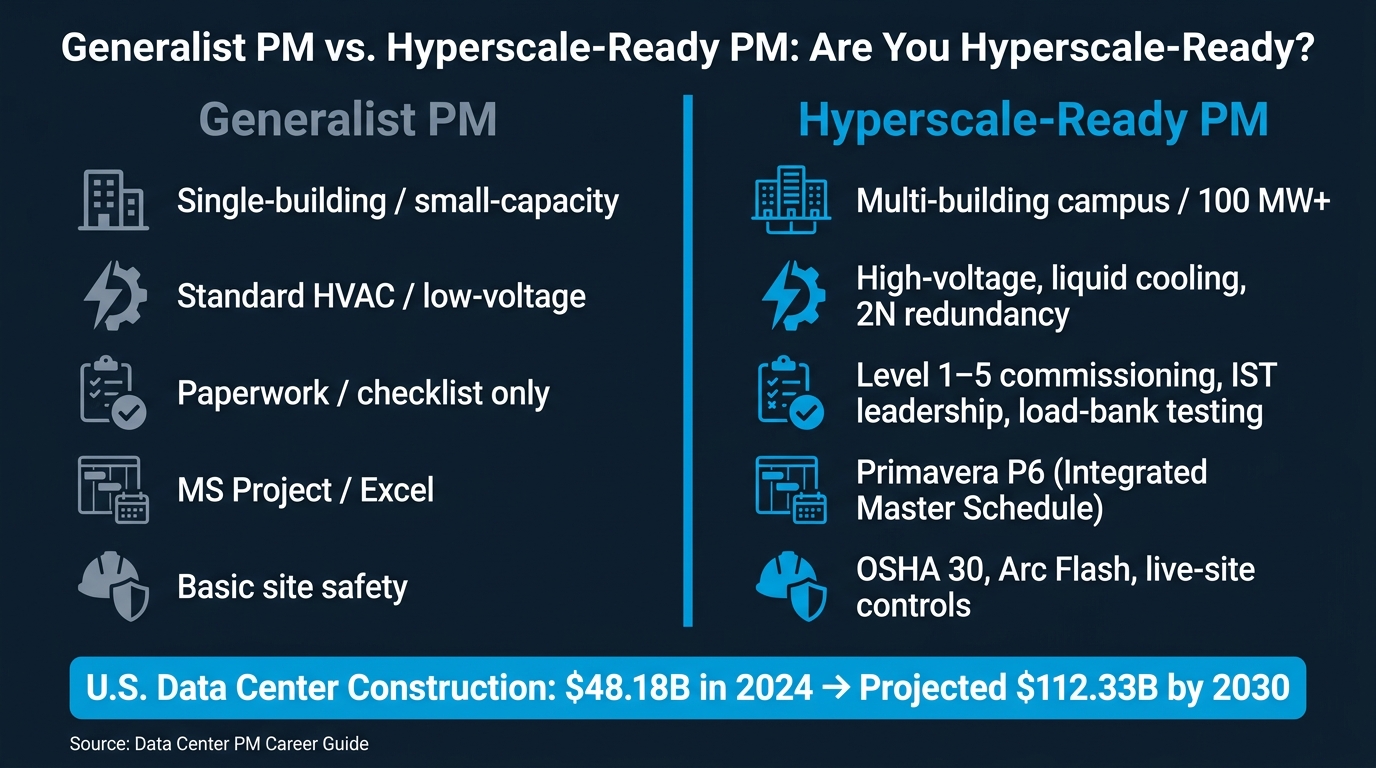

Generalist PM vs. Hyperscale-Ready PM: Key Differences
Once you know where these jobs are and who tends to hire, pay and offer criteria become the last big filters.
Data center PM pay changes a lot by role level. The biggest factors are project scale, usually measured in MW, plus commissioning scope, travel demands, location, and the type of employer.
Completion bonuses show up more often at the senior level. It’s smart to ask when the bonus pays out and which milestones trigger it. That one detail can change the shape of an offer.
Pay follows the same basic logic as fit: scope, commissioning ownership, and project scale.
Recruiters usually want proof that you stayed through commissioning and turnover. Tenure matters, but it’s not enough on its own. The screen often comes down to specifics: MEP-heavy delivery, Level 1–5 commissioning involvement, and experience working under tight schedule pressure. Travel flexibility is often non-negotiable.
Generalist PMs usually get screened out in four main areas:
When you rework your resume, spell out the project phase and MW capacity so your background reads like a hyperscale fit [19].
For commercial and industrial PMs, the next step is translating that background into hyperscale language. Build deeper MEP and commissioning experience, pair credentials with intent - PMP + CDCPM + PE is the strongest senior combination [16] - and shape your resume around the numbers and details that drive both fit and pay: MW capacity, redundancy levels, and your exact delivery role.
Don’t try to jump straight into a lead role. Aim for a bridge role instead, like assistant project manager, project engineer, or owner’s representative coordinator on data center, semiconductor, or healthcare projects.
Then, over the next 6 to 18 months, stack up hands-on experience with MEP-heavy work, commissioning, field decisions, Primavera P6, Procore, and the Level 1–5 commissioning sequence. A certification like CDCPM can also help show that you know this space well.
Hiring managers put the most weight on site-based execution that you can point to and prove. General management background helps, but it usually takes a back seat, especially on ground-up Tier III or Tier IV builds.
What matters most is hands-on work with mission-critical MEP systems, full L1-L5 commissioning and IST, schedule ownership in Primavera P6, and day-to-day control of GMP contracts, OFCI equipment, and change orders tied to the critical path. If you don’t have direct data center experience yet, bridge roles on complex industrial, health care, or semiconductor projects can still be a solid way in.
Focus less on broad commercial construction and put the spotlight on mission-critical work. The strongest version of this section should show direct ownership in regulated, high-uptime settings where failure isn't an option.
Lean into experience such as:
Use the STAR method to make that experience concrete. Set up the situation, explain the task, walk through the actions you led, and then show the result with numbers. For example, instead of saying someone “managed MEP coordination,” show what that looked like in practice: how many trades were involved, what constraint had to be solved, what tools were used, and what changed in the end.
If the person has worked with Primavera P6, BIM, or VDC, make that easy to spot. The same goes for commissioning. Spell out involvement across Level 1 through Level 5, and include Integrated Systems Testing where it applies. That kind of detail tells the reader this person understands more than just installation - they understand how systems get proven in the field.
Certifications should be grouped clearly in one place, especially items like PMP, CDCPM, and PE. Keep that section clean and easy to scan.
And if there is no direct data center background, say so plainly. Don't dance around it. It's better to be direct and then connect nearby experience - like hospitals, pharma, semiconductor, utility, or other high-control settings - to the demands of mission-critical delivery.
