August 22, 2026

Semiconductor Fab Construction Timeline: Groundbreaking to First Wafer

By:
Dallas Bond

If you want a short answer: a U.S. semiconductor fab usually takes 4–7 years from site start to first wafer, and stable production can take another 1–3+ years.

What drives that schedule? I’d boil it down to four things:

  • Phase gates that must clear in order
  • Utility readiness for power, water, gas, and exhaust
  • Cleanroom qualification before tool move-in
  • Labor timing so the right people show up at the right stage

Here’s the simple version:

  • Phase 1: Site prep and base build set the schedule.
  • Phase 2: MEP and process utilities turn a shell into a working facility.
  • Phase 3: Cleanroom sign-off, tool install, and commissioning lead to first wafer.

A few numbers make the point fast:

  • Leading-edge logic fabs often cost $15 billion–$28 billion
  • Off-site power upgrades can take 18–36 months
  • Large switchgear and chillers can run 40–60 weeks in lead time
  • Cleanroom and tool install work can extend the last phase by 12–24 months

The main takeaway is simple: the hiring plan has to follow the build plan. Early work leans on site and structure leaders. Mid-stage work shifts to MEP, controls, and QA/QC. Late-stage work depends on cleanroom, OEM coordination, commissioning, and startup teams.

Phase What happens Typical duration Main gate
Phase 1 Site prep, foundations, steel, dry-in 12–18 months Building dry-in
Phase 2 MEP rough-in, utility systems, subfab fit-up 6–12 months Utility readiness
Phase 3 Cleanroom, tool move-in, hook-up, commissioning 12–24 months First wafer

So if I had to sum up the whole article in one line, it would be this: a fab schedule slips when people treat construction, utilities, cleanroom work, and staffing like separate tracks instead of one linked sequence.

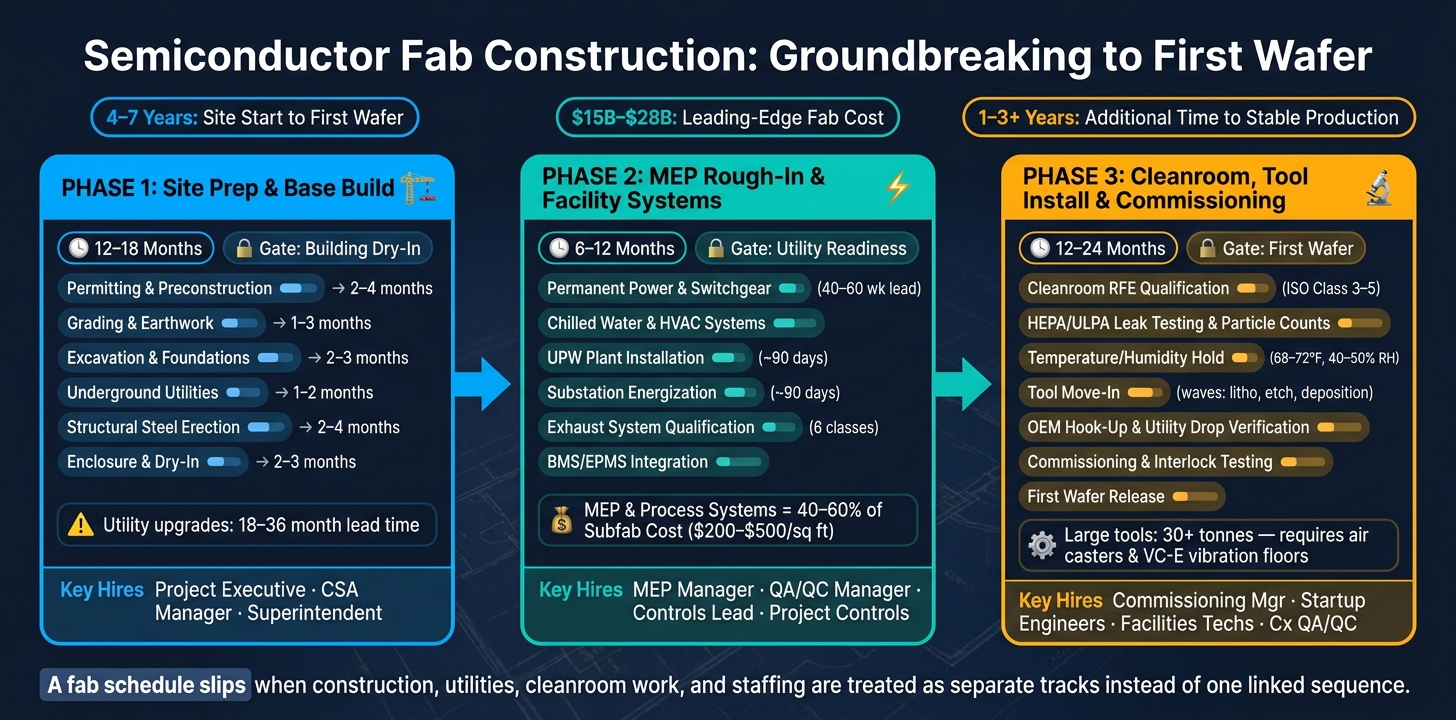

Semiconductor Fab Construction Timeline: From Groundbreaking to First Wafer

Semiconductor Fab Construction Timeline: From Groundbreaking to First Wafer

Building a Semiconductor Fab in 2 Years | Time-Lapse Construction

Phase 1: Site Preparation and Base Build

Phase 1 is where a fab schedule gets set - for better or worse. This is the stage that locks in the structural grid, site access, and utility backbone that every later trade depends on. If dry-in slips, it doesn't just delay interior work. It squeezes cleanroom qualification and pushes first wafer timing too, often by weeks for every month lost. When Phase 1 falls behind, the rest of the fab gets squeezed.

The full run starts at Notice to Proceed (NTP) and goes through building dry-in. On a large fab, that usually takes 6–12 months. And construction doesn't even start right away. Proposed semiconductor plants have to clear state, local, and federal regulatory reviews first.[5] On top of that, environmental permit processes can take 120 days or more on their own.[4] Before crews mobilize, teams need to lock in seismic and vibration surveys, permits, utility commitments, piling, and waffle-slab foundation design.[1]

Phase 1 decisions shape the critical path for the rest of the build.

Key Milestones From Notice to Proceed to Building Dry-In

These milestones aren't just admin steps. Each one either opens the door for the next stage or keeps it shut.

Phase 1 Milestone Typical Duration Key Risk Factor
Permitting & preconstruction 2–4 months (overlapping design) Environmental review, zoning delays, utility service agreements
Grading & earthwork 1–3 months Rock removal, caliche, monsoon/freeze seasons
Excavation & foundations 2–3 months Geotechnical surprises, late design changes for vibration criteria
Underground utilities 1–2 months (overlaps foundations) Routing conflicts, long-lead conduit and duct bank materials
Structural steel erection 2–4 months Fabrication lead times, crane availability
Enclosure & dry-in 2–3 months Roof system lead times, curtainwall design and mockup cycles

Once the shell is dry and the site is stable, the schedule shifts into MEP rough-in and facility systems.

Utility commitments are one of the biggest Phase 1 risks.[5][6] Large fabs can need major electric power capacity, and upstream substation or transmission upgrades often come with 18–36 month lead times. Water rights, discharge agreements, and gas line extensions can move on the same kind of timeline. If utility capacity isn't committed at or before NTP, MEP design can stall and tool power-on dates start slipping.

The strongest project teams deal with that early. They tie utility commitment milestones straight to NTP conditions and put one person in charge of utility coordination, backed by project controls support, to track off-site infrastructure in the master schedule. That's the handoff into Phase 2 planning.

Weather also matters more than people sometimes admit. It's not some small buffer item buried in a contingency note. Teams with experience build weather contingency into the Level 3 schedule using historical data, and they design temporary drainage systems that can handle extreme events.[2][6]

Early Hires That Matter: Project Executive, CSA Manager, Superintendent

The Phase 1 team needs to be in place before field production ramps up. If hiring waits until grading crews are already at full strength, the project is usually behind on sequencing, reporting lines, and cost and schedule control.

The project executive manages the owner relationship and the program schedule. That includes negotiating utility commitments, pushing permit escalations when needed, and making early procurement calls on long-lead structural steel.

The CSA (civil/structural/architectural) manager locks the structural grid and envelope, lines up geotechnical and vibration criteria with the structural engineer, and releases phased bid packages. In many cases, that means issuing a Foundations & Steel Package 1 before the full design is done.

The superintendent runs field sequencing and daily production. That covers crew flow, crane paths, material receiving, and daily output against the schedule baseline. In labor-constrained markets, where multiple megaprojects are fighting for the same ironworkers, equipment operators, and concrete finishers, a superintendent with local craft relationships can make a big difference in mobilization and sequencing.

The Phase 1 team also needs civil and logistics staff in place. They keep access roads, laydown yards, crane paths, and material receiving lined up with the field plan. Those roles need to be active at mobilization.

Phase 2: MEP Rough-In and Facility Systems

Once the building is dried in, Phase 2 moves into coordinated MEP and process rough-in inside a weather-tight shell. This is where the job gets dense, fast. MEP and process systems often make up 40%–60% of subfab cost, or about $200–$500 per square foot of cleanroom area in leading-edge fabs.[7] At that price and pace, loose coordination isn't a small problem. It can throw the whole phase off track.

A fab's stacked layout - utility basement, subfab, cleanroom, and fan deck - creates tight trade dependencies.[8] One delayed package doesn't just affect one crew. It can stall the next system in line and stretch the critical path. Tool readiness gets pushed out. HVAC can't be balanced until electrical feeders are live. UPW loops can't be validated until piping has been flushed and verified. Exhaust systems can't be accepted until each separate class - acid, solvent/VOC, general, heat, ammonia, and pyrophoric/silane - has been tested and proven with flow switches.

Utility and Process Systems That Control Schedule

Permanent power is the first big gate. Large switchgear and centrifugal chillers both come with 40–60 week lead times, so late buying decisions in Phase 1 squeeze the Phase 2 schedule almost immediately.[7] A sample schedule template puts the full facility utilities and abatement group at about 190 days, with UPW plant installation and substation energization each taking about 90 days inside that span.[4]

The sequence is straightforward, even if the field work isn't: power enables mechanical testing, mechanical testing enables environmental conditioning, and environmental conditioning enables process utility readiness. UPW, bulk gases distributed to valve manifold boxes (VMBs), and qualified exhaust systems all need to reach ready-for-hook-up status. Installed is not enough. They have to be ready for tool vendors to use.

Treat BMS and EPMS as core scope, not side work. If points lists or alarm matrices are missing, commissioning stops.

Workforce Ramp: MEP Leaders, QA/QC, and Project Controls

Phase 2 changes the team's job. The focus moves from structural delivery to systems integration, test discipline, and turnover control. Hiring needs to follow the installation sequence because the team has to support the utility sequence in real time.

Role Hiring Window Primary Responsibility
MEP Manager Before Phase 2 mobilization Coordinates overall utility package and installation sequence
Electrical Superintendent At Phase 2 start Manages field execution for power distribution and switchgear
Mechanical Superintendent At Phase 2 start Oversees HVAC, chilled water, plumbing, and process piping crews
Controls Lead Early Phase 2 Integrates BMS/EPMS, verifies points lists and alarm matrices
QA/QC Manager Before rough-in begins Manages pressure testing, leak testing, flushing, and turnover packages
Project Controls / Document Control Concurrent with Phase 2 start Maintains look-ahead planning, cost tracking, submittals, redlines, test records, and turnover packages

If you wait to staff these roles until installation issues start popping up, you've already lost time. At that point, the team usually doesn't have enough bandwidth to manage coordination, catch QA/QC misses, or keep turnover packages clean under deadline pressure. The practical rule is simple: bring in Phase 2 leaders before peak field activity starts, not after the schedule begins to slide.

When these systems turn over, the project moves into cleanroom completion, tool install, and commissioning.

Phase 3: Cleanroom Completion, Tool Install, and Commissioning

Phase 3 is where a build stops looking like a construction project and starts acting like a fab. At this point, every task has to protect tool move-in, hook-up, and startup. A small mistake that might have been workable earlier can now stop tool delivery, delay install, or push back first wafer readiness.

Cleanroom Readiness Before Tool Move-In

Before any equipment comes through the loading dock, the cleanroom has to hit a set of environmental and physical targets. These are often grouped under ready for equipment (RFE) status.[13] This is a hard gate. In most cases, tool vendors will not deliver until the facility meets their install requirements.

Before tool move-in, the cleanroom must reach RFE status. That means finishing HVAC and ductwork, pre-cleaning the space, balancing airflow, checking pressure cascades, leak-testing HEPA/ULPA filters, holding 68–72°F and the required RH, and passing ISO 14644-1 particle counts. In lithography, etch, and deposition bays, the target is often in the ISO Class 3–5 range, while gowning and subfab areas can be less strict.[3]

Once those conditions are steady, the site has to switch from construction protocol to cleanroom protocol. That means full gowning in airlocks, restricted access and badging, and controlled material routes. If that handoff is rushed, a space that just got certified can be contaminated before the first tool even shows up.

At this stage, the schedule leans heavily on the people coordinating cleanroom turnover, commissioning, and OEM activity. That clearance is the gate to tool move-in.

Tool Install and OEM Coordination

Once the cleanroom clears RFE, tool move-in becomes the next item on the critical path. Install usually happens in waves, with lithography, etch, and deposition tools moving in sequence alongside rigging and hook-up work.[1][4]

These are not small pieces of equipment. Large tools often weigh more than 30 tonnes, so they may need air casters or multi-axle dollies, plus clear travel paths with enough door height, turning radius, and overhead clearance.[3] Floor conditions matter too. Slab flatness tolerances are tight, and advanced lithography areas may need vibration performance at VC-E or better.[3][1]

One of the most common causes of delay is utility drops. Every tool needs exact connections for process gases, ultrapure water, vacuum, exhaust, and power. If a drop is in the wrong spot, mislabeled, or not fully ready when the tool arrives, the install crew stops while the facilities team fixes it. And if utilities are still not ready, OEM engineers may demobilize and come back later, which adds cost and eats up schedule.[10][12]

That’s why integrated install planning matters so much. Weekly or biweekly sessions usually bring together OEMs, mechanical and electrical contractors, rigging teams, and operations supervisors to map install sequences, flag constraints, and build detailed install playbooks.[10][1] Then daily stand-ups deal with whatever changed overnight: area conflicts, cleanliness issues, or shifts in priority between tool waves. Good OEM coordination leads keep one delayed tool from jamming the whole line.

Commissioning Gates Before First Wafer

A tool being set in place does not mean first wafer is close. Commissioning is not one final sign-off at the end. It’s a staged process made up of functional testing, interlock checks, and process utility qualification before startup can begin.

Milestone Category Before Tool Move-In Before First Wafer
Cleanroom envelope Complete, sealed, access controlled Stable under operating conditions
Pressure cascades Balanced and verified Continuously monitored and alarm-verified
Filtration and particle counts HEPA/ULPA leak-tested, ISO class qualified Requalified after rigging and hook-up activity
Temperature and humidity Stable at 68–72°F, 40–50% RH Proven stable under full tool load
Rigging and utility drops Paths confirmed, drops positioned and tested Hook-up complete, continuity and purity verified
Controls and interlocks BMS/EPMS point lists complete Alarm matrices, interlock sequences, and failover fully tested
Punch list Pre-move-in checklist signed off Non-blocking items only; critical items closed
Startup readiness Equipment can be received and set Startup teams cleared to release for first wafer or pilot lot

This gate structure also shapes late-stage hiring. Once the building is physically done but still not at first wafer readiness, roles like commissioning managers, Cx agents, startup engineers, facilities technicians, and commissioning QA/QC become central.[9][11][14] If those people are not in place before commissioning starts, teams usually don’t have the capacity to run functional testing, close punch lists, and support OEM startup at the same time.

The practical lesson is the same as in Phase 2: bring these people in before peak activity hits, not after the first gate starts to slip.

Conclusion: Aligning the Build Timeline With Your Hiring Plan

Greenfield fabs often take 28–36 months from permits to production ramp. But that timeline only works when each stage clears in order: shell completion, MEP and process utility turnover, cleanroom qualification, tool install, commissioning, and first wafer.[3][18][4] Your hiring plan needs to follow that same path from day one.

Shell completion only means the building is weather-tight. It does not mean the fab is ready for first wafer. That still depends on qualified utilities, stable HVAC, and cleanroom certification.[3] Those checkpoints should also set the timing for when key people join the team.

The hiring sequence has to match the build sequence. Recent CHIPS-funded projects show how labor gaps can throw the plan off, with skilled labor shortages delaying equipment-install schedules by a year or more.[15][16][17]

Here’s the practical takeaway:

  • Bring in project executives, CSA managers, and superintendents before site work starts.
  • Add MEP leaders, QA/QC, and project controls before rough-in begins.
  • Have commissioning and startup teams in place before cleanroom turnover.

If hiring falls out of step with the build, the schedule won’t hold.

FAQs

What usually causes fab schedules to slip?

Fab schedules usually slip for three reasons: design immaturity, supply chain constraints, and infrastructure delays.

When construction starts before the design is mature, teams often run into rework later. That can throw off sequencing, create clashes in the field, and disrupt MEP installation. It’s the classic case of moving fast early, then paying for it later.

Long-lead tools can also push the schedule out. Missed order windows, export problems, and customs bottlenecks all add time, and not in small doses.

Another common issue is poor early alignment across core systems and site needs. If ultra-pure water systems, grid interconnections, permitting, and labor availability aren’t lined up early, delays tend to show up during cleanroom fit-outs and commissioning, when there’s very little room for error.

When should key hiring happen across the build?

Hire key personnel one phase ahead of when they’ll carry the load. In practice, that means starting recruitment 3 to 6 months before the planned start date and setting aside 60 to 90 days to fill senior technical roles.

Bring in project executives, cost estimators, and schedulers early. Add MEP leaders and commissioning managers during design. Fill field leadership roles 8 to 12 weeks before mobilization. Then hire operations and facilities teams 6 to 9 months before planned completion.

What must be ready before tool move-in?

Before tools can move in, the facility has to finish the base build and pass through the Process Lateral Systems phase. That means tying together the MEP networks that keep the space running, including HVAC, ultrapure water, and gas delivery.

The cleanroom also needs to reach Clean Protocol Level 4. On top of that, crews need vibration-dampened platforms, verified utility hookups, confirmed airflow, and validated tool layouts. In many cases, teams use digital twin modeling to check those layouts before equipment arrives.
