How Defense-Tech Startups Structure Supply Chain Teams (Buyer to Director)

By:
Dallas Bond

I’d hire for the work that has no owner - not the title. Before adding staff, map who handles orders, suppliers, planning, inventory, and risk. Give each task one accountable owner and clear approval limits.

Here’s how I’d separate the 4 roles:

  • Buyer: Places approved orders, tracks deliveries, and flags shortages.
  • Senior Buyer: Manages difficult suppliers, negotiates within set limits, and leads delivery recovery.
  • Supply Chain Manager: Connects purchasing, planning, inventory, and logistics so builds stay on schedule.
  • Director: Sets sourcing plans, allocates capacity across programs, manages budgets, and takes company-level risks to leadership.

Quick Comparison

Role Main focus When I’d add it
Buyer Order execution Orders and follow-up need a dedicated owner
Senior Buyer Supplier performance Long lead times or supplier failures demand more attention
Supply Chain Manager Team coordination Shortages and priority conflicts keep returning to leadership
Director Company-level decisions Programs compete for capacity, cash, or supplier commitments

As production grows, I’d split these responsibilities only when the workload calls for it. More purchase orders alone don’t justify a promotion.

I’d also keep <u>commercial approval separate from technical approval</u>: engineering and quality retain authority over specifications and qualification. Contracts and cybersecurity guide supplier requirements, including rules for FCI, CUI, and CMMC. Hiring and promotion should follow measurable results in delivery, quality, cost, and risk - not titles or headcount.

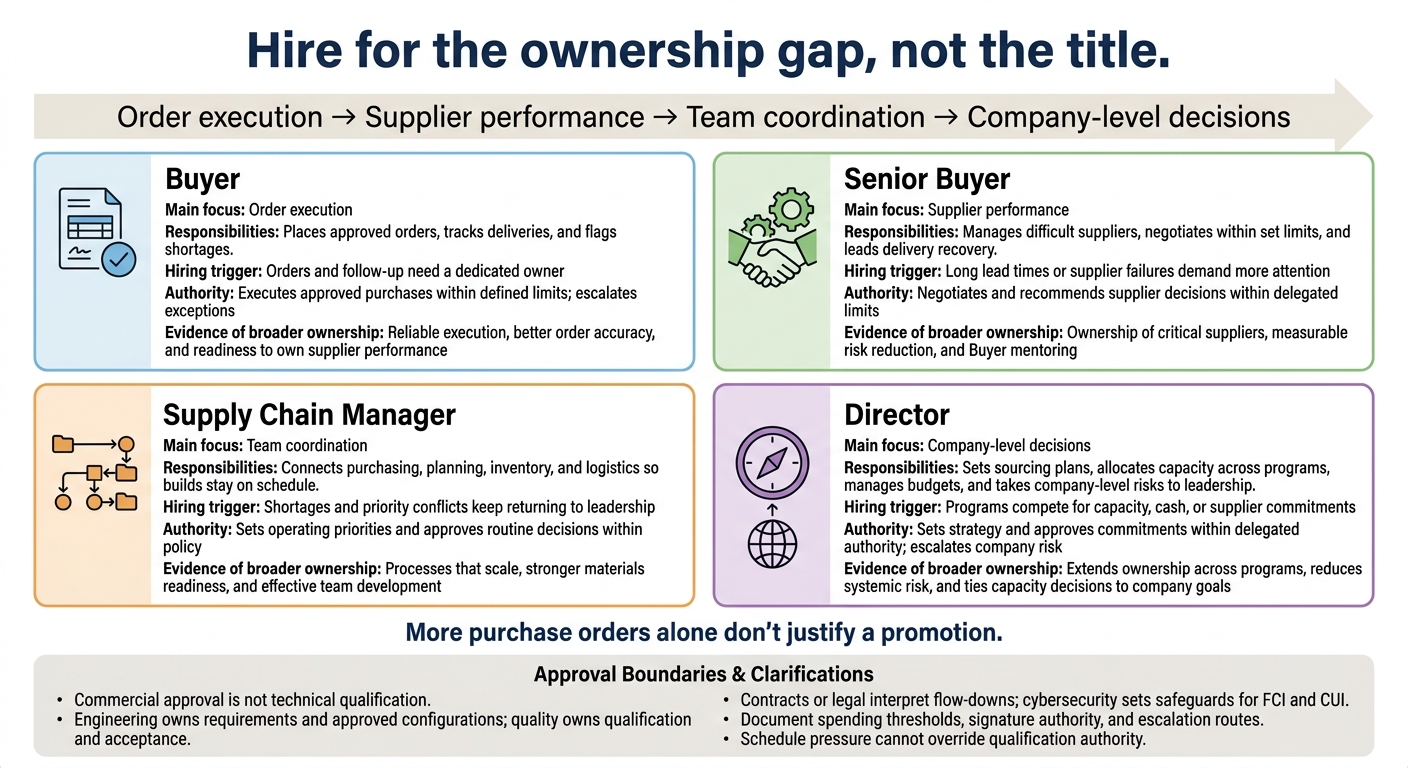

Defense-Tech Supply Chain Roles: Buyer to Director

Defense-Tech Supply Chain Roles: Buyer to Director

Buyer and Senior Buyer: Orders and Supplier Management

As defense-tech teams move from prototype purchases to repeat production, Buyers handle daily purchasing while Senior Buyers own supplier risk. ASCM describes Buyers as purchasing executors and Senior Buyers as owners of complex purchasing, mentoring, and process improvement.[6] Use these descriptions to guide scope - not as fixed title definitions.

Buyer: Place Orders and Flag Shortages

A Buyer works from approved requisitions, bills of materials (BOMs), or MRP recommendations. Before placing an order, check the part number, revision, quantity, need date, approved supplier status, and required documents. Compare qualified quotes, then create and route the purchase order. Unit price is only part of the cost: check freight, minimum order quantities, payment terms, and quote validity, too.

After release, get written acknowledgment, track deliveries, update the ERP, and escalate any order that puts the build schedule at risk.

Put release and negotiation limits in writing, including spending caps and approval exceptions. Engineering owns specifications and substitutions. The Buyer maintains supplier contacts, lead times, payment terms, and onboarding documents. They also route quality, legal, security, and export-control approvals to the teams responsible.

When hiring, test ERP fluency, BOM literacy, and follow-through. Give candidates a mock BOM, three supplier quotes, and an MRP need date. Ask them to identify gaps and write a supplier follow-up email.[6][5][7]

When supplier risk, lead-time pressure, or recovery work exceeds one Buyer’s bandwidth, move those accounts into a Senior Buyer role.

Senior Buyer: Own Complex Supplier Relationships

Add a Senior Buyer when long-lead parts, sole-source exposure, capacity limits, or repeated supplier failures require more than routine Buyer follow-up. Assign a defined supplier portfolio, delegated negotiation authority, alternate-source research, and responsibility for mentoring Buyers.

Track delivery, quality, cost, responsiveness, and capacity separately. Every supplier review should end with actions, owners, and due dates. The Senior Buyer leads commercial recovery; engineering and quality own qualification, technical acceptance, and corrective-action requirements.

The comparison below separates routine purchasing from portfolio-level ownership.

Buyer vs. Senior Buyer: Scope and Hiring Criteria

Purchase-order volume alone does not justify promotion. Look for sustained ownership of supplier performance, sound negotiation judgment, effective coordination across teams, and the ability to mentor another Buyer.

Dimension Buyer Senior Buyer
Scope Approved, repeatable purchases Complex, long-lead, custom, or high-risk purchases
Supplier ownership Individual orders Defined portfolio
Negotiation Routine terms within narrow limits Price, lead time, capacity, and payment terms within delegated limits
Escalation Flags shortages and missed commitments Leads recovery; escalates unresolved risks
Outputs PO accuracy, acknowledgment time, past-due orders, ERP accuracy Supplier delivery, quality, cost improvement, lead-time reduction, capacity coverage
Promotion readiness Independent execution and early escalation Independent portfolio management, documented improvements, and Buyer mentoring

Supply Chain Manager and Director: Team and Company Leadership

Supply Chain Manager: Coordinate Purchasing, Planning, and Inventory

When purchasing requires recurring coordination, the role grows from Buyer to Supply Chain Manager. The Supply Chain Manager coordinates daily work across Buyers, planners, materials staff, and logistics personnel, closing gaps between purchasing, planning, and inventory. They match demand to supplier capacity and work with engineering, quality, finance, and program management.

Set a clear review schedule: daily for shortages, weekly for suppliers and schedules, and monthly for capacity risks. Assign owners for ERP lead times, planning parameters, inventory discrepancies, and purchasing workflows. Track shortage aging, supplier on-time delivery, inventory accuracy, schedule adherence, and expedite spending.

Hire for process improvement - not just ERP familiarity. Ask how the candidate determined whether a shortage was real or caused by a bad BOM, inventory record, or demand signal.

Director: Set Supply Chain Direction and Manage Risk

Add a Director when programs compete for limited capacity or supplier decisions affect cash, customer commitments, and company outcomes. Managers handle daily execution; the Director owns team design, budgets, sourcing strategy, supplier development, capacity, resilience, and make-or-buy decisions. Look for evidence that candidates have built teams, managed budgets, negotiated strategic agreements, and explained cost, capacity, and delivery tradeoffs.

As defense-tech production scales, these decisions affect delivery commitments and program risk. Keep technical ownership separate: quality owns qualification and acceptance, while engineering owns requirements and approved configurations. Supply chain builds source records, traceability, and counterfeit-part controls into purchasing and receiving.[12][13]

Contracts or legal interpret flow-downs. Cybersecurity sets safeguards for Federal Contract Information (FCI) and Controlled Unclassified Information (CUI). DoD CMMC obligations depend on the solicitation, contract, information, and systems - not startup size.[9] Confirm the required NIST SP 800-171 version and assessment scope before awarding work to suppliers.[8][10][11]

Decision Rights: Who Executes, Recommends, and Approves

Use the matrix below to separate execution, recommendation, and approval as the team grows. Document spending thresholds, signature authority, and escalation routes. Commercial approval is not technical qualification, and the Director should not become an approval bottleneck for every order.

Decision Executes Recommends Approves Consults
Routine purchasing within approved budget Buyer or Senior Buyer Supply Chain Manager Delegated budget owner Finance, requester
Transactional supplier selection Buyer or Senior Buyer Supply Chain Manager Delegated procurement authority Engineering, quality
Long-term sourcing commitments and supplier agreements Director Director Executive, finance, and legal authorities under company policy Engineering, quality, program management, cybersecurity
Technical supplier qualification Quality or engineering Quality lead Authorized quality or engineering approver Supply chain, manufacturing
Inventory policies and safety stock Planner or manager Supply Chain Manager Operations executive or finance, according to policy Manufacturing, program management
Capacity commitments to customers Supply Chain Manager or Director Director Executive or program authority Manufacturing, finance, sales, program management
Alternate-source approval Supply Chain Manager or Director Director Engineering and quality for technical approval; executive for commercial approval Legal, contracts, cybersecurity
Risk acceptance Risk owner Director or functional leader Executive accountable for the affected program or business outcome Quality, legal, cybersecurity, finance
Compliance escalation Any employee Compliance, contracts, or cybersecurity lead Authorized compliance or executive authority Supply chain, quality, legal, customer representatives
Capital or headcount request Manager or Director Director or operations executive Executive team or board under governance rules Finance, HR, engineering, program management

Supply Chain Team Structures From Prototype to Production

Split roles based on ownership gaps, not headcount. Add people when supplier qualification, shortages, competing programs, or customer delivery risk become too much for one owner to handle.

As decision rights expand, the team structure needs to keep pace.

Stage Structural change Reporting lines Decision boundaries Key risks
Prototype Buyer handles execution with basic operations oversight Buyer reports to the founder or operations leader Leadership keeps commercial approval authority; engineering and quality keep technical approval authority Undocumented inventory, long-lead surprises, single-source dependence
Production ramp Add owners for recurring supplier and materials work Senior Buyer and planner or materials owner report to operations or a Supply Chain Manager Manager recommends sourcing and allocation; executives approve major commercial exposure Recurring shortages, capacity constraints, inaccurate planning signals, competing program priorities
Scaled production Dedicated functions report to a Director Functional leads report to the Director; supplier quality may report directly or through a matrix relationship to quality Director works within delegated authority; executives approve major contracts, capital, and risk acceptance Cross-program competition, sub-tier concentration, qualification delays, insufficient capacity

Prototype Stage: Buyer With Operations Oversight

One Buyer handles orders and expediting, while operations owns planning and inventory. The founder or operations leader handles supplier approvals and commercial approvals outside normal limits. Assign these owners before the first build. Add a Senior Buyer or materials owner when those responsibilities start competing for attention.

Production Ramp: Add Supplier and Materials Owners

Add a Senior Buyer to manage constrained suppliers. Assign a planning or materials owner when shortages recur or multiple programs compete for inventory.

Review shortages and suppliers weekly - or more often during constrained builds. Every shortage needs a required date, a recovery action, and an owner.

Add a Supply Chain Manager when priority decisions repeatedly fall back to operations leadership. As those issues recur, divide the work into dedicated functions under one manager.

Scaled Production: Separate Functions Under a Director

Give procurement, planning, materials, and logistics dedicated leads only when the workload supports it. Document supplier quality’s reporting line. Schedule pressure cannot override qualification authority.

Before increasing production commitments, require proof of supplier qualification, tooling and process readiness, capacity, and quality controls.

Hire a Director when several programs need shared capacity decisions and risk escalation becomes a bottleneck - not simply because headcount has grown.

Conclusion: Hire for the Gap in Ownership

Hire for the ownership gap, not the title.

Assign One Accountable Owner to Each Responsibility

Use the same ownership map to decide who to hire next.

  • Audit: purchasing, supplier qualification and performance, planning, inventory, shortages, logistics, approvals, and escalation.
  • Record: one accountable owner, contributors, an approver, a backup, and an escalation point.
  • Flag: responsibilities with no owner or competing owners, plus approvals that hold up routine work.

Match the hire to the gap. Order backlogs call for more execution capacity. Complex suppliers need deeper supplier-management skills. Disconnected functions need coordination, while company-level risk needs leadership.

Turn Role Responsibilities Into Hiring and Promotion Criteria

Turn the ownership map into hiring scorecards and promotion gates. Ask candidates for starting and ending metrics, the timeframe, specific decisions they made, and their approval limits.

Weigh cost improvements against delivery, quality, and risk. Promotion should reflect broader ownership - not just more transactions.

Role Authority Promotion evidence
Buyer Executes approved purchases within defined limits; escalates exceptions Reliable execution, better order accuracy, and readiness to own supplier performance
Senior Buyer Negotiates and recommends supplier decisions within delegated limits Ownership of critical suppliers, measurable risk reduction, and Buyer mentoring
Supply Chain Manager Sets operating priorities and approves routine decisions within policy Processes that scale, stronger materials readiness, and effective team development
Director Sets strategy and approves commitments within delegated authority; escalates company risk Extends ownership across programs, reduces systemic risk, and ties capacity decisions to company goals

FAQs

Which supply chain role should we hire first on a tight budget?

On a tight budget, one hire can cover both Sourcing Engineer and Buyer responsibilities. A Sourcing Engineer typically handles technical decisions, including make-versus-buy choices and supplier selection. A Buyer manages purchase orders, expediting, and supplier follow-up.

Build the role around the work you need done, then choose a title that fits your organization. You don't need to hire several specialists right away.

How do we know when combined roles need separate owners?

In lean, early-stage teams, one person often handles both buying and planning, or sourcing and purchasing [1][2][3][4]. Assign separate owners as the team shifts to rate-based production [3], or when purchase order volume, SKU counts, specialized supplier development, or delivery follow-up become too much for one person to control while keeping production on schedule [2][3][4].

How can we verify a supplier’s cybersecurity readiness?

Include CMMC flow-down requirements in every purchase order [1]. Check that the supplier has documented compliance with these standards and other defense-specific requirements, such as ITAR and DFARS [1][2].

For critical programs, contract language alone isn’t enough. Confirm that these flow-down requirements are actively managed and verified as part of the supplier’s overall compliance and readiness assessment [1][2].

Related Blog Posts

Keywords:
defense supply chain, startup supply chain, procurement roles, buyer senior buyer, supply chain manager, director of supply chain, supplier risk, procurement hiring
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

RF Engineer Hiring in Defense Tech: Radar, EW and the Clearance Question
October 6, 2026

RF Engineer Hiring in Defense Tech: Radar, EW and the Clearance Question

Set 90‑day deliverables, apply a 100‑point RF scorecard, and match skills, clearance, and lab readiness for radar, antenna, RF, or EW hires.
Propulsion Engineer Career Path: From Test Stand to Chief Engineer
October 6, 2026

Propulsion Engineer Career Path: From Test Stand to Chief Engineer

Four-stage ownership roadmap for propulsion engineers: from safe test execution and design verification to program-level chief engineer responsibility.
Technical Program Manager vs Project Manager in Defense Hardware: What Changes
October 6, 2026

Technical Program Manager vs Project Manager in Defense Hardware: What Changes

Contrast TPM and PM duties in defense hardware: technical readiness vs contracted delivery, with hiring and authority checks.
Integration and Test Engineers: The Hire That Decides Whether Your First Article Ships
October 6, 2026

Integration and Test Engineers: The Hire That Decides Whether Your First Article Ships

Hire integration and test engineers who take shipment ownership - not just run tests.
