October 6, 2026

Technical Program Manager vs Project Manager in Defense Hardware: What Changes

By:
Dallas Bond

I separate these roles by what they own: a TPM coordinates technical readiness; a project manager controls scope, cost, schedule, and delivery. Before hiring either, I check who can approve designs, fund recovery work, and change customer commitments - not just the job title.

Both roles work across development, integration, qualification testing, and production. But coordinating a decision is not the same as approving it. In U.S. defense acquisition, a program manager has broader accountability than a project manager.

Quick Comparison

What I compare Technical Program Manager Project Manager
Main focus Requirements, interfaces, configuration, and test results Scope, budget, staffing, schedule, and delivery
Suppliers Technical data, qualification, and defect closure Procurement, costs, delivery dates, and recovery plans
Production handoff Design maturity and readiness records Materials, labor, capacity, and promised quantities
Approval limits Works within delegated technical authority Works within delegated budget and contract authority
Hiring checks Integration results, test closure, and production readiness Forecast accuracy, supplier recovery, and delivery results

My hiring rule: <u>check what the candidate personally owned and who approved the work</u>. I use a 1–5 scorecard and ask for specific results before awarding a 4 or 5. Construction experience or a PMP credential alone does not prove defense-hardware experience.

Role Scope: Technical Readiness vs. Project Delivery

Assign responsibility before title. Define each role’s authority with the comparison below before writing the job description or evaluating candidates.

Responsibility Technical Program Manager Project Manager
Lifecycle scope Coordinates engineering maturity from requirements through production transition. Manages the project plan from authorization through delivery and closeout.
Technical ownership Coordinates technical work, dependencies, risks, and readiness evidence; does not normally approve the design independently. Ensures technical work supports delivery commitments but normally relies on engineering authorities for design approval.
Budget Identifies technical funding needs, estimates how design choices affect costs, and escalates technical cost risks. Owns or controls the project budget, forecasts, staffing plan, and cost performance.
Schedule Maintains technical dependency logic, review gates, test readiness, and engineering critical-path inputs. Owns the integrated master schedule, milestones, critical path, recovery plans, and customer dates.
Customer commitments Turns customer needs into traceable technical objectives and flags feasibility or verification concerns. Manages formal reporting, contractual milestones, deliverables, changes, and commitment tracking.
Supplier coordination Coordinates supplier technical data, interfaces, qualification evidence, and nonconformance closure. Coordinates supplier procurement, statements of work, delivery dates, commercial risks, and performance escalation.
Delivery accountability Accountable for technical readiness and evidence that the hardware can move to the next gate. Accountable for delivering the agreed scope within authorized cost, schedule, quality, and contract constraints.

Shared work still needs named owners. Link each technical risk to the requirement, test, schedule activity, and cost account it affects - and name its mitigation owner.

TPM Ownership of Engineering Coordination and Readiness

The differences between these roles become clearest during development, integration, qualification, and production handoff.

The TPM connects requirements traceability, architecture, interface control, and hardware–firmware–software dependencies. Outputs include a requirements traceability matrix, interface control documents, a technical risk register, and a design-review action log. Configuration management keeps drawings, firmware, software, and test procedures aligned with the approved baseline.[2][3]

During qualification, the TPM coordinates test-article configuration, verification coverage, approved procedures, and failure closure. For production transition, the TPM brings manufacturing, quality, reliability, supply chain, and configuration-management teams together to establish readiness evidence. Gates may include a Test Readiness Review, System Verification Review, Production Readiness Review, and physical or functional configuration audits.[4][5][6]

PM Ownership of Scope, Cost, Schedule, and Delivery

The PM turns authorized work into a work breakdown structure, work packages, an integrated master schedule, a budget, and a staffing plan. The schedule must connect dependencies - not just list dates - and cover the contract through completion.[7]

Working with engineering, procurement, finance, quality, manufacturing, suppliers, and contracts, the PM tracks critical-path changes, risks, actual costs, forecasts, customer reporting, and deliverables. Internal work can shift within delegated limits. Contract changes require authorized contracts personnel and customer approval.

TPM and PM Duties Across the Hardware Lifecycle

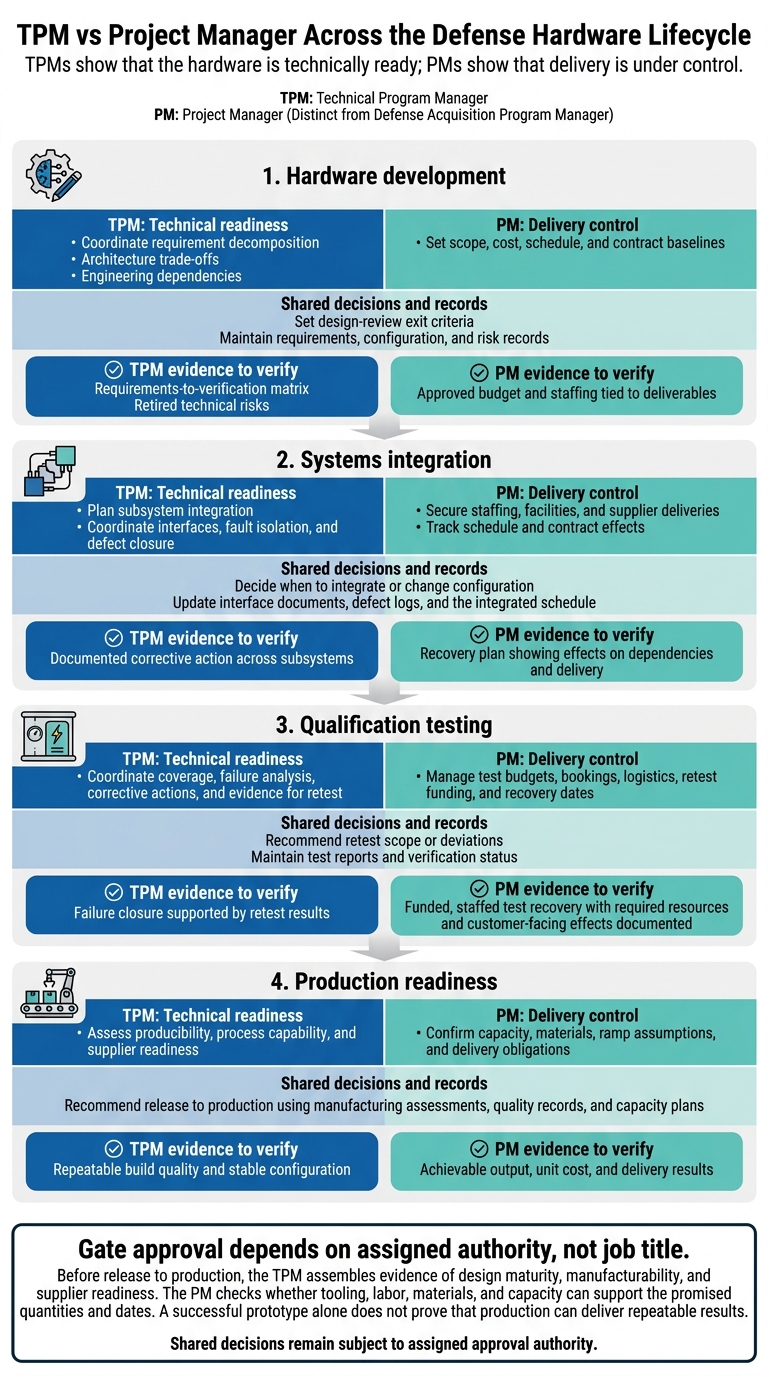

TPM vs Project Manager Across the Defense Hardware Lifecycle

TPM vs Project Manager Across the Defense Hardware Lifecycle

Across the hardware lifecycle, TPMs show that the hardware is technically ready; PMs show that delivery is under control. The table below shows how those duties shift from design to production.

Lifecycle stage TPM duties PM duties Shared decisions and records Proof of relevant experience
Hardware development Coordinate requirement decomposition, architecture trade-offs, and engineering dependencies. Set scope, cost, schedule, and contract baselines. Set design-review exit criteria; maintain requirements, configuration, and risk records. TPM: Requirements-to-verification matrix and retired technical risks. PM: Approved budget and staffing tied to deliverables.
Systems integration Plan subsystem integration; coordinate interfaces, fault isolation, and defect closure. Secure staffing, facilities, and supplier deliveries; track schedule and contract effects. Decide when to integrate or change configuration; update interface documents, defect logs, and the integrated schedule. TPM: Documented corrective action across subsystems. PM: Recovery plan showing effects on dependencies and delivery.
Qualification testing Coordinate coverage, failure analysis, corrective actions, and evidence for retest. Manage test budgets, bookings, logistics, retest funding, and recovery dates. Recommend retest scope or deviations; maintain test reports and verification status. TPM: Failure closure supported by retest results. PM: Funded, staffed test recovery with required resources and customer-facing effects documented.
Production readiness Assess producibility, process capability, and supplier readiness. Confirm capacity, materials, ramp assumptions, and delivery obligations. Recommend release to production using manufacturing assessments, quality records, and capacity plans. TPM: Repeatable build quality and stable configuration. PM: Achievable output, unit cost, and delivery results.

Hardware Development and Systems Integration

During development and integration, TPMs protect the technical baseline. PMs protect the delivery plan.

Integration sequencing must follow readiness - not facility availability. The TPM coordinates testable subsystem requirements and confirms interface compatibility, prerequisite tests, and defect dispositions. The PM turns those conditions into funded, staffed schedule activities and checks how changes affect customer commitments.

Both roles work from the same requirements matrix, configuration baseline, integrated schedule, and risk register. Before the team commits to revised dates, a design change should be reflected in every affected record.

Qualification Testing and Production Readiness

Later, the work shifts from proving performance to proving repeatability and readiness to ramp production.

Verification proves requirements, validation proves intended use, and qualification proves performance under specified conditions. The TPM coordinates coverage, failure analysis, and corrective-action evidence. The PM secures test funding, logistics, capacity, and recovery schedules.

Gate approval depends on assigned authority, not job title. Before release to production, the TPM assembles evidence of design maturity, manufacturability, and supplier readiness. The PM checks whether tooling, labor, materials, and capacity can support the promised quantities and dates. A successful prototype alone does not prove that production can deliver repeatable results.

Decision Rights, Accountability, and Hiring Criteria

Once duties are mapped, define who can approve technical decisions and delivery commitments. Assign decision authority, not job titles. Record who recommends, approves, executes, and consults, along with the delegation limits for each approval. Use that same map to guide hiring.

Template only; align it with the contract, delegation letters, technical authority framework, and internal procedures.

Activity TPM PM Systems engineer Chief engineer Manufacturing Quality Supply chain Customer / contracting authority
Requirements Coordinates technical closure and tracks dependencies Owns program alignment, resources, and commitments Leads requirement allocation and verification logic Approves the technical approach within delegation Advises on producibility Advises on acceptance requirements Identifies supplier constraints Controls contractual requirements when authorized
Design approval Coordinates review actions Ensures schedule and resources Recommends technical approval Exercises delegated design authority Confirms manufacturability Assesses compliance effects Confirms supplier readiness Approves where the contract requires
Testing Coordinates readiness and closure Controls test budget and recovery dates Evaluates verification results Determines technical disposition Supports test-article readiness Controls nonconformance records Coordinates supplier test evidence Witnesses, reviews, or accepts results when required
Change control Coordinates impact analysis Sponsors change governance Assesses verification effects Approves technical changes within delegation Assesses tooling effects Assesses inspection effects Assesses supplier cost and lead-time effects Approves contractual or customer-controlled baseline changes
Supplier performance Integrates supplier technical risks Owns commercial escalation Reviews supplier technical outputs Resolves technical disputes Validates production capability Manages supplier quality actions Owns purchase orders and supplier recovery Exercises contractual remedies when authorized
Production release Coordinates readiness evidence Owns release resources and commitments Confirms verification traceability Approves technical readiness within delegation Confirms process and capacity readiness Confirms acceptance readiness Confirms material readiness Provides required contractual acceptance
Delivery Coordinates open technical actions Owns delivery commitments Supports configuration questions Resolves technical exceptions Ensures shipment readiness Confirms release records Coordinates logistics execution Accepts deliverables

Use the matrix to keep technical disposition separate from contract authority.

Resolve Technical, Cost, and Schedule Conflicts

Hypothetical qualification failure: A defense electronics enclosure exceeds its allowable temperature after thermal cycling. The PM forecasts a 3-week redesign plus 2-week retest at $180,000, potentially moving delivery by 5 weeks. A material substitution is forecast at $45,000, but requires customer approval and introduces supply risk.

A recovery proposal is not permission to execute it. The chief engineer or delegated technical authority approves the technical disposition. Quality controls nonconformance treatment. The PM proposes funded recovery dates, but only the contracting authority can change contractual delivery commitments.

Under FAR rules, only contracting officers acting within their authority execute government contract modifications. Neither TPM nor PM status replaces delegated design, release, or contractual authority.[8][9] These approval boundaries should also guide candidate scoring.

Compare Candidates With a Role-Specific Scorecard

Evaluate authority candidates have actually exercised in defense hardware - not just general management experience. Score each criterion 1–5, and require specific evidence for a 4 or 5. Ask what candidates personally owned, who approved the decision, and which record proves the outcome.

Accept redacted summaries rather than sensitive program documents. For candidates moving from construction to hardware, probe integration, configuration control, and test closure. A PMP credential does not prove design authority, systems engineering skills, qualification experience, or production-release authority.

Criterion TPM evidence PM evidence
Technical ownership Personally owned technical decisions with documented outcomes Technical impacts reflected in approved delivery forecasts
Execution control Measured reduction in unresolved integration issues Forecast accuracy and milestone recovery results
Decision authority Documented engineering, quality, and configuration approval paths Documented escalation and contractual authorization
Defense experience Evidence accepted against applicable qualification standards Contract execution results and earned-value performance where applicable
Supplier coordination Accepted corrective actions attributable to the candidate Measurable recovery of supplier cost or delivery performance
Production transfer Readiness recommendation supported by acceptance records Ramp commitments supported by actual output and delivery results

Match Career Goals and Job Requirements

TPM work centers on engineering integration and readiness. PM work centers on contract and delivery control. Match the role to the lifecycle stage and authority level, not the title.

Use a job-description checklist that covers:

  • Lifecycle phase, engineering authority, and budget and schedule ownership.
  • Customer and supplier interfaces, applicable standards, and quality systems.
  • Security rules, configuration management, required test experience, and role-specific security eligibility.
  • Measurable success criteria.

Before combining responsibilities on a small team, state what the person owns and what must be escalated. Define success through qualification closure, forecast accuracy, supplier recovery, or on-time delivery - not “cross-functional leadership.”

Conclusion: Hire for Responsibilities, Not Titles

Once roles and authority are clear, hire for responsibilities - not titles. Neither title grants approval authority. Both require explicit decision rights across engineering, manufacturing, quality, suppliers, and customers.

Screen for technical readiness and delivery control. Check which responsibilities candidates owned, the interfaces they managed, their decision authority, their lifecycle coverage, and the outcomes they delivered. Before making an offer, assign each must-have responsibility to a named owner. If technical readiness, delivery commitments, supplier execution, or customer escalation lacks a clear owner, the gap may be in the role design - not just the candidate search.

Apply this standard especially carefully to candidates from outside defense hardware. Construction or other project-based experience does not, by itself, qualify someone for defense-hardware work. Verify domain-specific execution in requirements, configuration management, systems engineering, qualification testing, production readiness, quality processes, and customer/government acceptance.

FAQs

When should a defense hardware team hire both roles?

Hire both when the program is too complex for one person to own engineering execution and contract management. A Hardware Program Manager (HPM) owns the contract: cost, schedule, technical performance, EVM reporting, margin, and the transition to production. A Technical Program Manager (TPM) brings design, software, and test workstreams together under a technical plan [1].

On smaller teams, one person may fill both roles. Hire separately when the workload exceeds what one person can handle [1].

How can I transition from PM to TPM in defense hardware?

Moving from Project Manager (PM) to Technical Program Manager (TPM) means shifting your focus from contracts and business administration to technical integration across design, software, and testing.

Show your engineering knowledge, ability to lead cross-functional teams, and fluency with tools like P6 or MS Project. Build hands-on experience with SRR, PDR, and CDR milestones. Lead technical workstreams that put you in charge of dependencies, risks, and bringing engineering decisions together across teams.

How should TPMs and PMs resolve conflicting priorities?

TPMs and PMs should work within defined roles, contract requirements, and governance rules. The PM owns the contract, cost, schedule, and customer performance and is accountable for program-level decisions. The TPM drives engineering execution.

Check the contract, delegation matrix, or quality plan to confirm who has decision authority. Base decisions on objective evidence, and escalate schedule or technical issues early and openly. Keep technical assessment, quality verification, and program acceptance separate.

Related Blog Posts

Keywords:
Technical Program Manager, Project Manager, defense hardware, TPM vs PM, production readiness, qualification testing, decision authority, systems engineering
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

RF Engineer Hiring in Defense Tech: Radar, EW and the Clearance Question
October 6, 2026

RF Engineer Hiring in Defense Tech: Radar, EW and the Clearance Question

Set 90‑day deliverables, apply a 100‑point RF scorecard, and match skills, clearance, and lab readiness for radar, antenna, RF, or EW hires.
Propulsion Engineer Career Path: From Test Stand to Chief Engineer
October 6, 2026

Propulsion Engineer Career Path: From Test Stand to Chief Engineer

Four-stage ownership roadmap for propulsion engineers: from safe test execution and design verification to program-level chief engineer responsibility.
How Defense-Tech Startups Structure Supply Chain Teams (Buyer to Director)
October 6, 2026

How Defense-Tech Startups Structure Supply Chain Teams (Buyer to Director)

Assign clear ownership for buying, planning, inventory, and supplier risk; hire Buyer to Director roles as gaps appear.
Integration and Test Engineers: The Hire That Decides Whether Your First Article Ships
October 6, 2026

Integration and Test Engineers: The Hire That Decides Whether Your First Article Ships

Hire integration and test engineers who take shipment ownership - not just run tests.
