Integration and Test Engineers: The Hire That Decides Whether Your First Article Ships

By:
Dallas Bond

I’d hire for shipment ownership - not just test execution. Before making an offer, I’d verify that the candidate has helped ship a first production unit by checking interfaces, resolving failures, and preparing acceptance records.

My checklist covers 3 gates: test readiness, defect closure, and release approval. To assess candidates, I’d use:

  • A 100-point scorecard, with first-article ownership, interface checks, and failure diagnosis each weighted at 15%.
  • Interviews and a failure exercise that test personal decisions, configuration control, troubleshooting, and record quality.
  • References that confirm shipment results and judgment under schedule pressure.
  • A recruiter brief that states the role’s scope, deadlines, required records, and release approver.

The distinction I’d keep clear: passing tests is not permission to ship. <u>The engineer prepares the test records; the designated authorities approve release.</u>

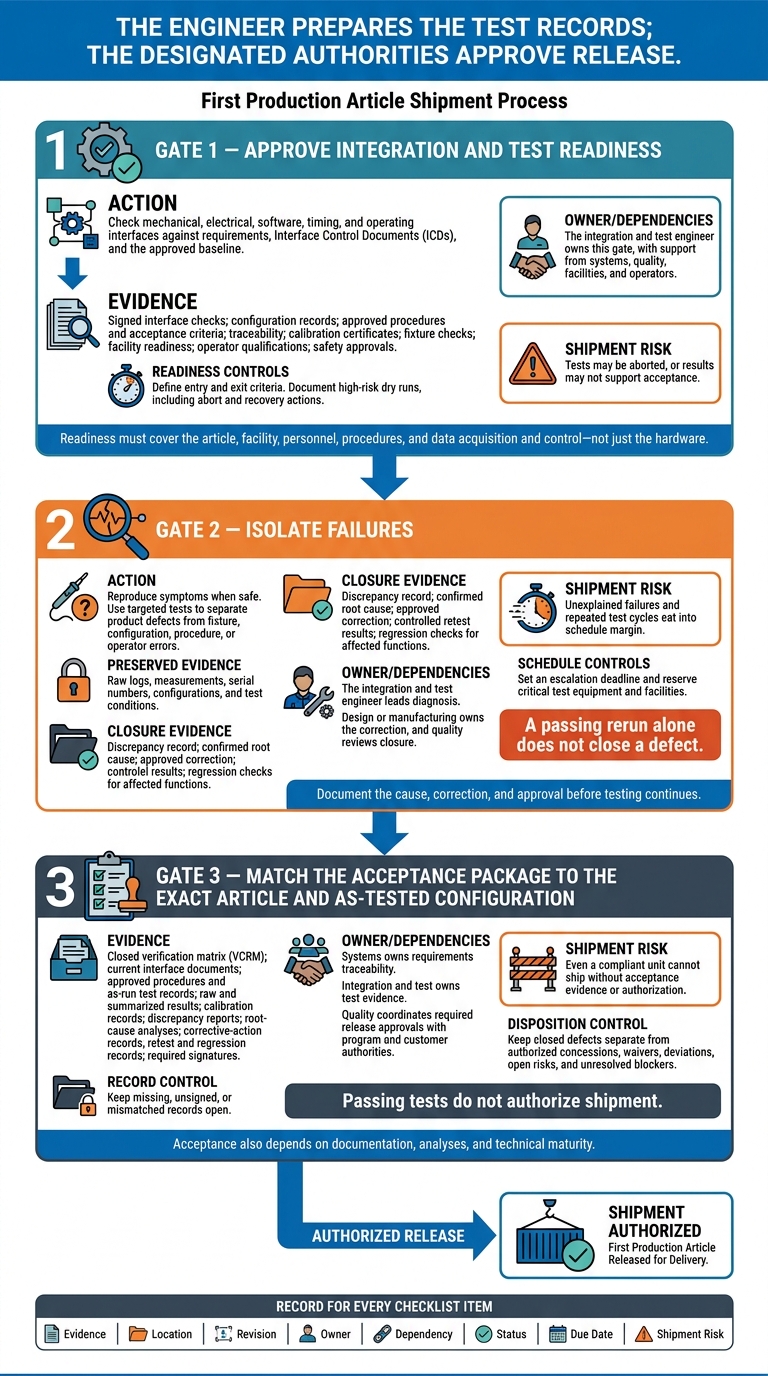

First-Article Delivery Checklist: From Integration to Release

First-Article Shipment: Three Release Gates

First-Article Shipment: Three Release Gates

Put ownership to work: confirm readiness, isolate failures, and complete release records before the first article ships.

Use three gates: readiness, failure closure, and release authorization. For each item, record the evidence, its location and revision, owner, dependency, status, due date, and shipment risk. Start with interface readiness so issues don’t stall shipment.

Verify Interfaces and Confirm Test Readiness

Gate 1: Approve integration and test readiness. Check mechanical, electrical, software, timing, and operating interfaces against requirements, Interface Control Documents (ICDs), and the approved baseline.

Evidence: Signed interface checks, configuration records, approved procedures and acceptance criteria, traceability, calibration certificates, fixture checks, facility readiness, operator qualifications, and safety approvals. Define entry and exit criteria. Document high-risk dry runs, including abort and recovery actions.

Owner/dependencies: The integration and test engineer owns this gate, with support from systems, quality, facilities, and operators.

Shipment risk: Tests may be aborted, or results may not support acceptance. Readiness must cover the article, facility, personnel, procedures, and data acquisition and control - not just the hardware.[4][5]

Isolate Failures and Verify Defect Closure

Gate 2: Isolate failures. Reproduce symptoms when safe. Use targeted tests to separate product defects from fixture, configuration, procedure, or operator errors.

Evidence: Preserve raw logs, measurements, serial numbers, configurations, and test conditions. Include the discrepancy record, confirmed root cause, approved correction, controlled retest results, and regression checks for affected functions.

Owner/dependencies: The integration and test engineer leads diagnosis. Design or manufacturing owns the correction, and quality reviews closure.

Shipment risk: Unexplained failures and repeated test cycles eat into schedule margin. Set an escalation deadline and reserve critical test equipment and facilities. A passing rerun alone does not close a defect. Document the cause, correction, and approval before testing continues.[3][8]

Complete Acceptance Records and Obtain Shipment Approval

Gate 3: Match the acceptance package to the exact article and as-tested configuration.

Evidence: Include the closed verification matrix (VCRM), current interface documents, approved procedures and as-run test records, raw and summarized results, calibration records, discrepancy reports, root-cause analyses, corrective-action records, retest and regression records, and required signatures. Keep missing, unsigned, or mismatched records open.

Owner/dependencies: Systems owns requirements traceability. Integration and test owns test evidence. Quality coordinates required release approvals with program and customer authorities.

Shipment risk: Even a compliant unit cannot ship without acceptance evidence or authorization. Keep closed defects separate from authorized concessions, waivers, deviations, open risks, and unresolved blockers. Passing tests do not authorize shipment. Acceptance also depends on documentation, analyses, and technical maturity.[2][6][7]

Candidate Evaluation Checklist: Score Delivery Experience

Use a 100-point scorecard and evaluate every candidate against the same evidence - not resume length or interview performance. Set the weights before interviews. Have panel members score independently before discussing results.[9][10]

Weight Skills That Affect Shipment

Use D = demonstrated (2), PD = partially demonstrated (1), and ND = not demonstrated (0). D requires a specific example the candidate personally owned, supported by evidence and a shipment result. PD means relevant participation without proof of full ownership or an outcome. ND covers vague, theoretical, team-level, or unsupported answers.

Record evidence, not impressions. Use the lowest-scoring areas to guide follow-up interview questions.

Evaluation area Weight Required evidence Rating Interviewer notes
First-article ownership 15% Personally led an integrated article through formal acceptance and shipment D / PD / ND Personal decisions, acceptance and shipment results
Interface verification 15% Identified and closed shipment-blocking interface risks against defined requirements D / PD / ND Risk found, closure evidence
Test readiness 10% Built or reviewed readiness criteria and the decision to proceed or stop D / PD / ND Aborts prevented, readiness decision
Failure diagnosis 15% Isolated root causes efficiently using logs, measurements, or controlled tests D / PD / ND Diagnostic evidence, cause, correction
Defect closure 10% Managed defects through correction, retest, and formal closure D / PD / ND Retest scope, closure approval
Configuration management 10% Controlled article and test configurations through acceptance D / PD / ND Baselines, approved changes, traceability
Verification documentation 10% Produced complete, reviewable test and release records D / PD / ND Release-ready evidence
Cross-functional execution 5% Coordinated engineering, quality, manufacturing, and external owners to clear shipment blockers D / PD / ND Blockers resolved, responsibilities clarified
Schedule judgment 5% Protected release criteria under schedule pressure D / PD / ND Proceed, pause, or escalate decision
Communication 5% Clearly communicated failures, shipment risks, and release recommendations D / PD / ND Timeliness, clarity, audience fit

Calculate each contribution as weight × rating ÷ 2, then add the results for a score out of 100.

Apply a separate minimum gate: a high total alone cannot offset an ND in first-article ownership, failure diagnosis, configuration management, or verification documentation. Resolve those gaps before advancing the candidate.

Prioritize Direct Experience Over Credentials

Compare product complexity and delivery responsibility, not years of experience. Look for integrated hardware/software, formal acceptance, regulated records, supplier interfaces, and manufacturing-floor exposure. Degrees, certifications, and tool familiarity don't prove shipment ownership.

To verify claimed improvements, ask for the measurement period, starting point, personal action, and acceptance or shipment outcome.

Accept sanitized walkthroughs or reconstructed records when work is confidential. Ask candidates to explain a document's purpose, revision control, their contribution, and final disposition. Never request proprietary drawings, source code, export-controlled data, classified details, or confidential customer information.

Use references to confirm readiness judgment, defect ownership, record quality, and shipment results - not titles. The interview should pressure-test these delivery behaviors rather than resume polish, with the lowest-scoring areas guiding the interview checklist below.

Interview Checklist: Verify Ownership and Troubleshooting

Use the lowest-scoring areas to guide your questions. Ask every candidate the same four things: what they owned, what evidence supported the decision, who approved it, and what changed after retest. Score answers against the rubric - not the candidate’s confidence.

Ask About Interface Checks and Test Readiness

Ask candidates to walk through a first production article they helped ship. Cover the acceptance criteria, their personal responsibilities, and the biggest threat to shipment.

Then dig into one failed interface: How did they reproduce the failure and verify the correction before shipment? What readiness gap did they catch before formal testing? Require the actual proceed-or-stop decision and supporting records, not just an assurance that everything was checked. Check end-to-end compatibility rather than isolated component success.

Ask About Defect Closure and Acceptance Records

Ask for an intermittent failure and a correction that failed retest. Have the candidate explain the original hypothesis, the evidence that changed their view, and the revised regression scope.

Trace the defect from the requirement through test results, correction, retest, and release approval. Ask how they handled missing records and what was still open at shipment. A strong answer separates verified correction from temporary disposition. It doesn’t treat a workaround - or a record recreated from memory - as closure.

Use an Acceptance-Test Failure Exercise

If the candidate sticks to generalities, switch to a failure simulation.

Present an intermittent end-to-end acceptance failure after a test-fixture modification. The customer requires traceable evidence before shipment. Request a one-page plan for a shipment decision covering containment, configuration checks, preserved logs, reproduction, controlled isolation tests, responsibilities, discrepancy records, correction verification, retest, regression, and release criteria. Require comparison to the last known-good configuration; do not assume the fixture caused the failure. The plan must distinguish finding the cause from proving closure.[8]

Score the exercise on evidence, control, and release judgment. Use a separate 100-point score:

  • Evidence-based diagnosis: 25 points
  • Configuration control: 20 points
  • Containment and safety: 15 points
  • Discrepancy traceability: 15 points
  • Correction verification and regression: 15 points
  • Escalation and release judgment: 10 points

Deduct points for uncontrolled repeat testing, discarded outliers, changed acceptance criteria, or closure based on one unexplained pass. Reward candidates who make shipment conditional on objective evidence and authorized disposition of every open discrepancy - not those who propose the fastest workaround.[11][8]

Conclusion: Make the Hiring Decision

Confirm Shipment Ownership Before an Offer

After completing the interview scorecard, check references to verify the candidate’s first-article ownership claims: interface checks, readiness, failure isolation, defect closure, and release records. Confirm whether they escalated issues early and upheld acceptance standards under schedule pressure.

Make the offer depend on verified ownership, and resolve any gaps first. Be clear about the difference between preparing the release evidence package and approving shipment. Use those findings to build a recruiter-facing brief that screens for the same delivery outcomes.

Turn the Checklist Into a Recruiting Brief

Give recruiters the role scope, key interfaces, test environment, ship-date milestones, required records, and release approver. Ask them to screen for one shipped first article, one failure-isolation case, and one closed defect - with measurable shipment impact. The hiring team should handle engineering-evidence validation.

Success is simple: integration complete, tests ready, defects closed, records accepted, shipment released.

FAQs

When should I hire an integration and test engineer?

Hire an integration and test (I&T) engineer when your program moves beyond the first article and needs someone to own the work from subassemblies through shipment of a flight-ready unit.

Small programs may combine I&T and test roles at first. A dedicated I&T engineer manages the full integration process: mechanical and electrical assembly, harnesses, ground support equipment (GSE), environmental testing, and the anomaly documentation required for customer acceptance.

How can I assess candidates without first-article experience?

Look for candidates who have owned work from start to finish and solved difficult problems in similar high-stakes settings. Use scenario-based interviews and redacted test documents they wrote to assess their technical judgment, root-cause analysis, team handoffs, failure documentation, and follow-through on retesting and closure.

Check references to confirm hands-on experience in the relevant test settings and their ability to manage the gap between test execution and customer acceptance. For hazardous operations, put documented safety qualifications and experience working under strict oversight first.

How do I measure this hire’s impact on shipment schedules?

Track three measures tied to first-article shipment schedules:

  • Schedule variance: Differences between planned and actual ATP/acceptance milestone dates [1].
  • Anomaly counts and closure time: Reference-verified anomaly counts from the engineer’s test campaigns, median days to root cause, and whether closure allowed sell-off without retesting [1].
  • Test readiness review outcomes: No readiness gaps or readiness-related aborted tests, plus delivery of as-run data packages to the customer for acceptance [1].

Related Blog Posts

Keywords:
integration test engineer, first-article shipment, test readiness, failure diagnosis, defect closure, release authorization, interface verification, hiring scorecard
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

RF Engineer Hiring in Defense Tech: Radar, EW and the Clearance Question
October 6, 2026

RF Engineer Hiring in Defense Tech: Radar, EW and the Clearance Question

Set 90‑day deliverables, apply a 100‑point RF scorecard, and match skills, clearance, and lab readiness for radar, antenna, RF, or EW hires.
Propulsion Engineer Career Path: From Test Stand to Chief Engineer
October 6, 2026

Propulsion Engineer Career Path: From Test Stand to Chief Engineer

Four-stage ownership roadmap for propulsion engineers: from safe test execution and design verification to program-level chief engineer responsibility.
How Defense-Tech Startups Structure Supply Chain Teams (Buyer to Director)
October 6, 2026

How Defense-Tech Startups Structure Supply Chain Teams (Buyer to Director)

Assign clear ownership for buying, planning, inventory, and supplier risk; hire Buyer to Director roles as gaps appear.
Technical Program Manager vs Project Manager in Defense Hardware: What Changes
October 6, 2026

Technical Program Manager vs Project Manager in Defense Hardware: What Changes

Contrast TPM and PM duties in defense hardware: technical readiness vs contracted delivery, with hiring and authority checks.
