Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
An FCL alone does not authorize classified manufacturing. I use 3 readiness checks before production starts: company eligibility, cleared people with need-to-know, and approved site safeguards and classified systems.
Your contract - not the fact that you make defense products - determines whether clearance is required. Here’s what I check:
My rule: <u>confirm approval before classified material arrives</u>. A finished room, a site badge, or a worker’s self-reported clearance is not enough. I check readiness with the FSO and the applicable government security authority against 32 CFR Part 117 and current DCSA guidance.

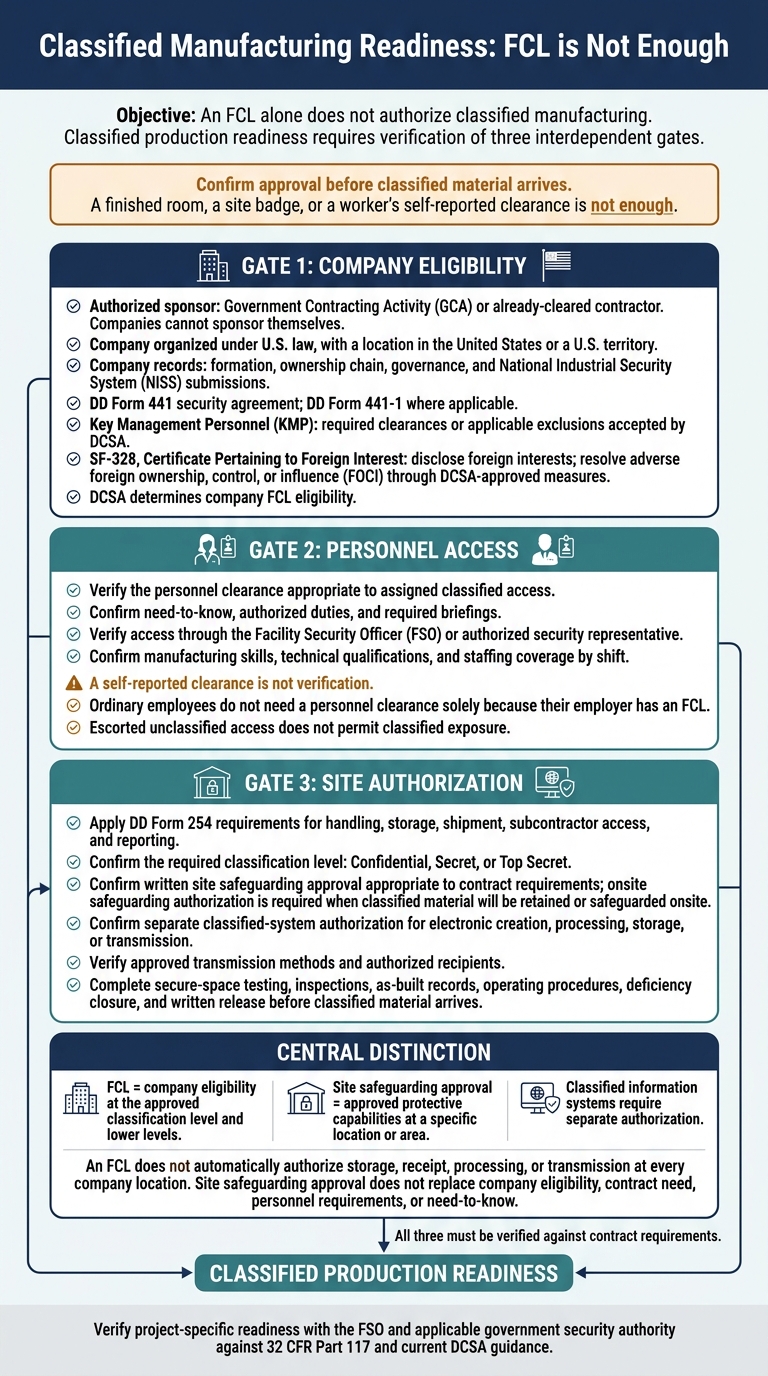

FCL and Classified Manufacturing: 3 Readiness Gates
A company must be organized under U.S. law and have a location in the United States or a U.S. territory. It must have a record of integrity and lawful business conduct, qualify for U.S. Government contracting, and have a genuine need for classified access. Any foreign ownership, control, or influence issues must also be resolved.
These requirements must be met before a plant or production line can support classified work. Sponsorship, company records, and DCSA review establish the company’s eligibility.
Companies cannot sponsor themselves. A Government Contracting Activity (GCA) or an already-cleared contractor must establish the need for classified access. Before submitting through the National Industrial Security System (NISS), assign a security or contracts lead to check that legal names, addresses, ownership details, and governance records agree.
Once the entity file is complete, DCSA reviews who controls the company.
Identify Key Management Personnel (KMP) through ownership records, governance documents, and actual decision-making authority - not job titles alone. KMP whose duties or authority affect classified information must hold the required clearances. This includes the FSO and any other security official with access authority.
A documented exclusion accepted by DCSA may apply when a person neither needs classified access nor has authority that could adversely affect classified-contract performance.
For each classified role, document the required access level, duties, and technical qualifications. A clearance does not replace job skills: a cleared candidate still needs the manufacturing skills the assignment requires.
Submit SF-328, Certificate Pertaining to Foreign Interest, along with supporting ownership and control records. Check that disclosures match ownership percentages, voting rights, board rights, financing, and direct and indirect foreign interests.
Foreign investment does not automatically disqualify a company. However, adverse FOCI must be resolved through DCSA-approved measures, such as governance controls, proxy arrangements, or special security agreements.
Before an acquisition, recapitalization, ownership transfer, or governance change, involve counsel and security staff. Determine which disclosures are required and notify DCSA through the prescribed process. An existing FCL does not automatically carry over to a changed corporate structure.
After entity eligibility and FOCI are resolved, the next gate is site safeguarding approval.
Once the company meets eligibility requirements, site approval determines whether the plant can handle classified work.
Cleared manufacturing means classified production by a company whose people, site, and systems are approved for the contract’s required level. A completed building and an FCL alone do not authorize classified work at that site.[5][10]
Before classified production begins, verify the FCL, site approval, transmission method, and need-to-know. Confirm whether the work involves Confidential, Secret, or Top Secret information and whether the contract requires onsite storage.[7][13]
Classified manufacturing generally requires both the appropriate company FCL and site-specific safeguarding authorization when classified drawings, components, material, or records will remain onsite.[12][13]
Site approval is only the starting point. Classified information must stay controlled at every production step. Apply classification guidance and markings to engineering data and changes. Restrict procurement data to approved subcontractors, and control production instructions, copying, photography, media, and inspection results.[9][11]
For shipping and installation, use authorized recipients, approved transmission methods, and custody controls. Follow approved storage and destruction procedures for working papers, rejected parts, scrap, and obsolete records - not just final deliverables.[9][11]
Creating, processing, storing, or transmitting classified information electronically requires an approved classified information system. An ordinary CAD workstation, manufacturing network, or email account does not qualify simply because the company has an FCL. Keep unclassified tasks separate where practical, and limit access to authorized recipients.[6][14]
Construction teams must build security into the layout, access arrangements, and turnover process. Confirm security requirements before setting boundaries and layouts. Equipment placement, utilities, approved storage, access controls, visitor routes, and maintenance access all affect safeguarding.[10][13]
Commissioning should include security-system testing, as-built records, operating procedures, and documented closure of deficiencies before classified material arrives. Share marked construction documents only with authorized recipients.[10][13]
Once the secure layout is set, staffing must follow the same access plan.
Define access conditions before posting jobs or issuing trade packages. Use the DD Form 254, contract guidance, and FSO review to specify each task’s clearance level, need-to-know, work zone, escort requirement, and permitted system access. State whether classified work will occur during construction or only after turnover. Document these decisions in the project security plan before hiring staff or mobilizing subcontractors.
Coordination does not confer approval authority. The owner controls scope, budget, and site decisions but cannot grant clearances. Assign access by task - not job title - and verify subcontractor eligibility when classified access is required. Owners, contractors, and subcontractors should follow one access plan.
With access rules in place, hire for both clearance requirements and trade skills.
Staffing should support secure construction now and cleared production later. Recruit the FSO and security administrators early enough to help with design, contract review, access planning, and turnover. Identify executives and key management personnel who require PCL processing.
Hire security staff first, commissioning staff next, and production and quality leaders near startup. Track start dates and escort needs so access control and training teams aren't overloaded.
Send clearance and access verification to the FSO or authorized security representative. Hiring managers should assess technical skills, licenses, safety qualifications, and commissioning experience. A self-reported clearance is not verification. Treat site badging, export-control restrictions, and PCL requirements as separate checks.
Ordinary trade work may require only approved escorted unclassified access. Bid packages should specify escort arrangements and require review of workforce changes before deployment.
Write each requisition with the exact access rule: active clearance required, clearance preferred, eligible to obtain, or escorted access only.
Before classified production starts, use this checklist to verify three gates: company eligibility, personnel access, and site authorization.
Check this list against current DCSA guidance and 32 CFR Part 117. Resolve project-specific gaps with the FSO, the DCSA Industrial Security Representative, contracting activity, or other authorized security officials.[5][11][15]
Not usually. Cleared manufacturing work generally cannot begin or move through mobilization until the company’s Facility Clearance (FCL) is active, contract-specific security requirements are validated, and individuals who need access have been granted the required Personnel Security Clearances (PCLs).
You can start non-classified planning and staffing preparation. But classified site work should wait until the FCL is active - not pending [1][2].
Your Facility Clearance (FCL) doesn’t automatically transfer when you move production. Work with your Facility Security Officer (FSO) and follow the appropriate Cognizant Security Authority processes to confirm that the new site is covered and its security controls meet the applicable requirements.
Personnel must also have active Personnel Security Clearances (PCLs) for their roles. Classified work can’t begin at the new site without the correct FCL coverage and required PCLs [1][2].
Keep site access, badging, and background screening separate from personnel security clearances. Start staff clearance checks early, and recruit for key roles 60–120 days ahead.
Allow extra time in the schedule: Secret clearances typically take 3–6 months, while Top Secret/SCI often takes 8–15 months. Rejections restart the clock and can multiply delays.
Verify clearance status through official systems like DISS/NSIPS, rather than relying on resumes. While vetting is still underway, consider making offers contingent on clearance approval.
