I use IPC-A-610 to check assembly workmanship and J-STD-001 to control soldering materials, methods, processes, and acceptance. Before you release work, confirm the contract’s required class, revisions, and addenda. Defense work is not automatically Class 3.
I keep the comparison focused on four questions:
Quick Comparison
My rule is simple: <u>a passing inspection does not prove process compliance</u>. Assign owners across production, quality, and manufacturing engineering; link build records to inspection results; and hold nonconforming work for approved disposition. Track first-pass yield and rework to check whether process fixes are working.
IPC-A-610 covers solder joints, component orientation, wiring, markings, mechanical assembly, cleanliness, and coatings.[10] For defense builds, apply these criteria only from the contract-required revision.
Record each finding with the assembly revision, reference designator or location, observed condition, applicable criterion, and disposition. Visual workmanship inspection cannot verify hidden joints; X-ray or cross-section inspection requires separate acceptance criteria.[6] Match training and qualification to these inspection tasks, and use the findings to distinguish isolated defects from recurring process trends.
Inspection trends help distinguish a one-off defect from process drift. Treat process indicators as warnings, not defects. Production should report anomalies. Quality should track trends by location, process step, equipment, and shift. Manufacturing engineering should identify and correct the cause, then verify the fix through later inspections.[11][15]
Document the contractual baseline in a controlled applicability matrix linked to travelers, inspection forms, and supplier requirements. Include the required IPC-A-610 revision, amendments, addenda, product class, customer exceptions, and the hardware or operations covered.
An addendum supplements its matching base standard - it does not stand alone. Use a newer revision only when the contract or customer authorization permits it.[13][16][17]
Qualification must match the inspection tasks in the contract matrix. IPC’s Certified IPC Specialist (CIS) pathway supports inspector qualification, but a certificate alone does not prove readiness for the assigned tasks.
Before inspectors work independently, require supervised inspection and confirmation that they can read drawings, distinguish defects from process indicators, and document findings. Addendum certification also requires certification to the matching base-standard revision.[14]
Defense manufacturing teams use J-STD-001 to control soldering materials, methods, processes, and acceptance criteria for surface-mount, through-hole, wire, and terminal connections. It covers both leaded and lead-free processes.[7][5][14] It also sets the process requirements behind assemblies inspected to IPC-A-610.
Appearance alone isn’t enough. Verify wetting, solder coverage, fillet shape, and connection geometry against the applicable criterion. J-STD-001 also provides guidance for X-ray inspection of hidden through-hole joints.[18]
Manufacturing engineering defines approved solder and flux, storage limits, equipment checks, thermal profiles, and cleanliness controls. Production records those checks and material lots, and quality uses the records to verify compliance.[19] These controls help prevent solder defects and reduce rework before final inspection.
Use the class and revision specified in the contract - not Class 3 by default. Before production, contract review must identify material restrictions and inspection methods.
If the Space and Military Applications Electronic Hardware Addendum applies, it governs the requirements it covers. Where it is silent, apply the governing Class 3 requirements. Resolve conflicts through the contractual order of precedence before release.[12][20][21]
Personnel qualification must match the assigned soldering or verification task. Production uses the qualified methods, quality verifies compliance, and manufacturing engineering authorizes assigned work. IPC’s J-STD-001 certification includes practical soldering assessments where applicable.[14][22]
The contract and task determine the required qualification. When an addendum applies, personnel must hold the base J-STD-001 qualification for the matching revision, plus any required addendum-specific qualification. Record authorizations, assessments, and renewal dates in a skills matrix. Verify authorization before personnel work independently.
With both standards defined, the next step is knowing where each one applies to the build.
In revisions that use these categories, target is preferred, acceptable is compliant, defect needs disposition, and process indicator triggers review. Quality should record the feature, location, criterion, and disposition - not subjective notes.[8][11] Acceptable workmanship does not prove process compliance.
Link inspection findings, required test results, and production records to the affected assembly. Use separate, approved procedures for rework.[5][9]
Use only the class invoked by the contract.[5][20] An invoked addendum changes or supplements identified base requirements. Requirements it leaves unchanged still apply.[17]
At contract review, confirm the invoked document set - not the newest edition. Maintain a controlled matrix that covers revision, class, addenda, drawings, approved materials and processes, inspection, and traceability. Check that baseline at document release, supplier approval, training, first-article inspection, and change control.
Once the contract set is fixed, personnel qualifications must match the invoked revision and assigned task.
Certification alone does not authorize someone to perform a task. Quality handles interpretation escalation and compliance records. Manufacturing engineering approves methods and evaluates technical changes.[24]
These differences shape daily release and inspection decisions:

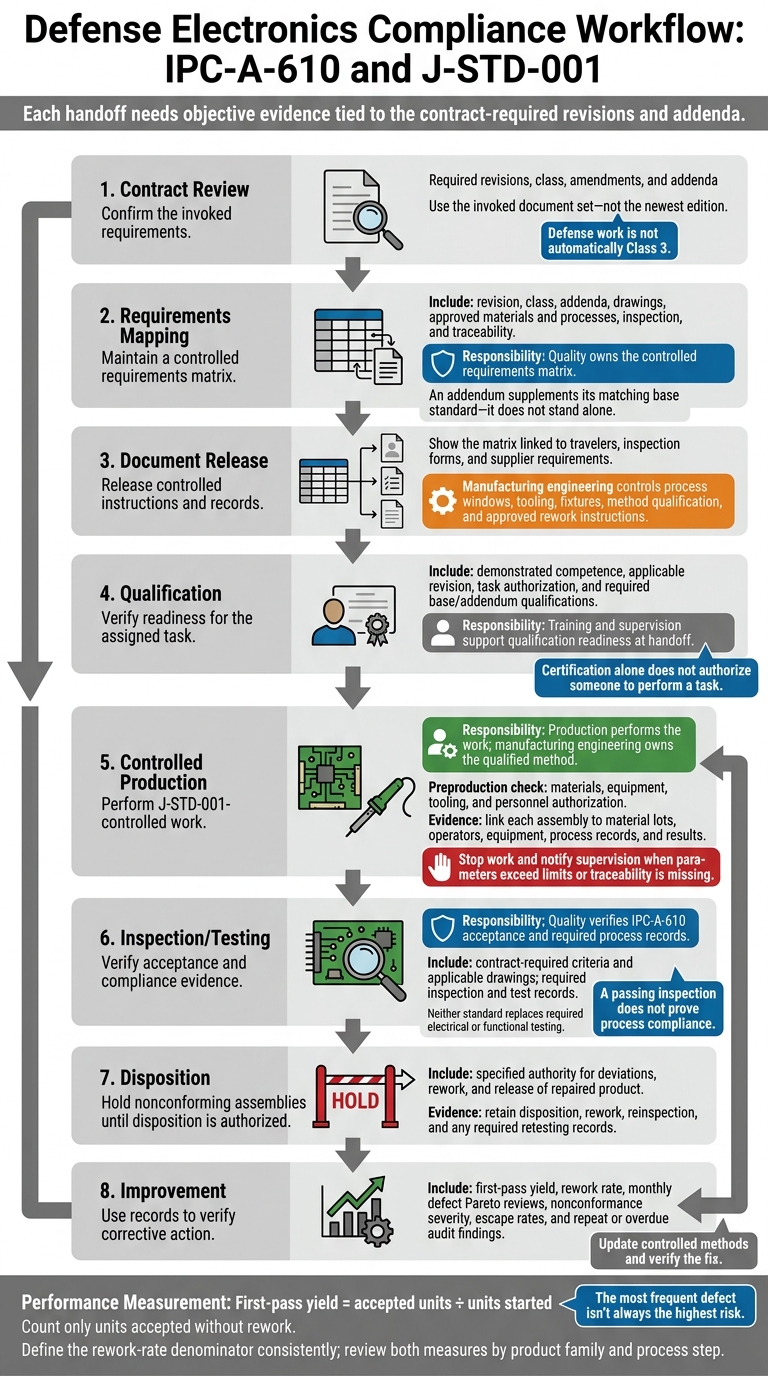

Defense Electronics Compliance Workflow: IPC-A-610 and J-STD-001
Once the contract set is fixed, assign an owner to each step.
Production performs J-STD-001-controlled work, quality verifies IPC-A-610 acceptance, and manufacturing engineering owns the qualified method. Operators must stop work and notify supervision when parameters exceed limits or traceability is missing. Training and supervision are responsible for qualification readiness at handoff. Trigger refresher training after process changes, extended absences, and recurring defects - not just when certificates expire.[14][28] This division keeps process control separate from acceptance.
Quality owns the controlled requirements matrix, inspection/test records, nonconformance control, and compliance checks. Base acceptance on the contract-required revisions and addenda.[20] Manufacturing engineering controls process windows, tooling, fixtures, method qualification, approved rework instructions, and defect reduction. Where practical, keep acceptance independent of the person doing the work.[29] Specify who can approve deviations, rework, and release of repaired product.[30]
With owners assigned, follow a controlled workflow: contract review → requirements mapping → document release → qualification → controlled production → inspection/testing → disposition → improvement. Each handoff needs objective evidence tied to the contract-required revisions and addenda. Before release, verify materials, equipment, tooling, and personnel authorization. Travelers should link each assembly to material lots, operators, equipment, process records, and results. Hold nonconforming assemblies until disposition is authorized. Retain records of disposition, rework, reinspection, and any required retesting.[30]
Use those same records to review performance. Calculate first-pass yield as accepted units ÷ units started, counting only units accepted without rework. Define the rework-rate denominator consistently, then review both measures by product family and process step. Pair monthly defect Pareto reviews with nonconformance severity and escape rates: the most frequent defect isn't always the highest risk.[27] Layered audits should check workstation controls, supervisory follow-through, engineering controls, and quality-system compliance. Track repeat and overdue findings, not just completed audits.
J-STD-001 sets soldering requirements for materials, methods, process control, and soldered-assembly acceptability. IPC-A-610 sets acceptance criteria for finished assemblies.[5][26] Use both only when the contract or governing specification requires them.[25][20] Assign work based on demonstrated qualifications - not a certificate alone.
Use Class 3 only when the contract invokes it. Before production begins, check the exact revision listed in the purchase order, statement of work, quality clause, drawing, or acceptance plan. Confirm any required amendments and addenda, too.[23][31] Requirements that haven’t changed still follow the base standard.[17][20]
Once you’ve confirmed the contract requirements, assign clear ownership across production, quality, and manufacturing engineering. Use inspection findings to correct the underlying process, then check whether defects and rework decrease. Work from the invoked requirements, not the newest revision.[23][20]
Confirm the required IPC class or revision with your customer during the initial project phase, before procurement or production begins. This gives the team agreed-upon build criteria and clear documentation expectations.
Set traceability, calibration, and quality requirements in both the contract and the project quality plan from the start to help prevent compliance issues.
The assembly remains noncompliant. A complete turnover package must show that it was built and checked against requirements [1][2]. Gaps in the records increase the risk of quality escapes and failed audits.
Quality and mission assurance teams must resolve all nonconformances and verify the supporting evidence, including travelers signed by supervisors or quality engineers. These records must let an independent reviewer reconstruct the test history and confirm configuration control and qualification status [3][4][2].
Focus on reference-verified work history - not credentials alone. Confirm specific technical outcomes with the production supervisors, manufacturing engineers, or program managers who directly oversaw the candidate’s work.
Review documented first-pass yields, fault isolation, and root-cause analysis on comparable high-reliability hardware. Verify hands-on equipment experience and the candidate’s ability to manage nonconformance reports, corrective actions, and readiness reviews. Give more weight to demonstrated performance in milestone reviews than to generic certification claims.
