October 4, 2026

DCMA, FAI and AS9102: First Article Inspection for Defense Programs

By:
Dallas Bond

A completed FAIR does not authorize shipment or government acceptance. I start with the contract: confirm the required AS9102 revision, inspection scope, and approval path before making the first article.

Here’s how I keep the requirements separate:

  • FAI: Check whether the production process makes parts that meet design requirements, then document why a full, partial, or no new inspection applies.
  • AS9102: Use Forms 1–3 to link the part configuration, materials, processes, and inspection results to supporting records.
  • DCMA: Confirm the QAR’s assigned role, notification rules, and witness points - not assume every program follows the same approval path.

Before release, I check traceability, resolve discrepancies through the required process, and verify customer or government approvals. The rule is simple: inspection documentation and <u>release authority</u> are separate.

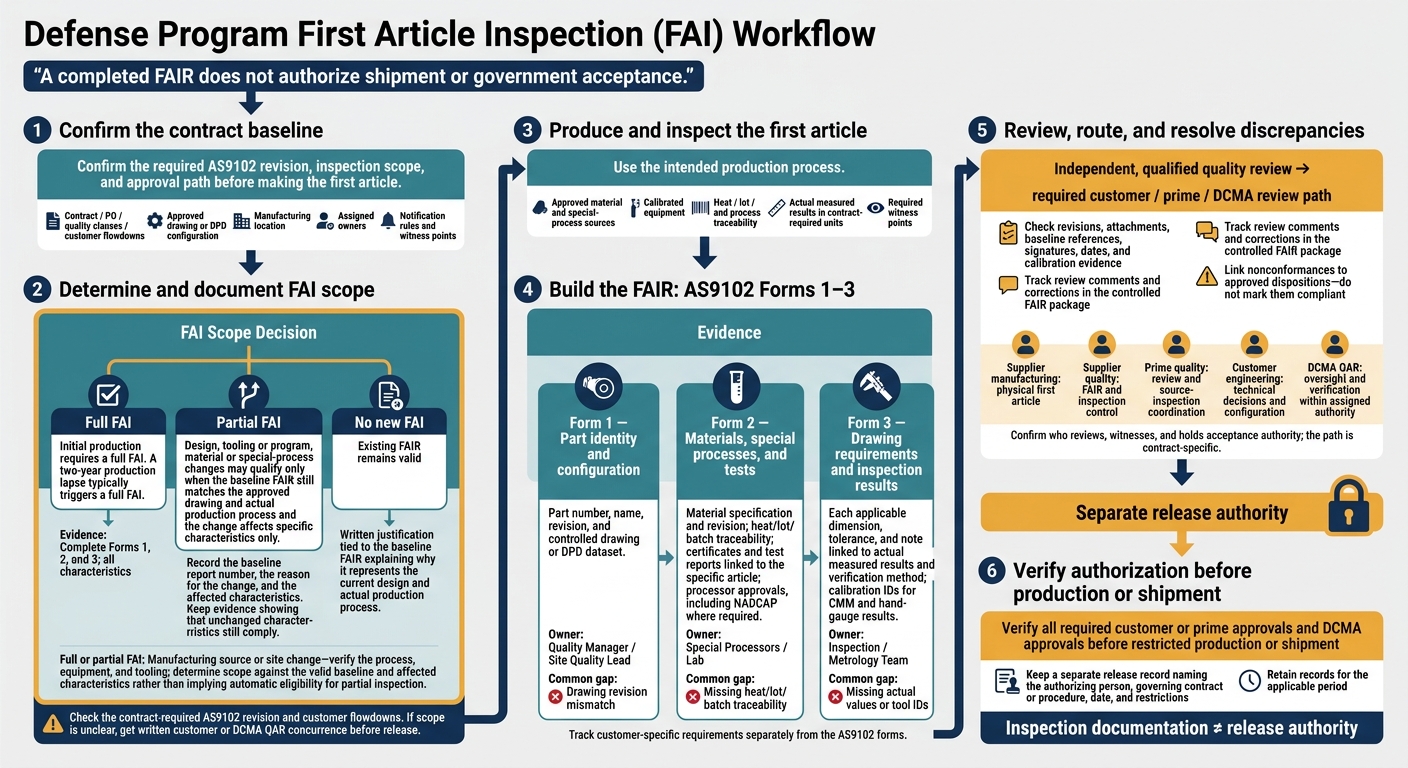

Defense FAI Workflow: AS9102 Documentation to Authorized Release

Defense FAI Workflow: AS9102 Documentation to Authorized Release

IAQG Standard 9102 and SCMH 3 2 First Article Inspection FAI Guidance

When Full or Partial FAI Is Required

Once the contract baseline is set, determine whether the change calls for a full or partial FAI.

Before setting the scope, check the contract-required AS9102 revision and any customer flowdowns. Then compare the existing FAIR with the approved drawing and actual production process. [1][2]

New Parts, Process Changes, and Production Lapses

Initial production requires a full FAI. Changes to the design, manufacturing source or site, tooling or program, and material or special process may qualify for a partial FAI - but only if the baseline FAIR still matches the approved drawing and actual production process, and the change affects specific characteristics only. [2]

A two-year production lapse typically triggers a full FAI. [2]

Documenting Full, Partial, or No New FAI

Trigger Inspection scope Required evidence Concurrence authority, when required
Initial production Full FAI Complete Forms 1, 2, and 3; all characteristics Customer / DCMA QAR
Design change Partial FAI Baseline FAIR link; affected-characteristic assessment Prime / DCMA QAR
Manufacturing source or site change Full or partial FAI Verify the process, equipment, and tooling Customer quality
Tooling or program change Partial FAI Verification of affected characteristics Internal quality / customer
Two-year production lapse Full FAI Re-verification of all characteristics and tooling DCMA QAR
Existing FAIR remains valid No new FAI Written justification tied to the baseline FAIR Customer / DCMA QAR

For a partial FAI, record the baseline report number, the reason for the change, and the affected characteristics. Keep evidence showing that unchanged characteristics still comply. [2]

For no new FAI, keep a written justification explaining why the existing report still represents the current design and actual production process. If the scope is unclear, get written customer or DCMA QAR concurrence before release. [2]

Once the scope is set, document the results on Forms 1–3 with objective evidence.

AS9102 Forms 1–3 and Supporting Evidence

Forms 1–3 document part, product, and characteristic traceability. Track customer-specific requirements, such as Boeing D6-82479 or Lockheed QCS-001, separately from the AS9102 forms. [1][3]

Once the scope is set, use these forms to record objective evidence.

Form Purpose Evidence owner Common documentation gap
Form 1 Part identity and configuration Quality Manager / Site Quality Lead Drawing revision mismatch
Form 2 Materials, special processes, and tests Special Processors / Lab Missing heat/lot/batch traceability
Form 3 Drawing requirements and inspection results Inspection / Metrology Team Missing actual values or tool IDs

Form 1: Part Identity and Configuration

Record the part number, name, revision, and controlled drawing or digital product definition (DPD) dataset. Check that the configuration matches the approved engineering baseline.

Form 2: Materials, Special Processes, and Tests

Document the material specification and revision, heat/lot/batch traceability data, and required processor approvals - including NADCAP where required. Link every certificate and test report to the specific article. This includes material, weld, heat-treat, NDT, and test records. [1]

Form 3: Drawing Requirements and Inspection Results

Use ballooned drawings or a requirement index to identify each applicable dimension, tolerance, and note. Record actual measured results and connect each characteristic to its verification method. Include calibration IDs for CMM and hand-gauge results. [1][3]

Link each nonconformance to its approved disposition, and do not mark it compliant. The supplier, prime, and DCMA review this record set before release. [1][3]

DCMA Oversight and Team Responsibilities

DCMA Quality Assurance Representatives (QARs) provide resident or delegated oversight, as assigned. Before scheduling the first article, confirm who reviews the FAIR, coordinates inspections, and holds acceptance authority. [1]

Completion of Forms 1–3 marks the handoff for review, witness points, and acceptance authority. Use the matrix below to send the FAIR to the right reviewer and avoid late rework.

Supplier, Prime Contractor, Engineering, and DCMA Duties

Assign one owner to each handoff based on the contract. Verify that staff have the required skills in GD&T, CMM programming, calibration, and counterfeit-parts control. Engineering and quality assignments also need clear responsibility for configuration control. [1]

Role Assigned responsibility Deliverable or authority to confirm
Supplier manufacturing Produce the first article and maintain process stability Physical first article
Supplier quality Prepare the FAIR and manage inspection and metrology Completed FAIR (Forms 1–3) and inspection control
Prime contractor quality Review the FAIR and coordinate source inspection FAIR approval or waiver, where authorized
Customer engineering Resolve technical questions and control configuration Drawing/specification interpretation and technical decisions
DCMA QAR Perform government oversight and verification Source inspection sign-off or government acceptance, within assigned authority

Source Inspection, Approvals, and Discrepancies

Once roles are assigned, confirm the contract’s notification period and witness points before the source review. This helps avoid scheduling delays. Have both the first article and the FAIR package ready for review.

Send the package to the authority responsible for customer approval, government acceptance, or production-readiness review. Government acceptance may be documented with a DD Form 250. Production-readiness review uses qualification results and yield data. [1]

Handle discrepancies through the approved disposition process. Keep the part, engineering decisions, and submitted records aligned. DCMA may issue corrective action requests for systemic failures. [1]

FAIR Checklist and Production-Release Checks

Use this checklist to turn the contract baseline and AS9102 forms into a release-ready FAIR package.

Preparation and Inspection Checklist

Before building the FAIR, check the contract, PO, quality clauses, supplier requirements, and applicable AS9102 revision. Record the FAI trigger, full or partial scope, configuration, and manufacturing location. Assign an owner for each piece of evidence before work starts. For a partial FAI, identify the baseline FAIR and explain why unaffected characteristics remain valid.[4][6]

Verify approved material and special-process sources, equipment calibration, and customer or DCMA witness points before work begins. Make the part using the intended production process. Maintain heat, lot, and process traceability, record measured results in the contract-required units, and link each discrepancy to a controlled nonconformance record.

Submission and Closeout Checklist

When the inspection package is complete, route it through the required approval path.

Check the FAIR package. Form 1 identifies the inspected part and configuration. Form 2 links materials, special processes, and tests to certificates and test reports. Form 3 records every applicable drawing or model requirement.[7] Check attachment identifiers, partial-FAI baseline references, revision consistency, signatures, dates, and required calibration evidence. Use the contract-required date format.

Submit through the specified channel, track review comments, and make corrections in the controlled FAIR package. Keep a separate release record that names the authorizing person, governing contract or procedure, date, and restrictions.

Before restricted production or shipment, verify all required customer or prime approvals and DCMA approvals. Retain records for the applicable period. A completed FAIR does not authorize release.[10][11][12]

Documentation Gaps That Delay Acceptance

Before submission, have an independent, qualified quality reviewer check for missing or inconsistent evidence, including:

  • Omitted notes or nominal values used instead of measured values
  • Unlinked certificates or an unidentified manufacturing location
  • Unsupported partial-FAI decisions, revision mismatches, or unresolved dispositions

This final quality review helps catch gaps before the package reaches the reviewer.[5][8][9] Reconcile the ballooned drawing with Forms 2–3 and the attachments. Give each open item an owner and due date. Close it only with objective evidence or an authorized disposition.

FAQs

What if my contract conflicts with AS9102?

Resolve the discrepancy in writing before committing to the work [1]. Contractual requirements take priority over AS9102’s general framework because customer flowdowns and quality clauses define your legal obligations [1].

Don’t rely on past practices or assumptions. Get the customer’s formal, written agreement on which requirements apply before production begins. This helps ensure your inspection process and documentation match the contract [1].

Can I use a supplier’s FAIR for my assembly?

You can use a supplier’s FAIR if it meets your contractual requirements and AS9102 and matches your assembly’s exact part number, revision, and configuration.

Check the objective evidence, including material and process certifications, and verify that the report covers every drawing characteristic. Also confirm that the supplier’s quality system and process approvals are current and apply to your site and work package.

Incomplete reports or those that don’t meet contract requirements won’t satisfy acceptance requirements and may delay production readiness.

Can an unresolved nonconformance block shipment?

Yes. An unresolved nonconformance can block shipment in defense and aerospace programs. It must go through a formal Material Review Board (MRB) process, which may require customer-authorized use-as-is, repair, or a formal waiver [1][2].

The product cannot be cleared for delivery without a documented disposition or resolution of open nonconformance reports. Failure to manage these issues can result in stop-ship orders or DCMA withdrawal of delegated inspection authority [1][2].
