August 28, 2026

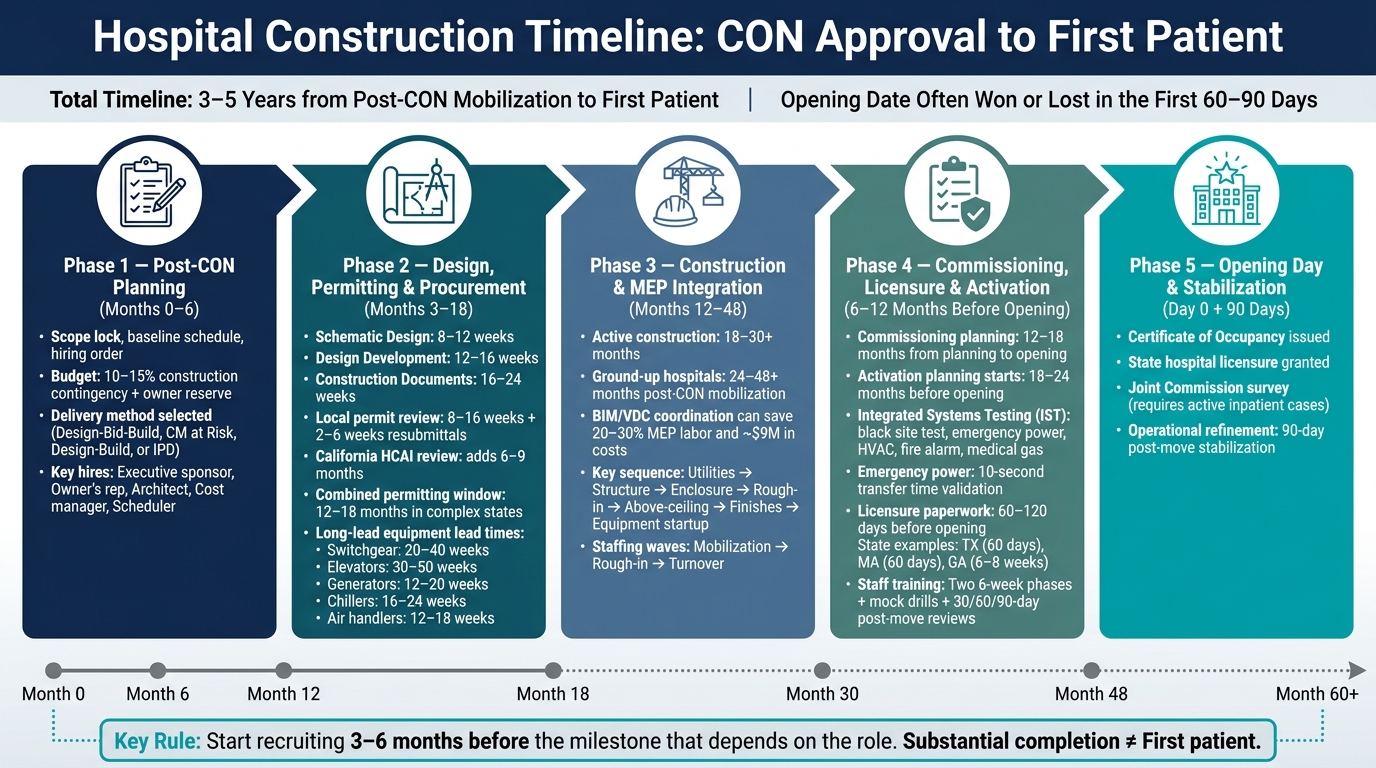

Hospital Construction Timeline: CON Approval to First Patient

By:
Dallas Bond

Most U.S. hospital projects take about 3 to 5 years from post-CON mobilization to first patient, and the date is often won or lost in the first 60 to 90 days.

If I had to sum up the full process in plain English, it works like this: CON approval sets the project in motion, but it does not allow construction to start. After that, the team has to lock scope, pick a delivery method, build the early leadership group, finish design, get permits, buy long-lead equipment, complete construction, test building systems, clear licensure, and prepare staff and departments for opening.

Here’s the short version:

  • Post-CON setup drives budget, scope, schedule, and hiring order
  • Design and permitting often take 9 to 18 months
  • Construction often takes 18 to 30+ months
  • Commissioning, licensure, and activation often need 6 to 12 months
  • CON review itself can add 3 to 12 months, or more if challenged
  • Late hiring in preconstruction, MEP, commissioning, or activation can push the opening date
  • Substantial completion is not the same as first patient

A few numbers stand out:

  • Ground-up hospitals often run 24 to 48+ months after post-CON mobilization
  • Permit review can run 60 to 120 days longer than other commercial jobs
  • Some long-lead items, like switchgear, can take 20 to 40 weeks
  • Activation planning should begin 18 to 24 months before opening
  • Licensure paperwork often starts 60 to 120 days before launch

If you’re trying to understand the timeline fast, the main point is simple: the project has to be staffed by phase, not by a generic org chart. Design roles need to be in place early. Field and MEP roles need to be in place before rough-in and close-in. Commissioning and activation leads need to be in place before testing starts.

That’s the path from approval to opening, in the order it usually happens.

Hospital Construction Timeline: CON Approval to First Patient

Hospital Construction Timeline: CON Approval to First Patient

Hospital Construction Project Management Explained by an Expert

Phase 1: Post-CON Planning, Delivery Model, and Early Team Buildout

The first 30 to 60 days after CON approval shape the project's schedule, budget, and staffing plan. This phase needs to produce three clear outputs: scope lock, a baseline schedule, and a hiring order. If those pieces are shaky, the project can start slipping before construction even begins.

Start by formalizing a project charter. It should define bed count, service lines, OR and diagnostic capacity, support spaces, the target opening date, and a budget that includes a 10–15% construction contingency plus owner reserve. In some states, early estimating is also a compliance matter. Georgia, for example, requires CON estimates to stay within ±10% of actual cost and ±5% of square footage.[6][7]

Choose a Delivery Method and Set the Baseline Schedule

The delivery method picked in Phase 1 affects almost everything that follows. It influences how much design and construction can run at the same time, when long-lead equipment can be bought, and how change orders are handled. Here's how the four main methods compare on the factors tied most closely to opening-date certainty.

Delivery Method Design/Construction Overlap Schedule Reliability Owner Control Best Fit
Design-Bid-Build Minimal Lower - median schedule growth about 4.4%[5] Highest Owners who want maximum design control and can accept a more linear timeline
CM at Risk Moderate - early packages possible Strong - median growth near 0%[5] High Most ground-up acute-care hospitals; balances speed and control
Design-Build High Strong - median growth near 0%[4] Moderate Repeat facility types and projects with speed-to-market pressure
IPD Highest Best potential - one healthcare portfolio reported little-to-no schedule growth[3] Shared Experienced teams willing to share risk and financial transparency

For most ground-up acute-care hospitals, CM at Risk tends to be the best middle ground. It brings the contractor into preconstruction early, which means owners get cost feedback, constructability review, and early sitework packages while the architect is still moving the design forward. That overlap can cut weeks or even months from the total timeline. It also gives owners cost data before they are locked into a GMP.

The delivery model also drives the hiring sequence. Put simply, it tells you when design, procurement, and field leadership need to show up.

The baseline schedule should be built backward from the target opening date, not forward from today's date. A mid-sized acute-care hospital usually needs:

  • 12–16 months for design and permitting
  • 18–30 months for construction
  • 6–12 months for commissioning, licensure, and activation[1]

That adds up to about 3 to 5 years from post-CON mobilization to first patient. And there's another wrinkle: healthcare permit reviews often run 60–120 days longer than similar commercial projects because state health departments hold primary review authority.[2] If that buffer isn't built in on day one, the schedule can start drifting fast.

Early Critical Roles and the Right Hiring Sequence

Right after CON, the owner should name an internal executive sponsor and set up a governance structure. From there, one of the first outside hires should be an owner's representative or program manager. This person connects health system leadership with the design and construction teams, coordinates authorities having jurisdiction (AHJs), and helps keep schedule and budget lined up.

A project scheduler and cost manager should also come in early. Without them, it's easy for the master plan, budget, and decision-making process to move in different directions.

The hiring order should track the critical path: governance first, then design, cost control, delivery, and commissioning. Each role needs to arrive before its decisions become costly to change. Bringing in a construction project delivery team in the right order helps avoid the gaps and overlaps that eat up time later.

Timeframe Role Why It Can't Wait
Month 0–1 Executive sponsor / owner's rep / program manager Drives governance, scope lock, and team procurement
Month 1–3 Healthcare architect + civil/MEP engineers Starts clinical programming and site strategy
Month 1–3 Cost manager + project scheduler Provides independent estimates and turns the plan into a working baseline schedule
Month 3–6 CM at Risk or Design-Build entity Enables preconstruction, early packages, and cost feedback
By schematic design Commissioning authority Must influence design before systems are specified
Immediately Legal / compliance support Structures contracts aligned to the delivery model from the start

The commissioning authority is often brought in too late. That's a mistake. Bringing this role in by the end of schematic design - or even earlier in IPD or Design-Build - allows them to review design narratives and catch issues with HVAC sequencing, electrical testing access, and life-safety system layouts before those choices are locked into the construction documents. A fix on paper may take days. A fix in the field can take months.

Once this early team is in place, the project is ready to move into design, permitting, and long-lead procurement. That same team structure then carries into those next steps.

Phase 2: Design, Permitting, and Long-Lead Procurement

Once the delivery model is set and the early team is in place, the project moves into its most schedule-sensitive preconstruction stretch. Design, permitting, and procurement all run at the same time. This is the point where hospital schedules are either protected or pushed off track.

What happens here shapes everything that follows. If a design decision slips, permit review can slip. If permit review slips, equipment buyout can slip. And if buyout slips, commissioning and activation may no longer fit inside the planned opening window.

Design and Permitting Milestones Mapped to Schedule Gates

For a 200–300-bed acute-care hospital, plan on 8–12 weeks for SD, 12–16 weeks for DD, and 16–24 weeks for CDs. That puts the full design window at about 9–14 months before permit-ready sets are done.[8][9][10]

Each gate does a different job.

The SD gate locks the clinical planning approach, departmental adjacencies, and gross square footage targets. That gives the team enough direction to start early cost modeling and move early site and civil packages.

The DD gate freezes the big systems: the structural grid, MEP system types, medical gas routing, IT backbone, and imaging room shielding concepts. Once those items are set, the team can build GMP pricing and early release packages on coordinated design choices instead of rough assumptions.

The CD gate starts the permit sets, issue-for-construction documents, early trade buyout, long-lead MEP procurement, and formal submission to review agencies. At that stage, the team can lock buyout timing, submittals, and field staffing dates.

Permitting for hospitals usually runs on more than one track. Local building departments often need 8–16 weeks for the first review of a full hospital permit package, plus 2–6 more weeks for resubmittals. Fire and life-safety review can add 4–12 weeks when smoke control, emergency power, and egress plans are tough.[11][12]

In states with dedicated healthcare review agencies, the timeline gets longer. California's HCAI is one example. That process can add 6–9 months of design oversight and permit review, often with staged approvals by discipline.[11][12][17] In those states, owners should allow 12–18 months for combined permitting.

A practical move is to carry 10–20% contingency float inside the permitting window and tie field leadership mobilization to permit issuance plus a defined buffer, not a fixed calendar date.[15]

Once those gates are set, long-lead purchases need to move on the same clock.

When to Buy Long-Lead Equipment

Hospital equipment lead times drive the schedule, not the other way around. Recent benchmarks put generators at 12–20 weeks, switchgear at 20–40 weeks, chillers at 16–24 weeks, air handlers at 12–18 weeks, and elevators at 30–50 weeks, with 4–8 additional weeks for custom configurations.[16]

The playbook is pretty clear:

  • Freeze capacity, voltage, redundancy, and equipment footprints by late DD or early CD
  • Select vendors while design is still closing
  • Reserve fabrication slots on conditional approval
  • Line up deliveries to a 2–4 week readiness window[13][14][16]

Utility coordination is where many teams get blindsided. Permanent electrical service upgrades often require utility design, regulatory approval, and utility-side construction. That process can run past 12 months, and much of it sits outside the owner's direct control.

If that work doesn't start during design, it can become the one item that stalls energization. Then commissioning stalls. Then licensure stalls. One outside dependency can jam the whole opening plan.

That only works when the MEP, procurement, and permit teams are already in place.

Staffing the Design-to-Procurement Handoff

These roles keep permits, models, and equipment buyout moving on time. They are the preconstruction hires that protect schedule certainty before field labor ramps up.

Role Primary Responsibility in Phase 2 Risk If Missing or Late
Healthcare planner Owns clinical program alignment; decisions affect equipment lists and infrastructure Late changes cascade into permit resubmittals and equipment re-specs
Permit coordinator Manages AHJ submissions, tracks review cycles, coordinates responses Incomplete submittals add 8–12+ weeks
AHJ liaison Primary interface with building department, fire officials, and state health agency Missed pre-application meetings delay review
BIM/VDC lead Drives model coordination across architecture, structure, and MEP Field clashes cause rework and delay
MEP manager Translates design intent into procurement packages; defines long-lead equipment requirements Late vendor selection pushes equipment delivery into the commissioning window
Procurement manager Manages bid schedules, purchase orders, and lead-time tracking Missed factory slots delay equipment by months
Cost and schedule controls Forecasts variances, flags when permitting or submittal delays threaten milestones No early warning means less recovery time before the critical path is affected

Phase 3: Construction, MEP Integration, and Commissioning Readiness

This is the phase where long-lead purchases stop being line items and start becoming installed systems. Active construction often runs 12–30+ months, depending on project size, phasing, and delivery method. At this point, schedule control comes down to one thing: tight coordination, clean inspections, and complete documentation at every gate.

Field Sequence from Structure to Above-Ceiling Close-In

Field work usually moves in a clear progression: utilities and structure first, then enclosure, rough-in, above-ceiling coordination, finishes, equipment, and startup. The long-lead equipment bought in Phase 2 now starts to shape the install sequence and room-by-room turnover.

Dry-in is a major checkpoint. Interior work depends on it. Equipment protection depends on it. Commissioning prep depends on it. If the building shell isn't under control, work inside gets messy fast.

Once the enclosure reaches dry-in complete, the biggest schedule gate often shifts to above-ceiling coordination. That's where timing can slip if trades aren't aligned. Utility energization is another hard dependency. Many systems can't be tested until permanent electrical service, chilled water, domestic water, and other utilities are live. Room handoff can also become a hard constraint, especially when clinical spaces must finish in a set order to support commissioning, inspections, and activation planning.

Protecting the Critical Path Through MEP, Quality, and Inspections

Hospital construction often comes down to what happens above the ceiling. One unresolved clash between ductwork, piping, conduit, fire protection, and medical gas can hold up drywall close-in, insulation, fireproofing, and final inspections across an entire zone. That's why the best teams treat ceiling closure like a locked gate: no close-in without approval. They use coordinated zone releases and daily trade sequencing to check that field conditions match the model before hidden issues get buried.

On a $96.9 million Northern California healthcare project, BIM/VDC coordination for MEP systems led to 20%–30% labor savings for MEP subcontractors, less than 0.2% rework for the mechanical subcontractor, about $9 million in cost savings, and 6 months of schedule savings.[18]

Coordination isn't the only place projects get stuck. In Phase 3, delays often come from failed inspections, missing documentation, and quality issues found too late in the install sequence. The usual culprits are familiar: missing firestopping, unverified door hardware, pressure relationship issues in isolation or procedure rooms, and weak medical gas testing. These problems tend to show up late, when fixes are slower and more expensive.

Commissioning work needs to be built into the construction schedule, not squeezed in at the end. ASHRAE Guideline 0-2019 describes commissioning as a process spanning pre-design through occupancy and operation.[19][20] That means testing, adjusting, and balancing (TAB), medical gas testing, and life-safety integration should be planned well before substantial completion.

Staffing Field and Technical Roles by Phase

Staffing usually works best in three waves: mobilization, rough-in, and turnover. Early on, the focus is field control. Later, it shifts toward system coordination and closeout. By the final stretch, the job becomes less about installation and more about testing, paperwork, and readiness checks.

The project manager, superintendent, scheduler, and safety lead need to be in place at mobilization. They set field control, sequencing, and site discipline from day one. As the project becomes more systems-heavy, MEP coordinators, VDC/BIM support, QA/QC personnel, and logistics specialists move to the front of the line. They handle trade interfaces, material flow, and inspection readiness. In late construction, startup and commissioning support becomes a top priority as the project shifts toward documentation, testing, and turnover.

Tie each hire to a field milestone, not a calendar date.

Role Ideal Onboarding Phase Schedule Risk if Delayed
Project manager Mobilization Loss of field control and sequencing discipline from day one
Superintendent Mobilization No site authority to enforce trade coordination or inspection hold points
Scheduler Mobilization No live critical path tracking; delays go undetected until they compound
Safety lead Mobilization Safety incidents and schedule disruption
MEP coordinator Interior framing / rough-in Unresolved clashes discovered during close-in; rework and RFI delays
VDC/BIM lead Interior framing / rough-in Field conflicts not caught before ceiling closure; late clash resolution
QA/QC manager MEP rough-in Incomplete inspection records block turnover packages and commissioning
Logistics specialist MEP rough-in Material staging failures delay installation windows for long-lead equipment
Startup and commissioning support Late construction Incomplete test documentation stalls commissioning and licensure

Phase 4: Commissioning, Licensure, Activation, and Opening Day

Once construction is substantially complete, the work changes fast. The team moves from install mode into testing, licensing, and move-in. And that matters because substantial completion is not opening day. A hospital still has to clear final inspections, pass integrated systems testing, stock rooms, train staff, finalize policies, and run emergency procedures before the first patient arrives.

Build the Commissioning and Activation Schedule Backward from Opening Day

The cleanest way to plan this stage is to work backward from first patient. The last 6–12 weeks usually have the tightest handoffs, and there’s not much room for drift. Commissioning often runs 12–18 months from planning to opening, while activation planning should begin 18–24 months before opening.[26][22]

That backward schedule should line up a long chain of tasks: equipment startup, BAS and controls checkout, TAB, life-safety testing, emergency power validation, medical gas verification, punch-list closeout, room readiness, IT and telecom cutover, FF&E stocking, staff orientation, and mock drills.[21][26] If one slips, the next one usually feels it.

A simple way to structure activation is to break it into five phases:[21][29]

Phase Timing Before Opening Key Activities
Planning and procurement 12–18 months Equipment selection, long-lead orders, vendor coordination
Logistics and staging 6–12 months Delivery sequencing, storage, installation prep
Installation and commissioning 3–6 months Equipment startup, functional performance testing, controls checkout
Integration and readiness 1–3 months IT cutover, clinical simulations, integrated systems testing
Go-live and stabilization Opening day + 90 days Operational refinement, post-move reviews

One of the biggest gates in this stretch is Integrated Systems Testing (IST). This is where the project proves that key systems don’t just work on their own, but work together under normal and emergency conditions.[28] That includes power, HVAC, controls, fire alarm, smoke control, medical gas, nurse call, elevators, emergency lighting, communications, and life-safety systems.[28]

A standard IST sequence may start with a black site test. In plain terms, the main service breakers are opened to simulate total building power loss. From there, the team checks emergency generator transfer, critical branch performance, and full system restoration.[28] Emergency power commissioning also has to confirm 10-second transfer times for life safety and critical branches, full-load generator testing, and alarm function.[25][27]

Commissioning specs often require a functional testing schedule workshop 6–8 weeks before equipment startups. The point is simple: get commissioning tasks into the master schedule early enough that they line up with construction closeout and activation work.[24] When that workshop gets skipped or pushed back, testing windows run into each other, deficiency closeout gets squeezed, and occupancy can slide.

Training also sits on the critical path. Commissioning shows the systems work. Activation shows the hospital can run. Training shows staff can use both on day one. One documented activation program used a two-phase training model, with each phase lasting six weeks, followed by two day-in-the-life simulations and post-move reviews at 30, 60, and 90 days.[23]

Occupancy and Licensure Requirements Before Patient Care Begins

Once systems pass testing, attention turns to occupancy approval and state licensure. Before a U.S. hospital can care for its first patient, it has to move through a step-by-step approval chain that runs alongside final commissioning. In most cases, that path includes final inspection by the local building official, fire marshal review, state health department or licensing survey where required, issuance of a certificate of occupancy (CO) or similar occupancy approval, and state hospital licensure.[32][33][34][35][37]

The timing changes by state, but the paperwork window usually opens well before launch. Most states require documents to be assembled 60–120 days before the opening window. Texas requires licensure applications no earlier than 60 calendar days before the projected opening date, along with the CO, fire safety survey approvals, and final construction approval forms. Massachusetts requires initial licensure applications at least 60 days before the expected start of clinical services. Georgia requires an initial licensure packet and survey request 6–8 weeks before the target opening date, plus final CO and fire safety approvals once the project is complete.[33][35][36][32]

For hospitals seeking Joint Commission accreditation and Medicare participation, there’s another wrinkle: surveys for new hospitals require active inpatient cases on site at the time of survey.[30][31] That’s why some organizations open selected units first, then build toward a broader ramp-up.

The licensure packet itself can get heavy fast. State submissions often call for governing body bylaws, organizational charts, fire drill records, the most recent fire inspection reports, CON letters, construction plan approvals, and CO copies.[32] This can’t be treated like side work at the end. One person, or one clear team, needs to own the package, track due dates, and get it filed on time.

A Phase-Based Hiring Plan That Supports Opening Readiness

The jobs that matter most in Phase 4 are not the same jobs that carried the project through construction. At this point, field control gives way to systems coordination, regulatory paperwork, and operating readiness. For hospital construction and mission-critical technical talent, the hiring push for commissioning and activation leadership should start before system testing begins, not after substantial completion.

Role Onboard By Primary Focus in Phase 4
Commissioning manager Before functional testing begins Sequencing and documenting system verification activities
Activation manager Before system testing begins Coordinating readiness across departments, vendors, and clinical teams
QA/QC lead During closeout and punch-list resolution Closing deficiencies before inspection windows open
Facilities lead Before final testing and licensure windows begin Operations readiness, preventive maintenance setup, utility management
Regulatory readiness support 60–120 days before opening Assembling licensure documentation and coordinating survey scheduling
Scheduler Continuous through Phase 4 Maintaining the backward schedule and surfacing critical path shifts
Project executive Continuous through Phase 4 Cross-functional accountability and owner-level decision authority

The activation manager is now its own role, with a clear focus on move coordination, FF&E, departmental readiness, and regulatory prep.

Gate-based staffing helps keep commissioning, licensure, and move-in moving together.

Conclusion: Role-Aligned Execution Is the Shortest Path from CON to First Patient

Projects usually win or lose their opening date much earlier than people think. The key window is the first 60–90 days after CON approval, when the schedule gets built and the hiring plan takes shape. What happens in that stretch affects everything that comes next - design, permitting, procurement, construction, commissioning, licensure, and activation. If the right people are in place before each milestone arrives, work tends to move with less friction. If they’re not, delays start stacking up.

That early hiring discipline matters all the way through the project. Phase-aligned teams can move delivery faster by cutting down on rework, resubmittals, and late handoff slowdowns. Each phase sets up the next one. You see this most clearly in permitting, where early AHJ engagement and dedicated code consultants can cut resubmittals. The same pattern shows up in commissioning, where agents brought in during design can spot life-safety and controls issues before they turn into inspection failures. For commissioning, activation, and field leadership talent, the hiring sequence is just as much a schedule tool as the project schedule itself.

The same idea carries into commissioning and activation. These should be treated as parallel workstreams, not tasks saved for the end. When activation planning starts 18–24 months before opening, clinical leads, facilities staff, and IT teams have time to run mock drills, fix workflow gaps, and finish training before licensure surveys begin [22][38][39].

A simple rule helps here: start recruiting 3–6 months before the milestone that depends on the role. That’s one of the clearest schedule levers owners can control.

Owners and hiring leaders who map roles to milestones, recruit ahead of the curve, and treat commissioning and activation as schedule-critical from day one give their projects the best shot at opening on time and caring for patients safely from the start.

FAQs

What can delay opening most?

The biggest opening delays usually come from regulatory compliance issues or inspection failures and the fix-up work that follows. This tends to happen when FGI or healthcare rules, or MEP systems like HVAC, medical gas, life safety, and pressure relationships, are flagged late in the process.

Regulatory surveys and licensure don't wait for punch-list completion. In some states, an HCAI deficiency can delay opening by months, and failed inspections can push occupancy back by about 6–12 weeks on average.

When should hospital activation begin?

Hospital activation needs to start early and stay active through the whole project. It shouldn’t wait until construction is done.

Regulatory surveys and licensure inspections won’t pause for punch lists. That’s why commissioning coordination and systems mapping need to begin during construction, not after it. Key leadership roles, including commissioning agents, should be in place by Day 60 to help with turnover planning, compliance, and Day 1 readiness.

Why isn’t substantial completion opening day?

Substantial completion is not opening day. It just means construction is done.

That’s only the first step toward a site that’s ready for inspections and ready to care for patients.

Even if the facility looks finished, it still has to clear regulatory surveys, licensure inspections, and third-party system checks. And that’s where things can slow down. Problems found during activation can push the opening back by months.

So construction turnover matters, but it doesn’t mean the facility is ready to open its doors.

Related Blog Posts

Keywords:
hospital construction timeline, CON approval, hospital commissioning, activation planning, long-lead equipment, permitting, CM at Risk, hospital licensure
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

The MILCON Timeline: Appropriation to Award to Beneficial Occupancy
August 28, 2026

The MILCON Timeline: Appropriation to Award to Beneficial Occupancy

Explains the MILCON flow from authorization and appropriation through award, construction, commissioning, and beneficial occupancy.
CivilGrid raises $26 million Series A for infrastructure platform
August 28, 2026

CivilGrid raises $26 million Series A for infrastructure platform

CivilGrid raises $26M Series A to scale its civil design platform for U.S. infrastructure modernization.
Fossefall selects Armada for Nordic AI data center deployments
August 28, 2026

Fossefall selects Armada for Nordic AI data center deployments

Fossefall selects Armada to deploy five Leviathan modular AI data centers (9MW) across the Nordics by Q1 2027.
USDOT unveils rail and highway corridor plan for power and pipelines
August 28, 2026

USDOT unveils rail and highway corridor plan for power and pipelines

U.S. DOT proposes converting highway and rail rights-of-way into corridors for power, fiber and pipelines.
