Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
A new U.S. mine can take 7–10 years from late-stage study to first production, and most of that time is tied to permits, funding, long-lead gear, construction, and startup.
If I strip it down, the schedule usually comes down to five parts:
A few numbers tell the story fast:
Here’s the plain-English version: money alone does not move the date forward. The schedule is usually set by permit sequence, design maturity, shipping windows, contractor timing, and whether the right people are in place early enough.
If you’re planning staffing, contractor mobilization, or EPCM support, the main takeaway is simple: every phase affects the next one. A late permit can idle crews. A late purchase order can stall installation. A late commissioning hire can slow first ore.
That’s what this article explains: where the time goes, what usually slips, and how teams can get more schedule certainty from permit to production.

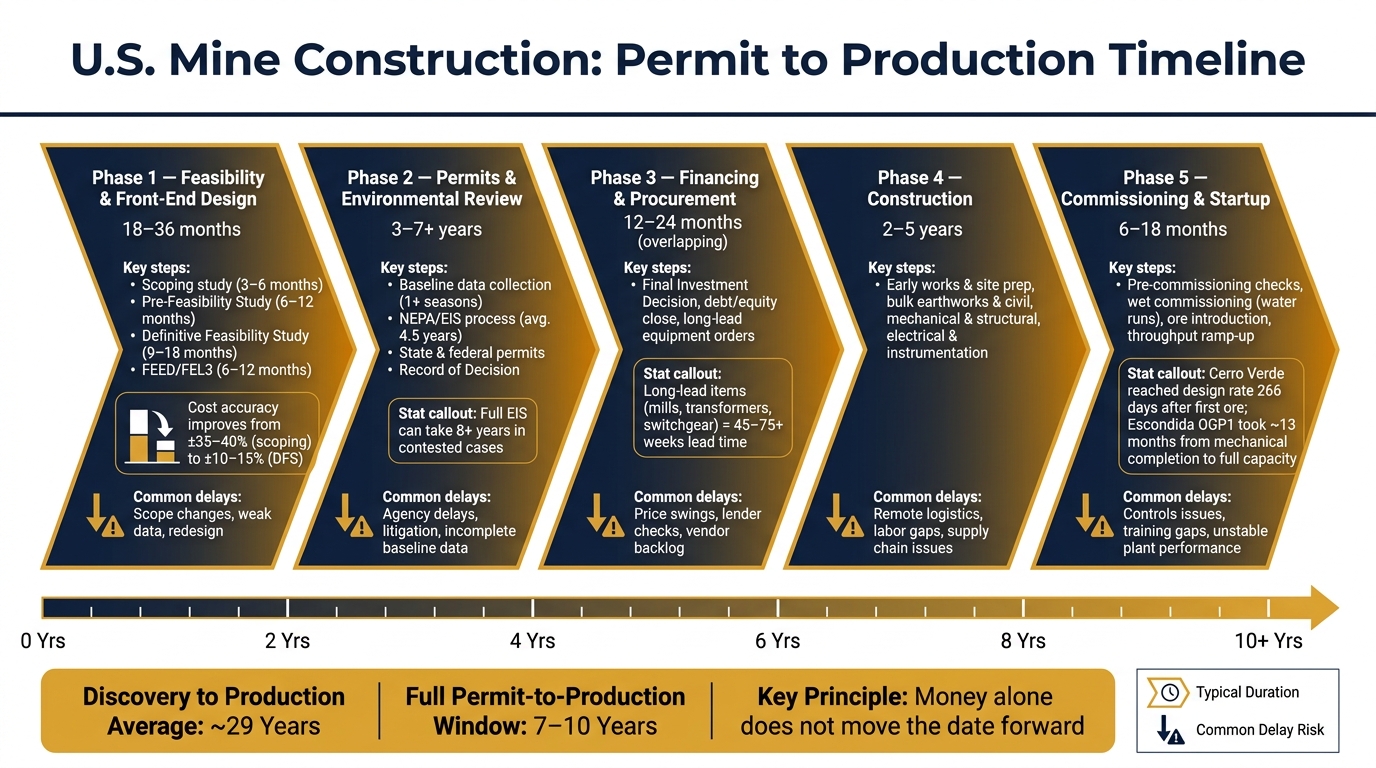

U.S. Mine Construction Timeline: Permit to Production (7–10 Years)
Phase 1 turns a deposit into a project lenders can back. That usually takes 18–36 months, and it sets the starting point for almost every later delay or cost saving. This is where that time goes.
The study sequence adds more engineering detail at each step and cuts down the uncertainty that boards and lenders want cleared up before they commit capital.
A scoping or concept study usually takes 3–6 months. At that point, design is only about 5–10% complete, so cost estimates are still broad, usually in the ±35–40% range. The point is to narrow the big choices: open pit or underground, which processing route to use, and how the site might be laid out.
Next comes a pre-feasibility study (PFS), which often runs 6–12 months. This stage improves resource confidence, sharpens the mine plan, develops the process plant concept further, and tightens cost accuracy to about ±20–30%.[10]
Then comes the definitive feasibility study (DFS). This is the document lenders and investment committees lean on when they decide whether to fund a project. It usually takes 9–18 months, pushes engineering to around 25–40% complete, and tightens cost accuracy to ±10–15%.[9][10] It also has to pull detailed geotechnical, hydrogeological, and metallurgical test work into one technical and economic model.
For a U.S. copper or gold project with capital costs in the $1–3 billion range, total study work plus front-end engineering can reach 2–4% of total project capital. That's tens of millions of dollars spent before construction even starts.[9]
Front-end engineering - often called FEED or FEL 3 - usually overlaps with the end of the DFS and can run another 6–12 months. This is where DFS outputs become drawings, specifications, and equipment lists that procurement teams and early-works crews can actually use.
For tailings storage facilities, FEED-level detail matters a lot for both permitting and construction planning, because TSFs often need to be partly built before the plant can start up.[6] If that detail isn't there, field teams run into scope gaps, and change orders can pile up. That alone can add 6–12 months to the schedule.
Once the technical case is in place, the owner still has to decide how to pay for it and how to deliver it.
Before final investment approval, owners have to make a few big calls:
Each choice affects how fast contractors can mobilize after FID and how much change-order risk stays with the owner during execution.[7][8]
Even if the study team hits its deadlines, many projects still stall between DFS and FID for 6–12 months or more. Why? Owners may still be lining up financing, working through offtake agreements, or waiting for better commodity prices.[7]
The Hudbay Minerals Copper World project in Arizona shows how this can play out. In January 2026, Mitsubishi completed a $600 million investment for a 30% stake in the venture. That cleared a major financing hurdle and let the project move toward a sanction decision planned for later that year.[1] The engineering work had been moving ahead, but the board still needed a fully structured financial partner before it would commit capital.
This is also why owner-side hiring early in Phase 1 matters so much. If key project, cost-control, scheduling, and constructability people join during this stage - instead of after FID - they can shape the study output, test assumptions, and help build an execution plan that stands up to lender review. When staffing comes late, teams often have to run extra study cycles, and FID can slip by months. Those early calls shape permitting, financing, and construction sequencing in Phase 2.
Once the owner sanctions the project, the critical path shifts from study quality to regulatory timing. After feasibility and FID, the schedule starts to revolve around permitting - the longest gate before construction can begin. For large greenfield mines, this is often one of the longest and most variable parts of the full permit-to-production timeline.
Permitting starts with baseline data collection, not with filing the application. Teams usually need water, wildlife, vegetation, air, and noise monitoring across at least one full seasonal cycle. If a baseline package is filed before that cycle is complete, or if key species surveys do not reflect the right season, agencies can issue information requests and pause the formal review[4][14].
That’s where schedules can start to slip. A team may have to go back into the field for another season, which can add months or even years to the timeline[4][5][14].
Once the baseline work is in good shape, the NEPA process moves through a set sequence: Notice of Intent, scoping, draft EIS preparation, public comment, final EIS, and Record of Decision[4][11]. For major mines, scoping can take 2–3 months. Draft EIS preparation often takes 12–24 months. Public comment usually runs 45–90 days, and final EIS preparation can take another 8–12 months. In contested cases, the full process can stretch to 8 years or more[4][5][11][13][15].
The Rosemont Copper Project in Arizona shows how long that path can be. The NEPA process began in February 2008. The public comment period on the draft EIS closed in January 2012. The final EIS came out in December 2013. The Record of Decision was completed in June 2017 - about a 9-year path from NEPA start to ROD[17].
That’s why permit sequencing and project delivery decisions can’t be handled as separate workstreams. They have to move together.
These approvals do not all clear at the same time. The order in which they finish shapes when field work can start. The table below focuses on the approvals that most often gate construction.
The takeaway is straightforward: construction hiring has to follow permit milestones, not target dates. If EPCM mobilization is scheduled against an assumed ROD date and that date slips, the owner can end up paying for a mobilized team with nowhere to work - or trying to hire people back after a stand-down[4][14][16].
Access roads and transmission lines that cross wetlands or federal land need Section 404 permits and rights-of-way before earthworks can start. Tailings storage facilities depend on completed hydrologic and geotechnical baselines, so tailings approvals often trail the main mine permits and become a hard gate for plant construction[3][4][14][16]. Water supply and discharge systems also need water rights, groundwater withdrawal permits, and NPDES permits before contractors can build or run construction utilities[14][16].
The projects that handle this well put permit milestones directly on the master schedule. They tie contractor mobilization to the ROD, key water and tailings permits, and any rights-of-way needed for access and power[4][14][16]. Structured coordination tools such as FAST-41 can help keep multi-agency reviews on a tracked schedule[1]. For owners building execution plans, that kind of visibility helps line up recruitment, procurement, and contractor mobilization with realistic permit dates instead of optimistic forecasts.
When approvals land, the critical path shifts to financing, procurement, and the long-lead items that set the pace for construction start.
Approvals alone don't put people and equipment on site. Before major work can begin, the project still needs FID, debt close, equity funding, updated capital estimates, and clear contract risk allocation. Financing close is the gate. It decides when construction can actually start, because it controls when site work, procurement, and contractor mobilization are allowed to move forward.
Once funding is released, the project shifts from paper decisions to physical work. After FID, the EPCM team issues IFC packages, awards early works, and lines up site prep: access roads, site offices, laydown areas, water management, and temporary accommodation. Those early scopes make it possible for bulk earthworks and civil foundations to move ahead without constant stops and starts. On large greenfield sites, work usually rolls out in staggered packages rather than one nonstop build sequence. From that point on, procurement timing and delivery order start to shape the critical path.
The table below shows a split that often gets muddled in practice: who makes the decisions, and who carries out the work. That gap matters. When roles blur, delays tend to follow.
A major schedule risk during construction is simple: civil work is ready, but the equipment isn't there. Long-lead items such as mills, transformers, and switchgear can take 45–75+ weeks to manufacture and test[21]. That means a site can be ahead on concrete and steel, yet still be unable to move the mechanical or commissioning sequence forward. Nothing advances until the equipment is fabricated, shipped, inspected, and set in place.
This is why early procurement matters so much. Projects that release purchase packages early, use vendor surveillance and expediting, and match design freeze dates to fabrication milestones tend to protect the schedule far better than projects that treat procurement like back-office support. In a build like this, procurement isn't a side task. It's part of the main race.
Remote access makes the problem tougher. Many U.S. mine sites rely on limited road access, seasonal transport windows, tight rail or port capacity, and oversize-load routes that depend on weather. Oversized cargo often needs special permits, route surveys, and escort planning. If freight slips, crews can end up waiting on site while equipment sits somewhere else. For remote or northern locations, logistics belongs on the critical path too. Unplanned breakdown parts may go by air freight, but the road leg from the airport to the mine is often the real choke point, not the flight itself[20].
On large mine builds, schedule delay usually doesn't come from one dramatic event. It builds slowly through small misses that stack up over time. A design issue can hold up a foundation pour. A turnover package can stall because nobody owned punch-list closure. That's how weeks disappear.
The people who keep that from happening are the ones managing the handoffs every day:
Each role protects a different part of the sequence. Schedulers and project controls teams keep the critical path visible. Field engineers sort out design and installation conflicts as they happen, not three weeks later. QA/QC and safety leaders help avoid rework and stoppages. Commissioning planners make sure turnover happens system by system instead of turning into a last-minute rush.
Hiring for those roles also needs to follow the shape of the project. Senior planning and controls people usually need to come first. Then come construction management and field engineering. Trades supervision and commissioning support ramp up closer to turnover. That sequence sounds obvious, but projects often get it backward and pay for it later.
The practical moves are pretty plain:
Those hires matter because they protect turnover timing. And they need to be in place before turnover starts, not after problems show up. Once the project reaches that point, the bottleneck shifts away from buildout and toward commissioning and startup. Soon after that, the focus moves again - from getting the plant built to getting first production online.
After construction, the schedule moves into startup. Mechanical completion is the start of commissioning, not the start of production. The plant still has to go through pre-commissioning, turnover, loop checks, energization, wet testing, ore introduction, and throughput ramp-up before it reaches steady-state output. That phase can take another 6–18 months. [23][24]
This is also the point where the project has to switch gears fast. Construction crews begin to roll off, while commissioning and operations teams step in. If that handoff is loose or late, the schedule can slip in a hurry.
The main issue is system dependency. A concentrator does not run as a group of standalone machines. The crusher feeds the mill, the mill feeds flotation, flotation feeds thickeners, thickeners feed tailings, and the whole chain runs through a control system that must verify each interlock before ore can move through the circuit safely. Startup follows a system sequence, not a bunch of isolated tasks.
After mechanical completion, the next steps happen in a set order. Pre-commissioning includes lubrication, hydraulics, electrical, instrumentation, and automation checks. Then comes wet commissioning, where the plant runs with water but no ore. That stage tests piping, pumps, interlocks, and control logic under actual flow conditions. Only then does the team bring in ore, starting with low feed rates and increasing throughput as process conditions settle.
Project data shows how long this stage can last. At BHP's Escondida OGP1 concentrator, mechanical completion took place in May 2015, and full capacity was not expected until June 2016 - about 13 months from mechanical completion to full capacity. [23] The Cerro Verde C1 copper concentrator hit its original design rate of 108,000 tons per day on a 30-day moving average 266 days after first ore. [22] That’s why staffing and controls readiness matter just as much as finishing the mechanical work.
Controls integration often determines whether startup stays on time. [2] Incomplete loop checks, poorly calibrated instruments, and control logic that has not been tested against live process conditions often stretch out startup. Operator readiness can slow ramp-up too. Even when the plant is fully installed, output can lag if the crew has not been trained on the exact circuit, equipment, and control system before first ore.
Because startup is highly timing-sensitive, hiring has to begin ahead of first ore. Hiring needs to start before turnover, not after.
Projects that ramp faster tend to treat commissioning as a separate discipline with its own hiring plan. That means bringing commissioning managers on board 12–18 months before first ore. [2] It also means lining up operations supervisors with turnover schedules so they are there during pre-commissioning and water runs, instead of showing up after the EPCM team has already handed over the plant. When operations and maintenance staff take part in commissioning, they usually know the plant better, solve problems faster, and trim the learning-curve delays that can slow ramp-up.
For hard-to-fill roles, timing matters even more. Process engineers with direct circuit experience, controls leads who have commissioned similar flowsheets, and shift supervisors with greenfield startup history are not easy hires. Specialized recruiting support can shorten searches for these commissioning and operations roles. The key is careful screening: there’s a big difference between someone who has actually delivered tonnage on a similar circuit and someone who simply worked nearby. Build that talent pipeline before peak demand hits, or hiring gets rushed at the worst possible moment.
The next question is how earlier permitting, procurement, and staffing decisions either protect or erode that finish line.
When you look at the full permit-to-production path, one thing stands out: the schedule only gets tighter when each phase hands off cleanly to the next. That 7–10 year window comes from delays piling up across the whole job - feasibility, permitting, financing, procurement, construction, and commissioning.
The main lesson is pretty simple: delay risk builds early, and it compounds. If permitting assumptions are too optimistic, the rest of the plan starts to wobble. Procurement gets triggered for a construction start date that slips. Contractors mobilize, then sit and wait. Workforce commitments get made before the site is ready. In the U.S., NEPA timing has to be built into the baseline schedule from day one. It can't be treated like something that may just sort itself out.
That puts procurement discipline right alongside permitting discipline. For construction leaders, schedule certainty starts well before fieldwork begins. It means tying execution planning to the DFS, locking in the delivery model before Final Investment Decision, and pre-qualifying critical subcontractors before approval. Those moves help shorten the back half of the schedule. Even then, long-lead equipment can still control the critical path. One late purchase order can leave a fully staffed site waiting around.
Staffing works the same way. Project controls managers, commissioning leads, and operations supervisors need to be in place long before peak demand hits - often 12–24 months ahead for project controls and 12–18 months ahead for operations leadership. These roles do not get filled fast once the schedule is under strain. Hire early, or late staffing will stack on top of every other risk.
Projects that reach first production on plan treat every phase like part of one connected chain. Permitting assumptions shape procurement timing. Procurement timing shapes construction sequencing. Construction sequencing shapes commissioning readiness. And commissioning readiness decides whether first ore turns into steady-state output in a matter of months or drags into years. Getting that chain right takes realistic planning, disciplined execution, and early talent commitment.
The biggest slowdowns usually happen at the local level. Planning and zoning approvals often turn into the main bottleneck that pushes back project start dates.
Federal reviews can stretch timelines too. In many cases, NEPA reviews, wetlands permits, and endangered species permits add years to the schedule.
Then there’s the grid side of the job. Utility interconnection and transmission upgrades can delay mobilization by 12 to 36 months because of grid studies and infrastructure work.
Sometimes. But there’s usually a catch.
Phased permitting can let a project start grading or foundation work before the full permit set is approved. That can cut crew idle time and keep the schedule moving. The downside is pretty clear: if the design shifts later, you may end up paying for rework.
The safer way to save time usually starts with early planning. That often means:
Owners should hire key project and commissioning staff based on project milestones, not calendar dates. That way, the right people are in place when major decisions need to be made.
For commissioning, that means bringing leaders in during design, ideally when the project is about 30% to 40% complete. Other key roles - like project executives and schedulers - should come on board during planning or early preconstruction, usually 3 to 6 months before the milestone where they can make the biggest difference.
