Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If a wastewater plant is tied to a consent decree, the schedule is a legal deadline, not a target. I’d sum it up this way: most of these programs take 5–10 years, and the dates that matter most are set early - during planning, design, delivery method selection, and long-lead buying.
Here’s the plain-English version of what drives the timeline:
A few points stand out:
Here’s a fast timeline view:
If you want the short answer, it’s this: the jobs that hit startup dates usually lock the schedule early, buy long-lead gear early, and hire field and commissioning leaders early. The ones that slip often wait too long on those three moves.

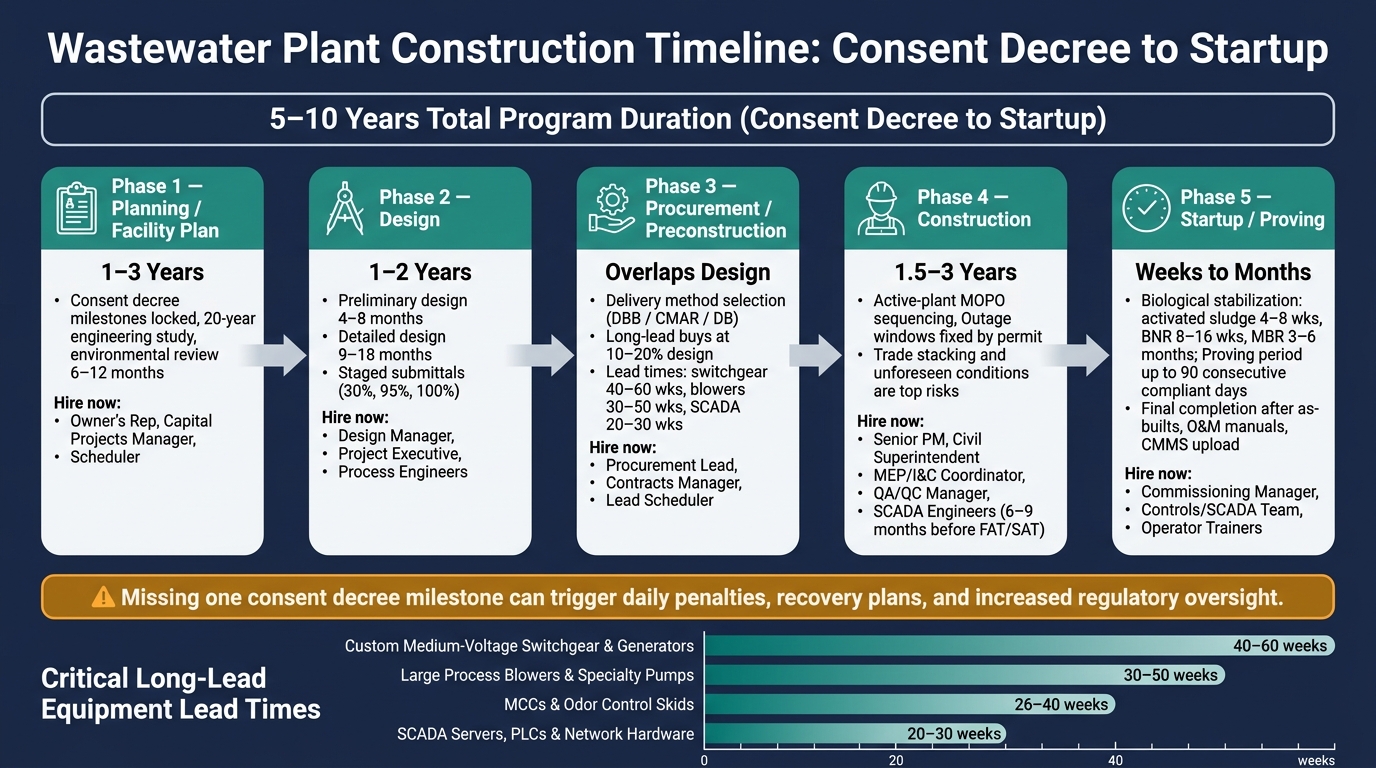

Wastewater Plant Construction Timeline: Consent Decree to Startup
Once the decree is signed, the compliance clock starts. From that point on, the job is to build a regulatory and design schedule that drives everything downstream. Pull out every required milestone - facility plan submittals, design deadlines, construction start, startup, operation, and performance testing - and back-plan them into the baseline schedule. That schedule becomes the backbone of the entire program.
Consent decrees are usually far more prescriptive than a standard capital project. Some spell out the exact sequence for preliminary design, final design, bidding, construction initiation, operation, and performance testing [3]. Others set fixed deadlines for ordering, design, site prep, installation, startup testing, and steady-state operation [4]. In plain terms, there’s not much room for slippage in Phases 1–2.
The facility plan is the technical anchor. It’s a 20-year engineering and planning study that covers flows, loads, treatment performance, alternatives, and phasing. More than that, it translates compliance requirements into a buildable scope, a phasing approach, and a procurement map. It should also flag long-lead equipment early so procurement can begin vendor outreach and budgeting. Environmental review and permitting need to sit in the master schedule too. Those steps can take 6–12 months or more, especially for new sites or wetlands impacts [6][7][8]. Early planning here also shapes procurement and delivery choices in the next phase.
A few roles matter early, and they matter a lot:
Those roles should be hired during facility planning, before design begins.
After the facility plan is approved, preliminary design sets the big technical calls: the process train, hydraulic profile, redundancy, and the first pass at electrical and controls concepts. For a medium-to-large plant, this stage usually takes about 4–8 months [8].
Detailed design takes those decisions and turns them into construction-ready packages. That includes P&IDs, civil and structural drawings, equipment data sheets, electrical one-lines, controls lists, loop diagrams, and SCADA architecture. From about 30% design to bid-ready documents, the schedule is usually 9–18 months, depending on plant complexity, delivery method, and regulatory review cycles [5]. Some decrees also require staged submittals - such as 30%, 95%, and 100% - with fixed windows for comments and responses [5].
The project executive needs to set the delivery strategy and commercial framework early. The design manager keeps discipline coordination on track, manages decision deadlines, and handles long-lead purchases during preliminary design. Process engineers should already be in place from the facility plan stage, since process decisions affect startup performance later on. These roles need to be hired before preliminary design starts if the team wants to protect the critical path. Once the design basis is locked, procurement and long-lead ordering become the next schedule gate.
Once the design basis is set, this phase marks the shift from design into execution. At this point, the biggest call is the delivery method. That one choice shapes the procurement path, decides who absorbs schedule risk, and shows how much float is left before the compliance deadline. After that, procurement timing becomes the next make-or-break item on the critical path.
The table below shows how the main delivery methods usually stack up when the deadline is fixed by regulation.
The main difference comes down to when contractor input starts. In DBB, it starts after design. In CMAR, it starts during design. In DB, it starts before design is finished. That timing can change the whole job.
After the delivery method is chosen, package release is next. And this is usually where a schedule either holds together or starts to slide.
Under DBB, owners usually issue an RFQ for the designer, then a separate RFQ or RFP for construction once design reaches 90%–100% completion. The downside is simple: constructability input comes late. CMAR and DB shift that timeline by allowing phased bid packages and early procurement before full design is done. Instead of waiting for one full document set, work can move out in earlier packages.
In CMAR, the owner often issues an RFP at about 20%–40% design, signs a preconstruction services agreement, and uses that stretch to work through constructability issues, build the GMP, and approve early purchase orders for critical equipment [17][21]. GMP development often begins around 60% design and wraps up near 90% design. Some projects also use multiple GMPs when early work packages make sense.
A practical CMAR procurement schedule can move fast:
The equipment that most often drives the procurement critical path includes large process blowers, high-capacity pumps, medium-voltage switchgear, motor control centers (MCCs), standby generators, odor control systems, and SCADA/PLC hardware. Recent U.S. lead times run 40–60 weeks for custom medium-voltage switchgear and large standby generators, 30–50 weeks for large process blowers and specialty pumps, 26–40 weeks for MCCs and major odor control skids, and 20–30 weeks for SCADA servers, PLCs, and network hardware [14][18].
That has a blunt implication: purchase orders for the longest-lead items often need to go out when detailed design is only 10%–20% complete, not after the GMP is signed. If that sounds early, it is. But waiting can burn months that you may not get back. That’s why many CMAR preconstruction contracts now specifically require the CM to flag these items and lay out delivery schedules before the full GMP is in place [15][19].
Three roles usually turn this from a good idea into a working plan: the contracts manager, the procurement lead, and the scheduler. These people protect release dates for long-lead equipment and the first construction packages.
The contracts manager lines up milestone dates, early procurement language, and risk-sharing terms with the decree schedule. The procurement lead handles vendor prequalification, RFQ/RFP release, bid review, and purchase order execution. The scheduler connects design milestones, fabrication durations, and plant outage windows in a resource-loaded CPM schedule so a slip shows up early - before a decree milestone becomes impossible to recover.
The hiring window for these roles is tighter than many owners expect. By Phase 3, the owner's rep and project executive should already be in place. The Phase 3 hires - estimator, procurement lead, contracts manager, and lead scheduler - should be on board by about 20%–30% design, or sooner if CMAR or DB is the chosen method, so cost and schedule models stay lined up with regulatory milestones [11][13].
On the contractor side, a CMAR or DB team should assign a project executive, preconstruction manager, lead scheduler, and commercial/contracts lead right after award of preconstruction services. That is usually 6–9 months before peak procurement [9][10][12]. Waiting until the GMP is signed to staff those roles often means walking into fixed decisions that may already be out of step with the decree timeline.
If full-time staffing is not ready yet, fractional schedulers or procurement leads can cover the gap and then shift to full-time as procurement ramps up.
With long-lead buys released, the project moves from preconstruction into field execution.
Once long-lead equipment gets released, the schedule moves off the page and into the field.
Work at an active wastewater plant almost never moves in a straight line. Mobilization, earthwork, structures, buried utilities, process mechanical, electrical, and I&C all have to fit around live treatment operations. Lose time in the field, and you don't just hurt output - you put compliance dates at risk. The delivery and buying choices made in Phase 3 shape how much room the field team has to resequence work here.
MOPO sequencing keeps treatment online by phasing basin outages and using bypass pumping for key tie-ins. A clarifier retrofit, for example, might need three separate weekend shutdowns spread across several months. Tie-ins to existing electrical switchgear also need energization plans lined up with plant staff and, in many cases, the local utility. That's why field risk control matters just as much as daily production.
Four risks show up again and again on U.S. decree-driven wastewater projects during Phase 4: unforeseen conditions, late or nonconforming equipment, limited shutdown windows, and trade stacking.
Unforeseen conditions - hidden utilities, contaminated soils, or worn concrete in existing basins - can trigger RFIs, change orders, and redesign cycles that eat up weeks of float. Permit limits set a hard cap on how many units can be offline at one time, so shutdown windows are fixed. No wiggle room. Miss one outage window, and the time left for mechanical completion and startup testing shrinks fast.
Late blower deliveries or medium-voltage switchgear that misses factory acceptance can compress the rest of the mechanical and electrical sequence. Then crews get pushed into the same work areas at the same time. That's trade stacking, and it's a double hit: lower output and higher confined-space risk.
Each field leader owns a different part of that risk:
The Sioux Falls Water Reclamation Facility modernization kept a 40-year-old plant operating during major upgrades by using CMAR, detailed tie-in planning, and off-hours shutdown windows. [26]
The most common staffing mistake in Phase 4 is simple: bringing in field leadership too late. The schedule only holds when the right people are in place before each workfront opens.
Controls and SCADA staffing needs extra attention because the hiring window feels early, almost too early. But there's a reason for it. Bringing SCADA engineers on 6–9 months before factory acceptance tests (FAT) and site acceptance tests (SAT) gives them time to review the control narrative, standardize instrument tagging, and build testing scripts before loop checks start.
When teams wait until pre-startup to make that hire, loop checks alone can slip by about 3 months. On a consent decree schedule, that's the kind of delay that can throw the whole job sideways. Large wastewater risk registers also flag labor availability as a schedule and cost escalation threat at the owner level [27]. Controls and SCADA work has to stay ahead of field completion. If it doesn't, startup slips.
By the time construction is getting close to completion, the controls team should already be leading turnover and startup planning.
As mechanical completion gets closer, commissioning and controls staffing becomes the next critical path.
After construction wraps, the schedule moves into turnover, testing, startup, and regulatory acceptance. Mechanical completion is only the start of turnover, not the finish line. At this stage, compliance depends on performance and formal acceptance. That’s why turnover, testing, and operator readiness become the real critical path.
Mechanical completion means the system matches approved drawings, has been leak-tested, has safety devices in place, and has only minor punch-list items left. Acceptance usually calls for signed completion certificates, inspection reports, redlines, and updated asset tags. Before pre-commissioning starts, the commissioning manager works with the process mechanical superintendent and electrical lead to confirm that all of that is in place.
Once systems are accepted for turnover, pre-commissioning begins. That work includes rotation and alignment checks, MCC and switchgear energization, loop checks, and clean-water testing before live wastewater is introduced.
At the Sand Island Wastewater Treatment Plant in Honolulu, point-to-point checks and SCADA integration before seed sludge introduction cut startup time by 4 to 6 weeks [29].
SCADA readiness is what makes startup repeatable and auditable. The controls/SCADA engineer needs to confirm that PLCs communicate reliably with SCADA servers, historian and reporting tools are set up for required compliance metrics, and alarm review is complete. Recent commissioning practice also includes scenario tests, such as power-fail recovery and interlock validation, with owner operations staff. That kind of drill helps catch problems before live cutover.
"The time to enforce documentation quality is at turnover, not after." - Fidelis Associates [2]
After clean-water testing passes, the plant can begin receiving flow. Conventional activated sludge usually stabilizes in 4–8 weeks. BNR systems take 8–16 weeks. MBRs often need 3–6 months [28][30].
Performance proving is the formal step where the plant shows it can consistently meet effluent limits under actual operating conditions. Consent decrees often require a proving period, such as 90 consecutive days of compliant effluent, and any exceedance can reset the clock. Typical proving periods run 1–3 months for secondary treatment upgrades and 6–12 months for complex BNR or advanced treatment systems operating under strict nutrient limits.
Substantial completion happens once biological performance stabilizes and formal proving begins. Final completion comes later, after all punch items are closed, as-builts and O&M manuals are delivered, asset data is uploaded to the owner’s CMMS, and SCADA configurations are backed up and handed over.
The weakest links in a consent decree timeline are often staffing choices made too late. A commissioning manager brought on during late design can define system boundaries, FAT/SAT requirements, and punch-list ownership before field work wraps. That turns Phase 5 into a planned sequence instead of a drawn-out debugging period.
In Phase 5, the controls/SCADA team needs to lead SCADA cutover, alarm testing, and operator validation. That work does not shrink well, and trying to compress it can lead to permit exceedances at startup. The process mechanical superintendent keeps loop checks and equipment turnover moving at the pace mechanical completion requires. And operator trainers and owner operations staff need to be involved before biological startup so normal operations, alarm response, and emergency procedures are practiced before handover.
One rule stands out: key Phase 5 roles should be fully engaged at least 6–12 months before planned mechanical completion and stay in place through regulatory acceptance. Commissioning managers and process-experienced superintendents are among the scarcest profiles in water treatment construction [1]. That makes early recruiting a schedule protection move. In Phase 5, staffing protects permit compliance, not just punch-list closeout.
The biggest startup delays usually come from late long-lead equipment procurement, permitting hurdles, and shortages of specialized talent.
Startup work depends on tight system integration. That means one missed dependency - like a delayed equipment delivery or poor MEP and SCADA coordination - can set off a chain reaction. A late commissioning lead, weak controls integration during design, or no backup for a key role can turn a manageable issue into a major bottleneck.
Long-lead equipment should be ordered as early as project kickoff or during the conceptual design phase. That matters because key items like switchgear, generators, and transformers can take more than 12 months to arrive. In plain terms, teams often need to make procurement calls before the design is fully finished.
A dedicated pre-construction phase for long-lead procurement helps teams lock in specs early and line up the building layout with the systems they choose. Those milestones should also be built into the Critical Path Method schedule so the project doesn’t get held up later.
Hire leadership and project controls roles during planning and feasibility, ideally 4 to 6 months before mobilization. The first hires should usually include the Project Executive, Development Manager, Owner’s Representative, Cost Manager, and Scheduler or Project Controls Lead.
It also pays to bring in a Commissioning Manager during design and preconstruction. That person can set testing requirements early, help prevent costly rework, and cut down handover delays.
