Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
One bad commissioning miss can cost a lot. In data centers alone, downtime can hit $8,851 per minute and about $740,357 per incident.
If I were hiring for a mission-critical project in 2026, I’d keep it simple:
In plain terms, this guide shows who to hire, when to hire them, what they usually cost, and where to find them. It also explains why a data center team may need 5 to 15 people, while a power project may run leaner but still need deeper niche skill.
A fast way to think about it:
Bottom line: I’d treat commissioning hiring as schedule and risk control, not just staffing. The article below breaks that down in a clear way.
Before you open requisitions, get clear on which commissioning roles the project needs right now and who owns each stage. A project moving into integrated systems testing needs a very different bench than one still working through pre-functional checks.
That decision has a ripple effect. The wrong role mix can lead to schedule holes, test delays, and higher turnover risk. It also shapes headcount, pay, and whether you need broad generalists or people with deep discipline knowledge.
The table below maps the five core commissioning roles found on many U.S. mission-critical projects, along with what each one owns day to day.
Technicians handle field checks and document support. Engineers take ownership of scripts, analysis, and corrective action.
A Commissioning Manager becomes necessary when a project includes multiple disciplines, tight schedules, or high-risk startup sequences where one missed dependency can throw off everything that follows. At that stage, coordination is a full-time leadership job. It’s not something an engineer can just squeeze in alongside their own technical scope.
On larger mission-critical builds, generalist commissioning engineers often don’t go deep enough. Discipline specialists bring sharper system knowledge and clearer deliverable ownership across three main areas.
Electrical commissioning engineers focus on UPS systems, switchgear, generators, protection relays, and power distribution. Mechanical commissioning engineers cover chillers, CRAHs/CRACs, cooling loops, pumps, and HVAC sequences. Controls, BMS, and EPMS specialists handle building automation, power monitoring, point-to-point verification, alarm testing, and controls integration.
Each specialty calls for different system depth and different interview signals. A general commissioning engineer might be solid overall, but that person usually won’t cover relay coordination, chiller sequencing, and EPMS logic at the same level.
Role mix also shifts by sector. That’s why demand and team structure look different across data centers, power, and manufacturing.
A practical ownership model gives the Commissioning Manager responsibility for execution sequencing and cross-stakeholder coordination. The GC manages construction completion and trade readiness. OEM field service teams support equipment-specific startup within their scope. Operations staff approve readiness for live use and join final acceptance. The Owner-side commissioning representative serves as the owner’s day-to-day point of contact on site, keeping execution aligned with the owner’s priorities from pre-functional checks through IST and final turnover.
That coordination model also affects hiring urgency, compensation, and team size by sector.

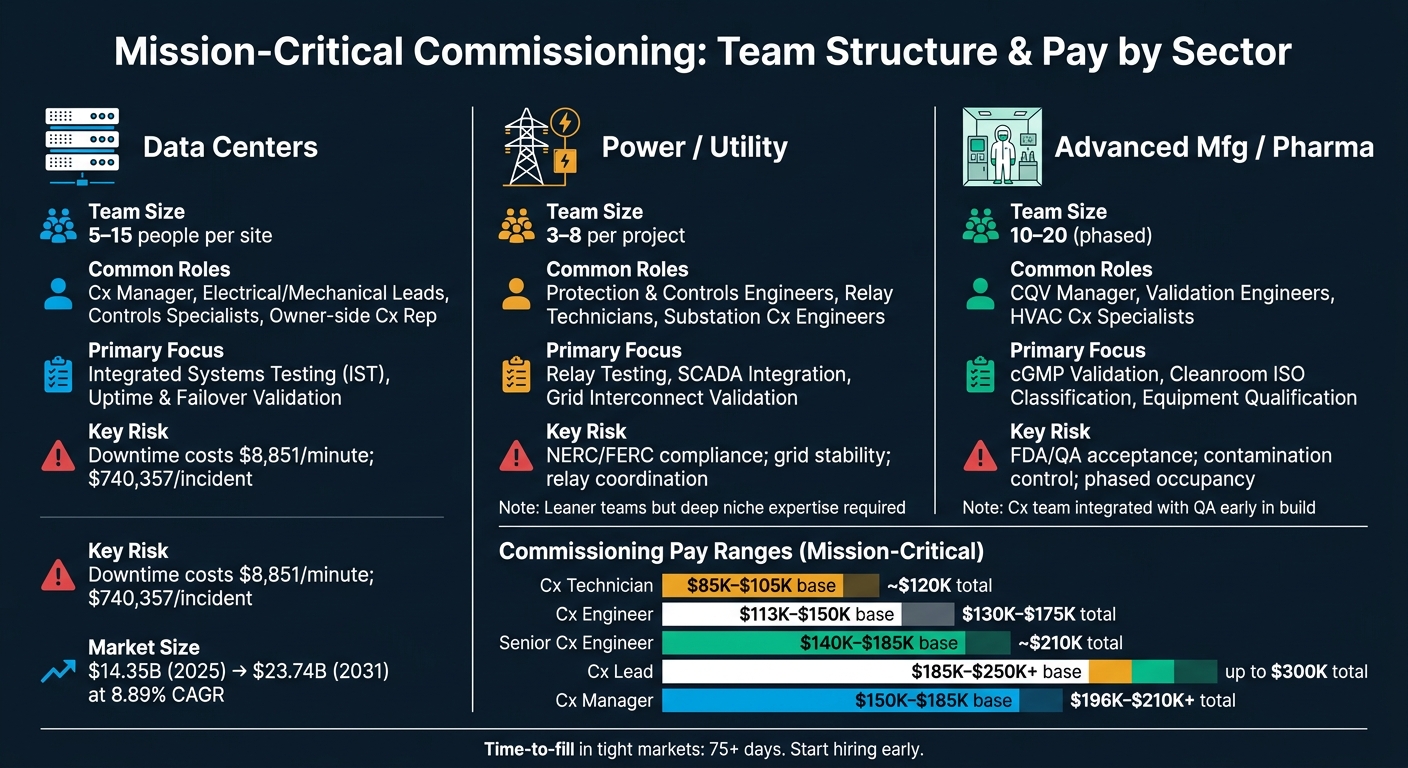

Mission-Critical Commissioning: Team Structure & Pay by Sector
Data center construction is a major force behind commissioning demand. In the U.S., the market hit $14.35 billion in 2025 and is projected to reach $23.74 billion by 2031, growing at about 8.89% CAGR.[4]
That growth isn't happening in a calm market. In some North American markets, vacancy rates have fallen to 1%, and 92% of new capacity is pre-leased before delivery.[5] When space is that tight, owners can't afford delays. Turnover dates become hard deadlines, and that pressure lands right on commissioning teams.
Power upgrades and advanced manufacturing are adding more strain. Grid modernization, semiconductor fabs, and pharmaceutical plants all need people who understand MEP systems, controls, and high-stakes startup work. And that's where the bottleneck shows up.
Commissioning talent is harder to find than general construction talent across most U.S. markets.[2][3] The pool is smaller because these jobs call for hands-on mission-critical experience, not just broad construction knowledge. As a result, hiring takes longer, and candidates often get counteroffers once they hit the market. You can see that most clearly in compensation and team design.
Pay in mission-critical commissioning starts with role level. After that, sector, location, travel load, and depth of credentials all shape the package.
There's also a clear gap between general commissioning and mission-critical work. General commissioning engineers often land in the low $80,000s to low $140,000s in total compensation. Mission-critical data center roles, by contrast, often reach $130,000–$180,000+.[2][3] At senior and principal levels, pay climbs fast.
Another pattern stands out: mission-critical roles often put more money into incentives than base pay. Bonuses are commonly tied to schedule performance and uptime.
These ranges shift by sector, travel demands, and sign-off authority. A lead who can travel heavily and carry final acceptance responsibility will usually earn more than someone in a narrower site role. Same title, different weight.
Team structure needs to fit the asset and the cost of failure. A small mistake in one sector might mean rework. In another, it can mean downtime, compliance trouble, or a system event no one wants to explain.
Data centers often run with two commissioning tracks: one on the owner side and one on the GC side. That setup works only when handoff points and acceptance authority are spelled out with no gray area.
Power projects are usually leaner on headcount, but they demand deep niche skill, especially in protection and controls. A misoperation during commissioning can have grid-wide consequences.[1] That's why these teams may look small on paper but still be hard to build.
Advanced manufacturing and pharma projects work a bit differently. Commissioning is tied closely to validation and qualification, so the Cx team isn't just brought in near the finish line. They work alongside quality assurance early in the build, which changes both staffing mix and hiring timing.
Those staffing patterns should shape how you source, screen, and close candidates next.
Once the role mix is set, screen for proof of commissioning work, not just general construction time on a resume.
For mission-critical commissioning roles, you need people with solid MEP and controls depth, plus hands-on IST experience in tight schedule conditions. The strongest candidates can show that they’ve actually tested and commissioned systems themselves. That means writing or running test scripts, tracking deficiencies, working with trades, and confirming corrective actions before turnover.
Certifications matter, but they should be treated as screening signals, not proof of performance on their own. OSHA 10/30 and NFPA 70E-related training are baseline needs for anyone working around energized equipment. PE licensure, Uptime Institute ATD/ATS, and commissioning credentials from ACG, BCA, or NEBB can help strengthen a profile. But project results should carry more weight, especially documented startups, IST execution, and clean handovers.
Scenario-based interviews tend to work well here. Ask how a candidate would respond to a generator failure during IST or how they’d trace a BAS/EPMS alarm chain. Then go one step further and review actual test scripts, checklists, and punchlists. That’s often where depth becomes clear.
Once you know what “good” looks like, the next step is to source from talent pools where people have already done this kind of work.
A strong place to start is with OEM field service engineers, MEP contractor staff, controls integrators, and plant startup teams. Those backgrounds line up closely with the discipline roles in the role map - electrical, mechanical, and controls - and usually bring the system-level depth the work calls for.
Plant startup staff and facilities operators from power, manufacturing, and pharma can also be a good fit. For lead roles on Tier III/IV data centers and utility-scale power projects, direct sector experience is a must. Junior and mid-level hires are a bit different. You can often build those roles from nearby technical backgrounds, as long as onboarding is structured and tied to a seasoned commissioning manager.
If the search covers multiple regions or has to land inside a narrow IST window, a specialized recruiting partner can cut down time-to-fill.
That’s where iRecruit.co can help. iRecruit.co supports time-sensitive commissioning hiring for mission-critical projects through recruitment, RPO, and consulting. Their team brings pre-qualified candidates and a streamlined hiring process, along with a 90-day replacement credit to lower hiring risk on critical roles.
Treat commissioning hiring as risk management. Define roles early so test plans, coordination gaps, and system issues show up before IST, not after turnover dates are already under pressure. Once those roles are clear, timing becomes the next risk point.
That approach shifts by asset class. Match team depth to project risk: hyperscale data centers, Tier III/IV sites, utility-scale power, and regulated advanced manufacturing need senior managers and discipline leads. Simpler industrial projects usually don’t. If the team is too small, problems stack up fast. If it’s too large, labor costs climb without enough return.
Higher-risk work and tighter talent pools push pay higher. Budget for mission-critical pay premiums: U.S. commissioning pay often lands above general commissioning rates, and tight markets can push time-to-fill past 75 days.[6]
When pay isn’t enough to fix the shortage, sourcing strategy matters more. If the local pipeline is thin, bring in adjacent technical talent - OEM field engineers, NETA testers, controls integrators, and startup staff - then support them with a seasoned commissioning manager and structured onboarding. If schedule pressure is high and internal recruiting bandwidth is limited, iRecruit.co can help cut time-to-fill and improve hiring quality for critical commissioning roles.
The best commissioning hiring plan matches staffing depth, pay, and sourcing speed to project risk.
Start hiring commissioning staff in the initial project planning phase, ideally during site selection and permitting. Bringing in commissioning leadership before installation starts helps set testing requirements and line up vendor documentation from day one.
Commissioning managers can take 60 to 90 days or longer to hire. Starting early helps avoid schedule slips and costly rework later.
Start with your project scope, tier target, delivery model, and the commissioning lifecycle (L1–L5). Those inputs shape how much oversight you need and how deep the technical work has to go.
For most mission-critical projects, that usually means a mix of:
Bring in commissioning leadership early so testing requirements are set before installation begins.
The strongest backgrounds tend to come from people with direct, hands-on experience in mechanical and HVAC field work, electrical power systems, BAS/BMS controls, TAB, and critical facilities operations.
In practice, candidates from high-stakes settings like semiconductor fabs, pharmaceutical manufacturing, hospitals, laboratories, and utility power often make the move more smoothly than people coming from general commercial construction. Why? They’re used to working where mistakes carry a bigger cost and systems have to perform as expected.
The people who stand out most usually bring hands-on startup and testing experience, strong multi-trade coordination skills, and deep knowledge of power distribution, cooling systems, and IST.
