Data Center Commissioning Careers: Cx Agent to Cx Manager

By:
Dallas Bond

If you want the short answer: a Cx Agent runs field checks, a Senior Cx Engineer leads test planning, and a Cx Manager owns schedule, risk, and turnover. That’s the career path in plain English.

I’d sum it up like this: the job shifts from doing the work, to leading the work, to owning the result. And that shift matters more now because North American data center construction under construction hit 6,350.1 MW in 2024, up from 456.8 MW in 2020 - about 12x more work in four years.

If you’re trying to understand this path fast, here’s what matters most:

  • Cx Agent: field checklists, startup support, issue logging, test data
  • Senior Cx Engineer: test scripts, sequence review, go/no-go calls, IST support
  • Cx Manager: client updates, gate approvals, turnover readiness, full program control
  • Common path in experience: about 0–3 years, then 3–7 years, then 8–15+ years
  • Typical U.S. base pay: about $85,000–$105,000, $110,000–$140,000, and $150,000–$230,000+
  • Main skill shift: componentssystemssite-wide accountability

A simple way I look at it: if you can only complete checklists, you’re still at the field stage. If you can plan tests and stop bad ones, you’re moving into engineer territory. If you can defend schedule and turnover calls under pressure, you’re closer to manager level.

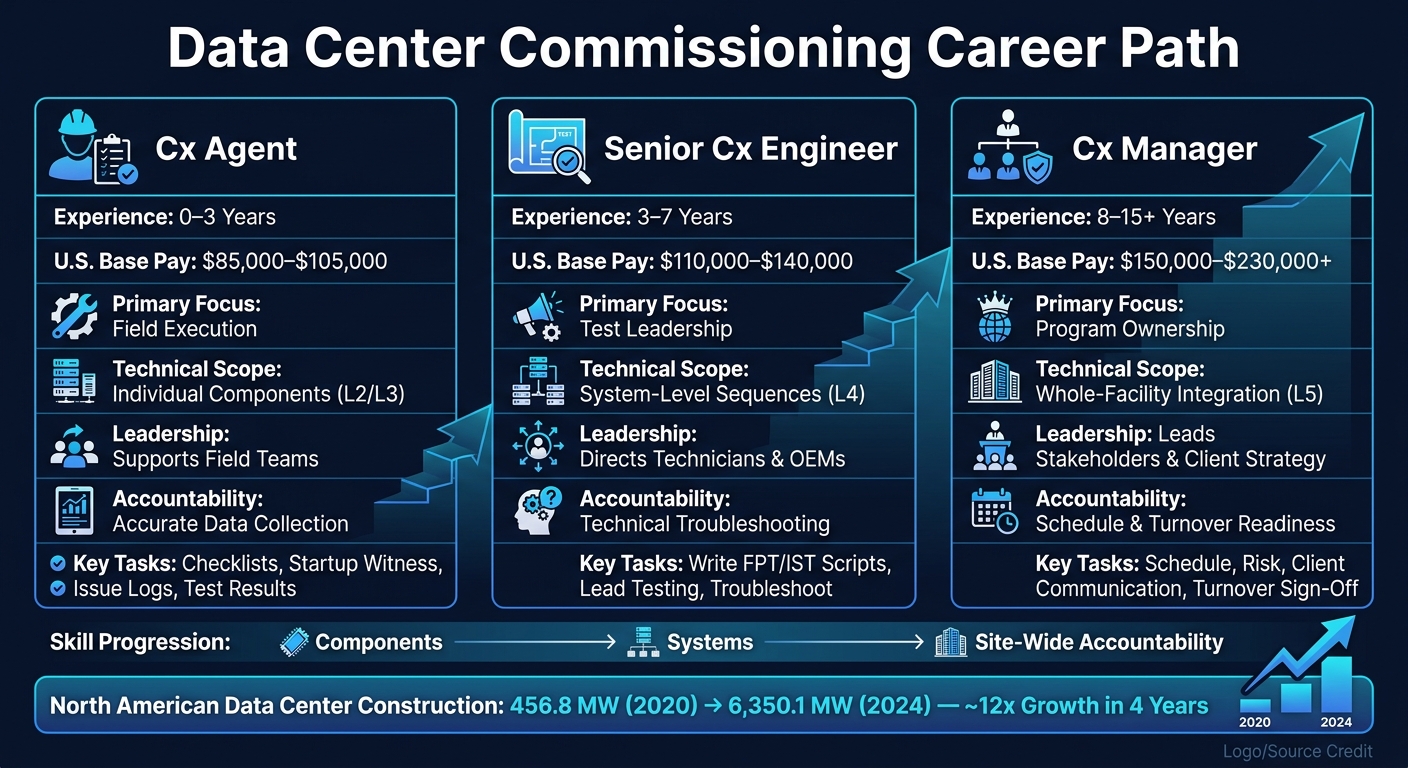

Data Center Commissioning Career Path: Cx Agent vs. Senior Cx Engineer vs. Cx Manager

Data Center Commissioning Career Path: Cx Agent vs. Senior Cx Engineer vs. Cx Manager

Data Centers from a Field & Commissioning Perspective

This field perspective is critical as commissioning talent is harder to find in today's competitive market.

Quick Comparison

Role Main focus Typical work Experience U.S. base pay
Cx Agent Field execution Checklists, startup witness, issue logs, test results 0–3 years $85,000–$105,000
Senior Cx Engineer Test leadership Write FPT/IST scripts, lead testing, troubleshoot 3–7 years $110,000–$140,000
Cx Manager Program ownership Schedule, risk, client communication, turnover sign-off 8–15+ years $150,000–$230,000+

Bottom line: this career path is less about job title and more about how much scope, risk, and handoff responsibility you can carry from design review through Level 6 turnover.

Commissioning Workflow, Deliverables, and Daily Project Work

Commissioning is a gated sequence of tests and handoffs that takes a data center from construction to turnover. Early on, the work happens in the field. Later, that same work shifts into test planning and then into program oversight. That shift shapes the day-to-day tasks, the paperwork, and the calls people make. It’s also what separates a field-focused Cx Agent from a program-focused Cx Manager.

Commissioning Levels and Key Test Stages

Data center commissioning uses Levels 0–6 to track progress from planning through turnover. These levels make it easier to see where each role matters most on schedule-driven work.

Level Phase What Happens
L0 Planning & Design OPR, basis-of-design, commissioning plan
L1 Factory Acceptance Testing OEM witness tests
L2 Installation Verification Site checks, labeling, drawing conformance
L3 Startup Initial energization and equipment startup
L4 Functional Performance Testing Verify sequences of operation
L5 Integrated Systems Testing Simulate utility loss and recovery
L6 Turnover & Acceptance Closeout, training, handover

Each gate acts as a schedule control point. For example, Level 2 installation verification for electrical systems like switchgear, UPS, and PDUs is often required before those systems can be energized safely. Level 4 FPT is also a big checkpoint. It’s usually the last stage where major defects show up before go-live.[2]

Trying to rush past a gate may look like a time saver on paper. In practice, it usually does the opposite. Problems found late cost more, take longer to fix, and can throw off later test events.

Documents and Tools Commissioning Staff Use in the Field

Each commissioning level produces its own set of deliverables. In the field, Cx Agents spend a lot of time working from startup and pre-functional checklists. These documents confirm that equipment is installed, wired, and labeled the right way before energization.

FPT scripts lay out step-by-step test procedures, expected results, and pass/fail criteria for system-level testing. IST matrices map out which systems are part of each failure scenario, what a passing result looks like, and which monitoring points need to be watched.

There’s also the operating side of the job. MOPs and SOPs help teams run tests safely and check that procedures will work during day-to-day operations after handover. Issue logs, punchlists, and retest records sit at the center of issue tracking and keep changing as the project moves forward. At closeout, O&M manuals and training records complete the turnover package.

Common tools include:

  • Commissioning software for field data capture and test tracking
  • Project controls platforms for coordination and issue management
  • Electrical modeling tools
  • BMS and EPMS monitoring systems
  • Platforms such as CxAlloy and Procore

Employers don’t just look at whether someone can stand there and witness a test. They look at whether that person can control the documents, track issues, and keep the job moving.

How Issue Tracking and Turnover Coordination Affect Project Outcomes

Deficiency management has a direct effect on schedule risk. When issues are logged with clear descriptions, equipment tags, severity ratings, and assigned owners, contractors can fix the right problems before the next test milestone hits.

That matters a lot when the issue is tied to critical gear. A UPS wiring problem or a bad BMS sequence found late - without a clear retest plan - can force the team to repeat a major test event. That adds labor cost and pushes back go-live.[3] Clean issue tracking helps protect energization dates, turnover timing, and client acceptance.

Turnover coordination pulls the whole job together at the end. A strong turnover package includes as-built drawings, commissioning reports, O&M manuals, and MOPs/SOPs in an organized digital format. It also means BMS and EPMS alarms are set up the right way and documented clearly.

Just as important, good turnover gives operations staff time to see how systems behave before live IT load comes online. That handoff quality sets up the role-by-role differences in the next section.

Role Breakdown: Cx Agent, Senior Cx Engineer, and Cx Manager

That handoff only works when these three roles move in order. Where one job stops and the next one starts matters a lot, both for someone thinking about a career move and for an employer trying to staff a job the right way.

Cx Agent: Field Execution, Checklists, and Functional Testing

The Cx Agent handles the field side of the work. Day to day, that usually means walking the site to verify equipment matches the drawings, checking nameplate data, confirming wiring terminations, and completing pre-functional checklists.[12][4]

During startup and Level 4 functional performance testing, the Cx Agent runs test scripts prepared by senior engineers and records the results.[5] If something fails, they document the issue clearly so the right contractor can fix it before the next round of testing.

Reading single-line diagrams, control schematics, and sequences of operation isn't a nice extra. It's part of the job. The same goes for working directly with OEM technicians and trade partners in the field.

Most Cx Agent roles ask for 0 to 3 years of mission-critical experience. A background in electrical, mechanical, or controls work is the usual way in. In the U.S., base pay often falls between $85,000 and $105,000 per year, though heavy travel and hot markets can push that higher.[6]

As the job gets bigger, the focus shifts from running tests to planning them.

Senior Cx Engineer: Test Planning and Technical Leadership

At this stage, the work changes in a pretty clear way. Instead of mainly executing tests, the Senior Cx Engineer writes them, updates them, and makes sure they're followed.

A Senior Cx Engineer develops functional performance test and integrated systems test procedures, ties them back to the Owner's Project Requirements, and leads execution in the field.[8] That includes assigning work to Cx Agents, working with controls vendors to check alarm logic and failover sequences, and sorting out high-risk problems like sequence-of-operations conflicts, unexpected system trips, and chiller plant instability that a junior agent would kick up the chain.

This role comes with decision-making power. If prerequisites aren't met or results look off, the Senior Cx Engineer can stop the test, call for a retest, or escalate the issue.

Most people in this role bring 3 to 7 years of mission-critical experience. Some also have commissioning credentials and manufacturer training.[11] In the U.S., base pay usually lands between $110,000 and $140,000, with project difficulty and location driving most of the difference.[6]

At the top of the ladder, the focus moves from technical control to program control.

Cx Manager: Program Ownership, Team Leadership, and Client Accountability

The Cx Manager owns the big picture: scope, schedule, risk, and client communication. In practice, that means owning the commissioning plan, gate approvals, and schedule integration.[7][9] It also means being the main point of contact for the owner or hyperscale client, leading status reviews, building risk dashboards, and signing off on turnover readiness.

Dimension Cx Agent Senior Cx Engineer Cx Manager
Primary focus Field verification & checklists Test writing & L4 execution Program ownership & L5 IST
Technical scope Individual components (L2/L3) System-level sequences (L4) Whole-facility integration (L5)
Leadership Supports field teams Directs technicians & OEMs Leads stakeholders & client strategy
Accountability Accurate data collection Technical troubleshooting Schedule & turnover readiness

Cx Managers usually bring 8 to 15+ years of commissioning and mission-critical experience, plus several full project cycles.[7][10] They're judged on schedule performance, issue closeout, and turnover readiness. In the U.S., base salaries often range from $150,000 to $230,000+, and bonus plans tied to project delivery and client satisfaction can push total yearly pay far past base salary.[9]

How to Move from Cx Agent to Cx Manager

Once the role differences are clear, the next question is what actually changes as you move up. In most cases, moving forward has less to do with time served and more to do with how much ownership you can handle. First, you execute in the field. Then you lead testing. After that, you take control of the full program. On large U.S. data center projects, strong performers in hyperscale settings can move through those steps faster by taking on more scope, more risk, and more accountability at each stage.[1]

Technical Skills That Grow at Each Career Stage

As a Cx Agent, your base is built around individual systems: low-voltage electrical panels, PDUs, UPS modules, CRAC/CRAH units, and BAS point verification. At this stage, the job isn't just checking boxes. You need to know each system well enough to spot problems during execution and understand what the test result is telling you.

The move to Senior Cx Engineer changes the frame. Now you're thinking across systems, not one piece at a time. You may write and refine test procedures that run through medium-voltage switchgear, standby generators, UPS and battery strings, chilled water plants, and integrated controls. You also start helping shape IST failure scenarios, like a utility loss, a UPS trip, or a chiller fault, and you need to understand how one failure can ripple through the rest of the site.

By the time you're ready for a Cx Manager role, the view is site-wide. You're looking at how multiple data halls, redundant utility feeds, generator farms, and N+1 or 2N setups behave under stress. You also need enough fluency in fire and life safety systems, including pre-action sprinklers, emergency power off, and detection logic, to make sure commissioning work doesn't create code or safety exposure during live testing.

A good way to build that range is to get close to the work that sits one level above you:

  • Shadow IST planning
  • Draft test scripts
  • Own issue logs
  • Read single-line diagrams, P&IDs, and control sequences

As your scope grows, coordination and judgment start to matter just as much as technical depth.

Leadership, Communication, and Decision-Making at Each Level

At the Cx Agent level, communication is mostly internal. That means writing clear issue notes, escalating on time, and reporting field conditions without confusion. Senior Cx Engineers spend more time coordinating with others. They lead daily huddles, run system-specific commissioning meetings, and often become the main point of contact for OEM reps during specialized equipment startups.

This is also where tougher calls begin. A Senior Cx Engineer may stop a test because prerequisites aren't met, call for a retest, or escalate a controls conflict that could hit the IST schedule. That's a different kind of pressure than field execution.

The Cx Manager role brings another shift. The job is no longer just fixing technical problems. It's about sizing up risk and standing behind a recommendation in front of senior owner stakeholders. For example, a Cx Manager may approve a partial IST to protect turnover, then document the remaining tests and line up the follow-up plan with operations. That kind of call, made under schedule pressure and explained in a clear, structured way, is what separates a manager from a lead engineer.

Career Stage Leadership & Communication Focus Key Decision-Making Authority
Cx Agent Accurate field reporting; timely escalation Verifying installation quality via checklists
Senior Cx Engineer Daily huddles; OEM and trade coordination; focused commissioning meetings Technical troubleshooting and test go/no-go decisions
Cx Manager Owner, GC, and operations alignment; executive risk reporting Program-wide risk, schedule, and turnover readiness decisions

Qualifications, Certifications, and What Employers Look For When Hiring

Hiring usually comes down to proof that you've owned the work, not just the letters after your name. Most Cx Agents come from trade backgrounds, such as electrician, HVAC technician, or controls tech, or from junior engineering roles, often without formal commissioning credentials.[1] For Senior Cx Engineer roles, a bachelor's degree in electrical, mechanical, or industrial engineering is more common, and certifications like the Certified Commissioning Authority (CxA) or Certified Commissioning Professional (CCP) carry weight. At the Cx Manager level, a Professional Engineer (PE) license in mechanical or electrical engineering can help, especially when the role calls for reading design intent, though it is not required across every data center project.[13][14][15]

Most hiring managers are pretty direct about what matters most: mission-critical project experience beats credentials alone. A candidate who has led ISTs on hyperscale or colocation projects, produced clear commissioning reports, and managed an issues log through turnover will often stand out more than someone with certifications but little field exposure.[13][14]

Mission-critical recruiters often help candidates show that experience in a way hiring teams can judge fast. That may include commissioning case studies, documentation samples, issue resolution examples, and clear risk communication so employers can better see who is ready for the next step.[14][16]

Conclusion: What Separates a Strong Cx Agent from a Ready Cx Manager

Taken together, the move from Cx Agent to Cx Manager is a move from execution to ownership. The line between a strong Cx Agent and someone ready for a Cx Manager role isn't just time on the job. It's the shift from owning tasks to owning outcomes. A Cx Agent shows value through accurate field execution. A Senior Cx Engineer adds test planning and troubleshooting. A Cx Manager owns program risk, schedule, and turnover. [20][22][19]

That step matters because demand is strongest for people who can own outcomes under schedule pressure. Demand stays strong across major U.S. data center markets, and teams that can show ownership and close turnover cleanly remain in the highest demand. [18][19]

For hiring teams, the takeaway is pretty clear. When a job post separates a Cx Agent who executes startup and functional tests from a Cx Manager who oversees integrated systems testing and readiness sign-off, candidates can match themselves to the role with less guesswork. Hiring teams also spend less time sorting through mismatched applicants. Role confusion slows testing, weakens documentation, and adds handover risk. [17][21]

For candidates, the step up happens when you can consistently own outcomes, not just complete checklists. Readiness comes from owning outcomes, not just stacking up years.

FAQs

How do I know when I’m ready to move from Cx Agent to Senior Cx Engineer?

You’re ready when you can reliably lead L4 functional performance testing and own Level 5 integrated systems testing, especially when schedule risk starts to climb.

The best way to show that isn’t with broad claims. It’s through the work you’ve already led: clear test documentation, strong cross-trade coordination, and disciplined issue logs that push deficiencies through to closure.

For senior roles, employers usually look for BCxP/CBCP plus CDCPM.

Which certifications help in data center commissioning careers?

Certifications can help you get past the first round of screening and show that you know the field. But on their own, they usually aren't enough. They matter most when they're backed by hands-on experience on mission-critical projects.

Here’s how that often looks by career stage:

  • Entry-level roles: OSHA 30 and NICET I or II
  • Mid-career roles: BCxP or CBCP and CDCPM
  • Senior, management, electrical testing, or energy-focused work: PE license, Uptime Institute ATD or ATS, DCEP, and NETA certifications

That’s the basic pattern: certs help open the door, but project experience is what gives them weight.

Is data center commissioning a good long-term career path?

Yes. Data center commissioning is a strong long-term career path.

It sits in a specialized, high-tech corner of the market, and demand keeps growing as AI infrastructure expands and power needs climb.

Commissioning also plays a key risk-management role. That matters. Companies need people who can help systems work as intended before a site goes live, which is why skilled pros are in demand.

Pay can be strong too. Senior people in the field often reach $200,000 to $300,000+. And the path tends to be pretty clear, moving from field roles into leadership over 6 to 15 years.

Related Blog Posts

Keywords:
data center commissioning, commissioning careers, commissioning agent, senior commissioning engineer, commissioning manager, functional performance testing, integrated systems testing, turnover readiness
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Commissioning Agent Salary 2026: Data Center Cx Pay Guide
August 17, 2026

Commissioning Agent Salary 2026: Data Center Cx Pay Guide

Data center commissioning pay in 2026 hinges on role, travel, and skills - base salary hides big overtime, per diem, and market premiums.
Solar Construction Jobs: Utility-Scale Careers & Pay 2026
August 17, 2026

Solar Construction Jobs: Utility-Scale Careers & Pay 2026

Utility-scale solar hiring is booming—BESS, commissioning, and travel-ready field roles command higher pay and faster hires.
Design Manager Salary 2026: What Builders Pay for D&E Talent
August 17, 2026

Design Manager Salary 2026: What Builders Pay for D&E Talent

2026 U.S. benchmarks for Design Manager pay: base ranges, bonuses, and sector/regional premiums across data centers, healthcare, and energy.
What Is MILCON? Military Construction Explained
August 16, 2026

What Is MILCON? Military Construction Explained

MILCON is the appropriations-funded machinery behind military construction. How projects are authorized and funded, who delivers them, and what the $19.7B FY26 program means for construction careers.
