EHS Program Manager: Running Multi-Site EHS at Hyperscale and Gigafactory Campuses

By:
Dallas Bond

My rule for multi-site EHS: no verified controls, no work release. Across hyperscale and gigafactory campuses, I use one shared framework, with named owners and checks for each site’s hazards - from mobilization through handoff.

Here’s what I focus on:

  • Clear ownership: Separate program oversight, site duties, contractor responsibilities, and technical approvals.
  • Coverage that fits the work: Staff by phase, shift, and hazard. Check contractor qualifications and field practices before work starts.
  • High-risk work controls: Verify permits, isolation, lift plans, and boundaries between construction and live testing.
  • Readiness backed by proof: Track audits, incidents, permit duties, and corrective actions. Compare injury rates per 200,000 work hours, but never treat low rates as proof that work is safe.

I hire for the hazards each team will face - not titles alone. And I keep one requirement at every milestone: <u>verify the fix in the field</u> before approving the next step. That keeps safety tied to the schedule, not separate from it.

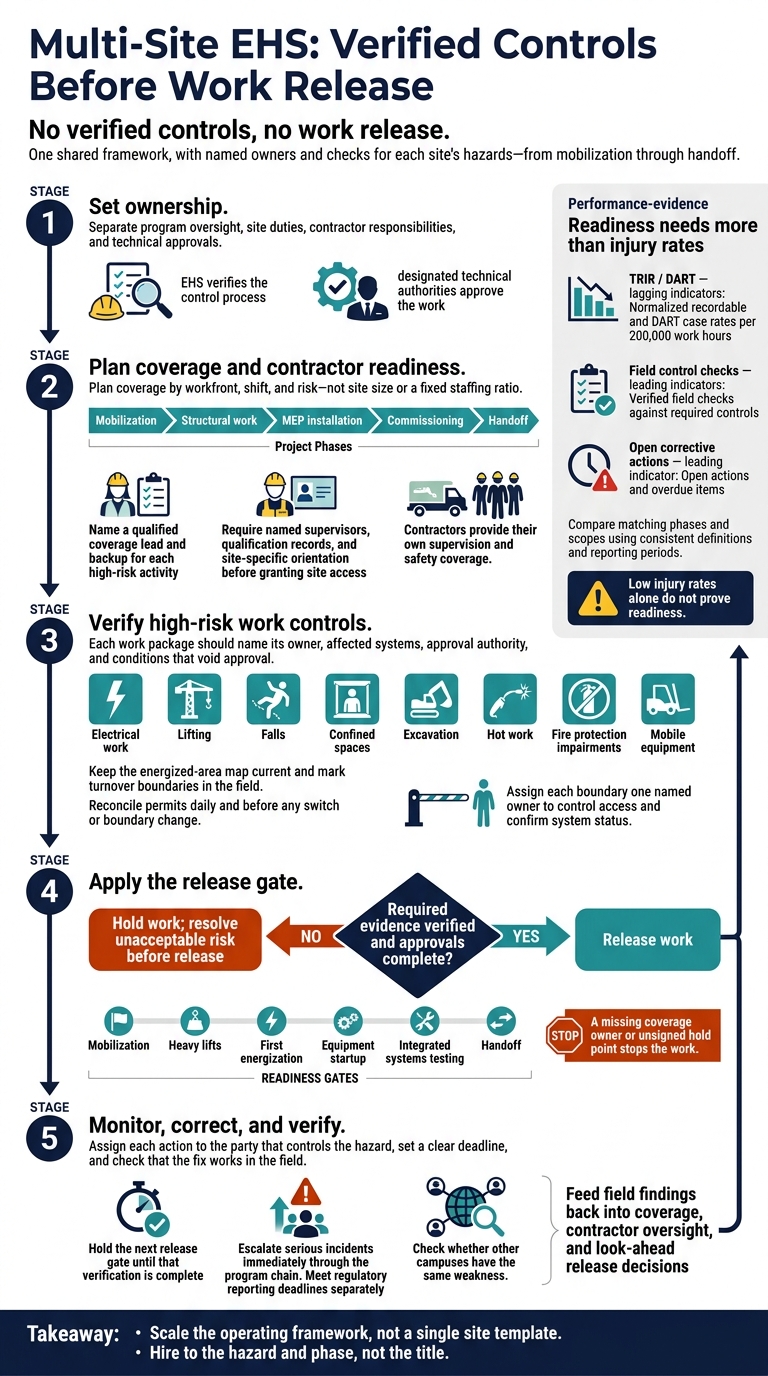

Multi-Site EHS: Verified Controls Before Work Release

Multi-Site EHS: Verified Controls Before Work Release

OSHA’s Multi-Employer Rule Explained (Most Contractors Miss This)

Plan EHS Coverage and Contractor Accountability

Once standards are set, assign staffing and contractor controls based on each phase and its risks.

Match Staffing to Project Phase and Risk

Plan coverage by workfront, shift, and risk - not site size or a fixed staffing ratio. Turn the standards into site-level staffing, contractor controls, and phase-specific oversight. Review workforce size, contractor count, overlapping activities, travel between work areas, and hazard severity. At hyperscale and gigafactory campuses, account for construction crews working beside commissioning teams. Name a qualified coverage lead and backup for each high-risk activity.

Phase Risk drivers Required roles to plan for Shift coverage Reassess when
Mobilization Arriving crews, temporary power, unfamiliar procedures Site EHS manager; contractor safety staff Cover onboarding and initial work shifts Contractors arrive or shifts expand
Structural work Heavy lifts, rigging, expanding concurrent work Contractor supervision; competent or qualified persons for lifting and rigging Cover lifts and concurrent work Lift plans, weather, or work areas change
MEP installation Increasing trade density, electrical exposure, exposure-generating work Contractor safety staff; qualified electrical personnel for LOTO and energized-work controls as needed Cover installation shifts and high-risk tasks Trade density or exposure changes
Commissioning Systems becoming live, testing, phased turnover Site EHS lead; commissioning safety and electrical specialists Extend coverage to testing windows, including nights Systems become live or testing boundaries move
Handoff Operating equipment, residual construction, permit obligations Site EHS lead; operations representatives Shift coverage to remaining work and operating interfaces Ownership or operating conditions change

Program and regional leaders should close coverage gaps across sites, while site EHS managers coordinate local oversight. Contractors provide their own supervision and safety coverage. CSP/CHST credentials can help screen candidates, but they don’t prove task-specific competence or replace designated-role requirements.

Check Contractor Readiness and Performance

Before mobilization, review project experience, safety programs, EMR, OSHA history, insurance, and site-specific safety plans. Require named supervisors, qualification records, and site-specific orientation before granting site access. Include reporting deadlines, audit access, corrective-action owners, and stop-work expectations in contractor requirements.

After mobilization, check field practices through daily walks and a weekly sample of pre-task hazard analyses. Verify qualifications, permits, and supervision where the work happens - not just in submitted files. A missing coverage owner or unsigned hold point stops the work. Escalate repeated deficiencies and overdue critical actions. Stop energized work performed without approval or a failed fire watch immediately. Restart only after verifying the correction. Use these checks to decide whether the site can take on the next phase.

Hire for Mission-Critical EHS Skills

Use scenario-based interviews supported by verified project experience. Ask candidates how they would coordinate electrical turnover, challenge an incomplete critical lift plan, separate live testing from construction, investigate a serious event, and escalate unresolved cross-site risks.

Look for NFPA 70E fluency and clear contractor intervention - not credentials alone. Give recruiters each role’s phases, shifts, reporting scope, and required technical skills. These hires must be able to run the controls for energized work, heavy lifts, and live testing.

Control High-Risk Work and Commissioning Boundaries

Use one release matrix across campuses to control work when installation and commissioning overlap. Once contractor readiness is confirmed, shift from people controls to task-release controls. Each work package should name its owner, affected systems, approval authority, and conditions that void approval. Link these hold points to hyperscale and gigafactory delivery schedules, especially where work meets live systems. EHS verifies the control process; designated technical authorities approve the work.

Activity Principal exposure Planning document Approval authority Field verification Stop-work trigger
Electrical work Electrical hazard Switching or isolation plan Qualified electrical authority Verify sources are isolated and the work area is controlled Missing isolation or authorization
Lifting Lift-related injury Lift plan Designated lift authority Verify the load path, equipment setup, and exclusion zone Any changed condition or failed verification
Falls Fall hazard Fall-protection plan Responsible supervisor Verify edge protection and rescue arrangements Missing fall protection
Confined spaces Atmospheric or entry hazard Entry permit and rescue plan Entry supervisor Verify monitoring, isolation, and rescue readiness Changed entry conditions
Excavation Underground utility strike hazard Excavation plan Competent supervisor Verify utility locations and protective measures Instability or unknown utilities
Hot work Fire or ignition hazard Hot-work permit Designated permit issuer Verify combustibles control and fire watch Missing fire watch or new ignition risk
Fire protection impairments Temporary loss of fire protection Impairment plan Designated impairment authority Verify affected zones, notifications, and compensating measures Impairment expands or compensating measures fail
Mobile equipment Vehicle-struck hazard Traffic plan Equipment supervisor Verify routes and pedestrian separation Pedestrian intrusion or equipment defect

As systems energize, controlling their boundaries becomes the main risk-control priority.

Verify Energization and Energy Isolation

Identify every energy source and require approved isolation before releasing work. Assign switching and isolation duties to qualified, authorized personnel. Hold energization if boundary information or approval is missing.

Verify Heavy Lift Plans and Site Conditions

Before releasing a lift, have the designated lift authority review the load, lift plan, and site conditions. Confirm exclusion zones and other field controls. Reassess the plan whenever weather, load, or site conditions change.

Once commissioning starts, live-system boundaries must govern the schedule.

Separate Construction Work From Live Testing

At the construction-to-testing handoff, keep the energized-area map current and mark turnover boundaries in the field. Reconcile permits daily and before any switch or boundary change. Assign each boundary one named owner to control access and confirm system status.

Hold conflicting work whenever testing could affect unfinished construction or another crew’s isolation. Restart only after the system owner and affected authorities verify the fix and update permits and boundaries.

After work is released, use audit and incident data to decide whether the next phase can stay open. Feed field findings back into coverage, contractor oversight, and look-ahead release decisions. Carry unresolved hazards into the next release gate. Standardize audit evidence across campuses so records are complete for audit and turnover review[2].

Close Corrective Actions and Escalate Serious Events

Track corrective actions through field-verified closure. Assign each action to the party that controls the hazard, set a clear deadline, and check that the fix works in the field. Hold the next release gate until that verification is complete. When findings repeat, tighten supervision or change the sequence of affected work.

Escalate serious incidents immediately through the program chain. Meet regulatory reporting deadlines separately. Investigate failed controls and the system conditions that contributed to the event, then check whether other campuses have the same weakness. Use repeat findings to adjust contractor oversight at every site.

Compare EHS Performance Across Sites

Use consistent definitions and reporting periods to compare matching phases and scopes, including contractor-level detail. For similar scopes, normalize results by work hours. The goal is to spot recurring control failures - not rank sites by raw incident totals.

Pair injury rates with control checks, environmental obligations, and open corrective actions. Low injury rates alone do not prove readiness.

Metric Definition Data owner Decision supported
TRIR / DART - lagging indicators Normalized recordable and DART case rates per 200,000 work hours[2] Safety manager; contractor reporting leads Identify trends that need deeper review
Field control checks - leading indicators Verified field checks against required controls Site EHS lead Target supervision and contractor oversight
Open corrective actions - leading indicator Open actions and overdue items Action owners; site EHS lead Escalate unresolved exposure

Use these comparisons to decide which sites can pass the next release gate.

Build EHS Readiness Gates Into the Schedule

Build gates into design reviews, logistics plans, look-ahead schedules, and commissioning plans. Define the evidence and approvers for each gate. Release work only after required evidence is verified and approvals are complete. Resolve unacceptable risk before release.

Milestone Evidence required Approvers
Mobilization Accepted contractor plans, verified personnel qualifications, required permits Construction manager; contractor lead; EHS lead
Heavy lifts Approved lift plan, completed inspections, verified crew qualifications Designated lift authority; construction lead
First energization Completed electrical inspections, verified energy isolation, verified personnel qualifications Qualified electrical authority; system owner
Equipment startup Approved startup plan, completed inspections, verified safeguards, completed personnel training Equipment/system authority; commissioning lead
Integrated systems testing Approved coordinated test plan, confirmed trade clearances, assigned supervision Commissioning lead; affected system owners
Handoff Completed required inspections, approved operating procedures, completed training, confirmed permit obligations Operations owner; technical authority

Conclusion: Scale EHS Oversight Without Weakening Controls

Scale the operating framework, not a single site template. Align shared standards with local risks, staffing by phase, contractor accountability, and verified controls for high-risk work. Manage campuses as one program so lessons from one site improve execution at the next.[3]

Once the operating model is in place, readiness checks, fast escalation, and field-verified closure help protect the schedule by identifying gaps early.

Use readiness findings to address the next staffing gap. Match unresolved risks at milestone gates with construction safety leadership for field execution, an EHS manager for commissioning and operations, or specialists for arc-flash, lithium-ion thermal runaway, or hazardous gas risks.[1][2] Hire to the hazard and phase, not the title.

FAQs

How do I prioritize EHS resources across competing site needs?

Plan at the program level. Use capital plans and project timelines to forecast staffing and resource needs 12 to 24 months ahead. Set up a central program office to keep safety standards, reporting, and audits consistent.

Rotate commissioning teams across sites as project phases change. This helps maximize coverage without adding permanent overhead. Bring EHS into preconstruction planning and align safety protocols with commissioning milestones to avoid last-minute resource gaps during electrical energization.

How should I resolve disputes over work-release readiness?

Base “go/no-go” decisions on documented, verifiable controls: applicable permits, LOTO, Energized Electrical Work Permits, and isolation verification. Give each corrective action an owner and a deadline, then verify closure in the field - not just on paper.

Use structured investigations to identify issues with training, supervision, schedule pressure, procedures, or trade interfaces. Turn the findings into visible changes supervisors can enforce. Route unresolved items through a single escalation path to program safety leadership before critical commissioning proceeds. [1][2]

How do I adapt shared EHS standards to local regulations?

Before fieldwork begins, hold a formal safety scope workshop to identify where corporate standards exceed local requirements. Use a standards matrix to map each work package to the applicable local and project-specific codes [1].

During preconstruction, work with local authorities having jurisdiction (AHJs) to ensure site-specific safety plans reflect regional requirements [2]. Add those requirements to site-specific risk registers and permit-to-work systems so teams apply them consistently across campuses [1].

Related Blog Posts

Keywords:
multi-site EHS, EHS program manager, hyperscale campuses, gigafactory safety, contractor accountability, verified controls, commissioning safety, energized work
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Construction Safety Engineer on Mission-Critical Builds: Scope, Certs, and Pay
October 1, 2026

Construction Safety Engineer on Mission-Critical Builds: Scope, Certs, and Pay

Evaluate scope, certs, field controls, and pay for construction safety engineers on data-center and power projects.
EHS Engineer vs EHS Specialist vs Safety Manager: Titles, Pay, and Who Hires Which
October 1, 2026

EHS Engineer vs EHS Specialist vs Safety Manager: Titles, Pay, and Who Hires Which

Match title, authority and pay to EHS work: engineers design controls, specialists enforce field safety, managers lead programs.
EHS Manager Job Description: What Owners Should Put in the Req
October 1, 2026

EHS Manager Job Description: What Owners Should Put in the Req

Owner-side blueprint for EHS manager requisitions: define scope, authority, 30/90‑day deliverables, contractor oversight, and hiring criteria.
Mountain States Data Center Jobs 2026: 8 Markets
October 1, 2026

Mountain States Data Center Jobs 2026: 8 Markets

Hiring priorities for eight Mountain States markets in 2026, ranked by project readiness, labor depth, pay pressure, and power timing.
