MIL-STD-810 testing takes five roles - not just someone who runs a chamber or shaker. I’d start by assigning who plans the tests, runs them, checks the records, and approves the outcome.
My rule: agree on test conditions, pass/fail criteria, and approval rights before testing starts. Then check readiness, record actual exposures, review failures and interruptions, and link each requirement to the final report.
<u>Passing a lab test is not the same as customer acceptance.</u> MIL-STD-810 provides test guidance, not universal certification. When hiring, I’d ask for a redacted plan, procedure, or report - not just an equipment list - to check which parts of this workflow the candidate owned.

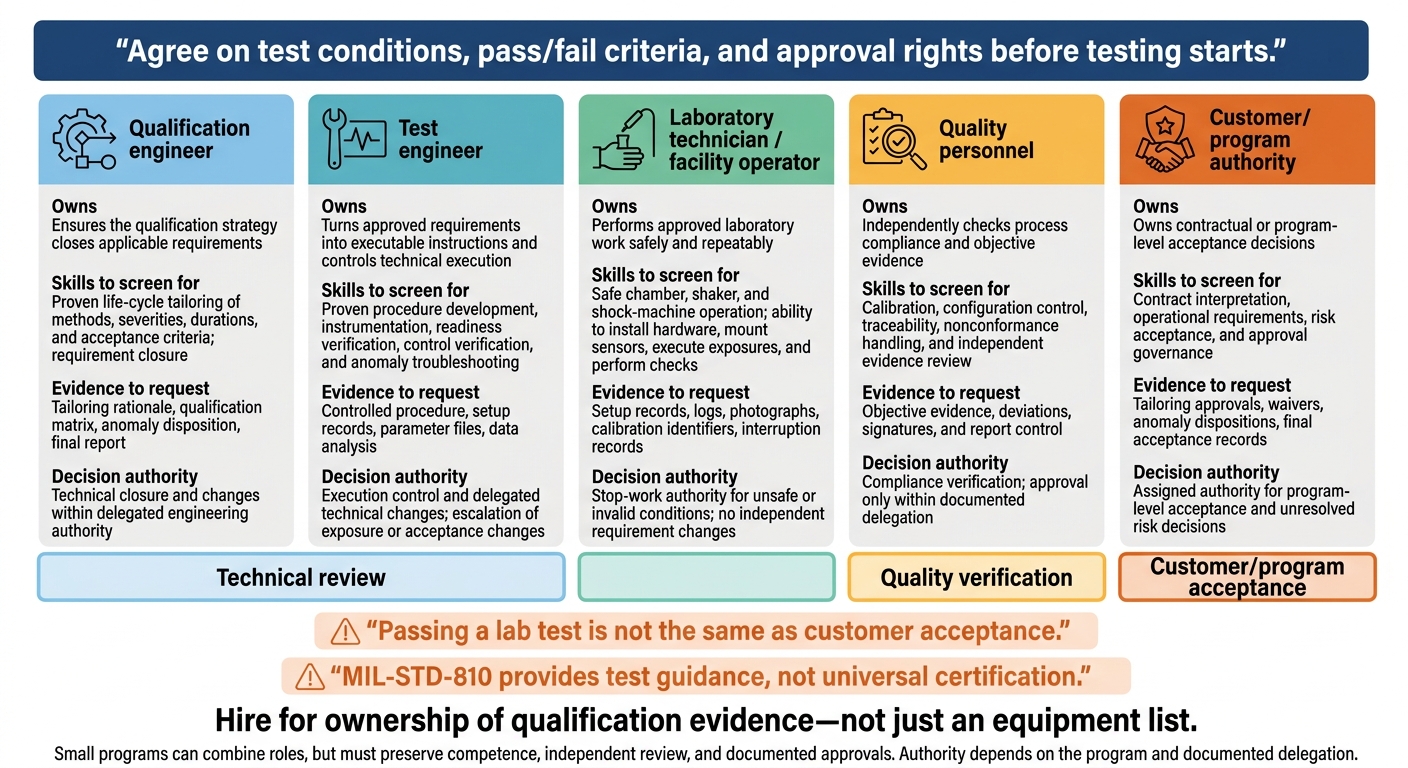

MIL-STD-810 Qualification: Five Roles and Decision Rights
Tailoring defines the test. The role map defines who owns each decision. Record approval authority in the contract, delegation matrix, or quality plan.[6][8][9]
Once the LCEP is defined, assign responsibility for planning, execution, review, and acceptance. Use the map below to staff each stage.
The qualification engineer turns environmental tailoring into an executable qualification plan. They translate the LCEP into a qualification matrix and close requirements through tailored methods, levels, sequence, checks, and acceptance criteria.[3][5]
A useful qualification matrix should include:
Hire for ownership of qualification matrices, not job titles. Confirm experience with tailoring and customer coordination - not just lab execution.
Execution starts only after the approved plan sets the test conditions and data requirements. The test engineer controls fixtures, instrumentation, tolerances, operating modes, and data collection. Technicians carry out the approved setup, operate the equipment, and record actual conditions and interruptions.
Give operators explicit stop-work authority for unsafe conditions, equipment faults, invalid instrumentation, or loss of test control. Before work resumes, preserve the evidence, assess test validity, and obtain a documented disposition. Changes to exposures or acceptance criteria require engineering review and the assigned approvals.[3]
Quality personnel and program authority confirm that the evidence matches the approved plan. Quality checks configuration, calibration, traceability, nonconformances, and report completeness. Program authority decides whether to approve tailoring, waivers, retests, or final acceptance.
Engineers assess whether the evidence meets requirements. The delegated authority approves changes within its assigned scope. Document witness-event disposition, and ensure disposition is recorded before acceptance.[3][6][9]
Use this workflow map to assign handoffs and approval gates, not just laboratory tasks. The table connects each role to the evidence and approvals needed from requirements through closure.
With ownership assigned, release the plan and confirm readiness.
The plan defines scope, criteria, controls, and approvals. The procedure explains how to run the test, step by step. Include configuration, tailoring, facilities, exposures, functional checks, safety, and records in the plan. In the procedure, specify installation, settings, limits, monitoring intervals, abort actions, recovery, and signatures.
Before release, verify equipment capability, current calibration, fixture suitability, sensor-channel continuity, item configuration, and recorded pre-test performance. A chamber’s advertised range isn't enough: it must also meet the required ramp, uniformity, and recovery conditions.
Once readiness is confirmed, control temperature, moisture, and dwell timing for each exposure.
Define sensor locations, dwell timing, ramp rates, powered state, and recovery. Separate unpowered storage from operation, cycling, and rapid temperature-shock transitions. Specify chamber uniformity, stabilization, when dwell timing begins, and functional monitoring.
Report temperatures in °C. Add °F equivalents only for orientation; do not change the governing values. For humidity tests, specify temperature and moisture sequences, expected condensation, recovery after chamber door openings, and controlled drying. Unapproved drying steps or early functional checks can change the evidence under evaluation.
Mechanical exposures also require defined inputs, controlled mounting, and clear abort limits.
Define profiles, axes, waveform, mounting, response sensors, sampling, notching, and abort limits. For vibration, specify duration, fixtures, control sensors, and approved notching. Verify mounting and channels, then record actual inputs.
Shock procedures must identify the source, waveform or response spectrum, load path, sampling and trigger settings, restraints, and inspection points. Combined-test procedures should state what happens when any environment or control channel goes outside tolerance. Use Method 520 only when the life-cycle profile calls for simultaneous stresses, not by default.[3]
After exposure, the work shifts from running the test to controlling the evidence. Completing an exposure does not establish compliance or acceptance. Records must connect the tested configuration, actual conditions, and functional results to the approved criteria.[3][4]
Technicians preserve raw files, logs, timestamps, photos, and as-run procedures. Test engineers check scaling, sensor attachment, calibration, data gaps, clipping, and measured versus commanded profiles. Qualification engineers determine requirement status, while quality checks completeness and approvals. Keep processed plots linked to their raw files, and document each data-reduction step.[7]
Separate facility events from item failures. Compare controller logs, exposure measurements, and functional results to establish what happened and when. Record deviations, the cause or leading hypothesis, and the effect on test validity.
For over- or under-test conditions, document the impact and obtain approval from the system authority before correction or retest. Preserve the original results, and identify whether retesting covers a repaired or revised configuration. Issue the required anomaly report to the procuring activity.[5][10]
Once the anomaly disposition is set, organize the record so another reviewer can trace the decision.
For closure, prepare a report that lets reviewers reconstruct the test. Include:
Link each requirement to its evidence location. State whether it was met, not met, or not tested, and clearly identify limitations and untested conditions.[5][7]
Keep technical review, quality verification, and customer/program acceptance separate. If any required approval is missing, mark acceptance pending. Report only the configuration and conditions actually tested. An approved waiver accepts a defined departure; it does not prove that the original criterion was met. Avoid “MIL-STD-810 certified” or bare “passed MIL-STD-810” claims.[3][4]
Define ownership before you hire: qualification engineers set strategy, test engineers direct execution, technicians run approved setups, quality verifies evidence, and customer/program authorities approve acceptance.[3][4] Match hiring decisions to these handoffs: tailoring, execution, data review, and acceptance.
Use this ownership map to screen candidates for the work they’ll control.
Ask candidates to walk through one redacted plan, procedure, anomaly, or report. Have them explain what they authored, reviewed, and approved. Equipment lists alone don’t prove qualification ownership.
Hire to close the weakest link in the workflow: tailoring, execution, evidence review, or acceptance.
Match the vacancy to the missing work. Hire qualification engineers for weak tailoring or requirement closure, test engineers for incomplete procedures, instrumentation, or analysis, technicians for setup and execution bottlenecks, and quality personnel for insufficient evidence review.
An unresolved acceptance decision needs a designated authority - not just another laboratory hire. Small programs can combine roles, but they must preserve staff competence, independent review, and documented approvals.
Keep qualification roles separate from construction, mechanical/electrical/plumbing, controls, and commissioning roles. Hire for ownership of qualification evidence, not laboratory infrastructure.
Yes - it depends on the program. In defense and aerospace, a Test and Evaluation Engineer often handles planning, facility or range scheduling, test execution, analysis, and the final report accepted by the customer.
On satellite programs, the Integration and Test Engineer and Test and Evaluation Engineer roles often overlap until qualification is complete.
For government test events involving munitions or UAS, responsibility for the overall campaign is typically separate from responsibility for executing each test event.
Environmental retesting is typically required when a design change affects an item, interface, or configuration that could change environmental performance. This applies especially to application-tailored MIL-STD-810 test methods.
Retesting takes place after approved engineering changes are implemented, when quality or mission assurance requires updated records. These records include as-run results and disposition. Failed or deviated conditions require retesting until the test data confirms that corrective actions worked [1][2].
Don’t rely on titles or certificates. Use reference checks to confirm end-to-end ownership: tailored test plans and procedures tied to the verification matrix, facility scheduling, test execution, data analysis, and an accepted qualification report.
Ask what tailoring they changed. Request hands-on details about MIL-STD-810 equipment setup, instrumentation, and reporting for temperature, vibration, shock, or humidity tests. Confirm their responsibilities with the test engineer or test director responsible for acceptance.
