October 3, 2026

Capital Equipment and Construction Sourcing Manager: The Role Gigafactories and Hyperscalers Hire

By:
Dallas Bond

I’d hire this role to protect project cost and startup dates - not just negotiate prices. With transformer lead times that can exceed 60 weeks, start sourcing from the commissioning deadline and work backward. Before award, confirm scope, supplier capacity, delivery dates, and installation responsibility.

For gigafactories and hyperscalers, I’d focus the role on three areas:

  • Packages: Production equipment, critical electrical and mechanical systems, and construction contracts.
  • Supplier commitments: Total installed cost, payment terms, testing, warranties, changes, and delivery tracking.
  • Hiring proof: Package ownership, contract experience, and examples of resolving delays - checked through interviews and a short award-memo exercise.

The boundary matters: this manager buys equipment and construction packages but does not run construction. I’d judge success by <u>readiness for commissioning</u>, with engineering, construction, and testing teams clear on who owns each handoff.

Job description of Procurement Manager - Role, Responsibilities & Skills

Role Responsibilities and Sourcing Scope

The manager handles sourcing plans, bid requests, commercial negotiations, award recommendations, contract administration, change control, delivery tracking, and closeout. Engineering or the Owner’s Engineer sets the technical requirements and freezes the basis of design. Owner approval rules then determine when commitments can be made. [4][5]

The sourcing approach varies by package, but the controls don’t: lock scope, price, delivery, and installation responsibility before award.

Gigafactory Production Equipment

This scope covers electrode coating, calendering, cell winding or stacking, formation and aging, inspection, automation, and material handling. [1] Bids from international OEMs must include freight, import duties, integration, and spare parts - not just the unit price. Every package must arrive in time to protect commissioning and first production.

Data Center Electrical and Mechanical Equipment

Transformers, switchgear, UPS systems, generators, and chillers determine when energization and integrated systems testing can begin.

Owner-furnished, contractor-installed (OFCI) means the owner buys the equipment and the contractor installs it. Contractor-furnished, contractor-installed (CFCI) puts both tasks with the contractor. Equipment-plus-installation packages combine both scopes under one award. Each contract must clearly assign responsibility for delivery, storage, installation, and warranty coverage.

In June 2024, Riverside Public Utilities purchased a 15 kV switchgear lineup separately from its construction and testing contracts. [4]

The role also covers the work needed to get that equipment installed.

Construction Contracts and Project Services

For sitework, foundations, structural steel, and MEP installation contracts, bid scopes must define equipment-to-building interfaces. Closing scope gaps before award helps prevent commissioning gaps later.

Contract administration tracks approved changes and their effects on cost and schedule. It also involves working with the responsible project teams to close outstanding commercial obligations.

Across these packages, sourcing decisions establish who owns the equipment, who installs it, and who carries the schedule risk.

Package Type Key Sourcing Decision Risk if Ordered Late or Scoped Poorly
Production equipment Assign OEM integration and equipment-to-line interfaces Integration gaps delay commissioning and first production
Critical facility systems Choose OFCI, CFCI, or a combined award; assign testing responsibility Delivery delays or failed factory acceptance tests block energization and integrated systems testing
Construction contracts Align trade scopes with equipment delivery and installation interfaces Trade conflicts and change orders delay site readiness and commissioning

Supplier Selection, Contract Terms, and Delivery Tracking

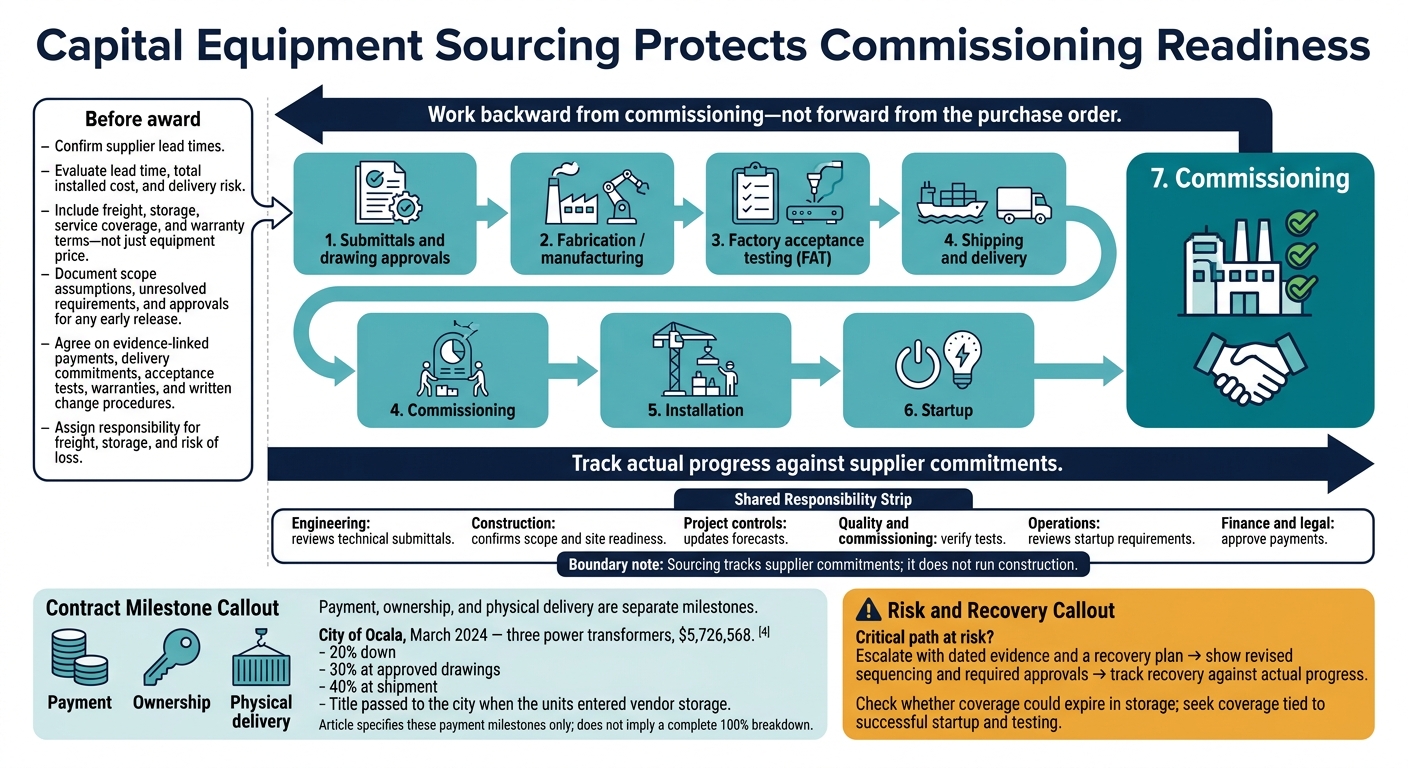

Capital Equipment Sourcing: From Award to Commissioning

Capital Equipment Sourcing: From Award to Commissioning

Once the package scope is set, select suppliers and agree on terms that protect the budget and schedule.

Long-Lead Planning and Total Cost

Work backward from commissioning - not forward from the purchase order. Link installation, shipping, factory acceptance testing (FAT), manufacturing, and drawing approvals to the integrated project schedule. Confirm each supplier’s lead times before award.

Base the award on lead time, total installed cost, and delivery risk. Include freight, storage, service coverage, and warranty terms - not just the equipment price. For transformers, delivery certainty matters alongside technical compliance. Document scope assumptions, unresolved requirements, and approvals for any early release.

In March 2024, the City of Ocala purchased three power transformers for $5,726,568. Its payment structure included 20% down, 30% at approved drawings, and 40% at shipment; title passed to the city when the units entered vendor storage. [4]

Payment, ownership, and physical delivery are separate milestones. The contract needs to address each one.

Supplier Qualification and Contract Negotiation

Judge suppliers by evidence, not assurances. Apply pass/fail checks for mandatory requirements before scoring price and delivery.

Criterion Illustrative Weight Required Evidence Effect on Award
Technical compliance 25% Compliance matrix, exceptions, named technical resources Reject unresolved mandatory deviations
Capacity and delivery 25% Production slot, backlog, milestone schedule Require a capacity commitment backed by evidence
Total cost and commercial terms 20% Installed-cost breakdown, exclusions, escalation terms Compare complete scope, not headline price
Quality and safety 15% Quality plan, inspection records, applicable safety documentation Resolve material gaps before award
Financial strength and service 15% Financial review, U.S. service staffing, parts support Adjust payment security or reject unacceptable exposure

Check capacity, backlog, financial strength, and U.S. service coverage during qualification. [1]

Negotiate pricing or clear escalation rules, payments linked to evidence, delivery commitments, performance guarantees, acceptance tests, warranties, and written change procedures. Spell out responsibility for freight, storage, and risk of loss.

Check whether the warranty could expire while equipment sits in storage. Seek coverage tied to successful startup and testing. [4] Have legal review late-delivery remedies and clauses allowing price or schedule adjustments if owner-furnished equipment arrives late. Tie each payment to verified progress.

Coordination Through Installation and Commissioning

After award, keep one milestone register that links supplier commitments to startup readiness. Track submittals, fabrication, FAT, delivery, installation, startup, and commissioning.

Make responsibilities clear: engineering reviews technical submittals; construction confirms scope and site readiness; project controls updates forecasts; quality and commissioning verify tests; operations reviews startup requirements; and finance and legal approve payments.

If a supplier puts the critical path at risk, escalate with dated evidence and a recovery plan. Show revised sequencing and required approvals, then track recovery against actual progress - not the original promised date.

Qualifications and Candidate Evaluation

Required Experience and Preferred Credentials

After supplier qualification, evaluate candidates against the same standard: proven ownership of schedule-sensitive packages. Define the role by package scope, not title. For larger roles, verify ownership of packages worth $50 million or more and experience with GC/CM or design-build contracts. Working on a large project isn’t enough [1].

Set baseline education and experience requirements, but give package ownership more weight than credentials alone. Education is a screening tool - not proof of fit. Require demonstrated ownership of long-lead packages, drawing literacy, and fluency in AIA/equipment contracts [1].

For roles covering hyperscale infrastructure, require package-level knowledge of critical equipment and vendor drawings. Candidates from comparable capital projects should connect their experience to the role’s actual packages and commissioning responsibilities.

Hiring Criteria and Evidence to Check

Check what the candidate owned, approved, negotiated, and signed. Use evidence tied to commissioning readiness to assess documentation quality, technical curiosity, and negotiation discipline.

Requirement Evidence to Verify Interview Prompt
Package ownership Package-value range, scope, award authority, and commissioning interfaces “What did you own, and who authorized the award?”
Commercial judgment Award rationale, final-cost explanation, and commissioning obligations “Why did the selected bid offer the best value?”
Delivery performance Promised versus actual commissioning-critical milestones; recovery actions “What slipped, when did you escalate, and what changed?”
Change control Scope-change disposition and cost and commissioning impacts “How did you resolve the scope change and its cost and schedule impact?”
Technical and team coordination Drawing-review involvement and alignment with engineering and construction on installation and testing “What required engineering approval, and how did construction influence your decision?”

Use work samples to check whether candidates can apply these standards under pressure.

Candidate Scenarios and Work Samples

Present hypothetical supplier problems involving delays, late specification changes, proposed substitutions, and missed factory acceptance tests. Look for answers that distinguish sourcing decisions from engineering approval, identify when to escalate, and explain how the decision protects the schedule.

Provide sanitized bid data and ask for a one-page award memo. Check for clear reasoning, explicit assumptions, and a clear separation of sourcing, engineering, and construction decisions.

Conclusion: Define the Role by Project Outcomes

When hiring, judge the role by project outcomes - not the title alone. Make commissioning readiness, not purchase-order placement, the finish line. Assign ownership of each package’s supplier technical compliance, total cost, and contract terms to control costs and keep the schedule on track.

Set each package’s critical-path window and link ownership to clear commissioning handoff criteria: operations and maintenance manuals, warranties, and factory acceptance test records. Candidates should explain how their work controlled costs, reduced supplier risk, and protected the startup schedule.

Use these criteria to write the role profile, build the interview scorecard, screen candidates, and connect hiring decisions to commissioning milestones.

FAQs

When should we hire a capital equipment sourcing manager?

Hire a capital equipment sourcing manager during initial diligence or preconstruction - ideally 6 to 12 months before mobilization. Switchgear, generators, and chillers can take 30 to 65 weeks or longer to arrive, so procurement needs to begin well before construction documents are finalized.

Bringing this manager on board early helps secure manufacturing slots, negotiate volume pricing, and time deliveries to match site readiness. That means fewer costly disruptions to the construction schedule.

How do we choose between OFCI and CFCI?

Use Owner-Furnished, Contractor-Installed (OFCI) for long-lead, mission-critical equipment when you need control over procurement, standardized designs, or volume pricing. Your team handles vendors, logistics, and customs - and bears the schedule risk if deliveries arrive late.

Choose Contractor-Furnished, Contractor-Installed (CFCI) for routine, short-lead materials, when internal procurement resources are limited, or when you want a single point of responsibility. It simplifies administration and puts delivery risk on the contractor, but gives you less visibility into costs and supplier choices.

Can experience in other capital projects qualify me for this role?

Yes, experience in other capital projects often qualifies you. Employers value backgrounds in mission-critical, MEP-heavy (mechanical, electrical, and plumbing), or highly regulated projects that involve large-scale construction packages, long-lead equipment, and complex procurement contracts [1][2].

Relevant sectors include semiconductor fabrication, pharmaceutical facilities, power generation, and hospital construction [2]. If you don’t have direct data center experience, highlight your hands-on work in cost estimating, Primavera P6 scheduling, and managing critical path dependencies in similar high-stakes settings [1][2][3].

Related Blog Posts

Keywords:
capital equipment sourcing, construction procurement, long-lead equipment, gigafactory procurement, hyperscaler sourcing, commissioning readiness, OFCI CFCI, supplier qualification
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

NADCAP Explained: Accreditation for Aerospace Special Processes
October 3, 2026

NADCAP Explained: Accreditation for Aerospace Special Processes

Step-by-step overview of NADCAP scope, audit prep, NCR handling, and maintaining accreditation for aerospace special processes.
Real Estate Analyst to Strategic Real Estate: The Industrial Owner Career Path
October 3, 2026

Real Estate Analyst to Strategic Real Estate: The Industrial Owner Career Path

Roadmap for analysts to own decisions and move into acquisitions, development, asset management, and portfolio leadership.
Construction Engineer vs Project Engineer vs Field Engineer: The Industrial Build Ladder
October 3, 2026

Construction Engineer vs Project Engineer vs Field Engineer: The Industrial Build Ladder

Explains constructability, document coordination, and installation verification differences among construction, project, and field engineers.
HVAC Technician Levels 1-5 Explained for Critical Facilities
October 3, 2026

HVAC Technician Levels 1-5 Explained for Critical Facilities

Outlines HVAC technician levels 1–5 for critical facilities, covering skills, troubleshooting depth, authority, and required certifications.
