Mission-Critical Commissioning Specialist Roles

By:
Dallas Bond

If a site can’t pass testing, it isn’t ready to run - even if construction is done.

When I look at mission-critical commissioning roles, I see a simple split: who plans the work, who runs the tests, and who approves turnover. In places like data centers, pharma plants, power sites, and advanced manufacturing facilities, these jobs sit between construction and handoff. Their work covers readiness checks, functional testing, integrated systems testing, issue tracking, re-testing, and final documentation.

Here’s the short version:

  • Commissioning Provider (CxP): the firm leading the commissioning program
  • Commissioning Authority (CxA): the person checking work against owner requirements and making pass/fail calls
  • Commissioning Manager (CxM): the person driving schedules, meetings, and test windows
  • Commissioning Engineers and specialists: the people doing field testing across electrical, mechanical, and controls systems
  • Sector titles change: data centers use Cx and IST titles; pharma uses CQV titles; power uses startup and commissioning titles
  • Reporting lines matter: owner-side, third-party, and contractor-embedded teams each handle speed, control, and sign-off differently
  • Hiring focus: employers should screen for direct test experience, controls knowledge, issue closeout, and sector-specific system work

A few facts stand out. The article notes that U.S. data center commissioning pay often falls between $90,000 and $160,000 per year. It also points out that 10% to 20% of TAB readings may be re-checked during verification. And in mission-critical work, sample testing is not enough when uptime or compliance is on the line.

For me, the main point is clear: construction completion is not the same as site readiness. These roles exist to prove systems work alone, work together, and keep working when something fails.

Role Main job Typical focus
CxP Lead the commissioning program Planning, staffing, process control
CxA Check against owner requirements Witness major tests, acceptance calls
CxM Run site execution Schedule, meetings, issue logs
Cx Engineer Perform testing Electrical, mechanical, controls
CQV Engineer Run regulated qualification work IQ/OQ/PQ, deviations, validation

If you’re hiring or trying to understand these jobs, I’d keep it simple: look at testing scope, reporting line, and sector fit first.

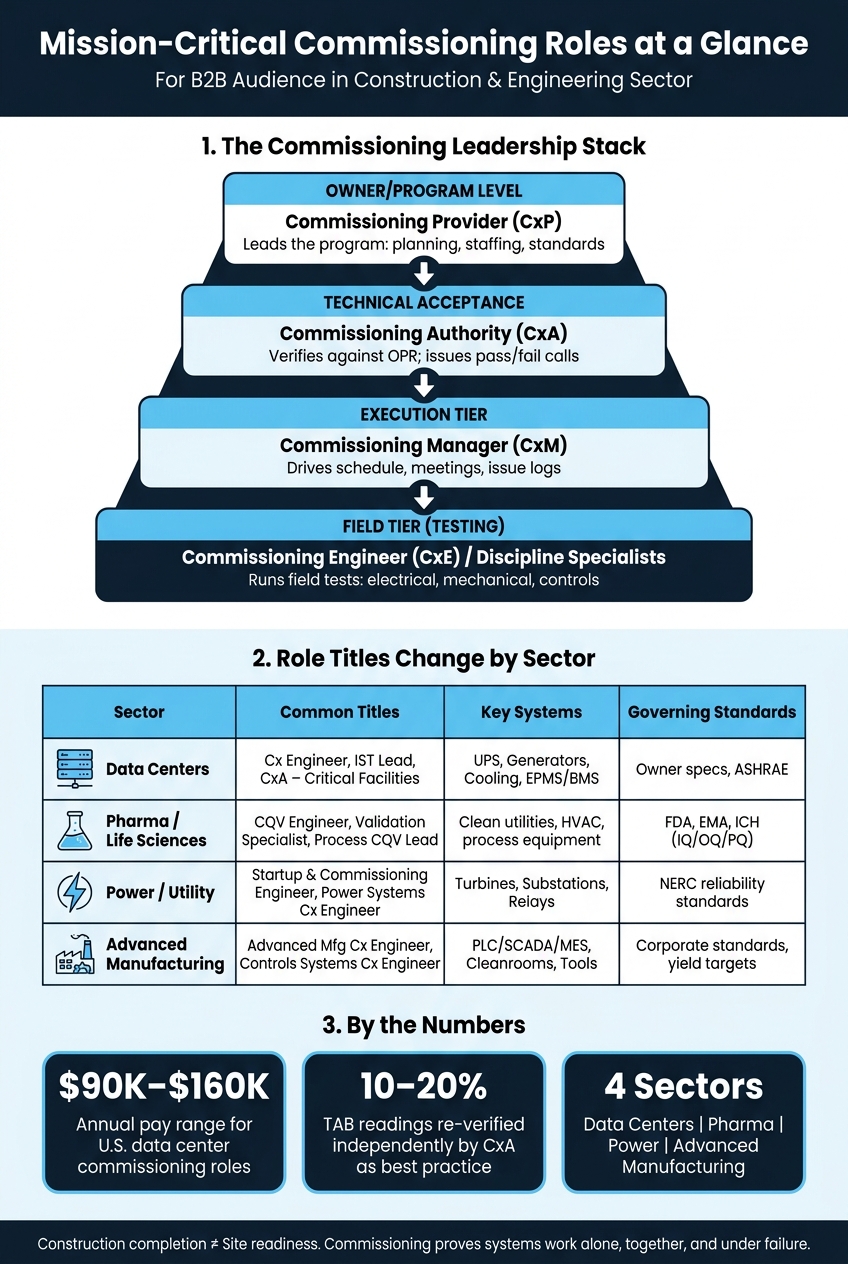

Mission-Critical Commissioning Roles: Structure, Reporting & Sector Fit

Mission-Critical Commissioning Roles: Structure, Reporting & Sector Fit

Core Commissioning Roles and Where Each One Fits

Commissioning roles sit between construction and operations. Their job is to turn installed systems into accepted systems. The roles below show who plans the work, who leads it, who carries it out, and who signs off.

Commissioning Provider, Commissioning Authority, and Commissioning Manager

These three roles make up the leadership layer of a commissioning program. They work closely together, but they do not do the same job, and they do not answer to the same part of the project.

The Commissioning Provider (CxP) is the firm or organization hired to lead the commissioning program. The CxP builds the commissioning plan, lines up staff, coordinates test procedures across trades, and makes sure the process follows the right standards. On most U.S. mission-critical projects, the CxP is a third-party firm hired by the owner. That separation helps keep the process independent from the contractors who installed the equipment.

The Commissioning Authority (CxA) is the senior technical lead inside the CxP, or in some cases a direct owner’s representative. The CxA checks the work against the OPR, approves test scripts, witnesses major tests like integrated systems tests or performance qualification runs, and issues findings and acceptance calls. Large owners - hyperscale data center operators, major pharmaceutical companies, and utilities - are building owner-side CxA teams more often now. These teams oversee multiple projects at once and apply internal standards across the full project portfolio.

The Commissioning Manager (CxM) is more focused on execution and coordination than on technical acceptance. This role ties commissioning milestones to the construction schedule, manages issue logs, leads daily and weekly commissioning meetings, and keeps MEP trades and controls integrators lined up for testing windows. On design-build or EPC projects, the CxM is often embedded with the builder or construction manager and handles site logistics. The CxA still keeps final acceptance authority.

Put simply, these roles split the work into three lanes: program oversight, technical acceptance, and day-to-day execution.

Feature Commissioning Manager (CxM) Commissioning Authority (CxA)
Employer GC, EPC, construction project managers, or owner's PMO Owner or owner's rep
Primary Objective Drive execution, startup, and turnover Verify compliance with OPR and design intent
Authority Coordinates turnover actions and schedule Approves final system acceptance
Project Phase Mid-construction to turnover Pre-design to early operations
Independence Part of the project delivery team Independent third-party advocate

Titles may shift from one market to another, but the reporting chain and testing duties tend to stay the same.

Commissioning Engineer and Discipline Specialists

Below the leadership layer, Commissioning Engineers (CxE) and discipline specialists handle the field work. They run tests, document results, and help close deficiencies.

A commissioning engineer usually works within one discipline. Electrical specialists handle NETA acceptance tests, breaker functional tests, transfer switch operations, and UPS and generator load testing. Mechanical specialists focus on chilled water systems, air handling units, flow balancing support, and equipment start/stop sequences. Controls and BAS specialists verify point-to-point mappings, sequence of operations, alarm routing, and integration to DCIM or plant historian systems. These roles carry strong technical weight inside their area, but formal acceptance still moves up through the CxA.

Pre-functional checklists (PFCs) gate functional testing by proving installation and readiness.[4][5][6] On many U.S. project specifications, a contractor’s signature on the PFC is required before functional testing can start. That makes the PFC more than a commissioning form. It also acts as a quality control checkpoint for construction.[4][5][6]

Here’s how the full role structure maps across goals and systems:

Role Main Objective Primary Systems
Commissioning Authority (CxA) Owner advocacy & verification All (MEP, Controls, Life Safety)
Commissioning Manager (CxM) Execution & schedule certainty All (coordination focus)
Commissioning Engineer (CxE) Technical testing & verification Discipline-specific (mechanical, electrical, controls)
BAS/Controls Specialist Controls logic & integration BAS, BMS, EPMS, SCADA
Cx Technician Field verification Individual components

Role Titles by Sector: Data Centers, Pharma, Power, and Advanced Manufacturing

Job titles change by sector because the systems, risks, and acceptance criteria change too.

In data centers, common titles include Data Center Commissioning Engineer, Commissioning Authority – Critical Facilities, and Integrated Systems Test Lead. The work centers on UPS, generators, switchgear, cooling, controls, and IST. In each case, the role reports through the commissioning chain, not straight to installation crews.

In regulated manufacturing, commissioning becomes CQV. Titles like CQV Engineer, Validation Specialist, and Process CQV Lead point to a regulation-driven setting shaped by FDA, EMA, and ICH guidelines. The work covers IQ/OQ/PQ, deviations, and validation. CQV engineers often report into Engineering Services or Validation/Compliance functions rather than construction teams, which shows how regulatory this work is in GMP environments.[2][1][3] In each case, the role reports through the commissioning chain, not straight to installation crews.

In power generation and energy projects, titles like Startup and Commissioning Engineer and Power Systems Commissioning Engineer are common. The work covers turbines, substations, relays, and grid interconnection. NERC reliability standards and utility codes shape testing priorities. In each case, the role reports through the commissioning chain, not straight to installation crews.

In advanced manufacturing - semiconductor fabs, battery gigafactories, aerospace facilities - roles may appear as Advanced Manufacturing Commissioning Engineer, Tool Installation & Commissioning Specialist, or Controls Systems Commissioning Engineer. The work covers tool startup, cleanroom stability, and MES integration, often guided by corporate standards and product yield targets. In each case, the role reports through the commissioning chain, not straight to installation crews.

Scope of Work and Day-to-Day Responsibilities

Commissioning starts during design and runs all the way through turnover. Day by day, this is the work that turns installed systems into accepted systems.

Planning, Test Development, and Readiness Reviews

Early commissioning is mostly desk-based work. But it sets the tone for everything that happens later.

At this stage, specialists review the Basis of Design (BOD) against the Owner's Project Requirements (OPR). The goal is simple: find gaps in redundancy, maintainability, or testability before those issues get built into the facility. They also keep the commissioning plan, test matrix, and field test scripts up to date. Those documents guide what happens on-site.

Readiness gates are one of the most useful tools in this phase. Before a major milestone like initial energization, generator load bank testing, or a live failover simulation, the commissioning specialist leads a formal readiness review. They confirm that:

  • Installation is complete
  • Submittals are approved
  • Controls points are wired and verified
  • Safety systems are active
  • Operations staff are available and briefed

If the risk is too high, the activity stops until the prerequisites are in place. No guesswork. No “we’ll figure it out live.” Once the gate is cleared, the work moves into site testing and deficiency closeout.

Field Execution, Documentation, and Re-Testing

Once construction reaches the right stage, the work shifts into the field.

Daily tasks usually include site walkdowns to check installation quality and labeling, loop checks and point-to-point checks with controls and electrical crews, and witnessing functional tests to confirm that each system responds the right way under normal commands, alarms, and failure conditions. Specialists also review trend data from BMS, SCADA, or historian systems to spot quieter issues like unstable control loops, sensor drift, or intermittent faults that may not show up in a single test run.

When something fails, the deficiency is logged right away, assigned to the right party, and tracked until it's fixed. Re-testing after the fix is required. It becomes part of the formal record, not an optional extra. Daily reports show what was tested, what passed, what failed, and what comes next. Those records later feed the turnover package.

Who leads that day-to-day effort can change based on whether the specialist reports to the owner, the CxP, or the contractor.

How Daily Work Changes by Sector

The process stays much the same across sectors, but daily priorities can look very different.

Sector Primary Daily Focus Key Testing Scenarios
Data Centers Power and cooling reliability UPS transfer, generator load bank, cooling redundancy (N+1/2N), full-facility IST failover simulations
Pharma / Life Sciences GMP compliance and qualification Cleanroom classification, IQ/OQ/PQ execution, environmental stability, pressure cascade verification
Power / Utility Grid stability and protection systems Relay coordination, pre-energization checks, transformer startup, protection system validation
Advanced Manufacturing Automation integration and line readiness PLC/SCADA/MES interface verification, safety interlocks, recipe management, dry-run simulations

So while the workflow stays familiar, the daily focus shifts. In one setting, the team is centered on power and cooling. In another, it's qualification work. Elsewhere, it's protection and energization, or automation and line readiness. That mix also changes with the reporting structure, which the next section covers.

Reporting Lines and Interfaces With Project Teams

Once testing begins, the reporting setup affects speed, escalation, and final acceptance.

Where a commissioning specialist sits on the org chart shapes three things: who directs the work, whose sign-off is needed, and who can stop turnover when a test fails.

Owner-Side, Third-Party, and Contractor-Embedded Reporting Structures

On U.S. mission-critical projects, three setups show up again and again. Each one comes with a different mix of independence and day-to-day coordination.

Owner-side commissioning managers report into the owner's capital projects, engineering, or reliability team. They set the commissioning approach, approve the commissioning plan, and control whether the project moves from one phase to the next, like going from functional testing into integrated systems testing. Because they sit with the owner, they aren't pulled by GC schedule pressure in the same way. That makes it easier for them to hold the line when systems aren't ready.

Third-party CxA/CxP firms are hired by the owner but work apart from both the owner's internal staff and the construction team. They usually report to the owner's project manager or program executive, and their scope is built around verifying, witnessing, and documenting performance. Their main strength is impartial verification. The downside is simple: issue resolution can drag if the GC and trade partners are not contractually tied to their direction.

Contractor-embedded commissioning leads sit inside the GC or a major trade partner and report to the GC project executive or senior project manager. They tend to move fast, work closely with superintendents and foremen, and fold commissioning into the construction schedule from the start. For high-risk tests like power failover and black-start scenarios, owners often want independent witnessing.

The table below shows who directs the work, who witnesses tests, and who signs off.

Role Reports To Coordinates With Acceptance Authority
Commissioning Authority (CxA/CxP) Owner's project executive or program manager Owner's rep, GC PM, MEP coordinators, controls integrator, TAB contractor, OEM vendors, facility operations Recommends acceptance; owner makes final acceptance
Owner's Commissioning Manager Owner's capital projects director or facilities director Third-party CxA, design engineers, GC, trade partners, IT/OT teams, operations Approves test plans, signs readiness to proceed into IST, and approves or holds beneficial occupancy
GC Commissioning Lead GC project executive or senior PM Superintendents, MEP coordinators, trade foremen, controls subcontractors, vendor startup teams, and sometimes the owner's CxA Can certify pre-functional and functional testing complete; cannot approve final owner acceptance
Commissioning Engineer Commissioning manager, whether third-party, GC, or owner-side Field foremen, TAB teams, controls programmers, OEM technicians, QA/QC inspectors Signs off on test execution and data integrity; escalates pass/fail status; formal acceptance is made by the CxA or owner
Discipline Specialist Commissioning manager or discipline lead Controls integrators, power systems engineers, process equipment vendors, facility engineering, owner operations Technical authority for discipline-specific criteria; final system acceptance is typically a jointly held decision with the CxA and owner

Interfaces With Construction, MEP, Controls, and Operations Teams

Commissioning doesn't happen in a silo. Day to day, specialists work across several teams, and the quality of those handoffs has a direct effect on whether testing stays on track and deficiencies get closed.

With superintendents, the focus is field logistics. That means confirming systems are installed, safe, and accessible, and lining up lockout/tagout before energized testing starts. With project managers, the conversation shifts to schedule alignment: fixing commissioning milestones, matching vendor visits to test windows, and handling change orders that come out of commissioning findings. A commissioning look-ahead schedule tied to the GC's 3-week and 6-week look-ahead helps keep pre-functional completion, startup, functional testing, and integrated testing lined up by area and system.

MEP coordinators handle spatial coordination and trade sequencing. Commissioning specialists rely on them to make sure systems are installed in a way that supports testability and access to instrumentation. Put plainly, MEP coordinators own installation and sequencing. Commissioning owns performance verification.

TAB teams balance air and hydronic systems and run early loop-level checks. Commissioning specialists then verify that system-level performance, including air changes per hour, pressure relationships, and chilled water delta-T, matches design intent. Best practice calls for the CxA to re-test 10% to 20% of TAB measurements independently to verify quality.[8] Controls integrators put sequences of operations, alarms, and interlocks into place. Commissioning specialists then push those sequences under simulated and live failure scenarios to confirm fail-safe behavior and alarm response.

During integrated systems testing, EPMS and BMS leads set up trends and alarms to capture data before, during, and after each test. They're often the first people to spot odd behavior in power flows or temperatures while a test is still running. Facility operations staff take part to validate procedures and practice alarm response. During IST, the CxA or commissioning manager confirms technical readiness, and the owner's operations leader authorizes whether to proceed or stop based on operational risk.[7]

These reporting patterns shape the commissioning profiles U.S. employers need most.

Hiring Mission-Critical Commissioning Talent in the United States

Commissioning jobs can look pretty different from one project to the next. In one case, the person sits on the owner side. In another, they work for a third-party firm or inside the contractor team. That’s why hiring should start with the project’s testing scope.

The right hire usually needs a mix of field testing, controls troubleshooting, documentation, and owner communication. But that mix isn’t fixed. It shifts based on the role and where that person sits in the project structure.

What Employers Should Look for in Commissioning Candidates

Start with direct, hands-on experience. Look for people who have worked through planning, pre-functional checks, functional testing, integrated systems testing, and turnover. It’s especially smart to confirm that they’ve been involved in functional testing and integrated systems testing, since those stages tend to carry the most risk.

A resume full of project names doesn’t tell you much on its own. What matters more is whether the candidate can explain what actually happened in the field. Can they walk through a test failure, show how it was documented, and explain how the team fixed it? That kind of detail tells you they’ve done the work, not just stood nearby.

Sector experience matters too. A strong commissioning candidate for a data center role may not be the right fit for pharma or power.

Here’s what to look for by sector:

  • Data centers: hands-on work with UPS, switchgear, generators, and EPMS/BMS logic
  • Pharma and biotech: IQ/OQ/PQ exposure, plus familiarity with cGMP and FDA documentation expectations
  • Power and energy: protective relay testing and grid-interconnection experience

Across all sectors, controls fluency is a big separator. People who can validate PLC, SCADA, and BMS sequences before they break during testing tend to stand out from the pack.

Field skill alone isn’t enough. Documentation discipline matters just as much. Ask candidates how they built a turnover package or how they tracked deficiencies through closure. If they can’t explain their process clearly, that’s a red flag.

Use the matrix below to match experience to the role you need.

Role Title Target Background Key Hiring Signals
Commissioning Manager Senior GC or commissioning provider; 8–10+ years mission-critical Led multi-discipline commissioning from functional testing through integrated testing; owner-facing reporting; coordinated third-party commissioning agents
Commissioning Engineer – Electrical Electrical engineering or field startup background UPS, switchgear, generator testing; wrote and executed test scripts; documented deficiencies
Commissioning Engineer – Mechanical MEP contracting or OEM field service Chilled water, cooling, and air distribution testing; system-level performance verification
CQV Engineer (Pharma/Biotech) Process or mechanical engineering; cGMP environment IQ/OQ/PQ execution; clean utilities experience; FDA-aligned documentation
Controls/BMS Commissioning Specialist Controls integration or building automation background Point-to-point verification; SOO validation; failure scenario testing; EPMS/SCADA fluency
Commissioning Authority (Third-Party) Senior engineer or commissioning provider leadership Independent verification track record; impartial reporting; multi-sector IST experience

Salary benchmarks for U.S. data center commissioning roles currently range from $90,000 to $160,000 per year, depending on seniority and location. Commissioning managers with program-level scope usually land near the top end of that range.

How iRecruit.co Supports Mission-Critical Commissioning Hiring

When project demand starts ramping up, building a commissioning bench can turn into a scramble. Specialized recruiting support can help cut down the search time.

iRecruit.co supports mission-critical commissioning hiring with pre-qualified candidates, recruitment, RPO, and consulting for commissioning, MEP, project management, and field roles across data centers, energy, infrastructure, defense-tech, advanced manufacturing, and pharmaceutical facilities.

Conclusion: Roles, Reporting Lines, and Project Impact

When commissioning roles are filled with the right sector experience and clear reporting lines, startup risk drops. Failures show up earlier. Turnover packages are more likely to stand up under owner and regulatory review.

Those hiring calls made early in project planning often shape which path the project ends up taking.

FAQs

When does commissioning actually start?

Commissioning starts earlier than a lot of teams expect: during the pre-design phase.

At this Level 0 stage, the Commissioning Authority helps shape the Owner’s Project Requirements and reviews the Basis of Design to spot gaps or conflicts while everything is still on paper. When commissioning comes in during site selection, permitting, or before schematic design, teams can avoid rework, schedule delays, and design mistakes before they snowball.

Who has final sign-off on system acceptance?

Final sign-off on system acceptance sits with the owner or the owner’s representative, backed by the Commissioning Authority (CxA).

The Commissioning Manager runs startup and testing. The CxA then checks the results on an independent basis and recommends acceptance. Operations staff and the owner-side commissioning representative take part as well, helping confirm that everything lines up with the Owner’s Project Requirements (OPR) and the way the owner expects the system to operate.

How do commissioning roles differ by industry?

Commissioning roles change from one industry to another because the work itself changes. The systems are different, the rules are different, and the schedule pressure can look completely different too.

  • Data centers: These projects usually have larger teams. The focus is on uptime, failover validation, and IST. There’s little room for error because downtime can be extremely costly.
  • Power and utilities: These teams are often smaller and more specialized. Their work centers on relay protection, SCADA integration, and NERC/FERC compliance. It’s more like precision fieldwork than broad coordination.
  • Pharma and advanced manufacturing: Here, commissioning teams tend to work more closely with QA and validation. The focus is on cGMP, cleanroom standards, and FDA acceptance. They’re also often brought in earlier, since documentation and testing need to line up from the start.

Related Blog Posts

Keywords:
commissioning specialist, commissioning authority, integrated systems testing, data center commissioning, CQV, commissioning manager, commissioning engineer, site readiness, commissioning hiring
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Passive Fire Protection Roles in Data Center Delivery
August 29, 2026

Passive Fire Protection Roles in Data Center Delivery

Assign one owner per phase, enforce hold points, and keep usable records to avoid rework, failed inspections, and turnover gaps.
Mine Construction Timeline: Permit to Production - Why It Takes 7–10 Years
August 29, 2026

Mine Construction Timeline: Permit to Production - Why It Takes 7–10 Years

Why U.S. mine builds take 7–10 years from late‑stage study to first production: permits, financing, long‑lead equipment, construction, and commissioning.
How to Build a Hyperscale Data Center Team
August 29, 2026

How to Build a Hyperscale Data Center Team

Learn 5 ways project leaders build hyperscale data center teams through trust, delegation, partner alignment, and field leadership growth.
The MILCON Timeline: Appropriation to Award to Beneficial Occupancy
August 28, 2026

The MILCON Timeline: Appropriation to Award to Beneficial Occupancy

Explains the MILCON flow from authorization and appropriation through award, construction, commissioning, and beneficial occupancy.
